| 4/16 | 1.0 | | - | - | Received, manual assembled. | |
| 4/17 | 2.0 | | - | - | Inventory. | |
| 4/18 | 4.0 | 4.0 | - | - | Inventory. | |
| 4/19 | 2.0 | | - | 06-01 | - | |
| 4/20 | 6.0 | | 06-01 | 07-01 | deburing- scuffing. Halted on 06 due to missing part. Started on 07 (rudder), gathering parts | |
| 4/22 | 3.0 | | 07-01 | 07-07 | Gathered all pieces related to 07. Started on deburring and scuffing. | |
| 4/23 | 3.0 | | 07-01 | 07-03 | Finished scuffing, preprocessing. Started to cleco the first plates together. | |
| 4/24 | 0.0 | | | | - | |
| 4/25 | 0.0 | | | | - | |
| 4/26 | 5.0 | 5.0 | 07-03 | 07-03 | Priming day! | |
| 4/27 | 3.0 | | 07-03 | 07-07-S1 | Did not complete 07-05 Steps 2-4, as this would mean riveting parts which priming was not yet complete for. | |
| 4/28 | 0.0 | | | | - | |
| 4/29 | 3.0 | | | | - | |
| 4/30 | 3.0 | | | | Time spent match drilling un-clecoing and deburring | |
| 5/1 | 0.0 | | | | - | |
| 5/2 | 0.0 | | | | - | |
| 5/3 | 2.0 | | - | | All time spent deburring | |
| 5/4 | 2.5 | | - | - | All time spent deburring, dimpling | |
| 5/5 | 0.0 | | | | - | |
| 5/6 | 2.0 | | - | - | All time spent deburring, dimpling: Dimple-punched the hole. | |
| 5/7 | 2.0 | | - | - | All time spent deburring, dimpling. | |
| 5/8 | 4.5 | | | - | Priming day! Assembly comes next. | |
| 5/9 | 9.0 | 9.0 | 07-08 | 07-10 | Rudder riveting~! | |
| 5/10 | 0.0 | | | | - | |
| 5/11 | 3.0 | | 07-11 | 07-12 | More rudder rivetting! | |
| 5/12 | 0.0 | | | | - | |
| 5/13 | 2.0 | | 06-03-01 | 06-04-08 | Started on Vertical Stabilizer while waiting for specialized tools to arrive. | |
| 5/14 | 0.0 | | | | - | |
| 5/15 | 4.0 | | 07-17-01 | 07-12-03 | First assembly of rudder | |
| 5/16 | 3.0 | 2.0 | 07-12-03 | 07-12-04 | Rudder final drilling. | |
| 5/17 | 0.0 | | | | - | |
| 5/18 | 1.5 | | | | Gathering parts for Hstab. | |
| 5/19 | 2.0 | | 08-02-01 | 08-02-08 | Made the mistake in the backing plate. | |
| 5/20 | 3.0 | | 08-02-09 | 08-04-02 | Continued on HSTAB- may need to re-order locknuts. | |
| 5/21 | 2.1 | | 08-04-03 | 08-04-06 | Completed mock HSTAB assy. disassembled for priming. | |
| 5/22 | 2.0 | | - | - | Prep VSTAB and HSTAB for paint. | |
| 5/23 | 0.0 | | | | - | |
| 5/24 | 5.0 | 5.0 | - | - | Priming day! | |
| 5/25 | 0.0 | | | | - | |
| 5/26 | 3.0 | | 06-04-04 | 06-04-06 | Rivetting together VSTAB | |
| 5/27 | 0.0 | | | | - | |
| 5/28 | 2.0 | | 06-04-06 | 06-05-01 | Finish skin riveting of vertical stabilizer | |
| 5/29 | 3.0 | | 06-05-02 | 06-05-04 | Vertical stabilizer complete | |
| 5/30 | 0.0 | | | | | |
| 5/31 | 2.0 | | - | - | Reman the new HS-601 doubler plate | |
| 6/1 | 7.0 | | 08-04-07 | 08-05-02 | Designed cradle for HSTAB holder, dimpled some of the ribs. | |
| 6/2 | 1.0 | | 08-06-01 | 08-06-03 | Rib dimpling completed. | |
| 6/3 | 3.5 | | 08-07-01 | 08-08-02 | Dimpling skins | |
| 6/4 | 7.0 | | - | - | Prepping for priming. Scuffing, mostly. | |
| 6/5 | 5.0 | | - | - | Priming day! | |
| 6/6 | 0.0 | | | | | |
| 6/7 | 0.0 | | | | | |
| 6/8 | 4.0 | | 08-10-01 | 08-10-04 | Rivetting the Hstab | |
| 6/9 | 1.0 | | 08-10-04 | 08-11-03 | placed a few rivets | |
| 6/10 | 0.0 | | | | | |
| 6/11 | 3.0 | | 08-11-03 | 08-11-04 | more hstab rivetting | |
| 6/12 | 3.0 | | 08-11-04 | 08-11-04 | Rivetting Hstab- with the bird :) | |
| 6/13 | 0.0 | | | | | |
| 6/14 | 2.0 | | 08-11-04 | 08-11-04 | STILL rivetting hstab | |
| 6/15 | 0.0 | | | | | |
| 6/16 | 0.0 | | | | | |
| 6/17 | 4.0 | | 08-12-01 | 08-12-03 | Cleco'd rear spar to hstab | |
| 6/18 | 3.0 | | 08-12-03 | 08-12-03 | Did a couple of hstab rivets in the rear spar | |
| 6/19 | 3.0 | | 08-12-03 | 08-12-04 | Got proper sets, finished hstab rear rivets. | |
| 6/20 | 1.0 | | 08-12-04 | 08-12-04 | Hstab completed, except for 9 rivets I'll have to revisit later. | |
| 6/21 - 6/25 | 0.0 | | | | | |
| 6/26 | 1.0 | | 09-00-0 | 09-02-07 | Pulling elevator parts out of inventory. | |
| 6/27 | 0.0 | | | | | |

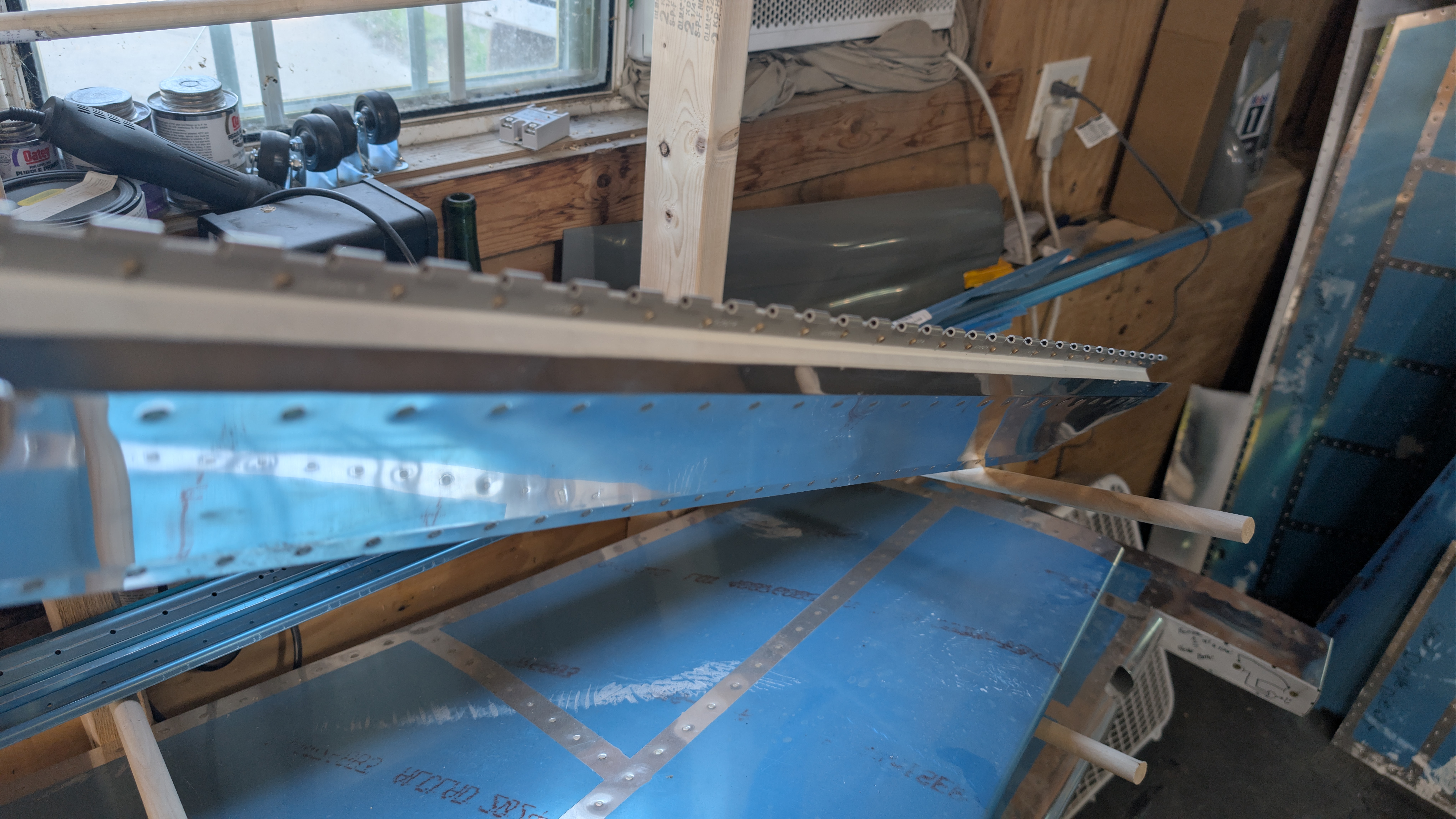

| 6/28 | 6.0 | 6.0 | 09-02-07 | 09-06-04 | Started on Elevator mock assembly. | |
| 6/29 | 3.0 | | 09-07-01 | 09-08-01 | More mock assembly | |
| 6/30 | 3.0 | | 09-08-02 | 09-09-01 | Elevator clecoing, #30 final drilled a few holes. | |
| 7/1 | 1.0 | | 09-09-02 | 09-09-02 | Elevator clecoing, trailing edge trimming. | |
| 7/2 | 0.0 | | | | | |
| 7/3 | 0.0 | | | | | |
| 7/4 | 6.0 | 6.0 | 09-09-03 | 09-09-07 | | |
| 7-5 | 2.0 | | 09-09-07 | 09-09-07 | | |
| 7/6 | 2.0 | | | | Dimpling Elevator skins | |
| 7/7 | 2.0 | | | | Finished dimpling elevator trim tab skins | |
| 7/8 | 0.0 | | | | | |
| 7/9 | 0.0 | | | | | |
| 7/10 | 0.0 | | | | | |
| 7/11 | 0.0 | | | | | |
| 7/12 | 0.0 | | | | | |
| 7/13 | 0.0 | | | | | |
| 7/14 | 0.0 | | | | | |
| 7/15 | 0.0 | | | | | |
| 7/16 | 0.0 | | | | | |
| 7/17 | 0.0 | | | | | |
| 7/18 | 5.0 | 10.0 | | | dimpling elevator skins | |
| 7/19 | 0.0 | | | | | |
| 7/20 | 0.0 | | | | | |
| 7/21 | 0.0 | | | | | |
| 7/22 | 0.0 | | | | | |

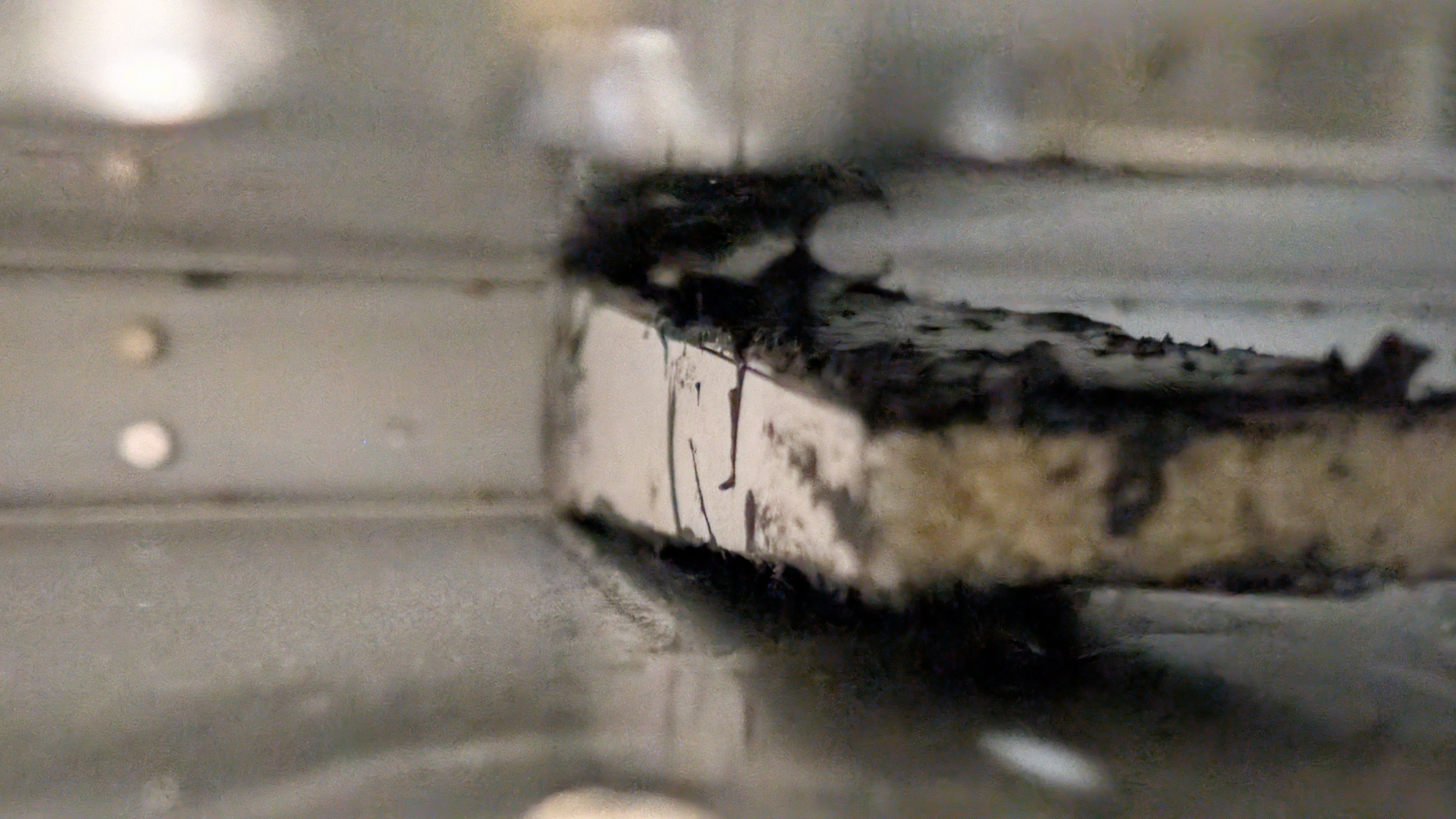

| 7/23 | 3.0 | | | | Scuffing elevator for priming. | |
| 7/24 | 3.0 | | | | More scuffing | |
| 7/25 | 4.0 | | | | Acid etching, rinsing, hanging. | |
| 7/26 | 6.0 | | | | Priming day | |
| 7/27 | 0.0 | | | | | |
| 7/28 | 0.0 | | | | | |
| 7/29 | 0.0 | | | | | |
| 7/30 | 0.0 | | | | | |
| 7/31 | 0.0 | | | | | |
| 8/1 | 2.0 | | | | Prep for Trim tab rib installation. | |
| 8/2 | 0.0 | | | | | |
| 8/3 | 0.0 | | | | | |

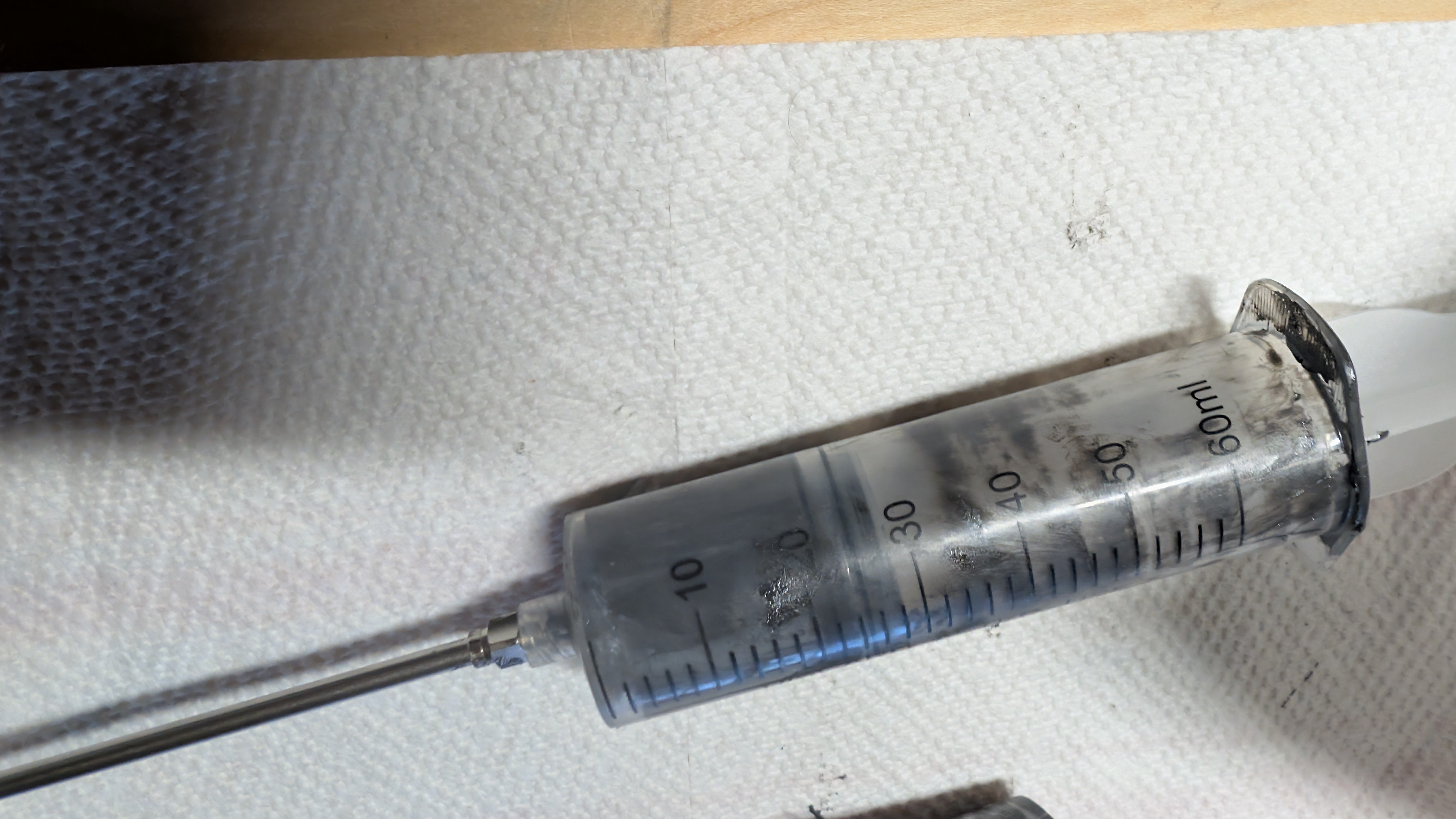

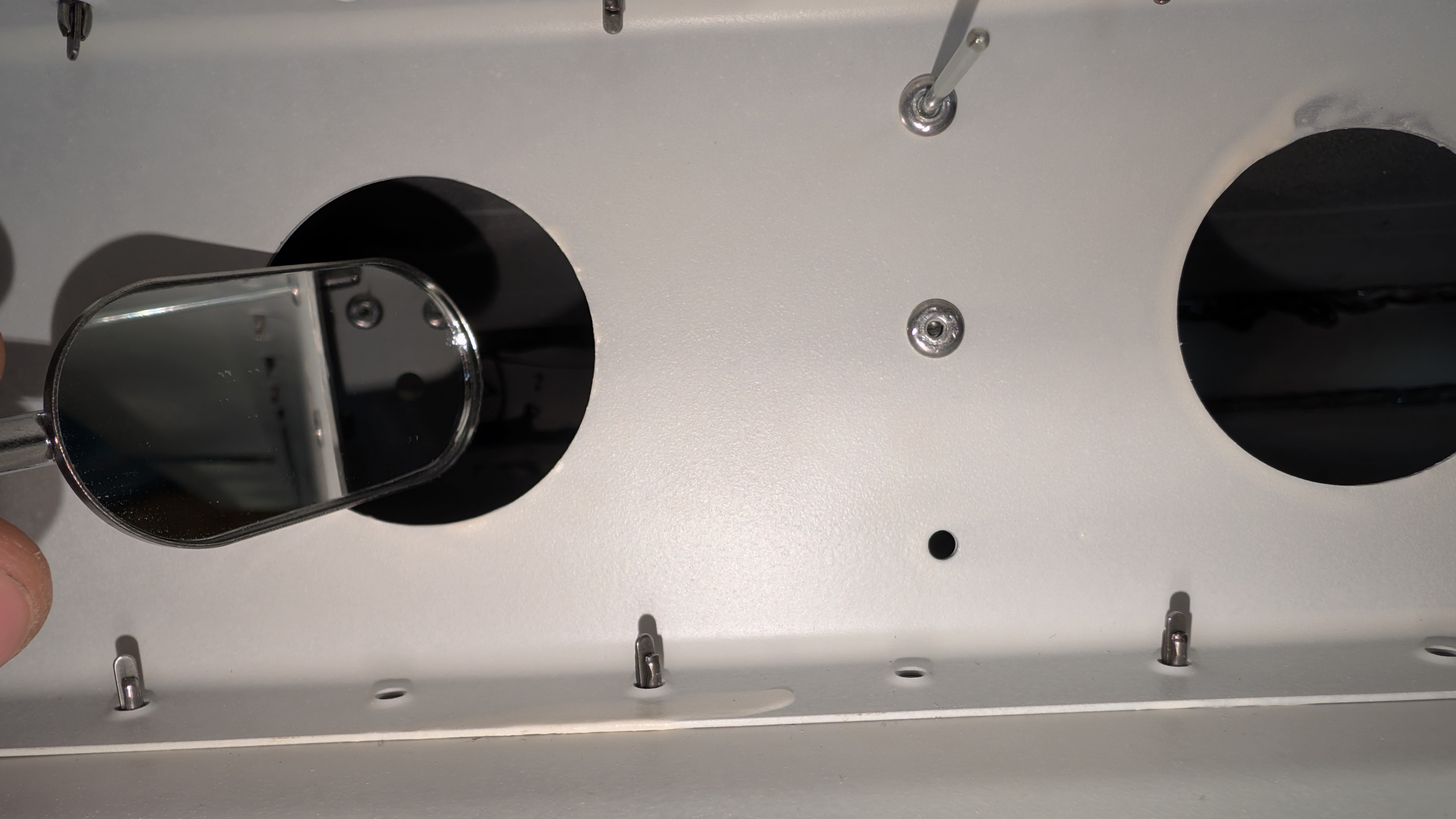

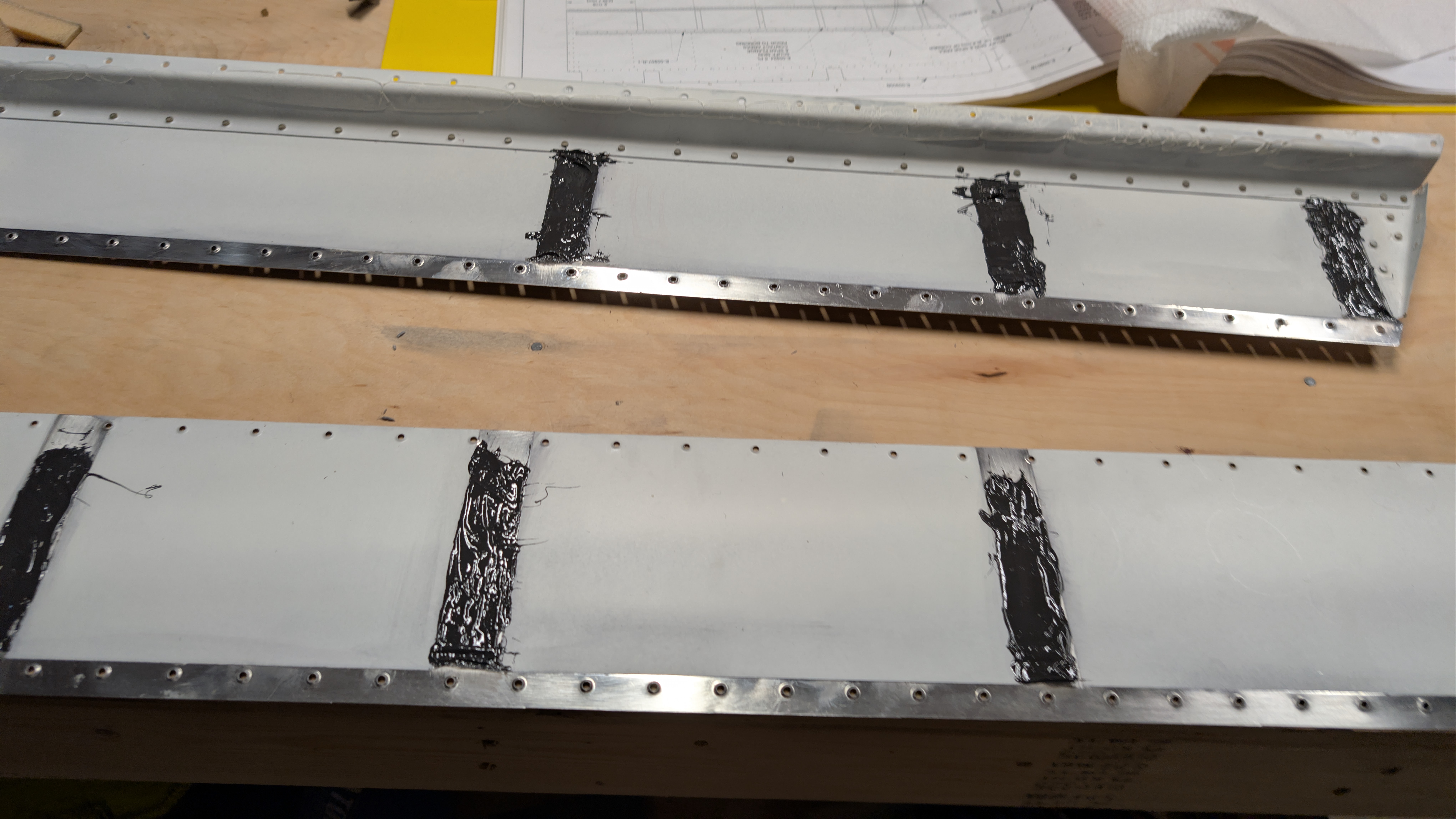

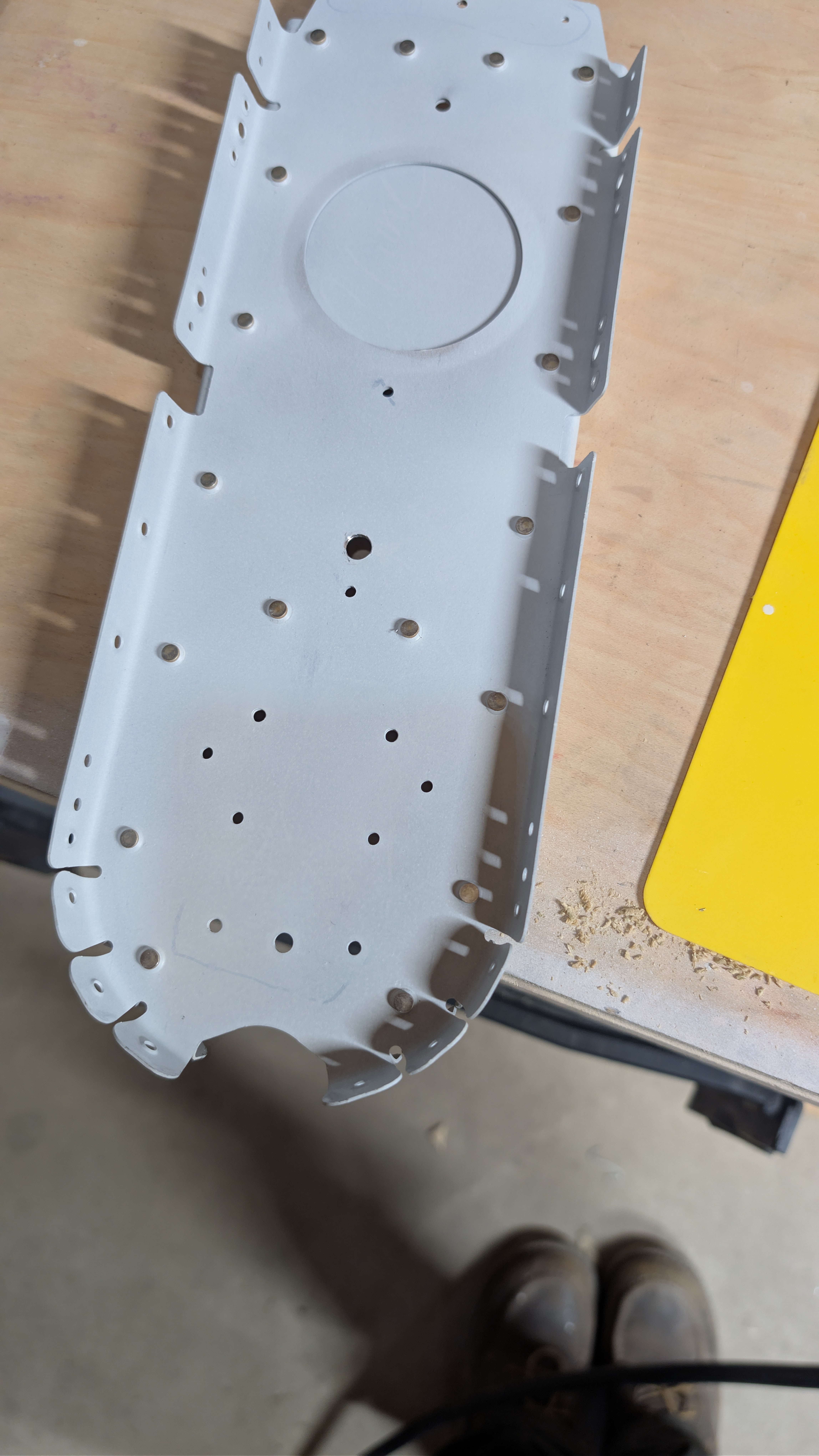

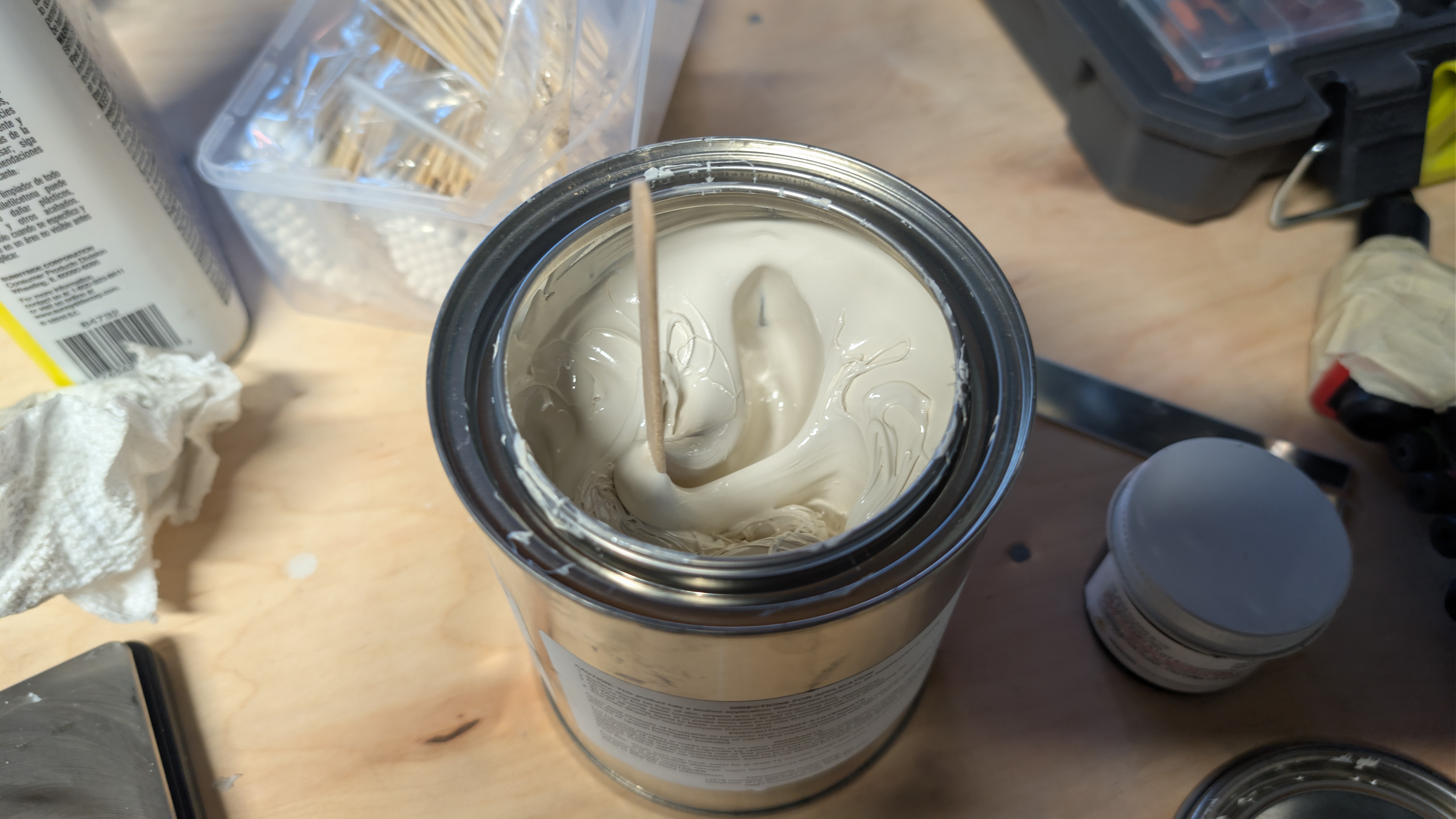

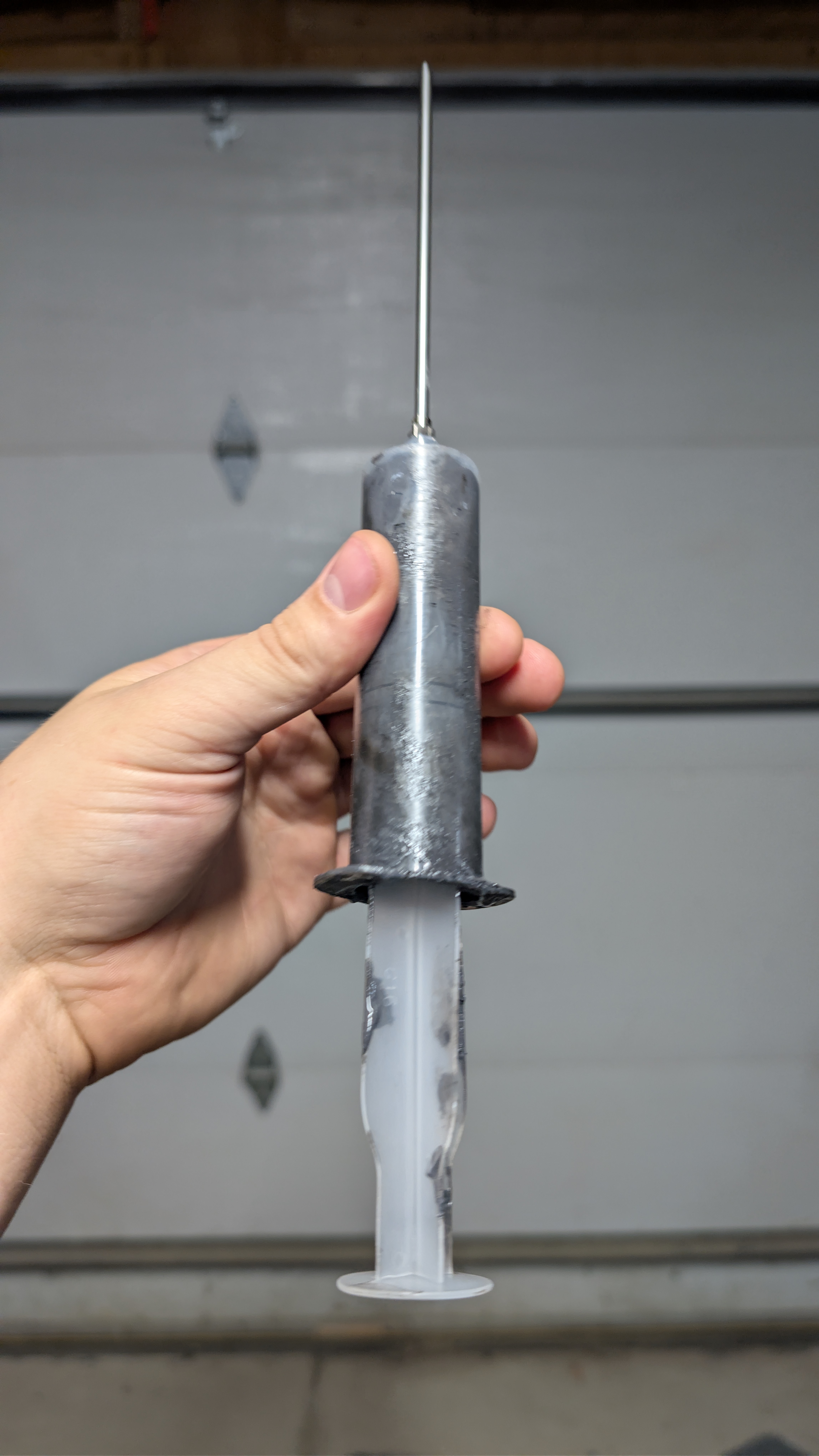

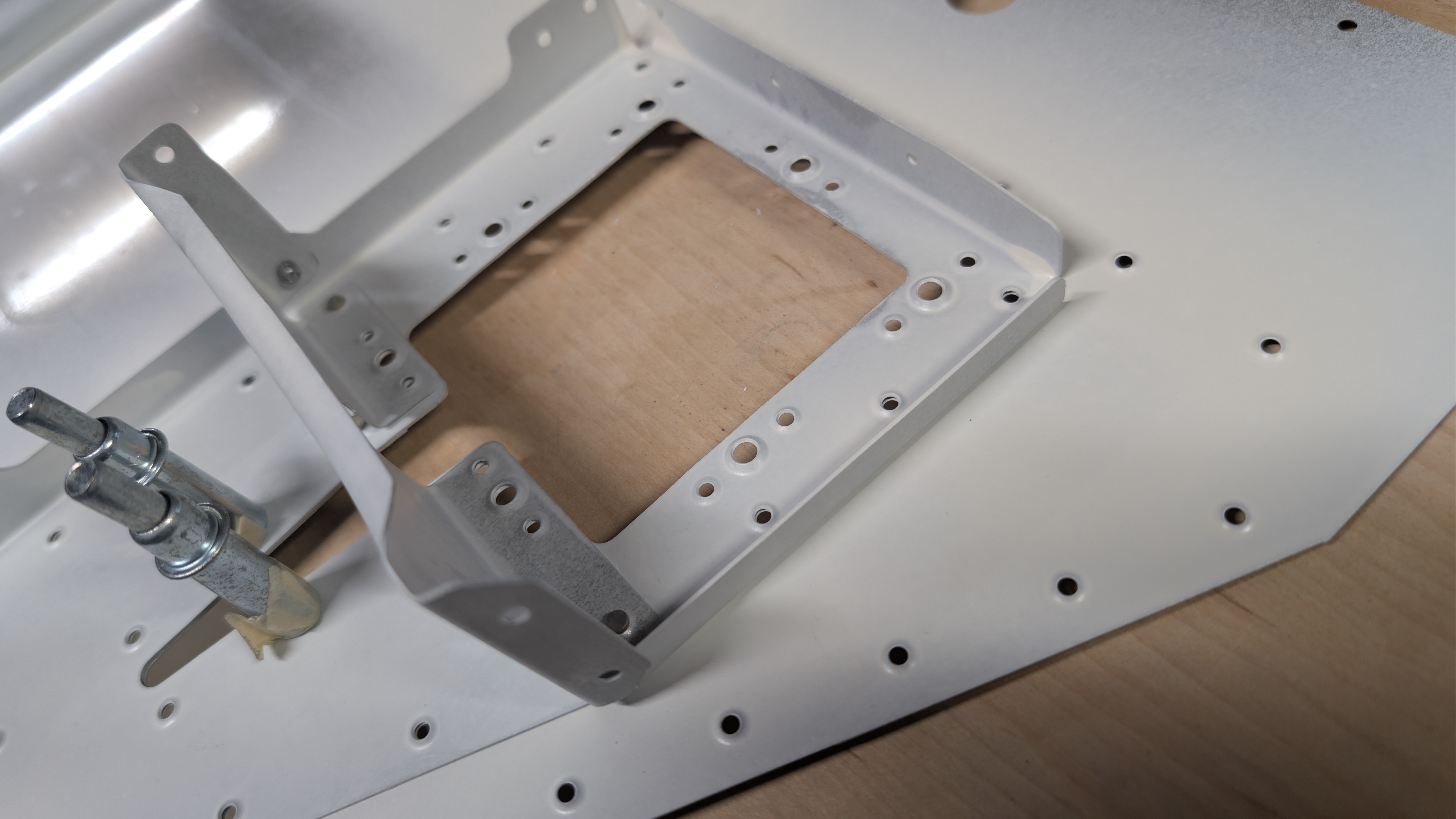

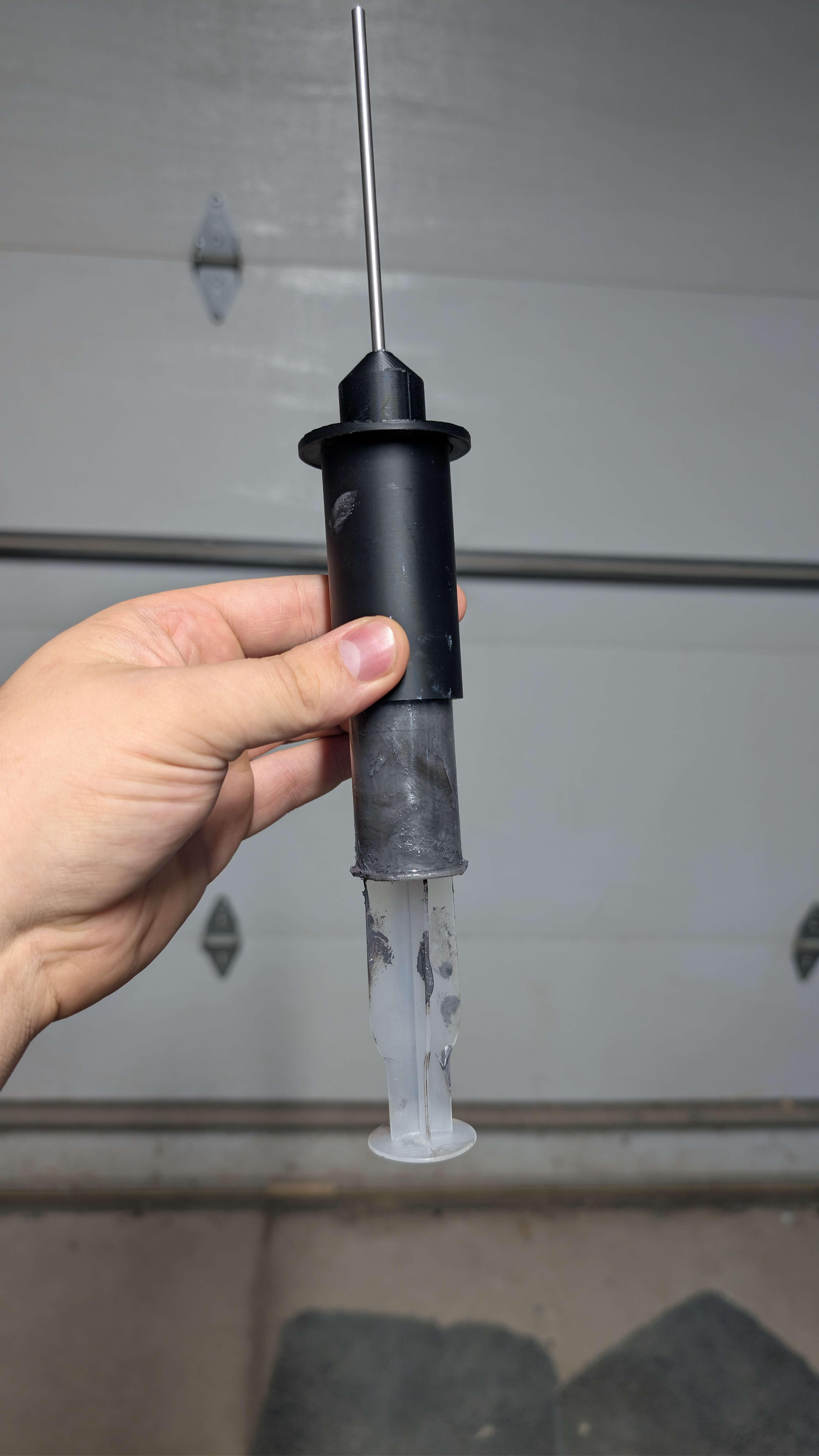

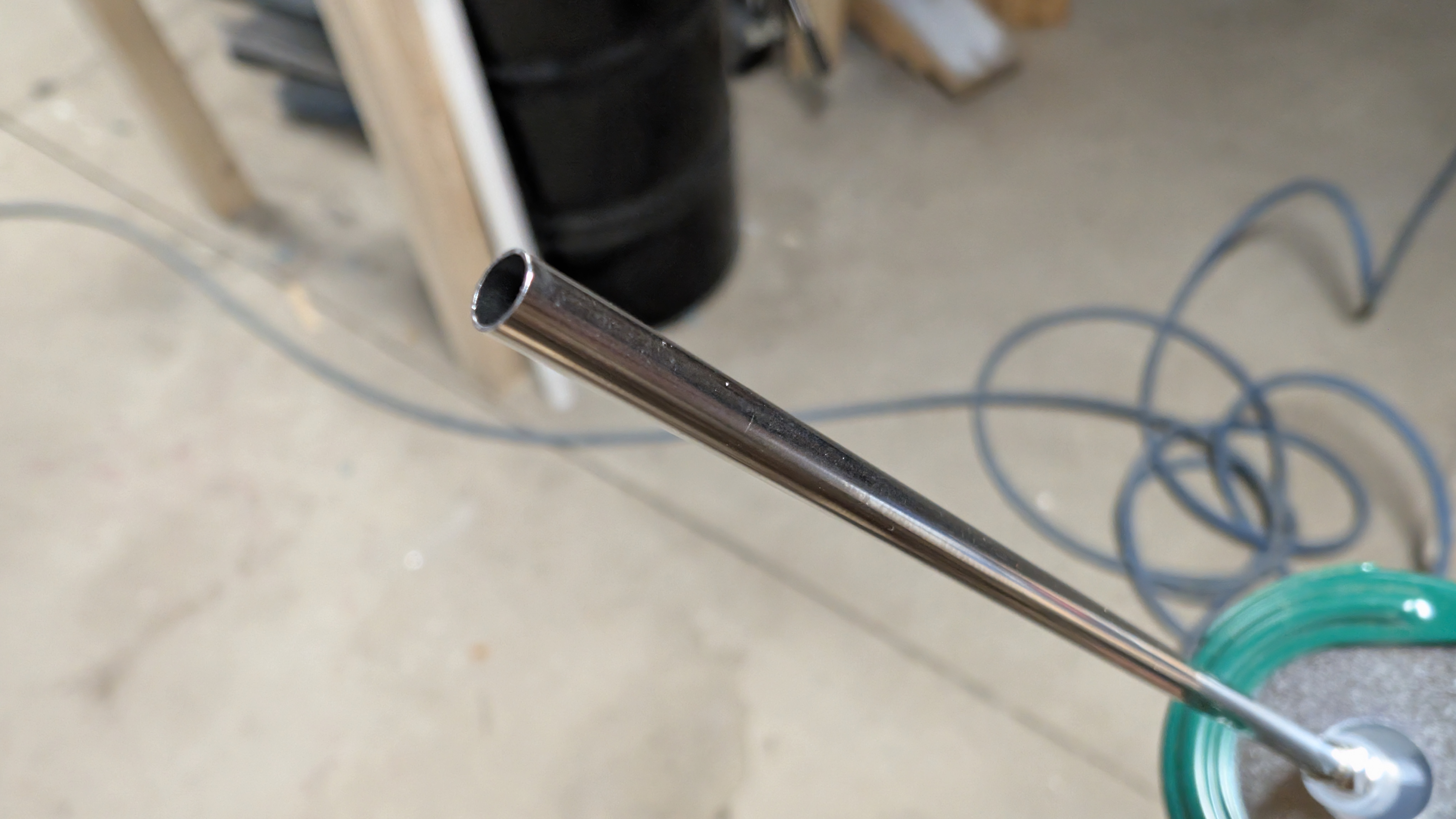

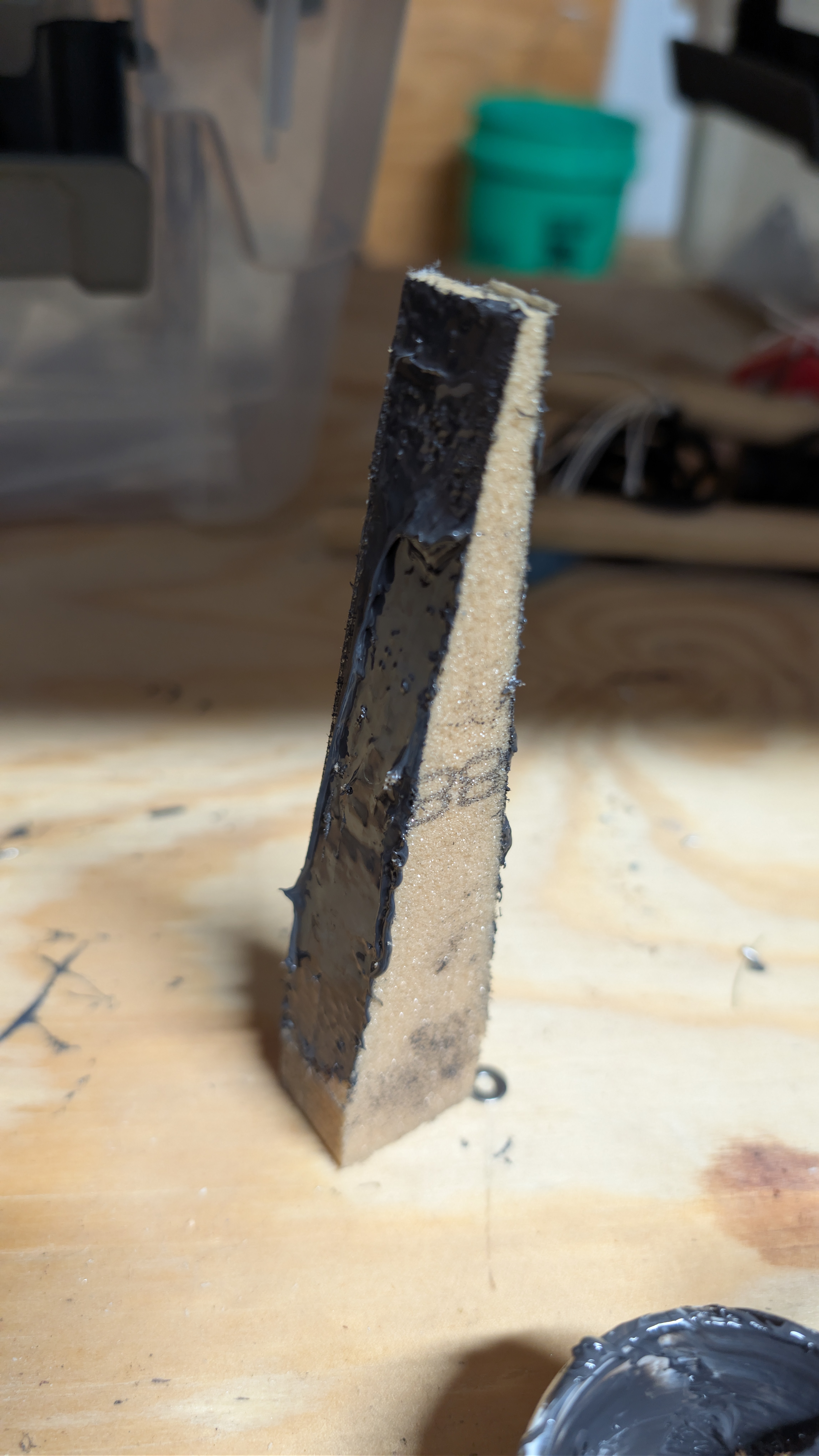

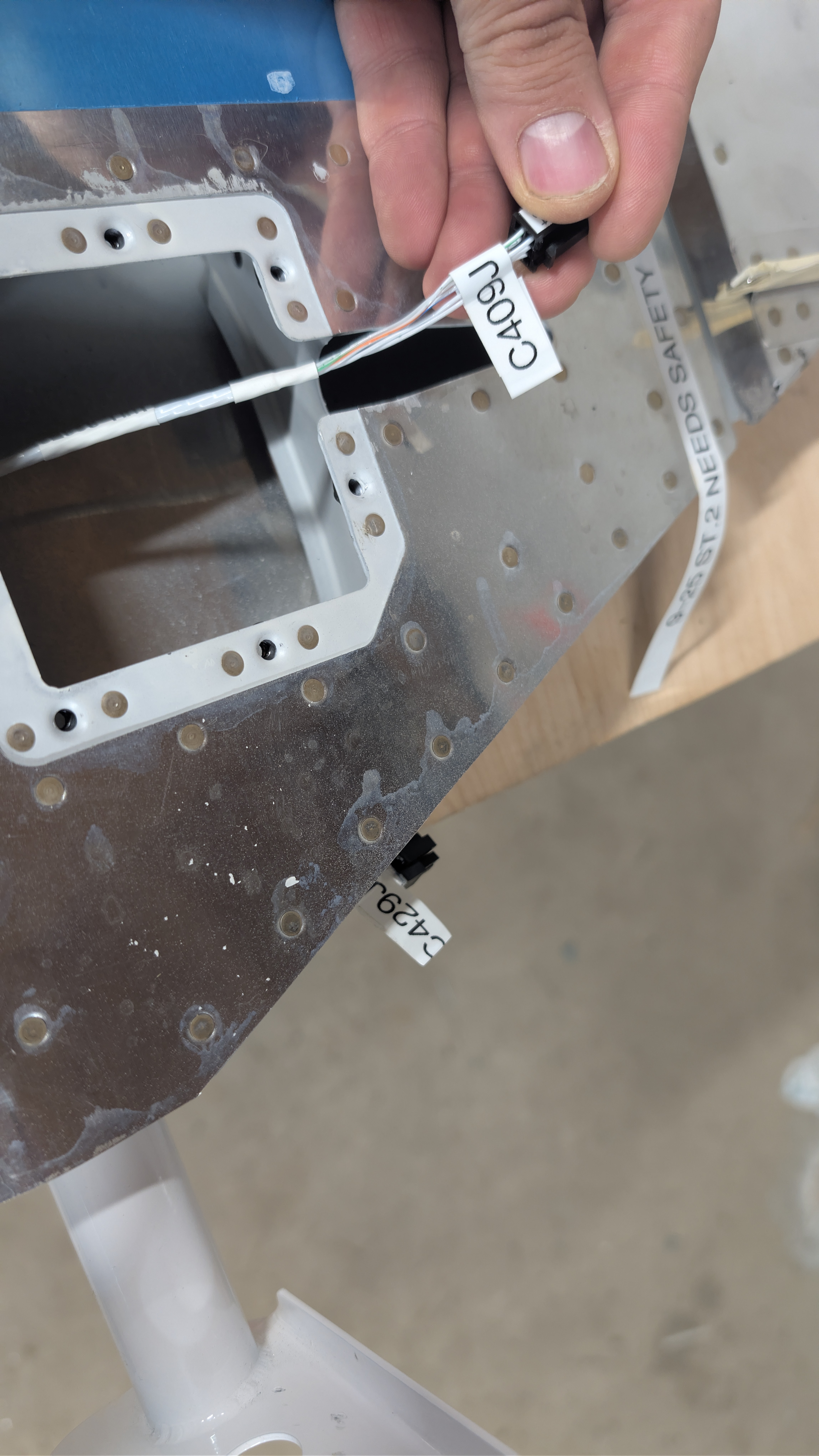

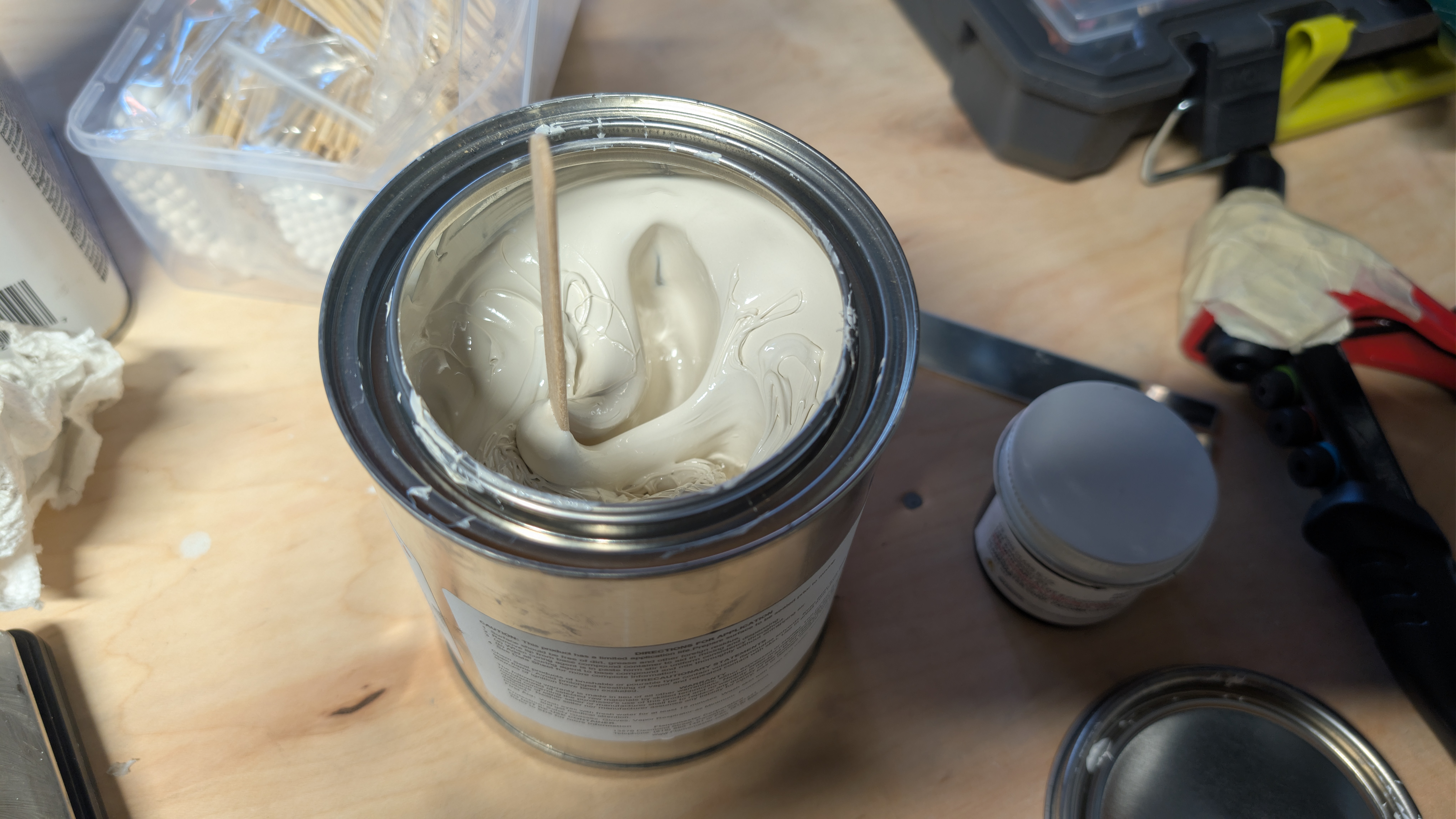

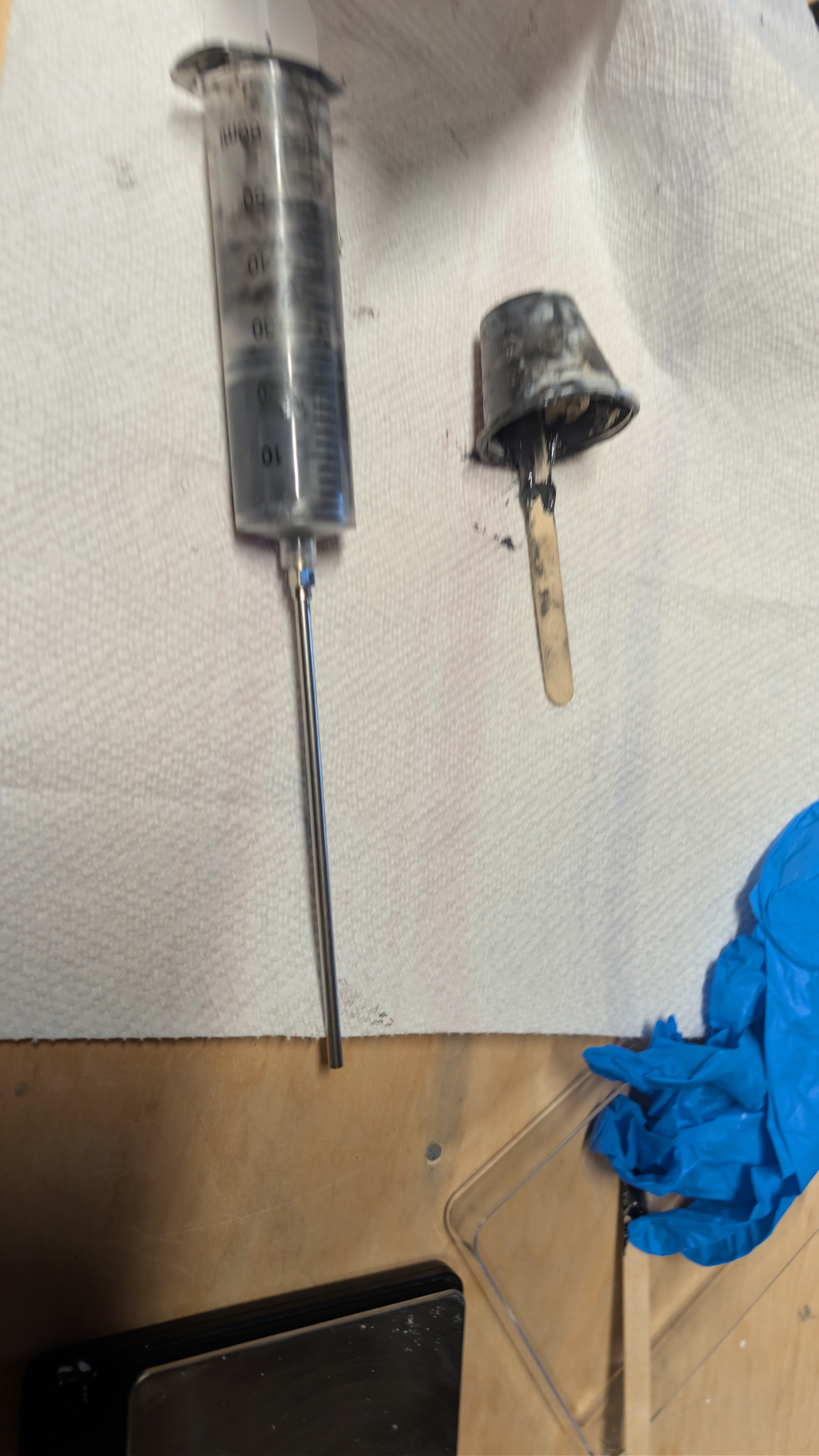

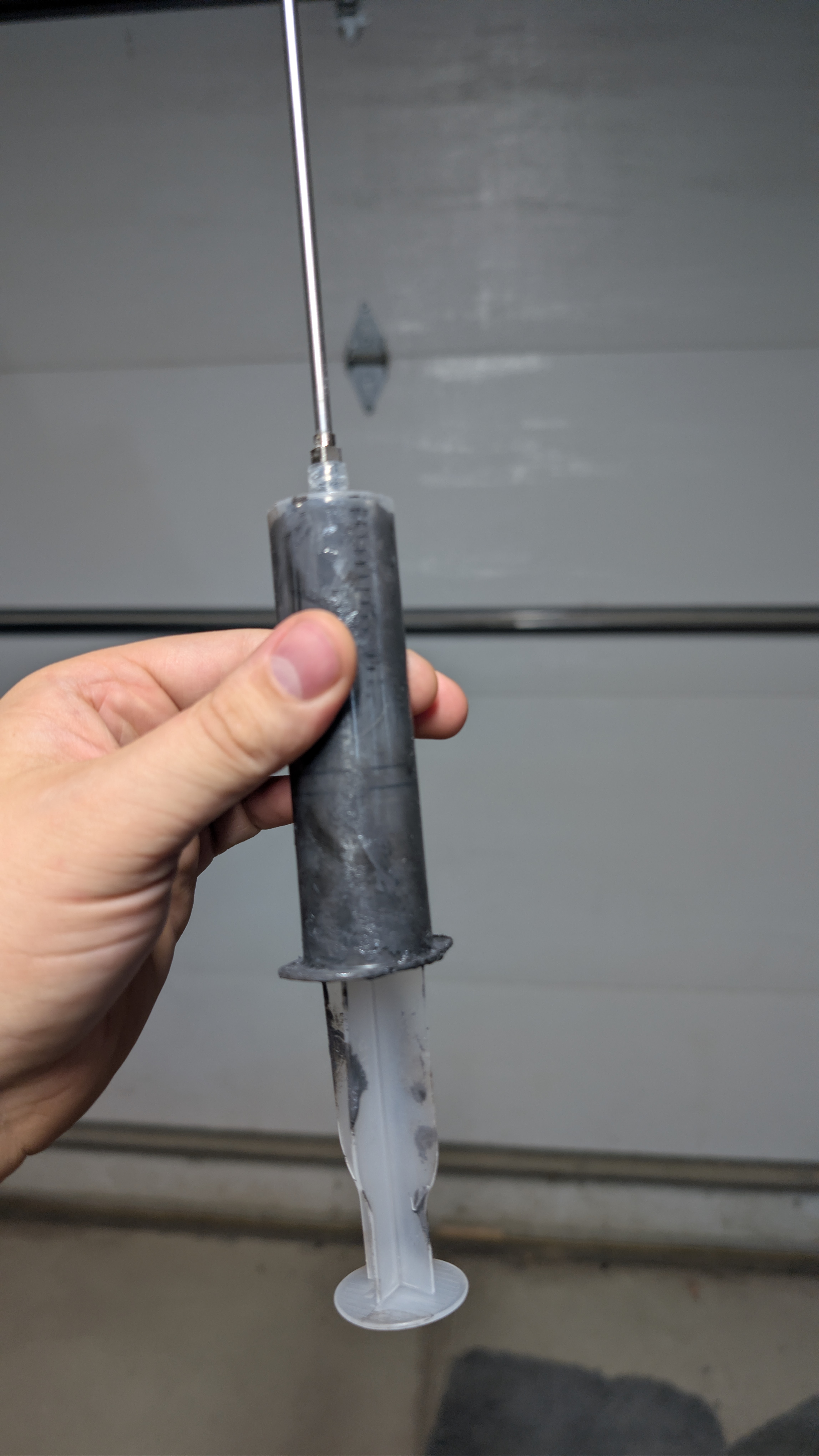

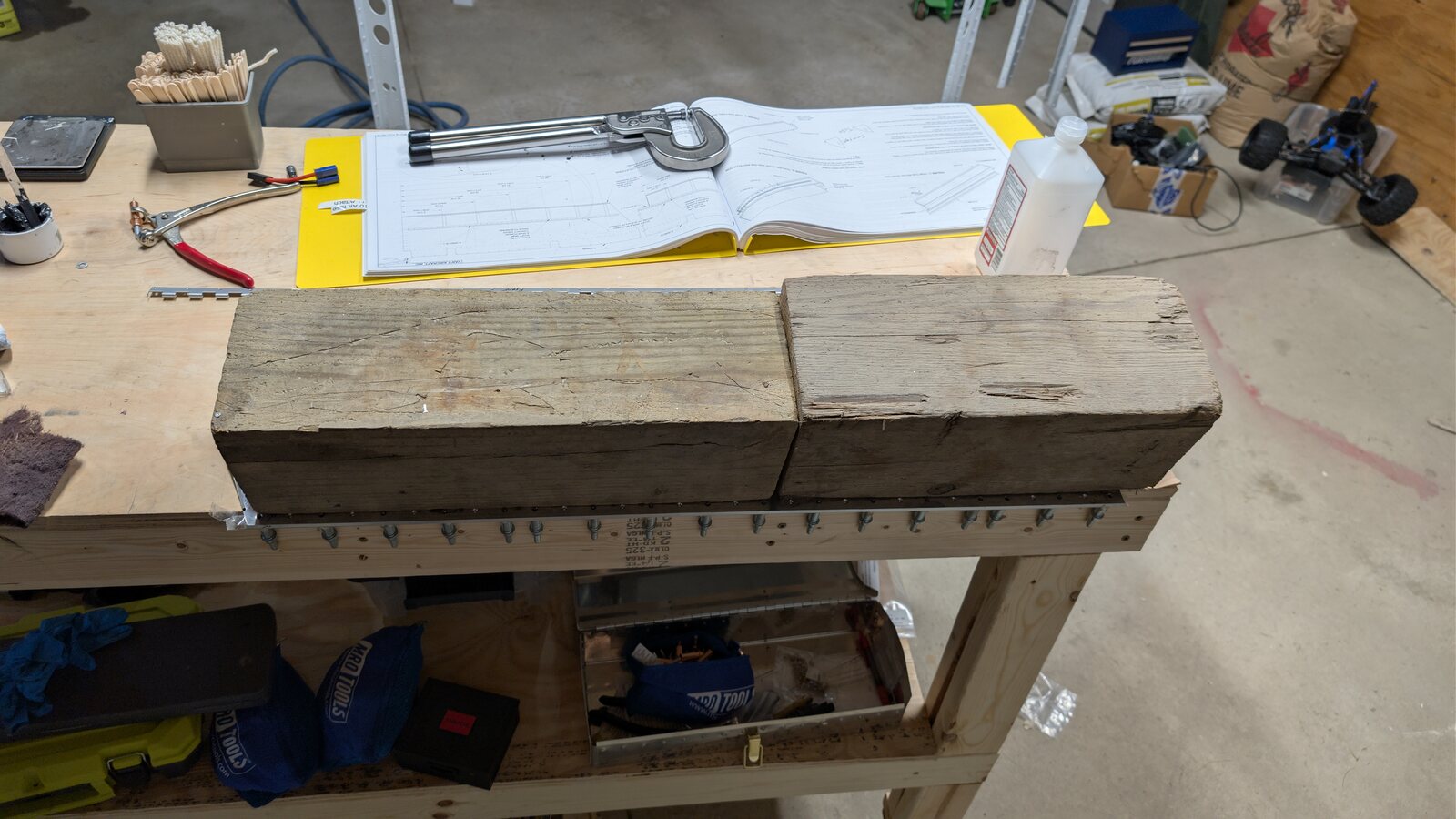

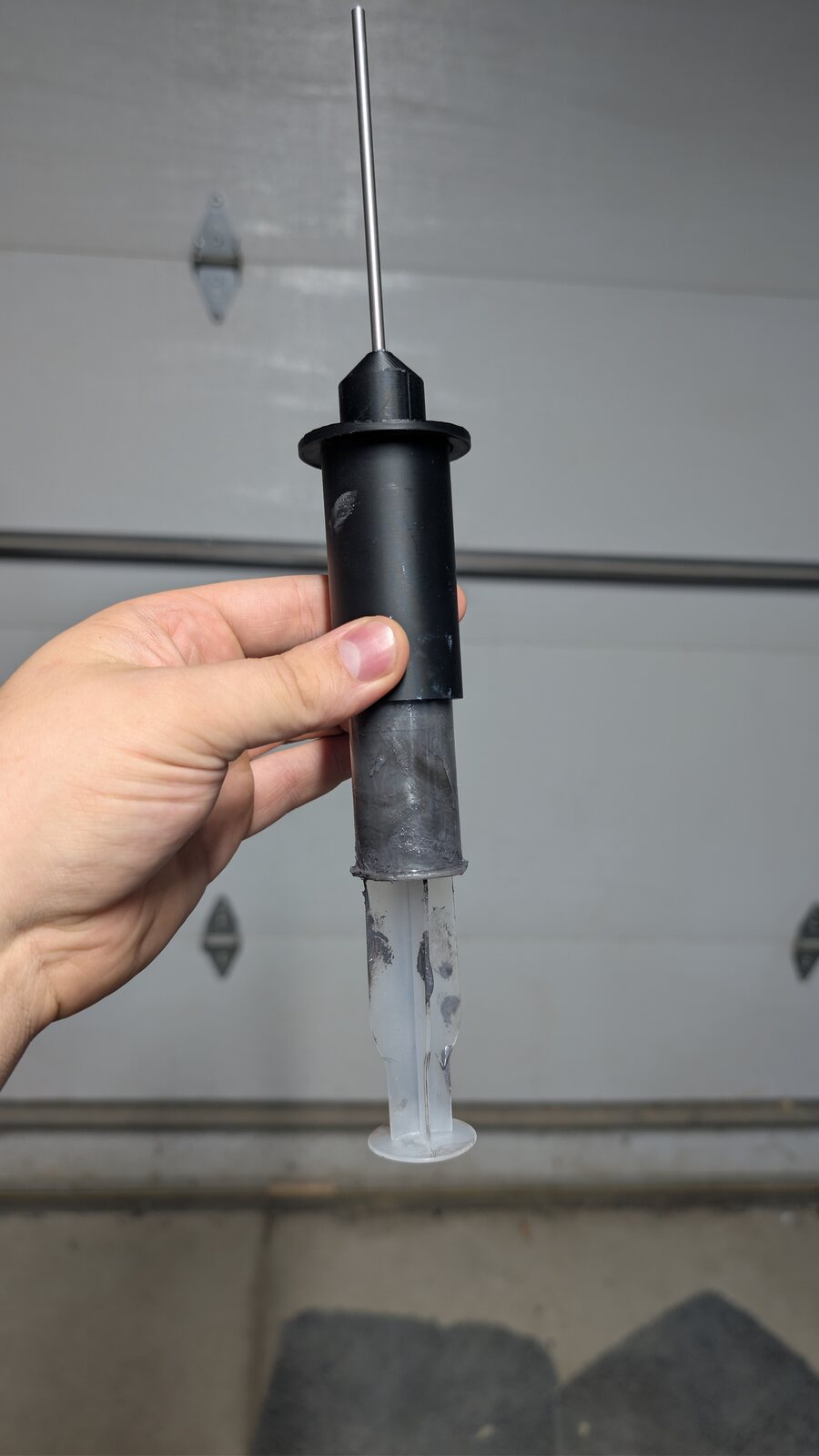

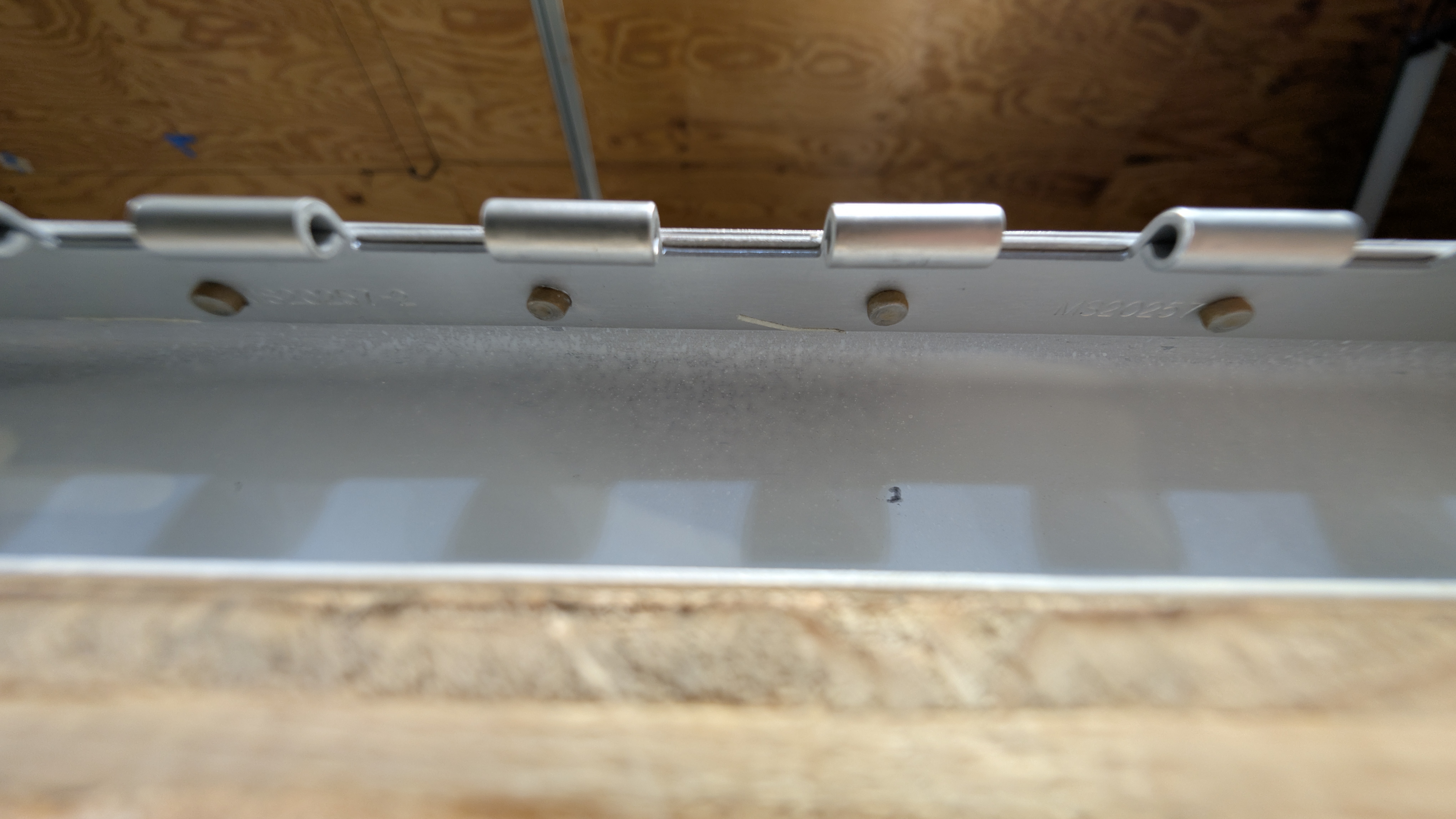

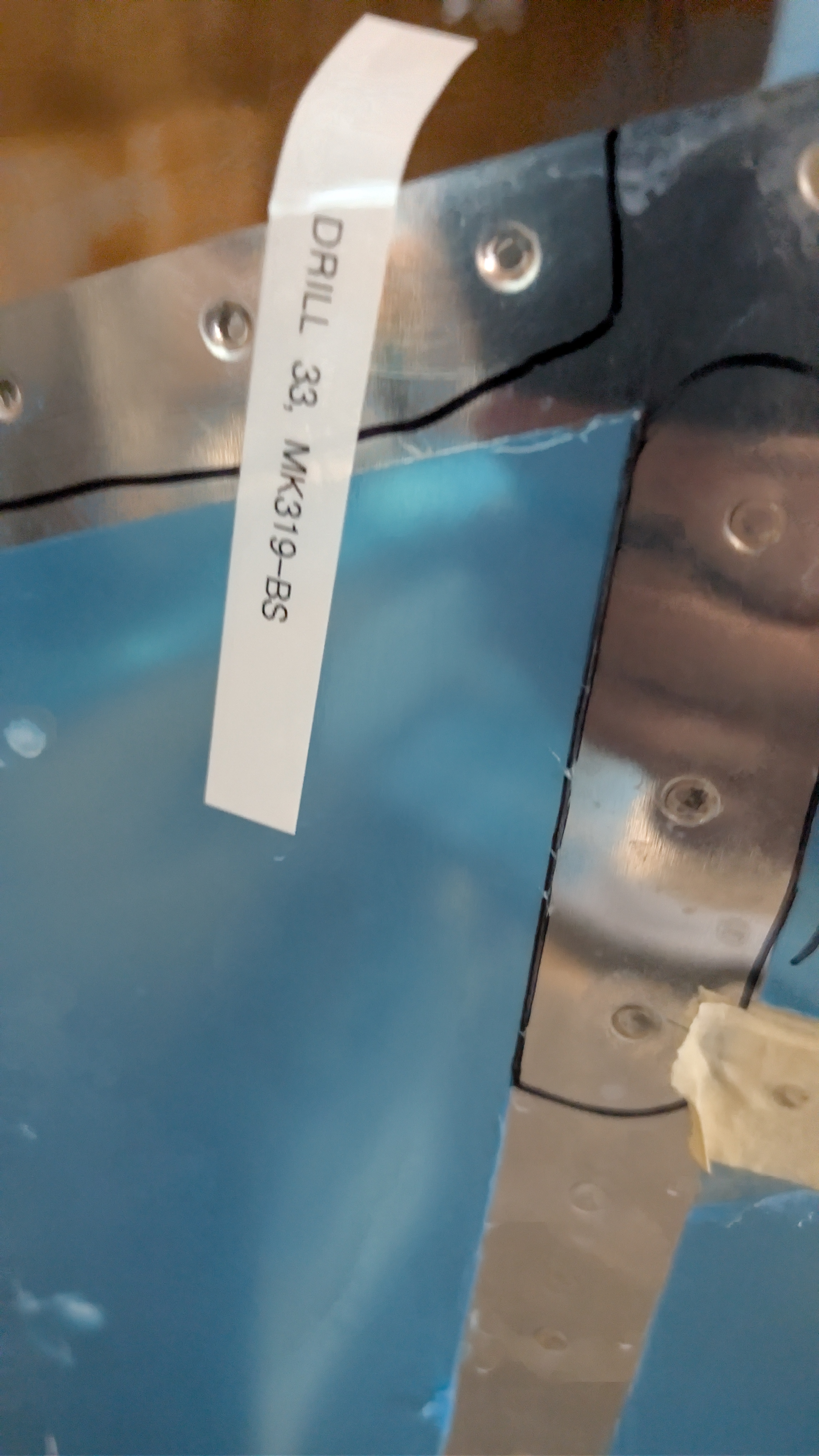

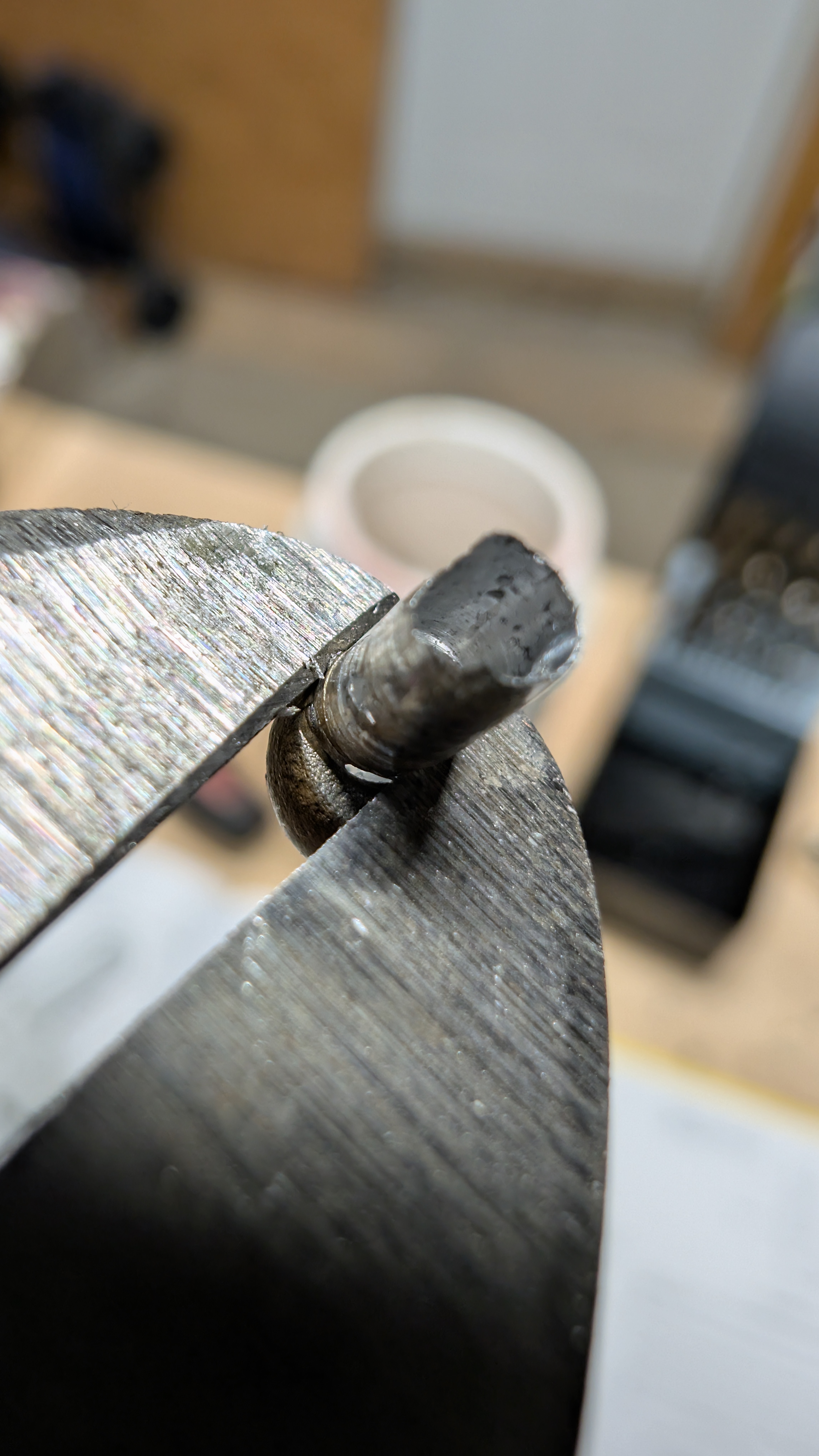

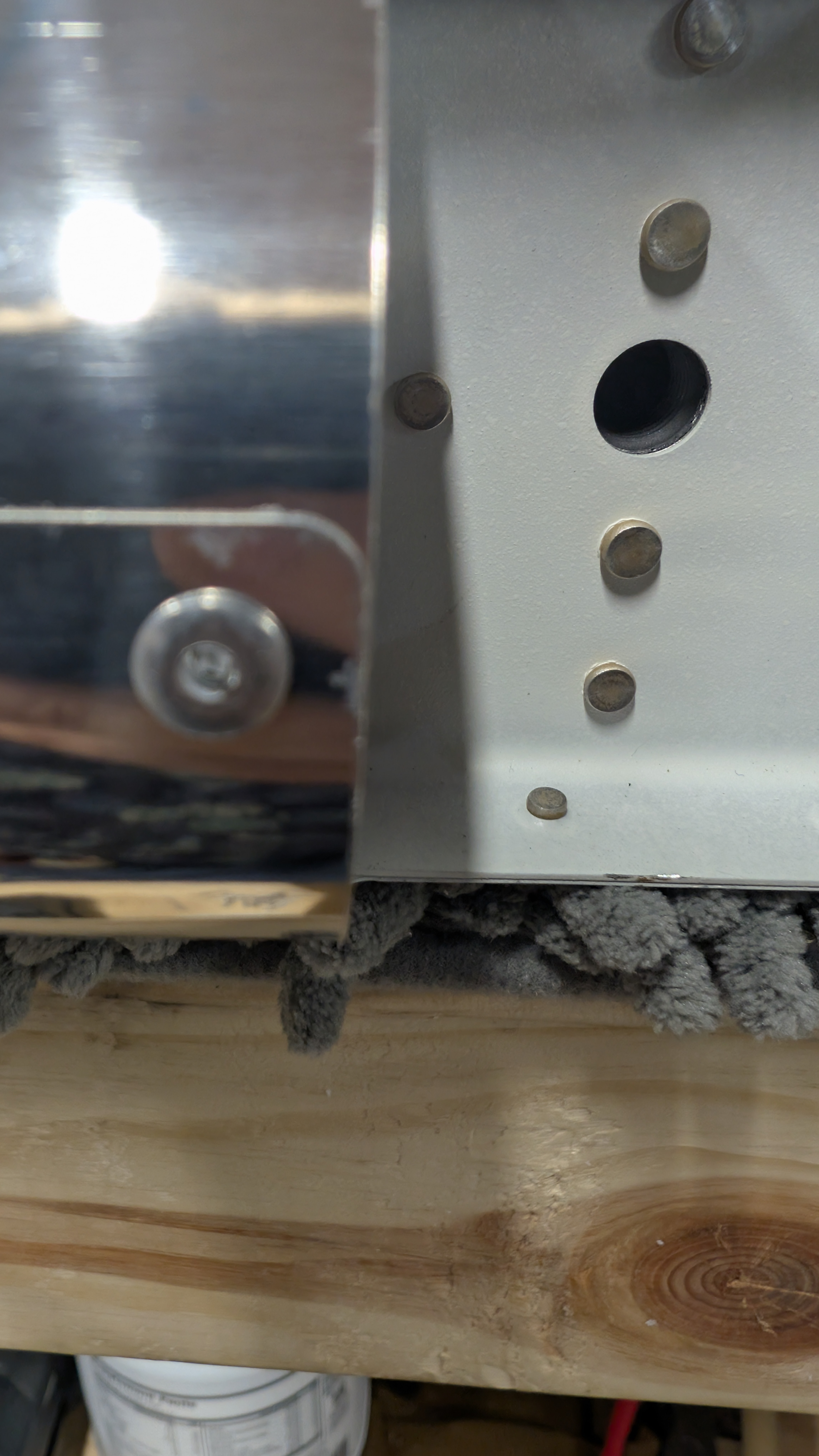

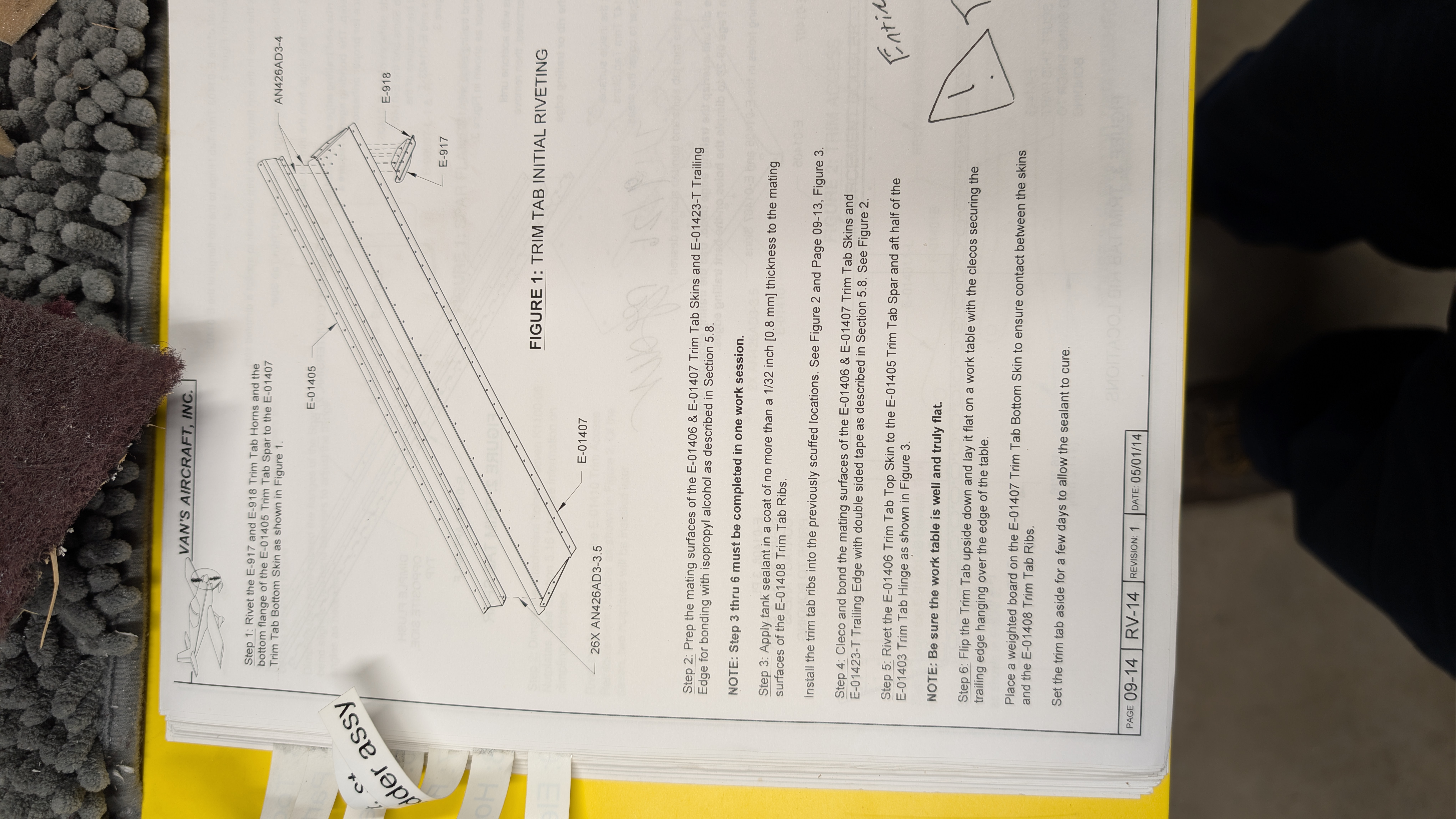

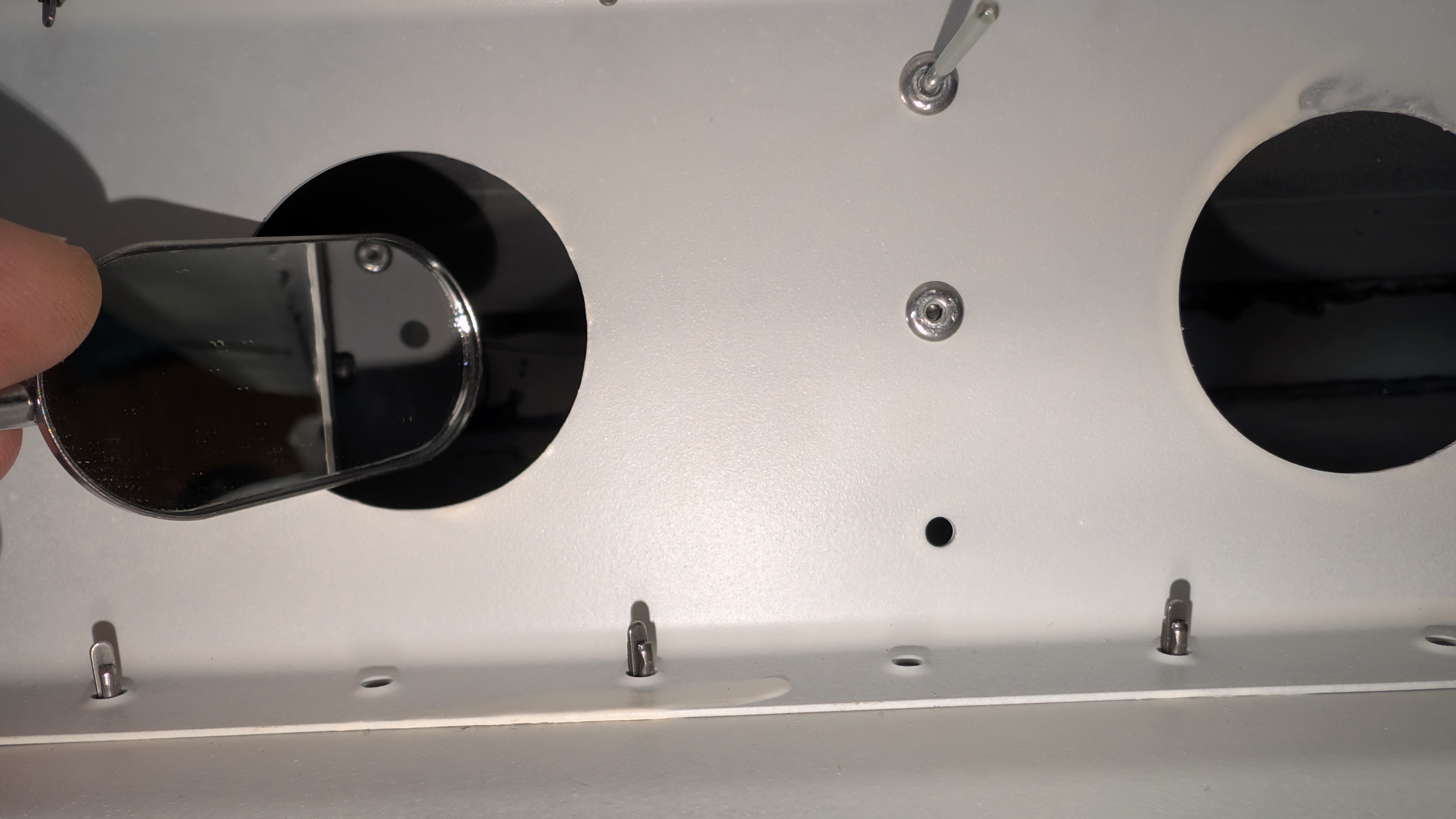

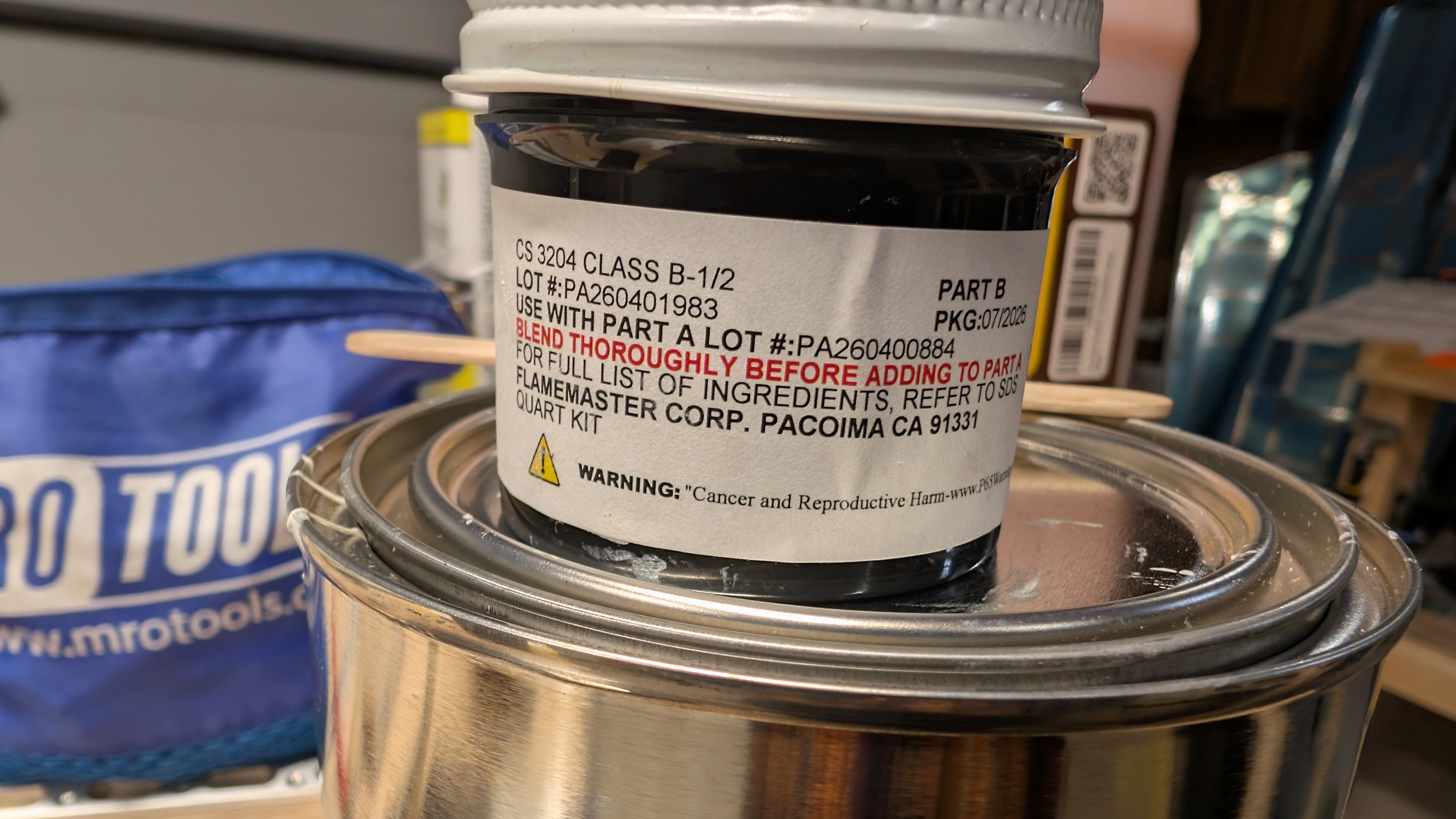

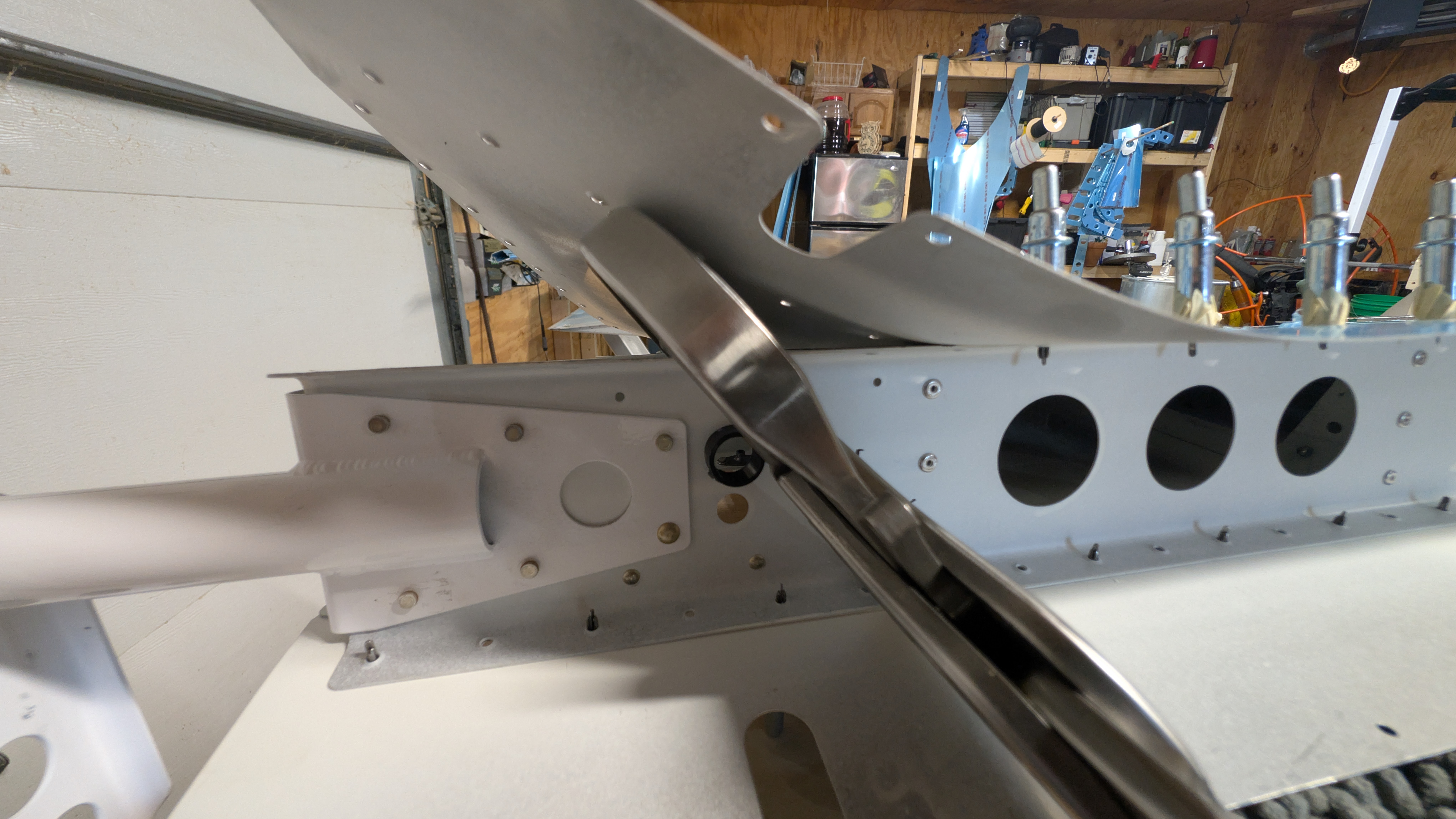

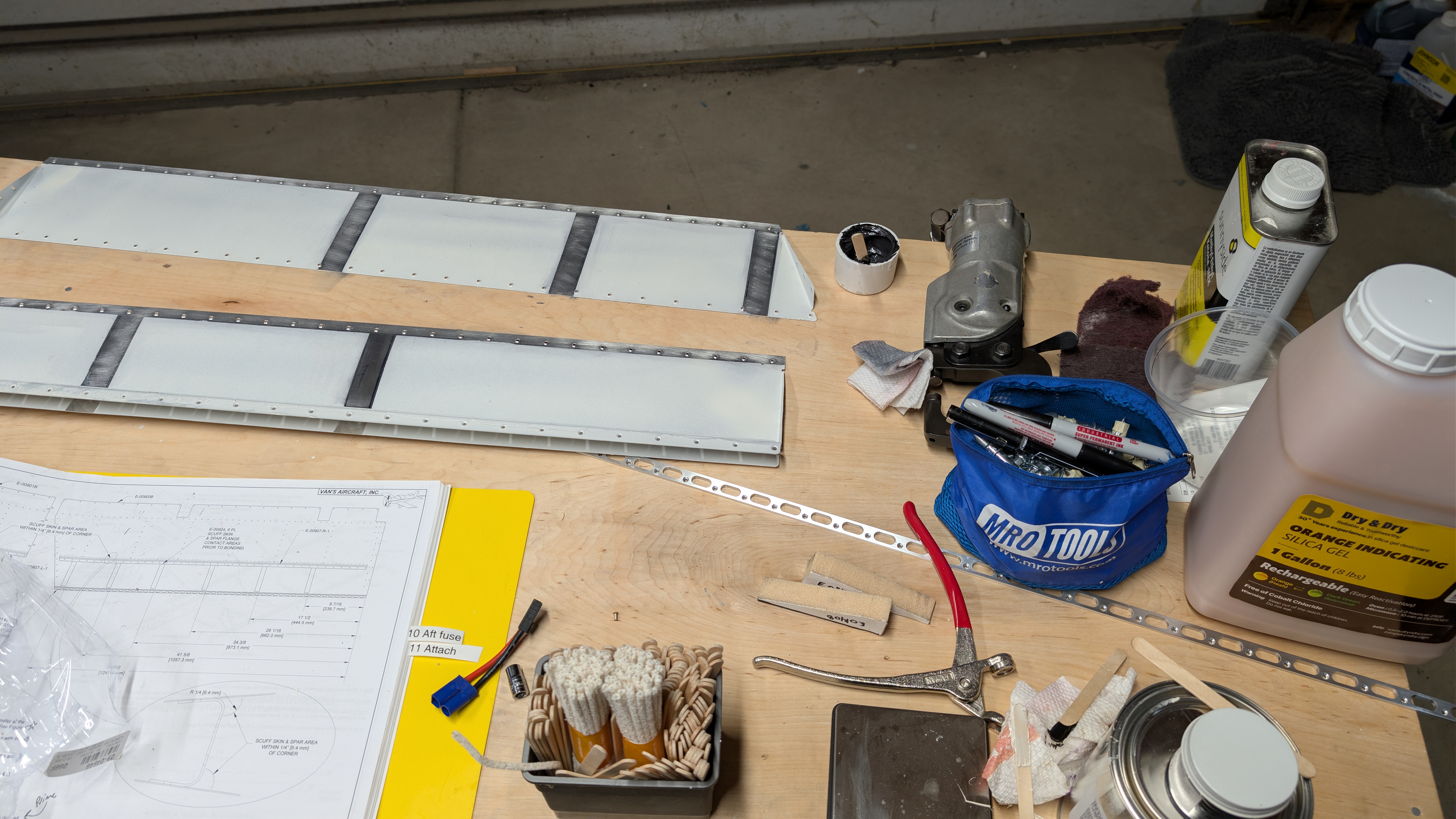

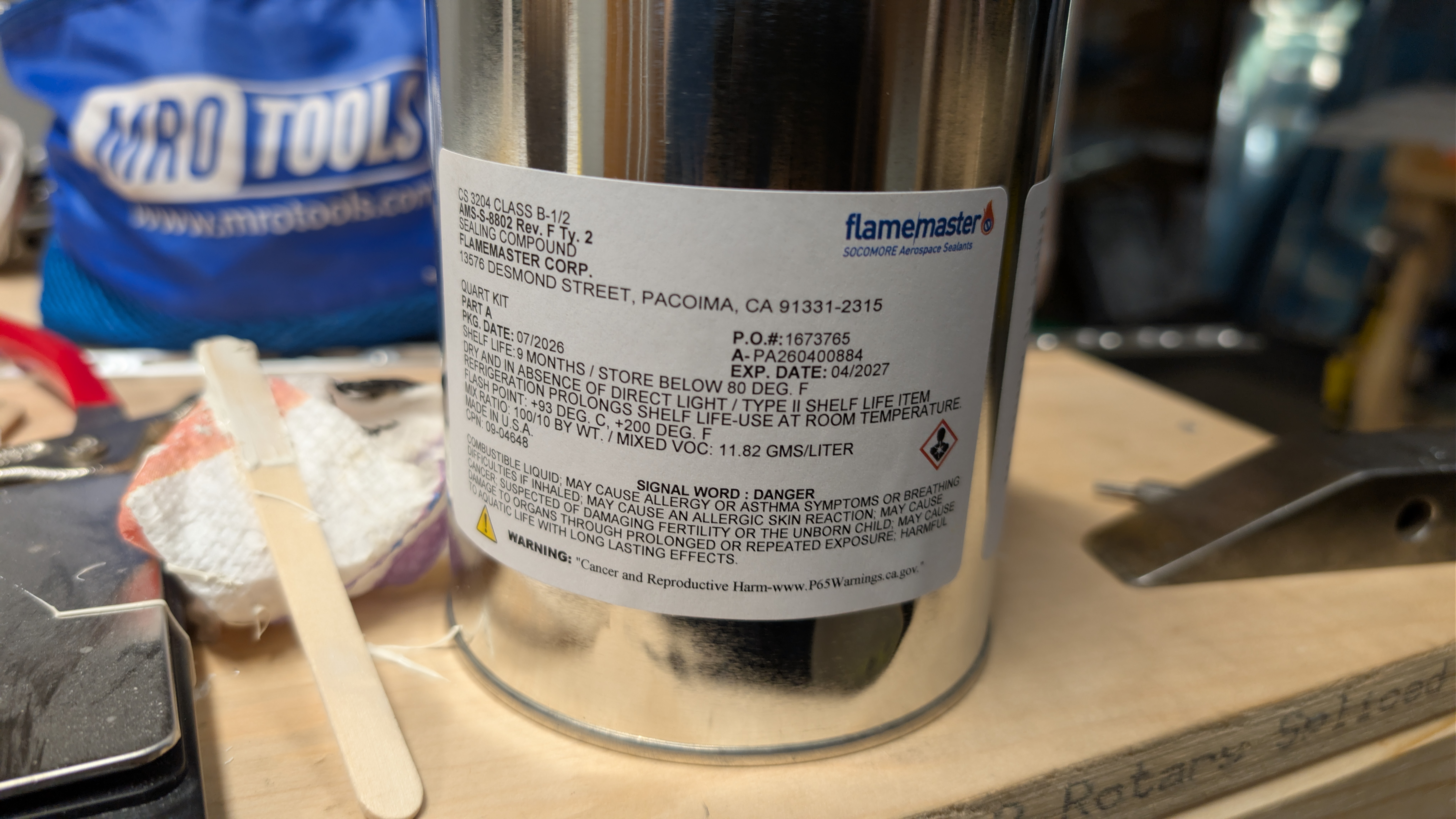

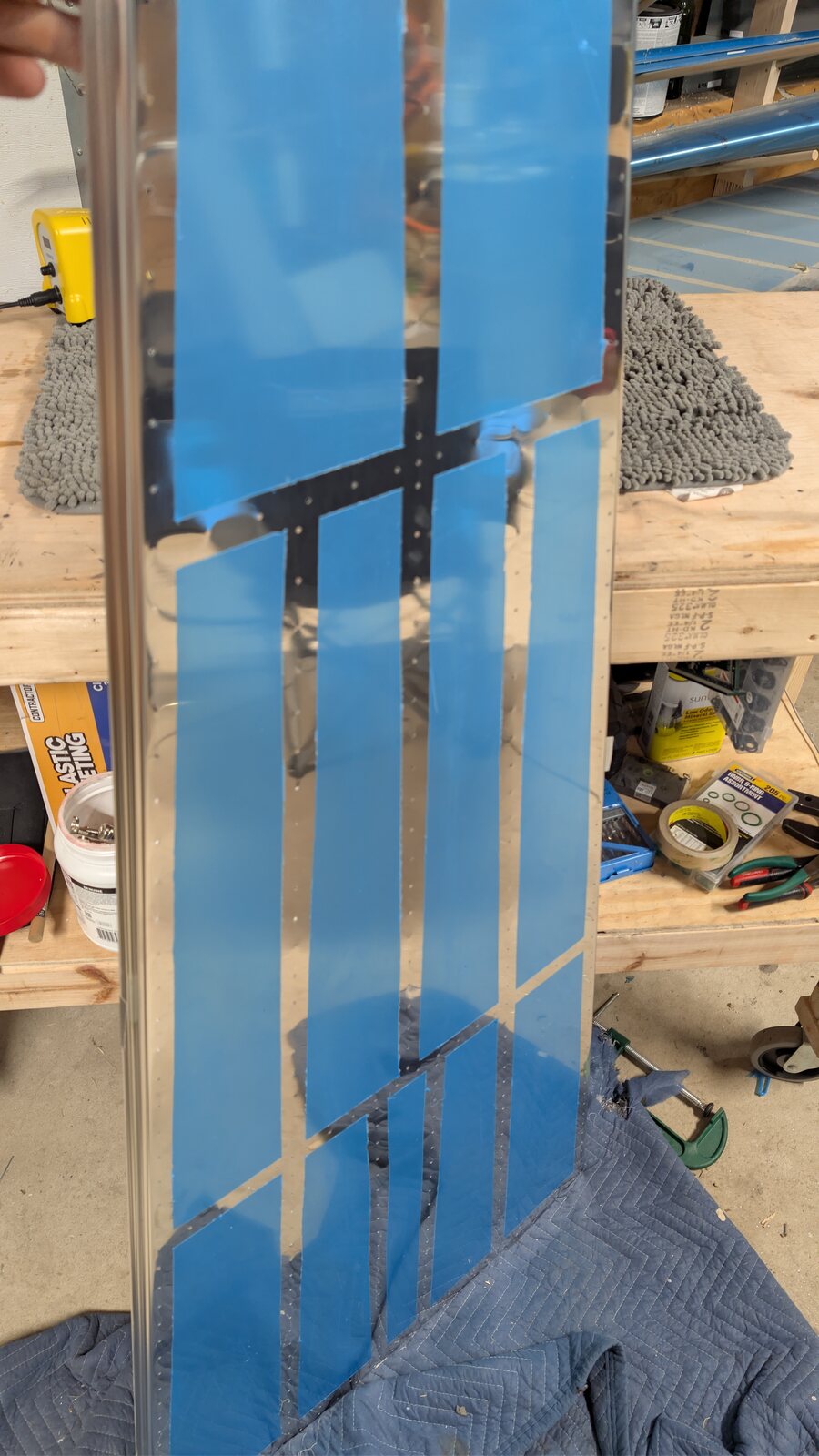

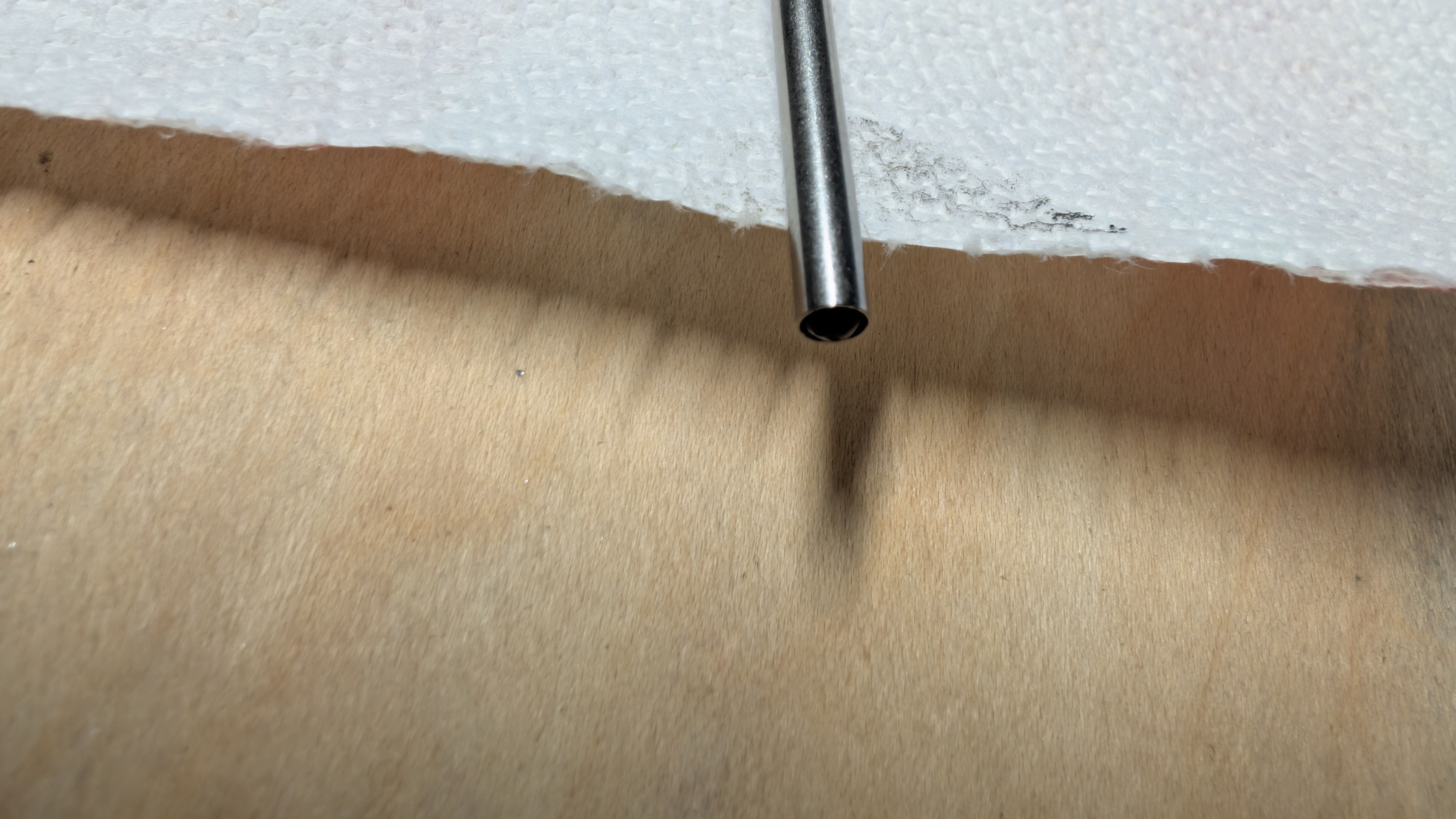

| 8/4 | 2.2 | | | | Trim tab assembly for elevator. | [1 (full), 2 (full), 3 (full), 4 (full), 5 (full), 6 (full), 7 (full), 8 (full), 9 (full), 10 (full), 11 (full), 12 (full)] |
| 8/5 | 0.0 | | | | | |

| 8/6 | 0.0 | | | | | [1 (full)] |
| 8/7 | 1.0 | | | | Trim tab in storage, assembling parts for the main portion of the elevator | |
| 8/8 | 0.0 | | | | | |
| 8/9 | 5.0 | 3.0 | | | Began main control surface assembly for elevator. | |
| 8/10 | 0.0 | | | | | |
| 8/11 | 0.0 | | | | | |
| 8/12 | 0.0 | | | | | |
| 8/13 | 0.0 | | | | | |
| 8/14 | 0.0 | | | | | |
| 8/15 | 0.0 | | | | | |

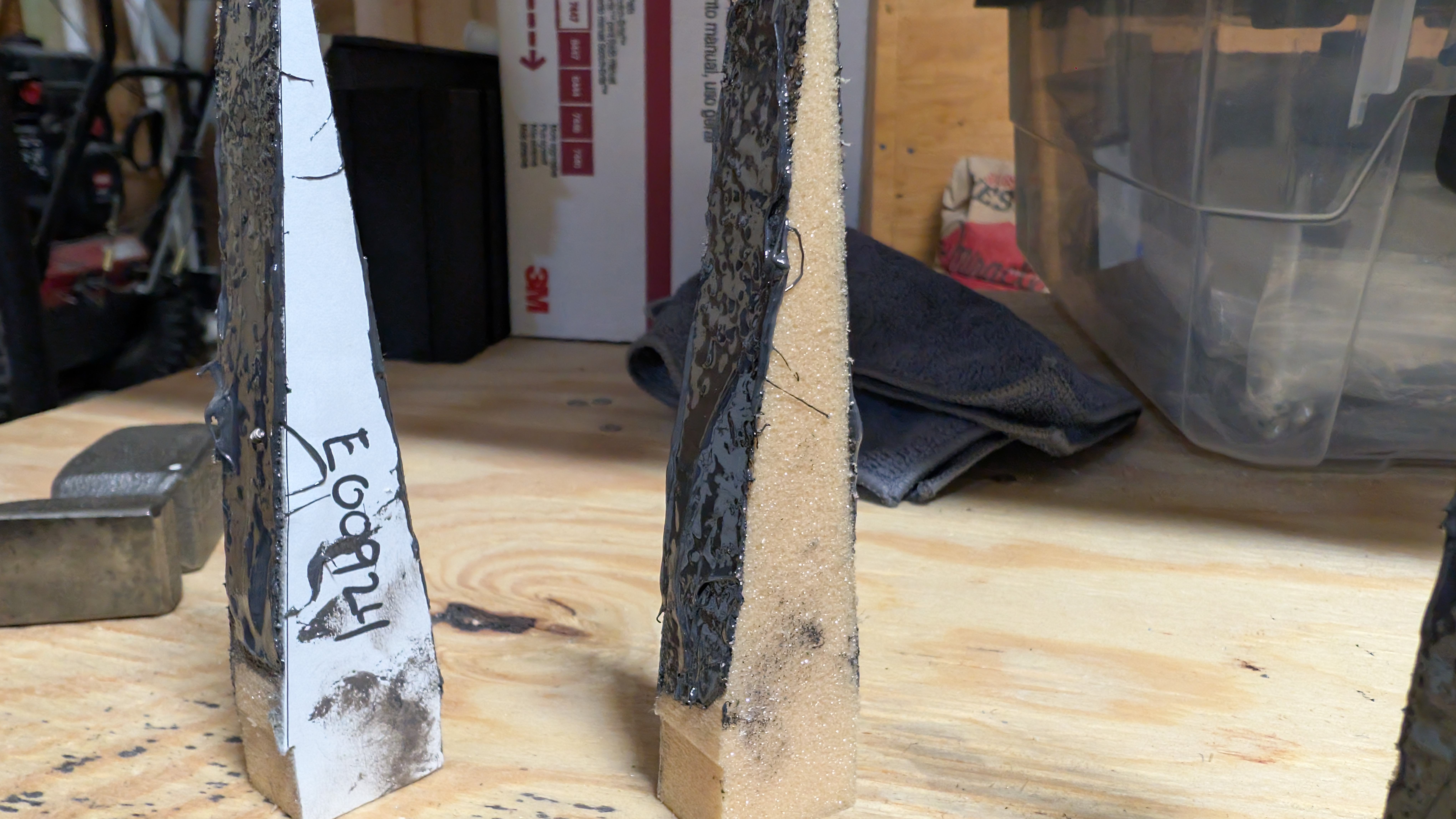

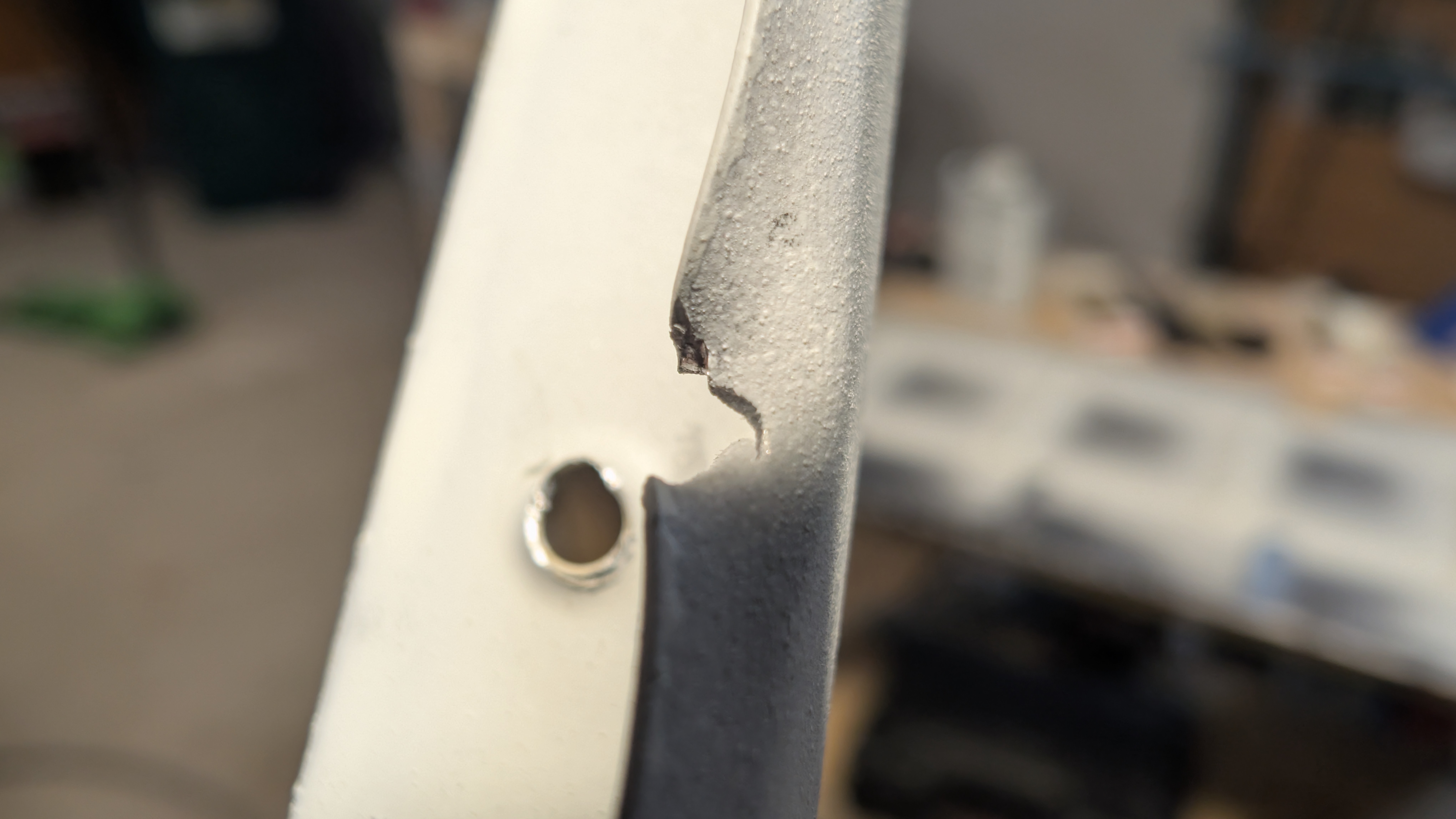

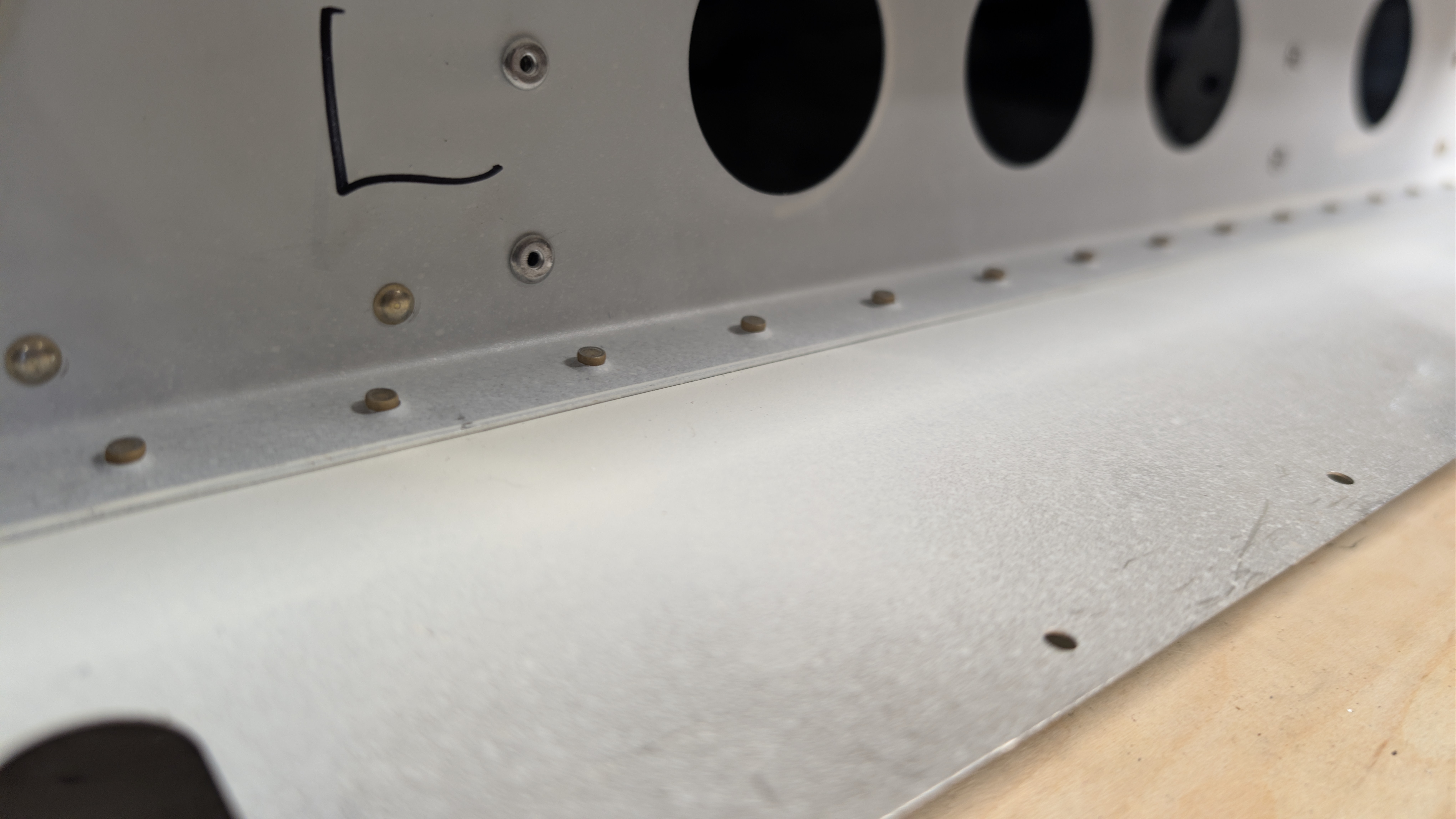

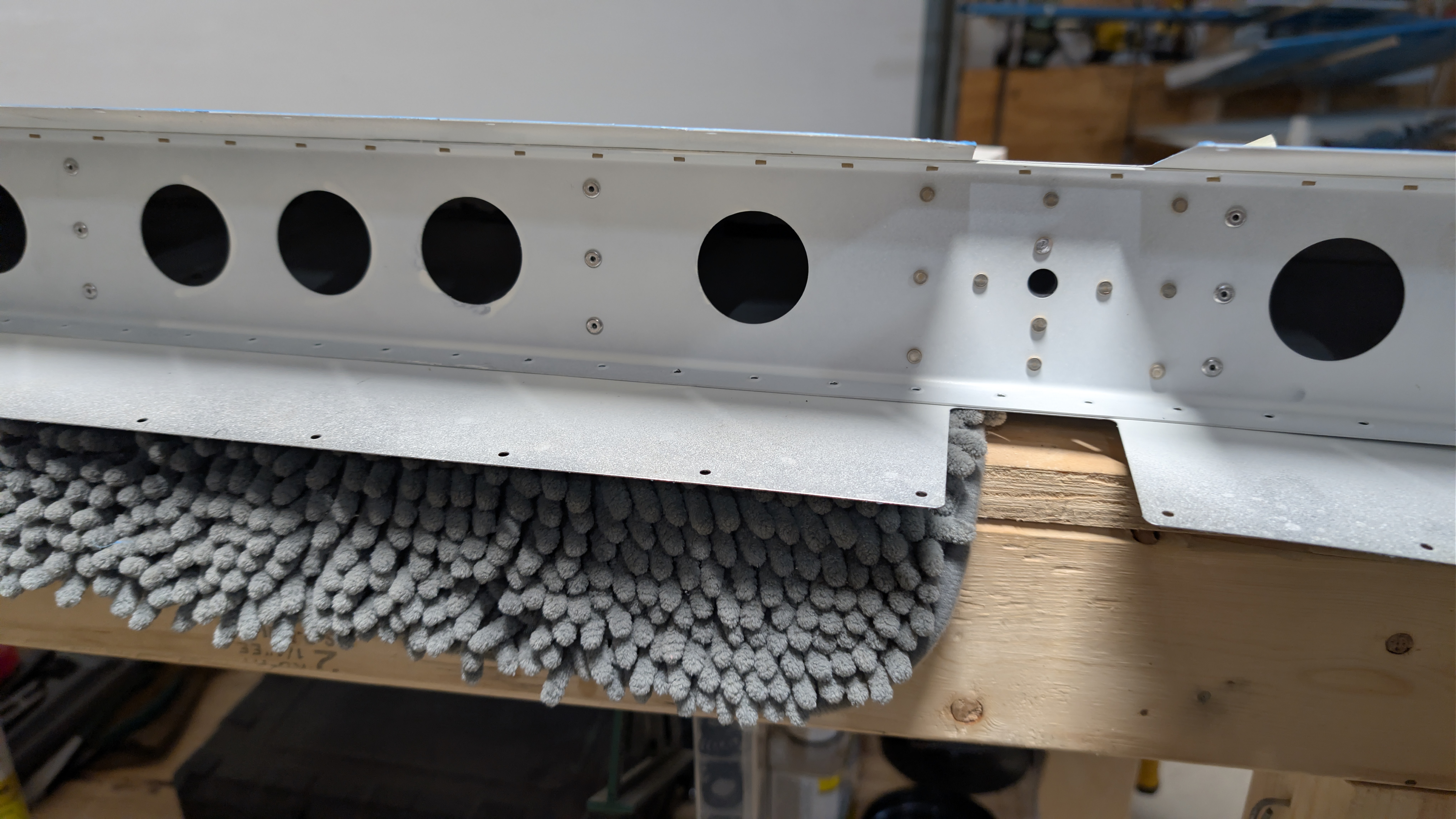

| 8/16 | 1.2 | | | | Rivetted ribs to rear elevator spar | |

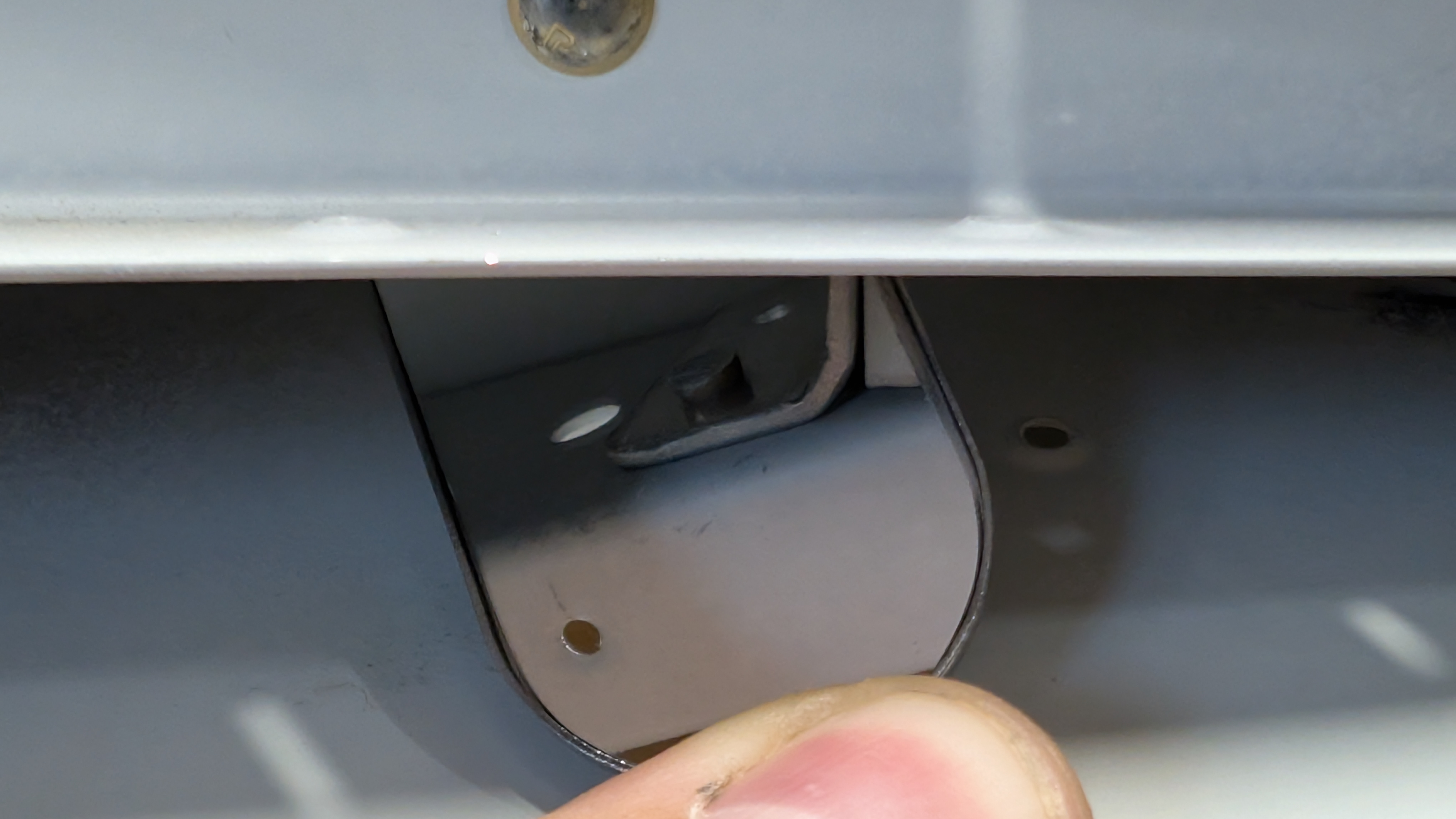

| 8/17 | 2.0 | | | | Continued riveting ribs to rear elevator spar | |

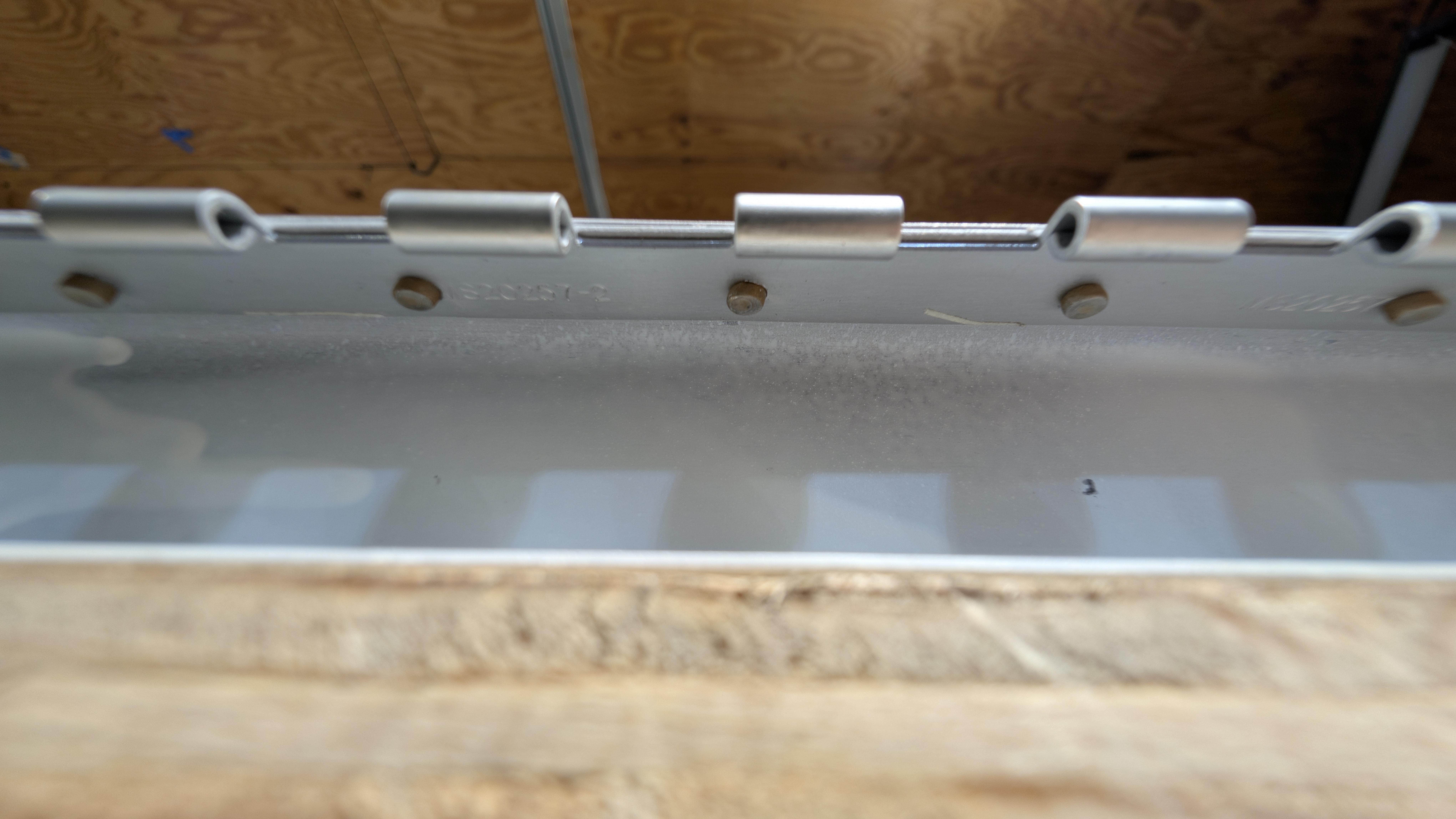

| 8/18 | 0.0 | | | | | [1 (full), 2 (full), 3 (full), 4 (full)] |

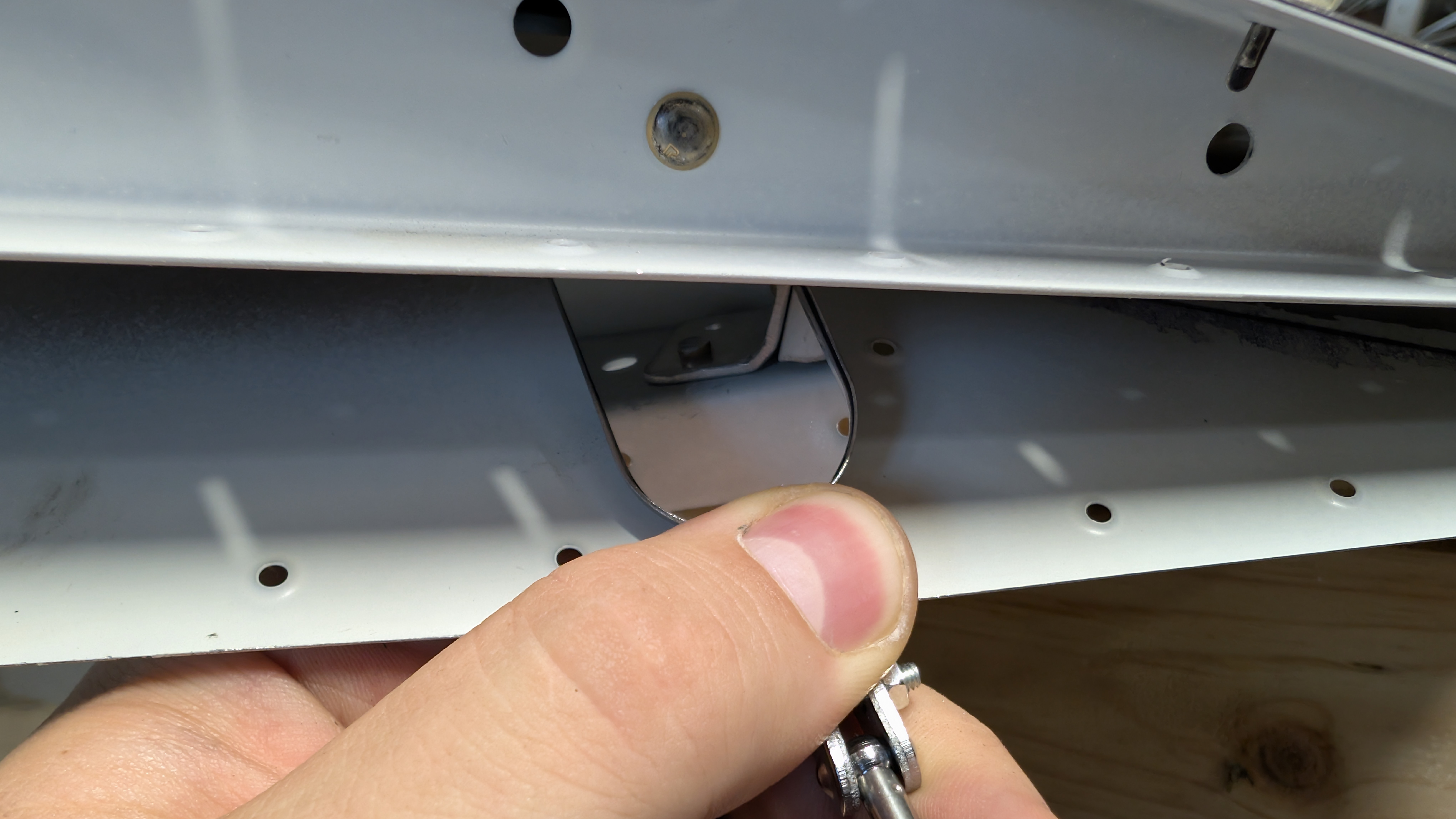

| 8/19 | 1.5 | | | | riveted piano hinge to elevator body for trim tab. | |

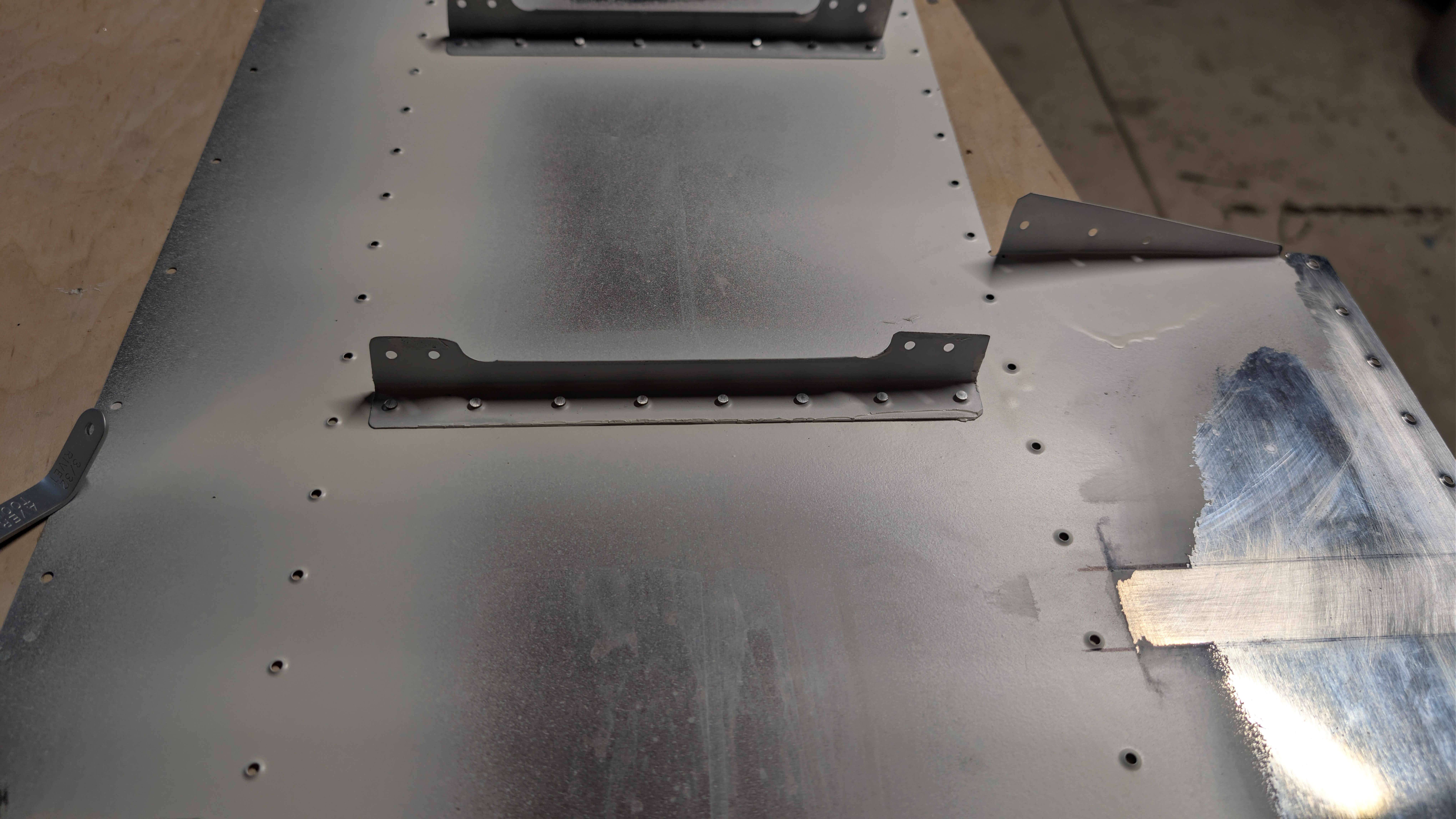

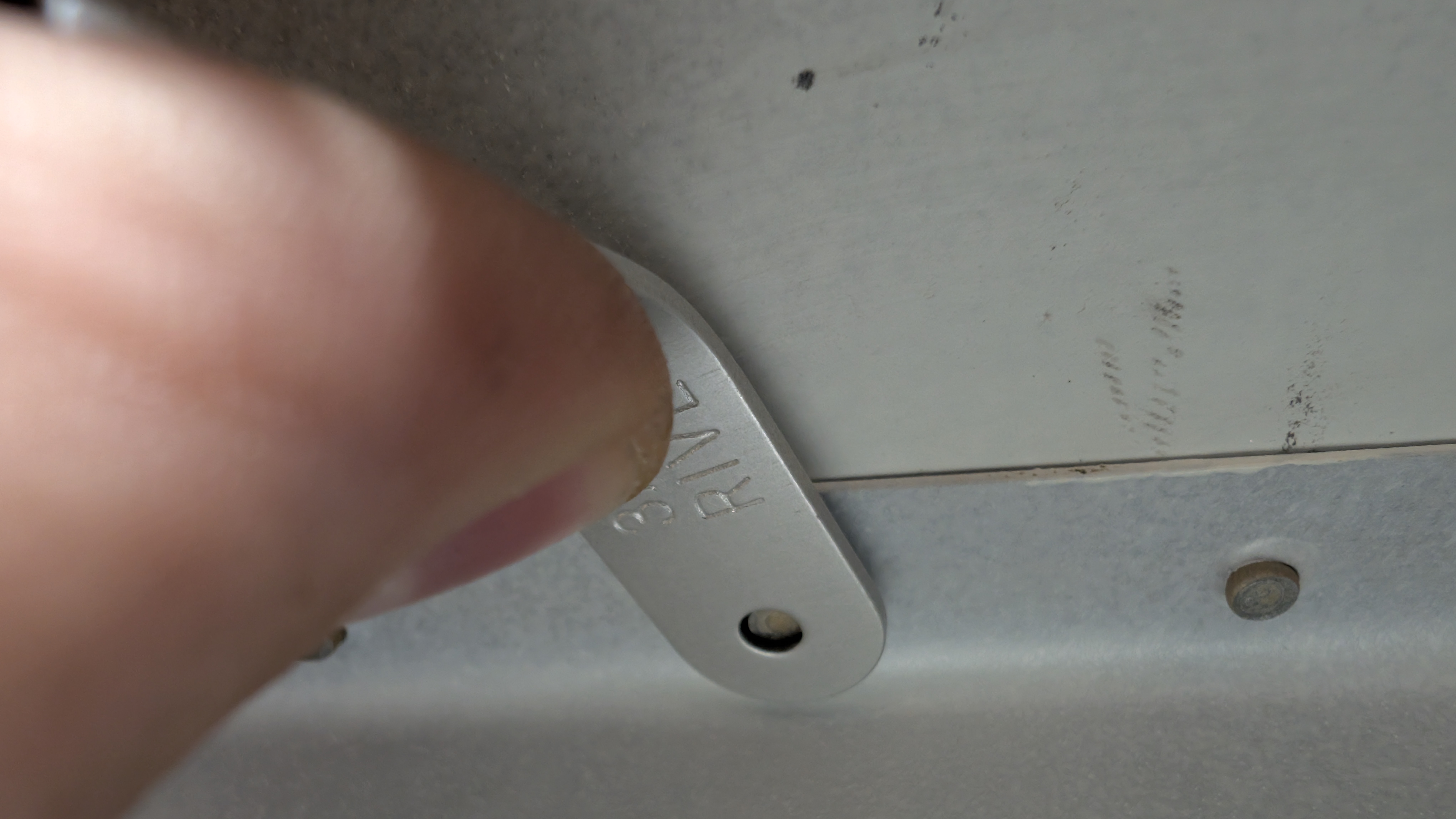

| 8/20 | 3.0 | | | | Back-riveting ribs onto skins | [1 (full), 2 (full), 3 (full), 4 (full), 5 (full), 6 (full)] |

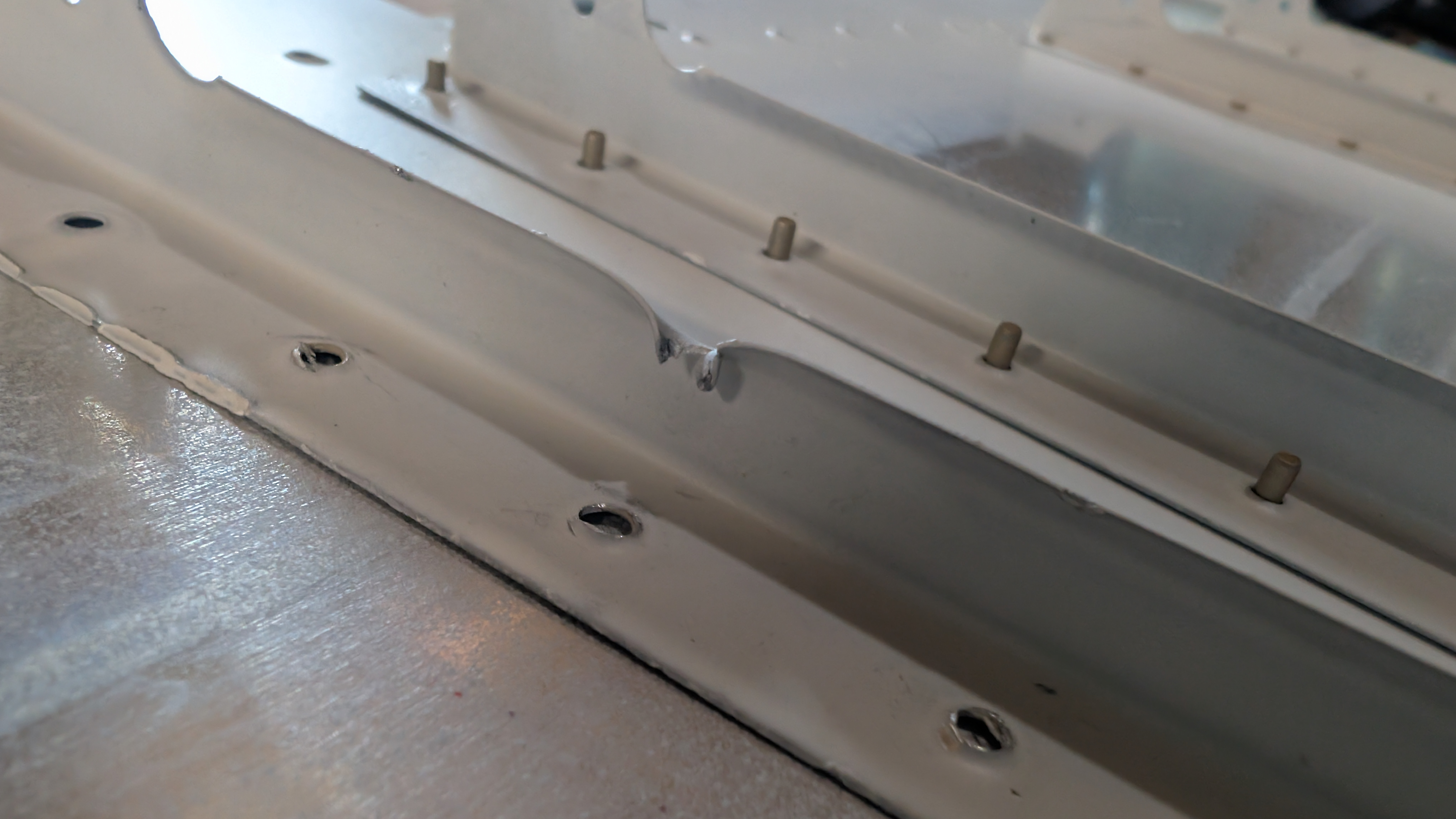

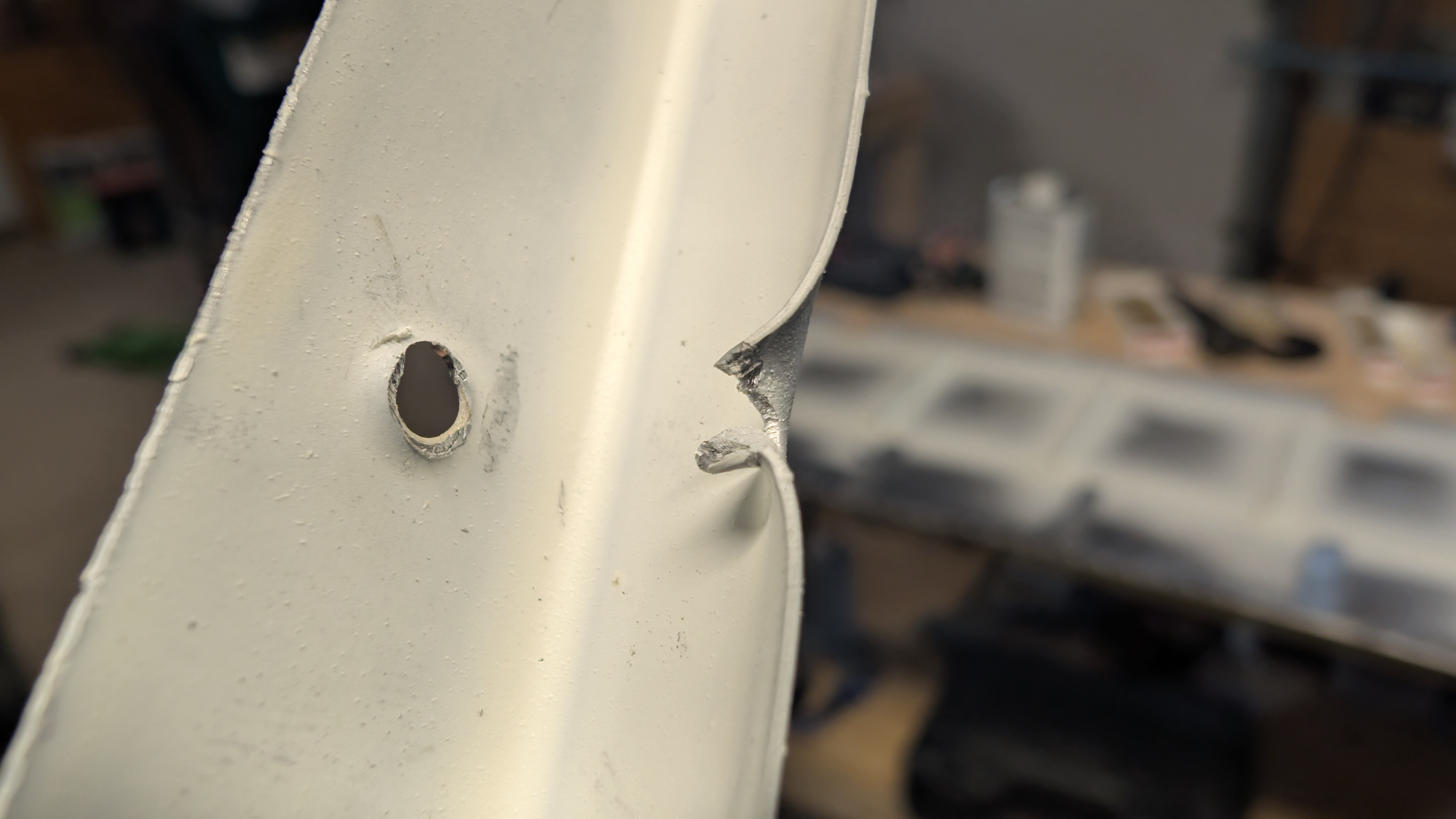

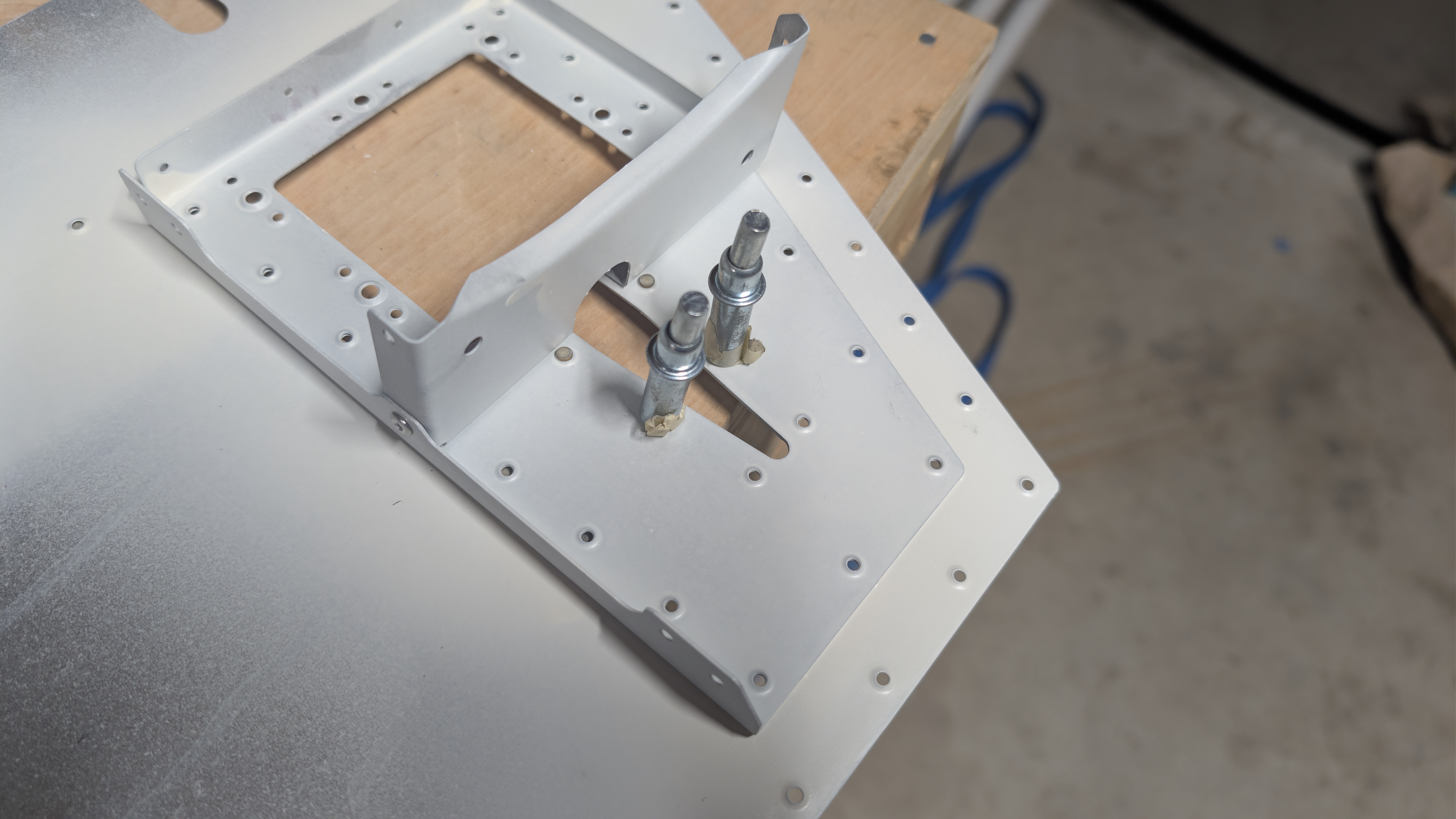

| 8/21 | 3.0 | | | | Back-riveting continues, servo mount as well. | [1 (full), 2 (full), 3 (full), 4 (full)] |
| 8/22 | 0.0 | | | | | |

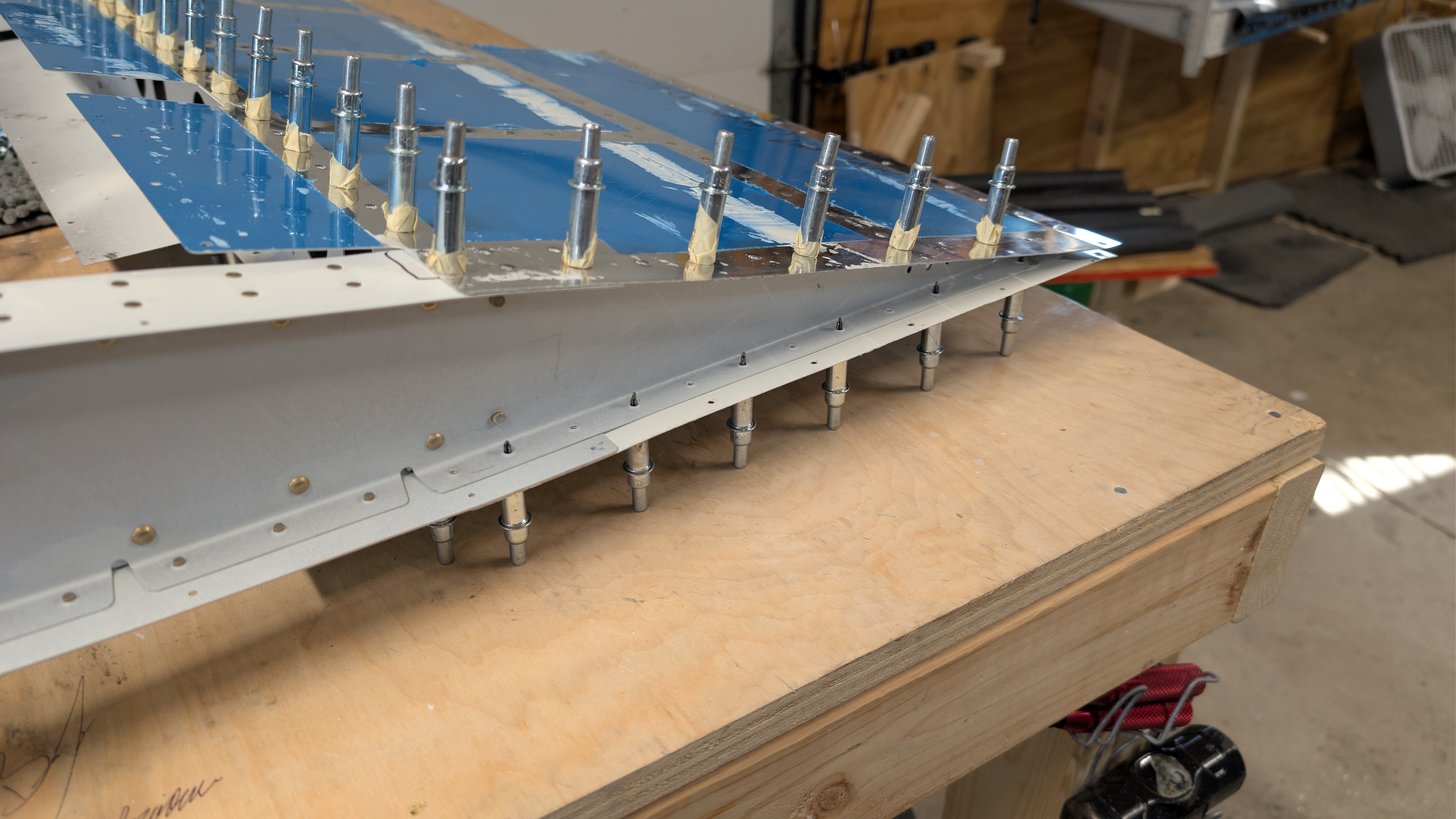

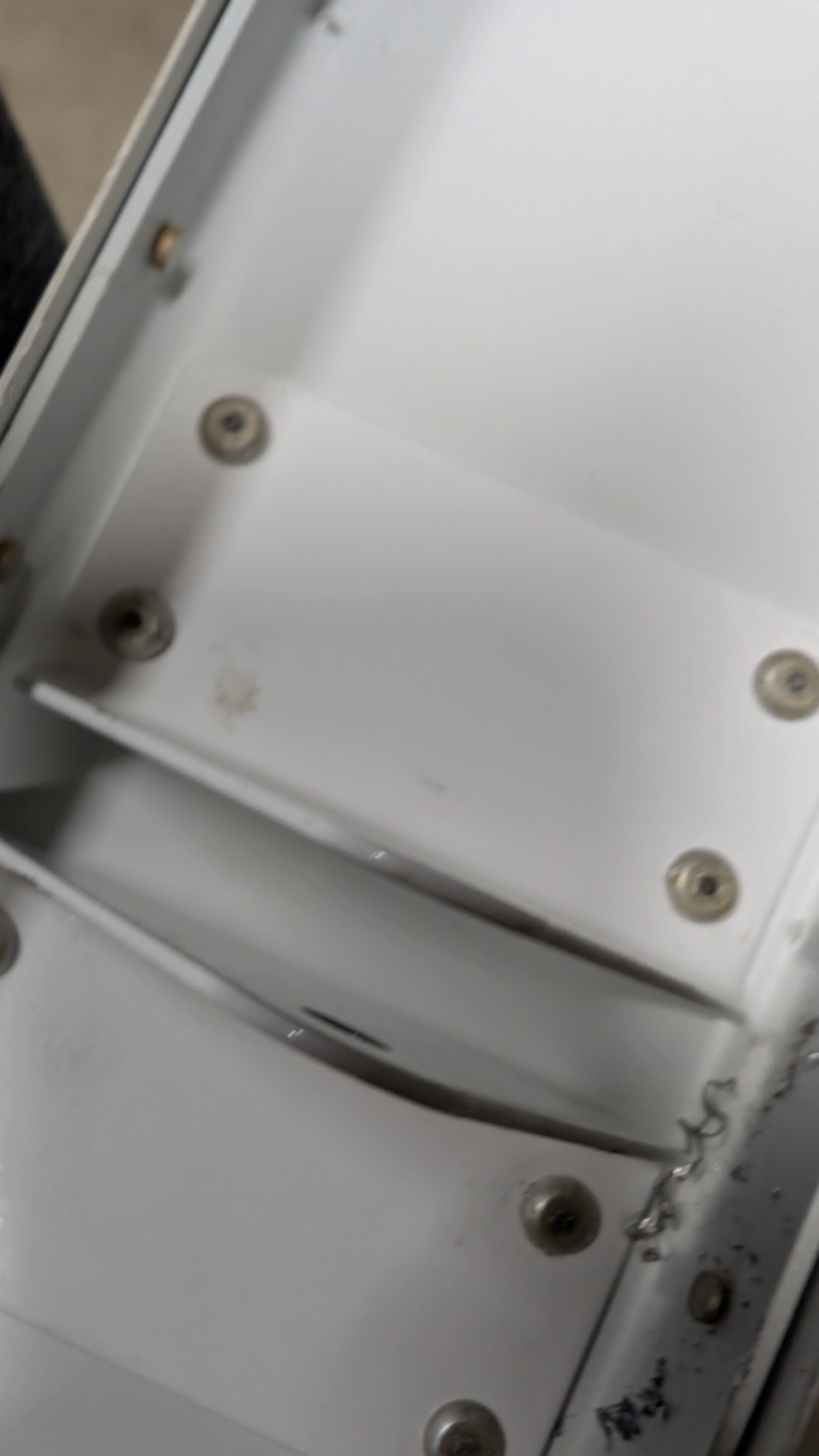

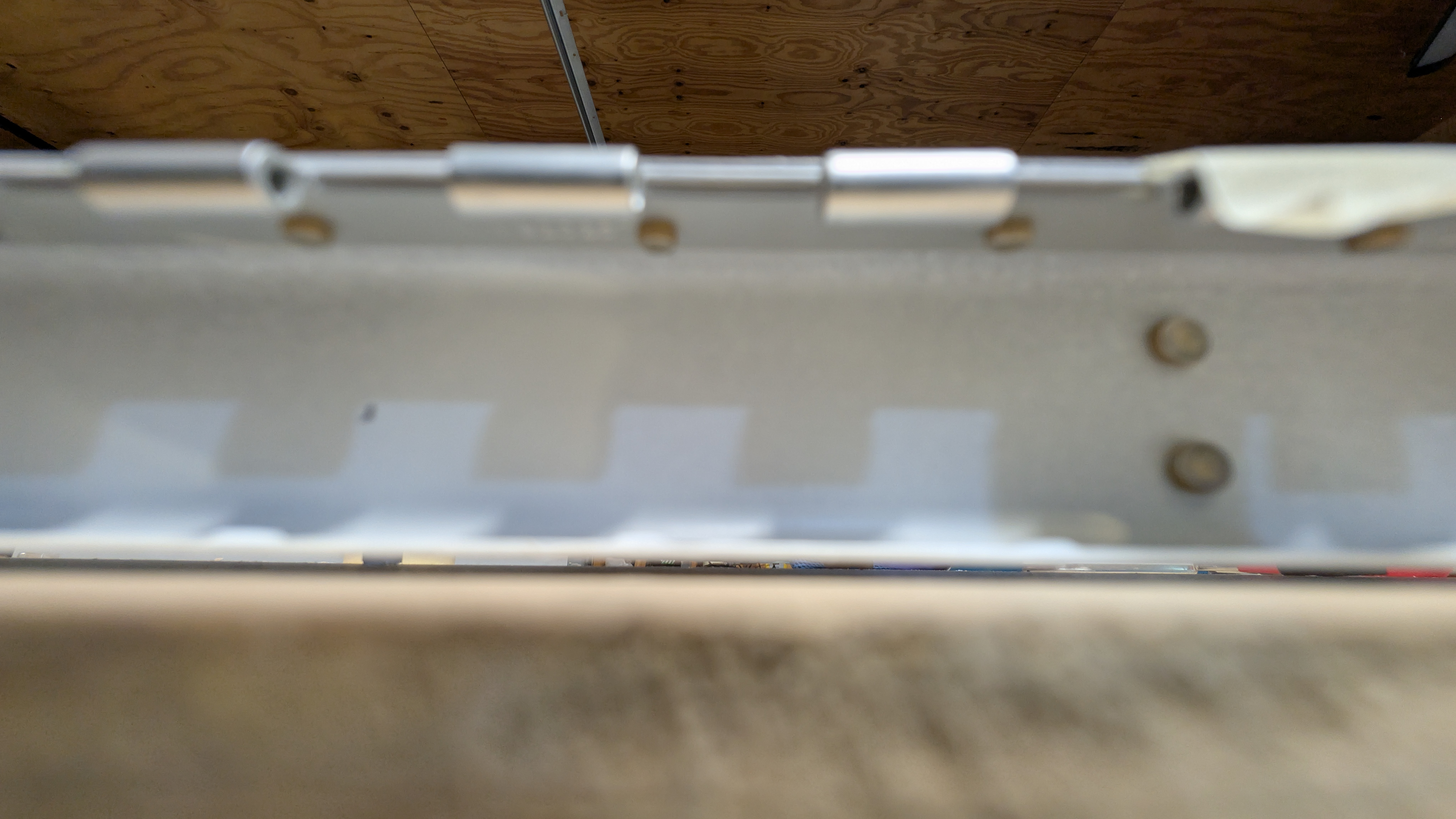

| 8/23 | 6.0 | 8.0 | | | first time putting the elevator skins together to form a surface. | |
| 8/24 | 0.0 | | | | | [1 (full), 2 (full), 3 (full)] |

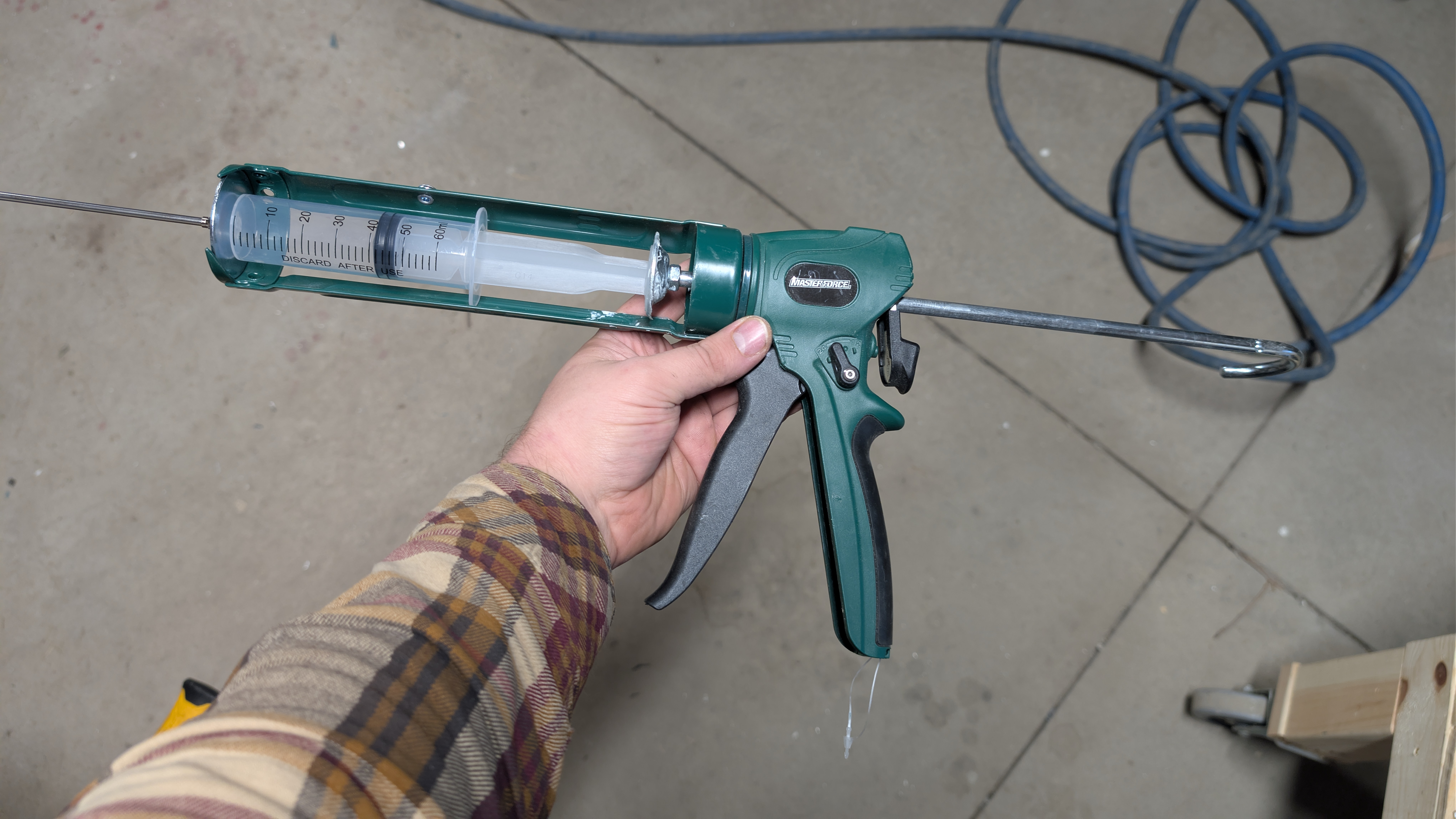

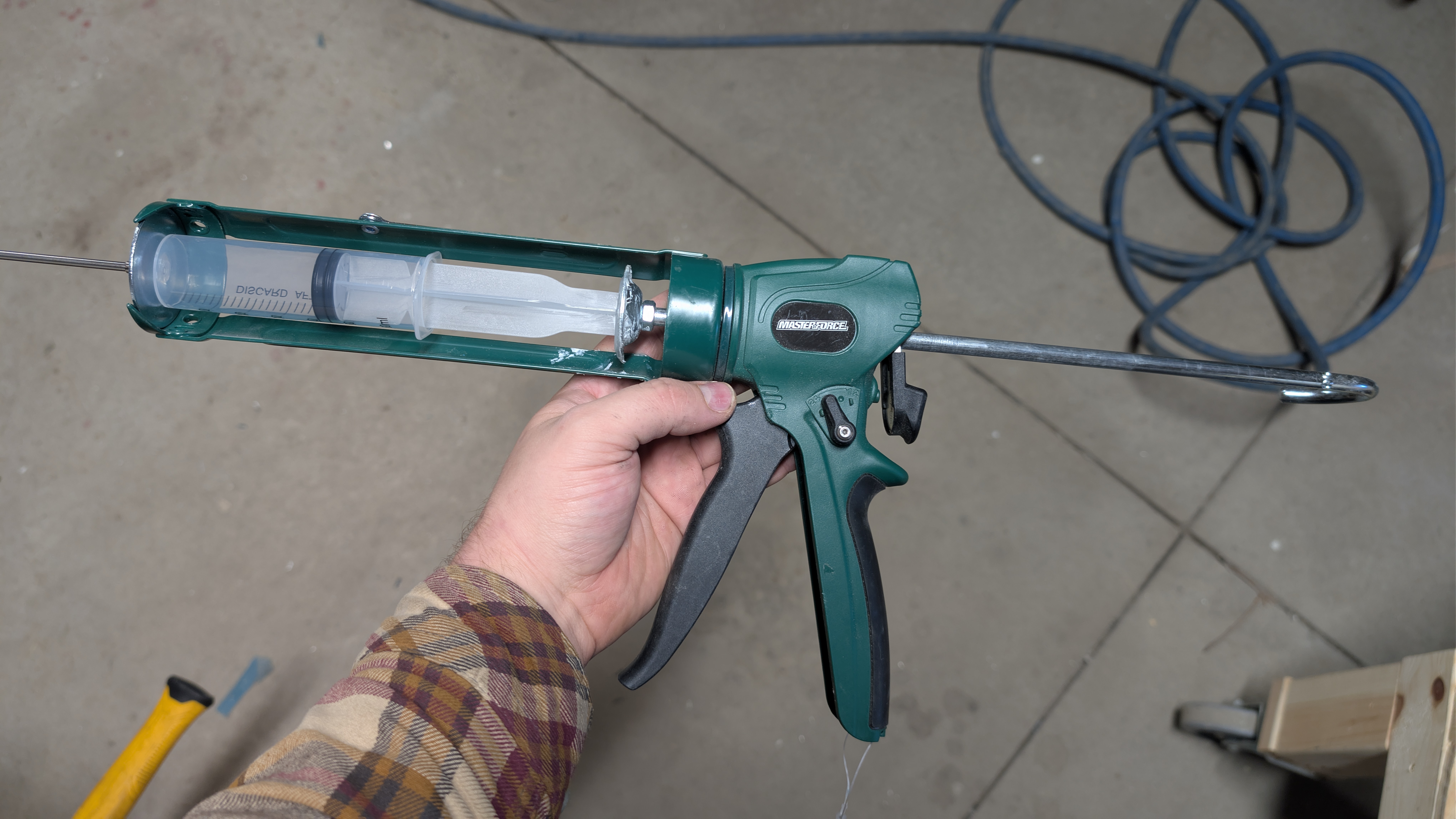

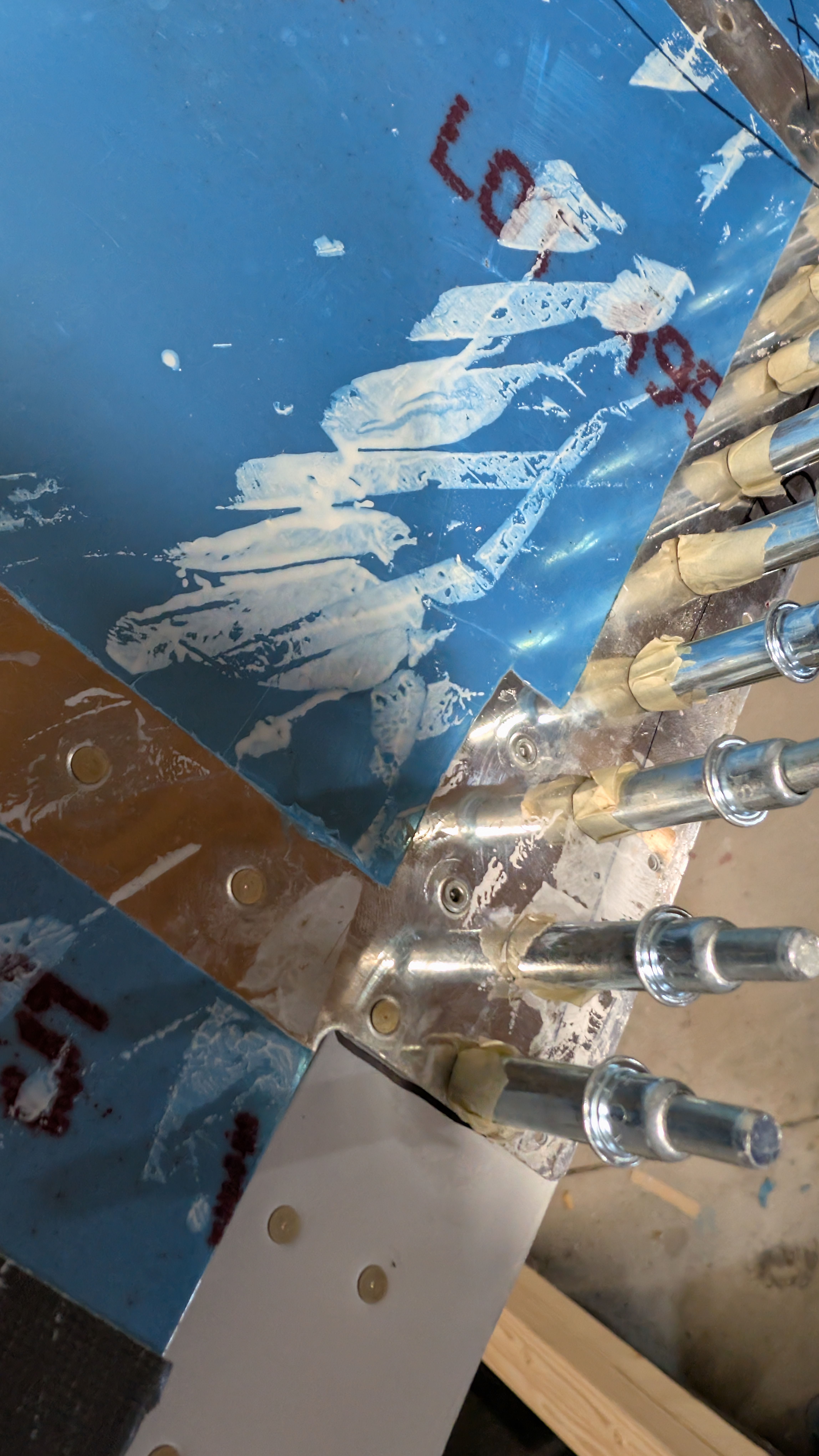

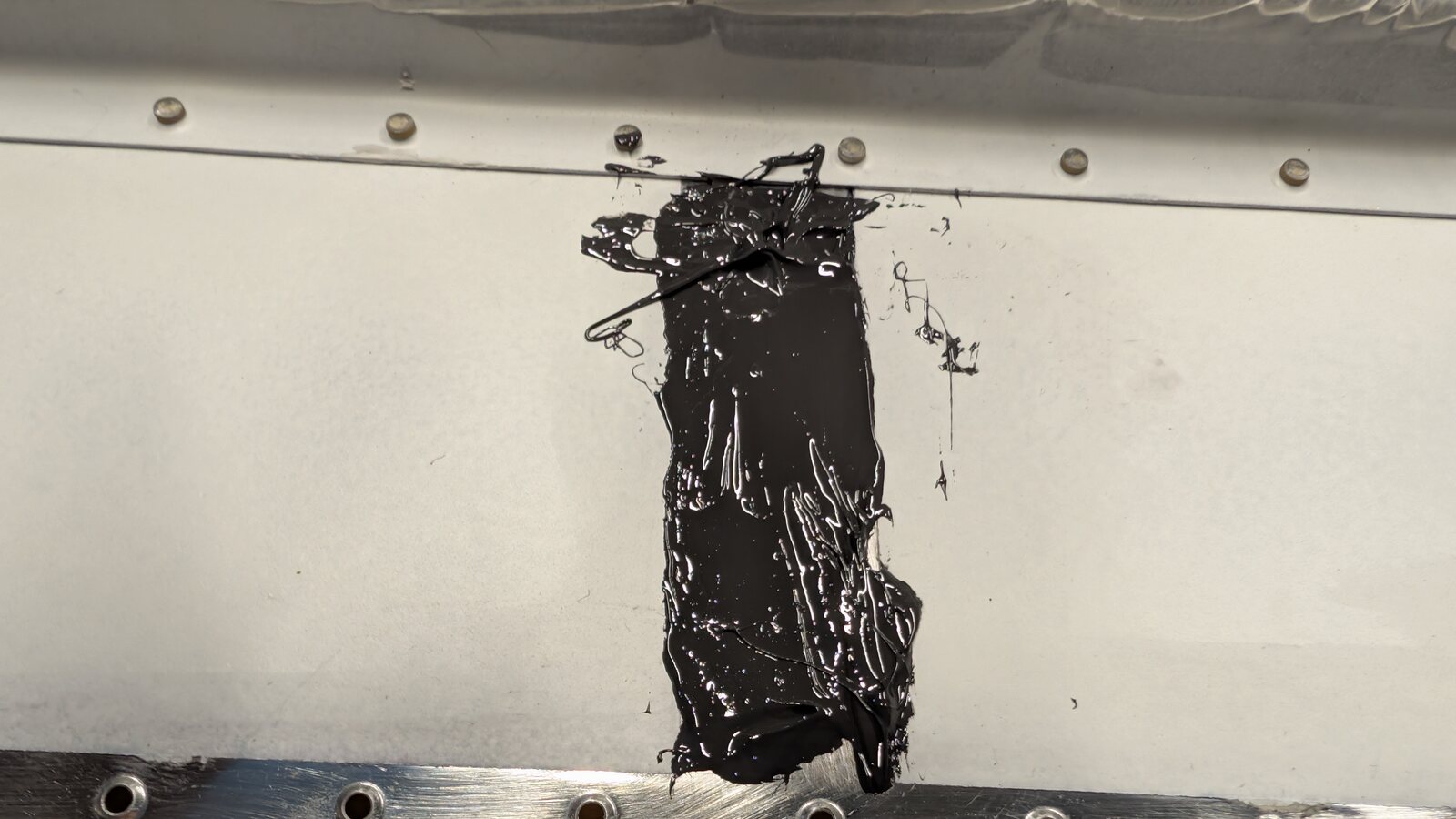

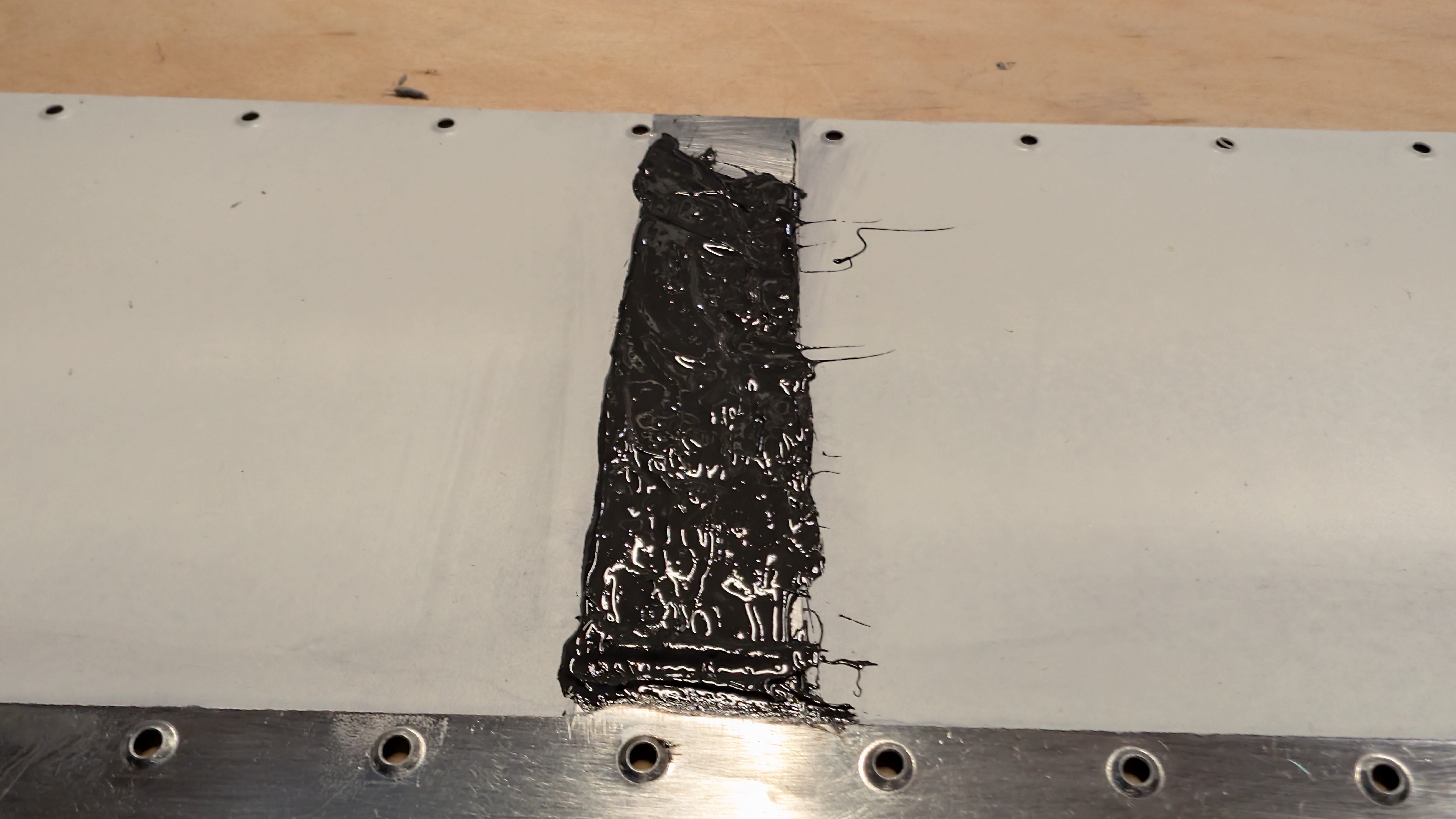

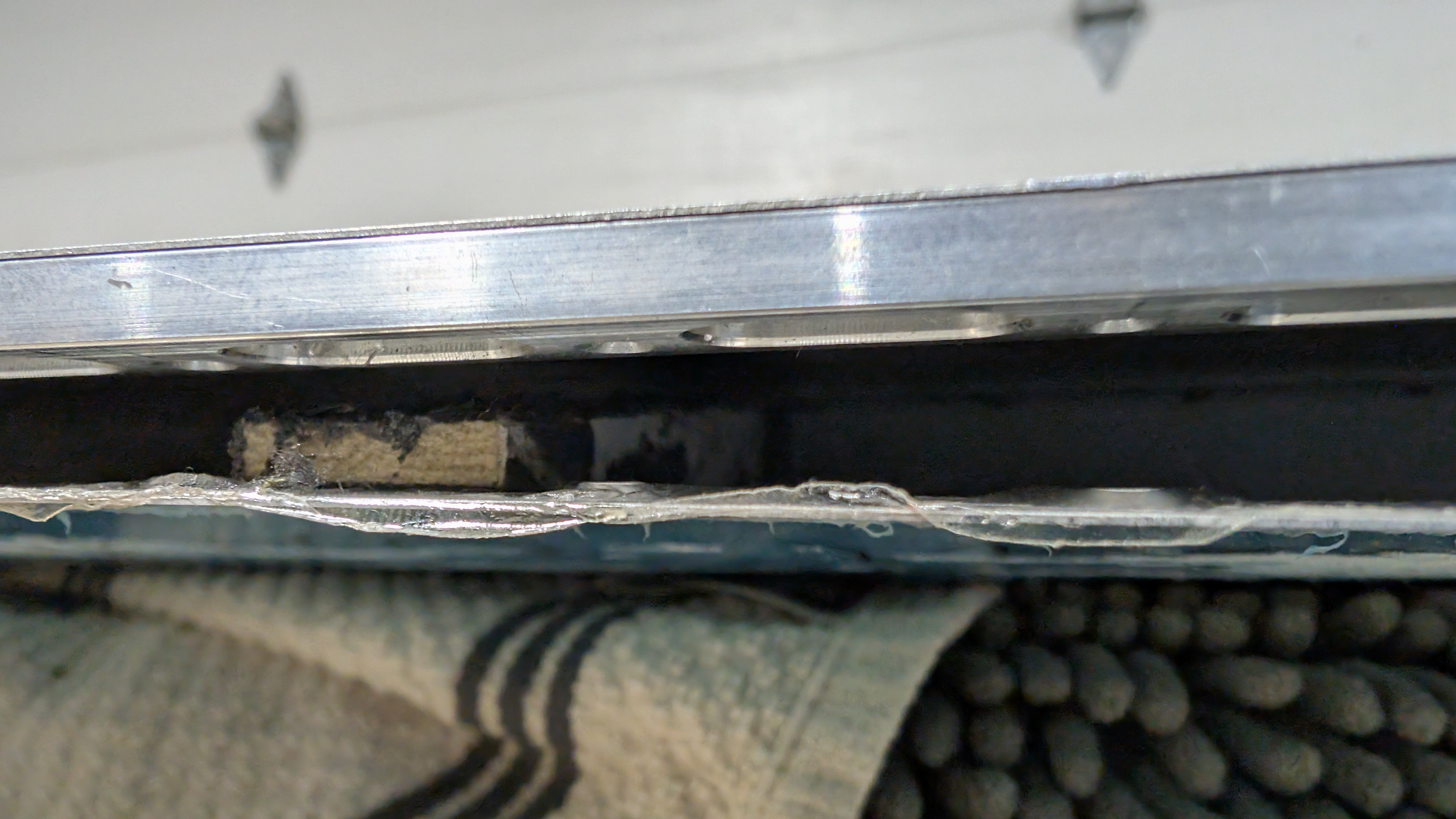

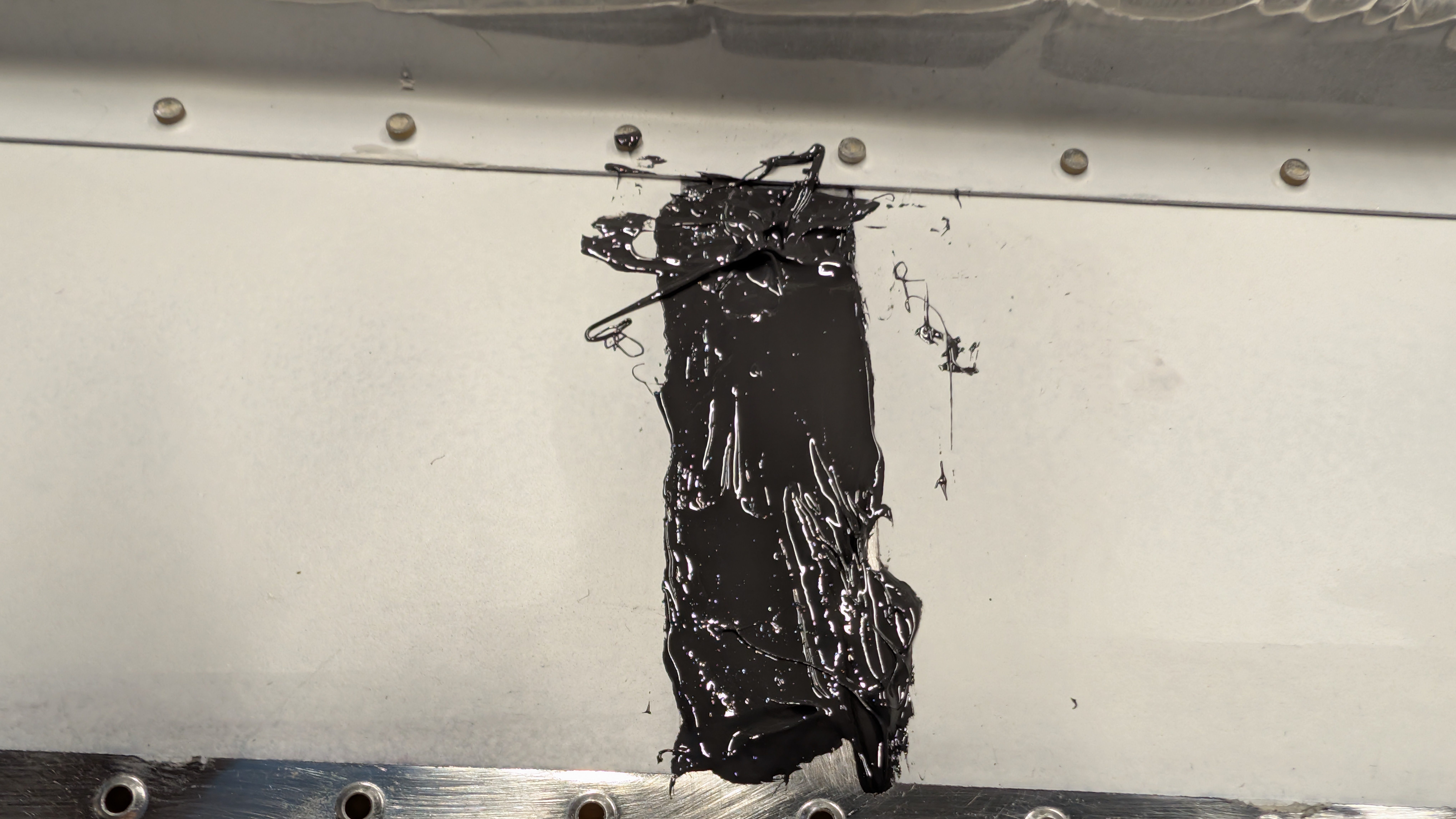

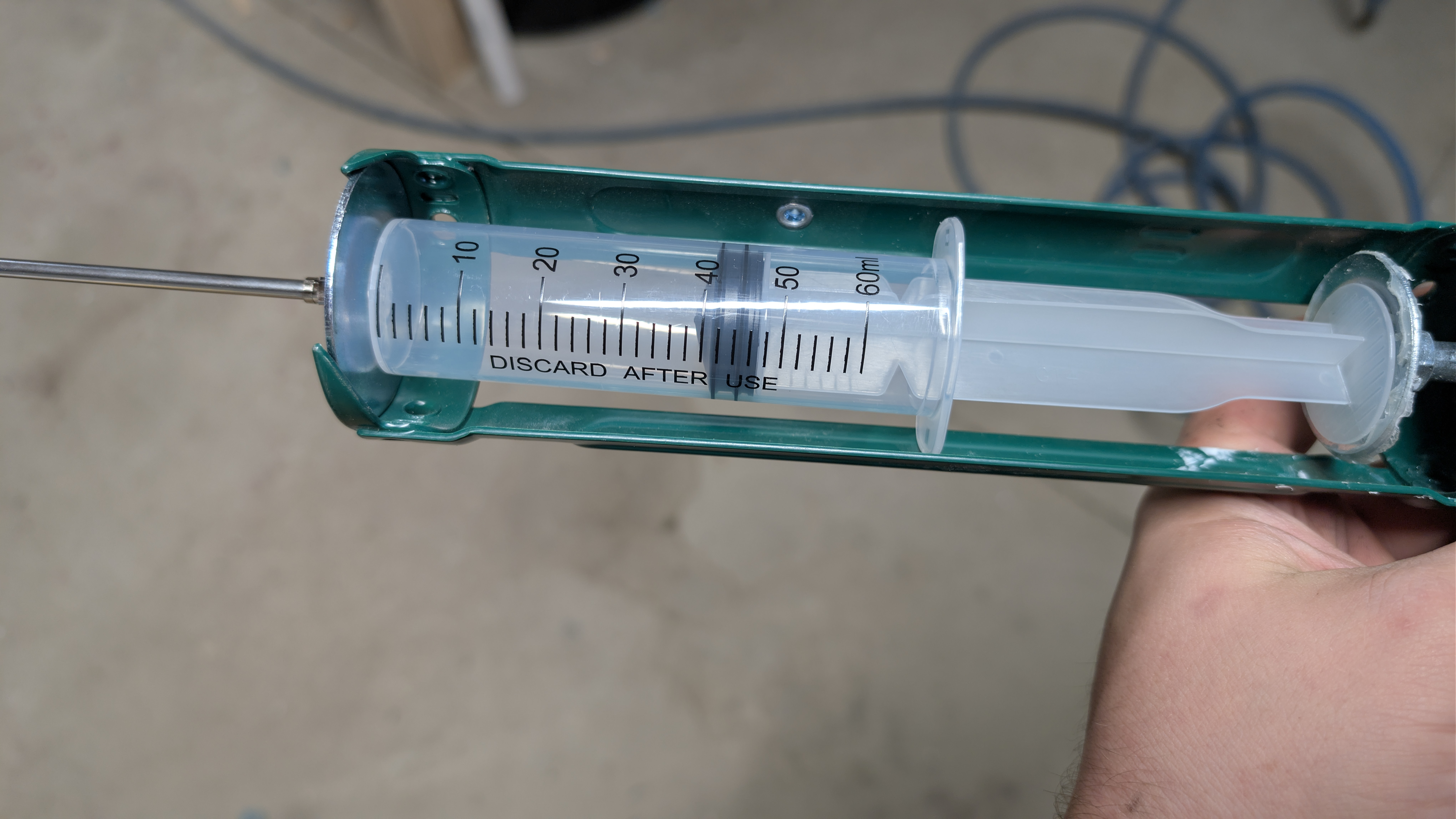

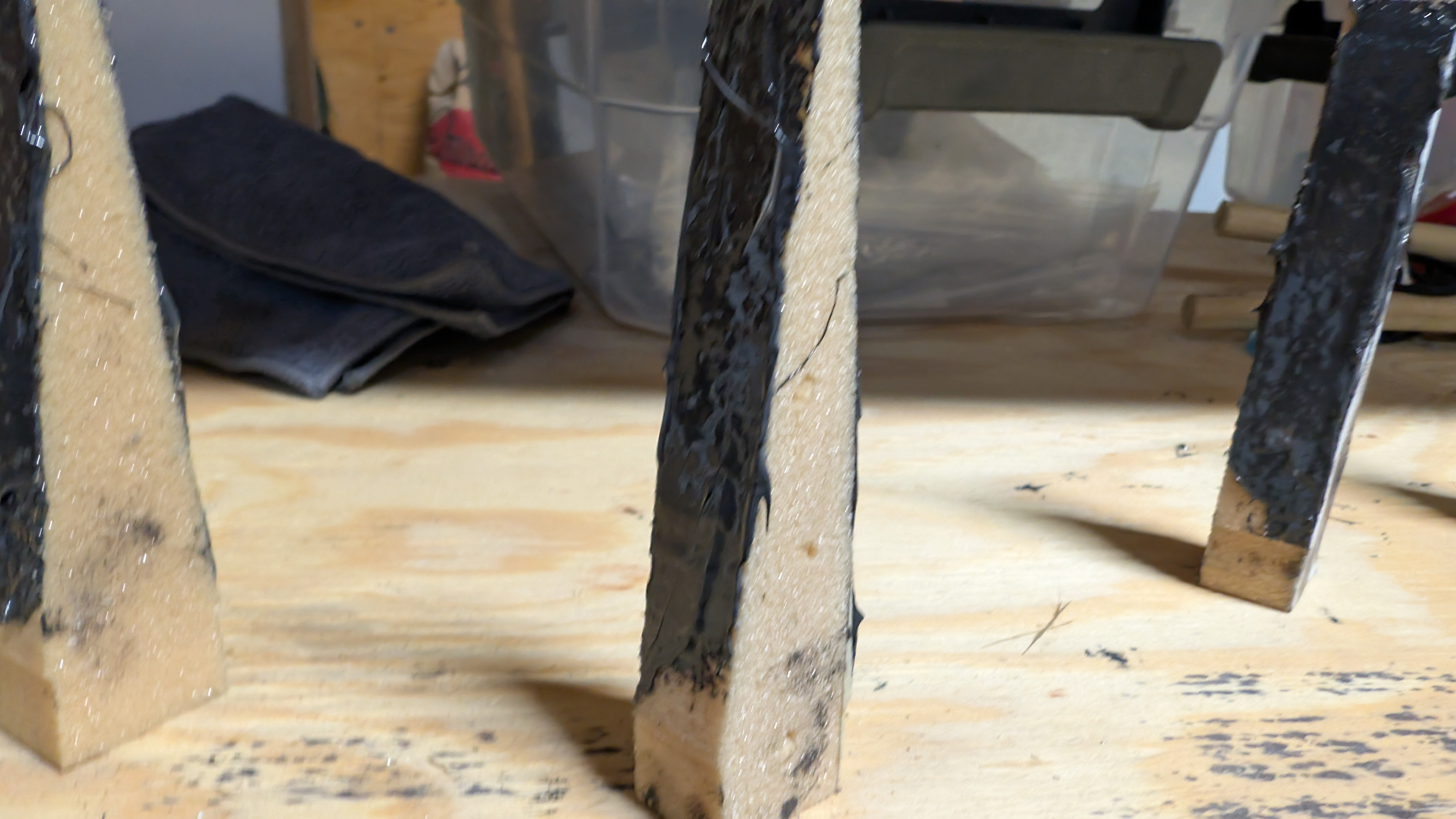

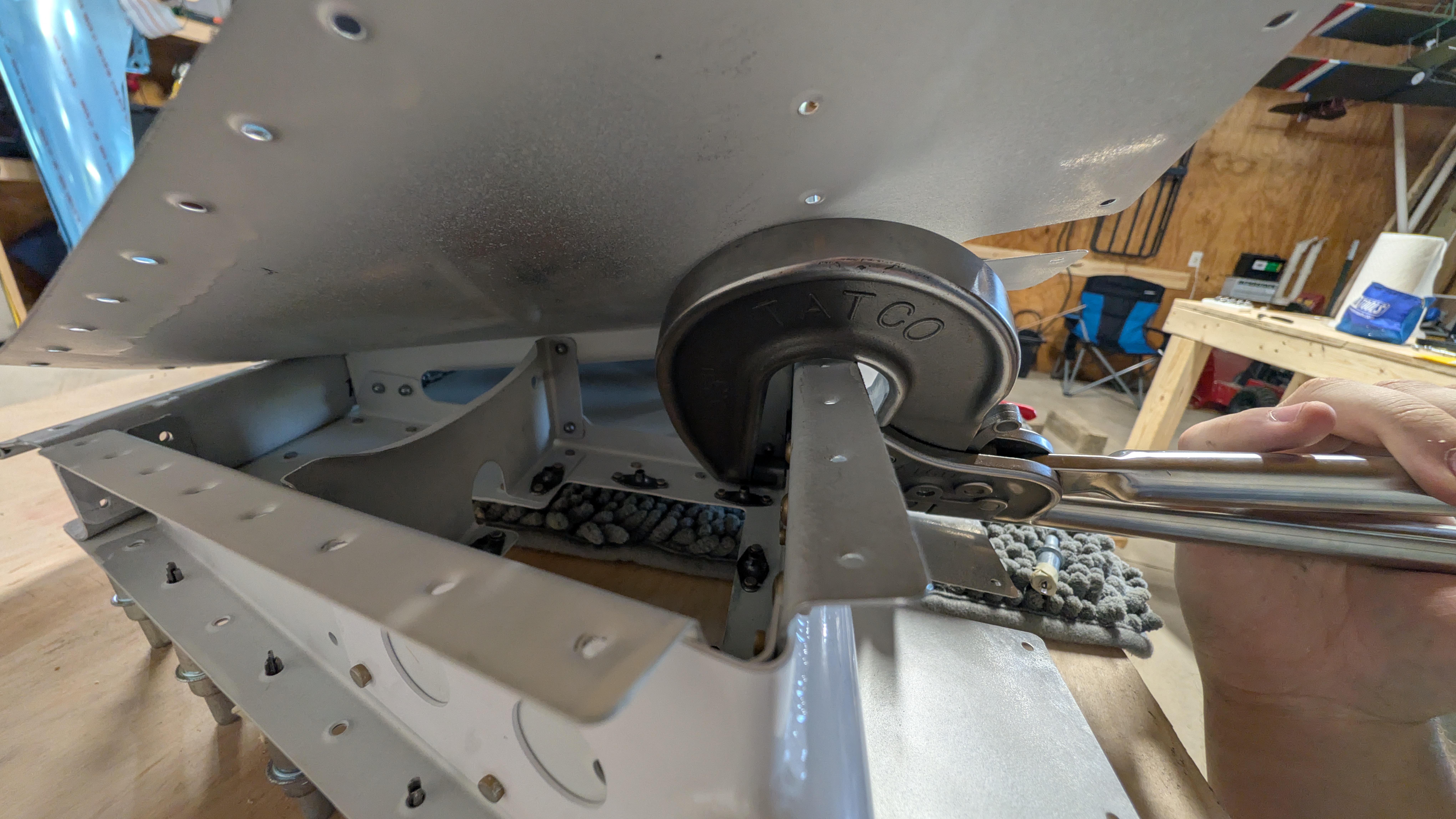

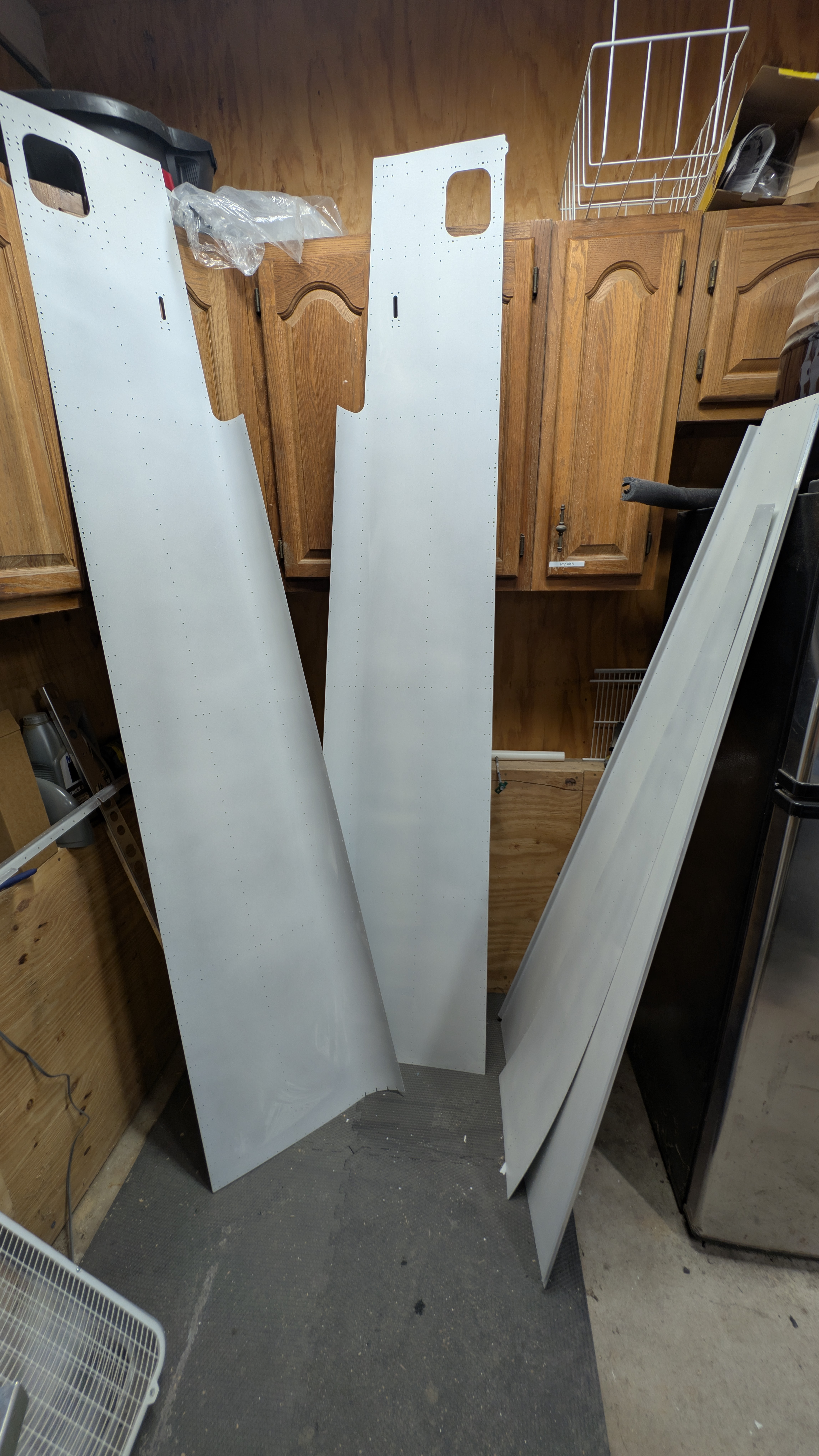

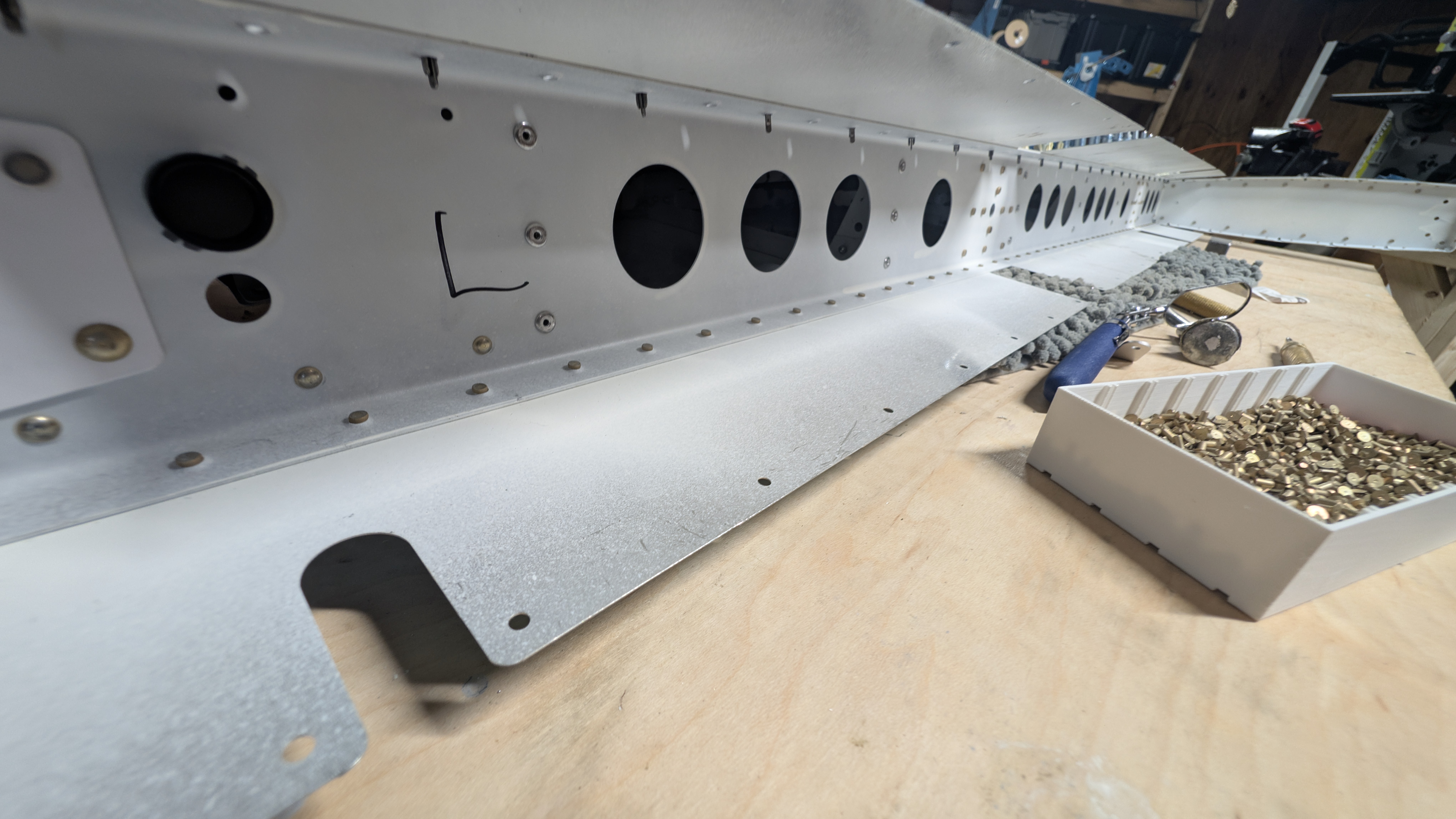

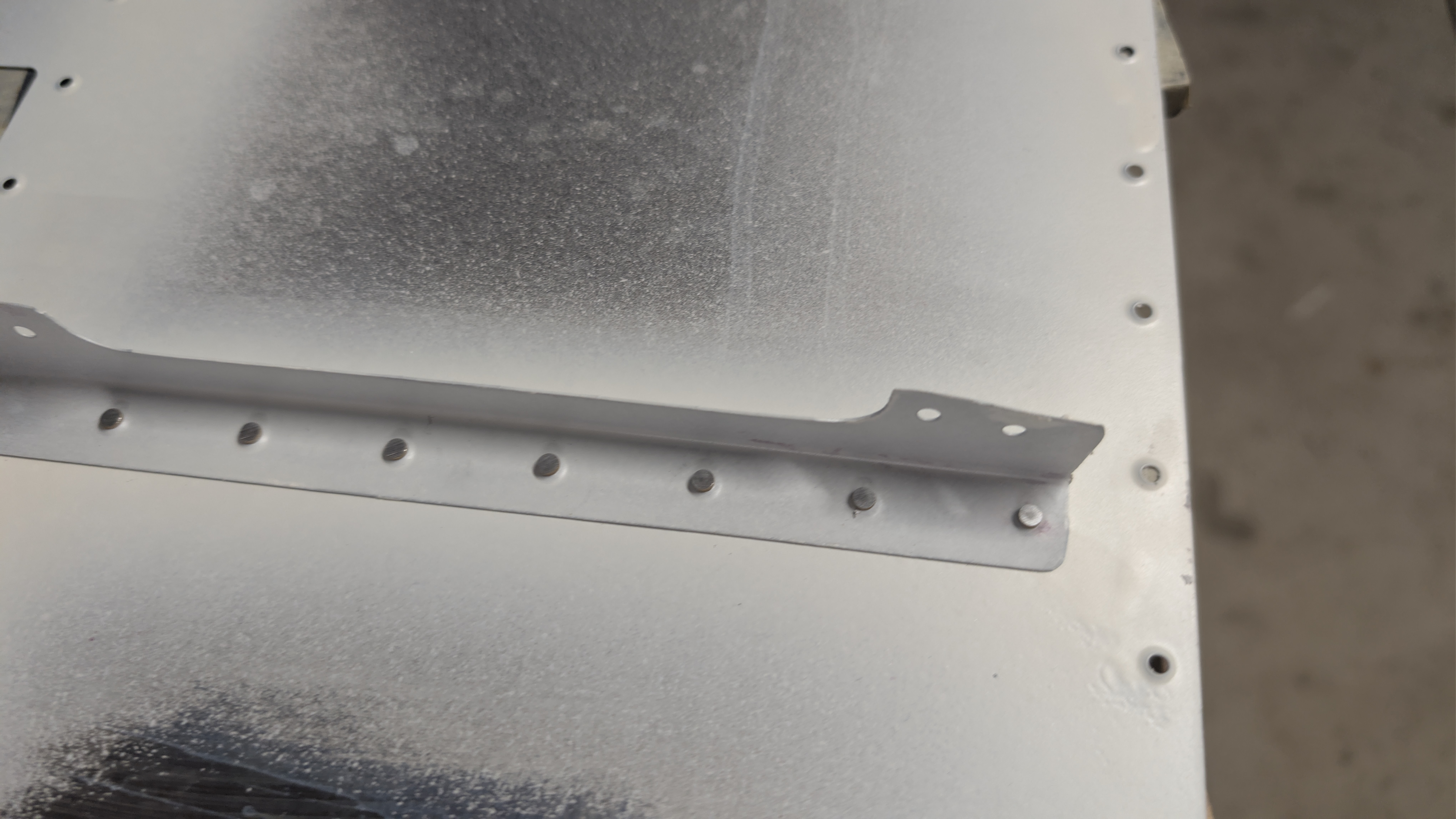

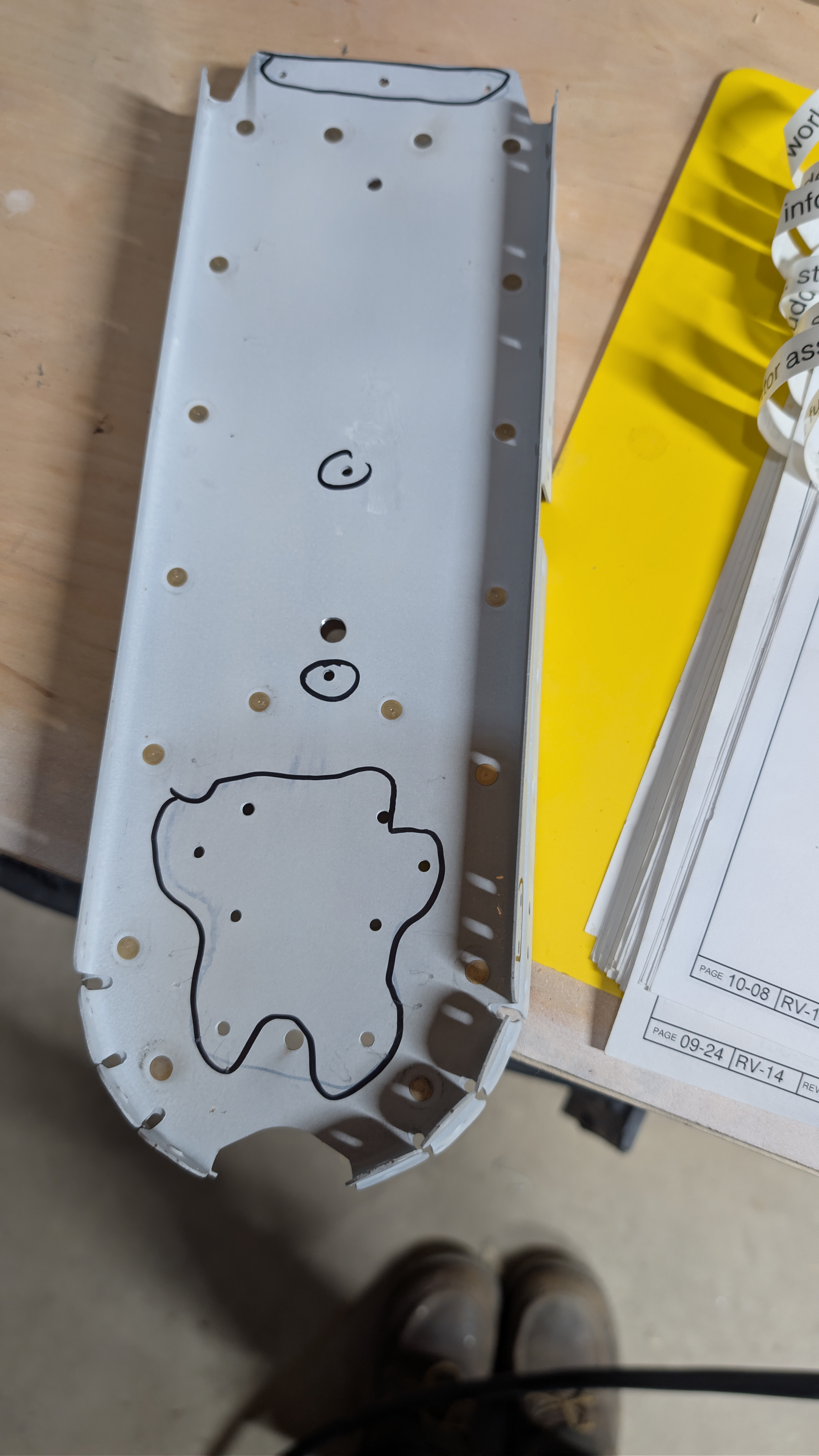

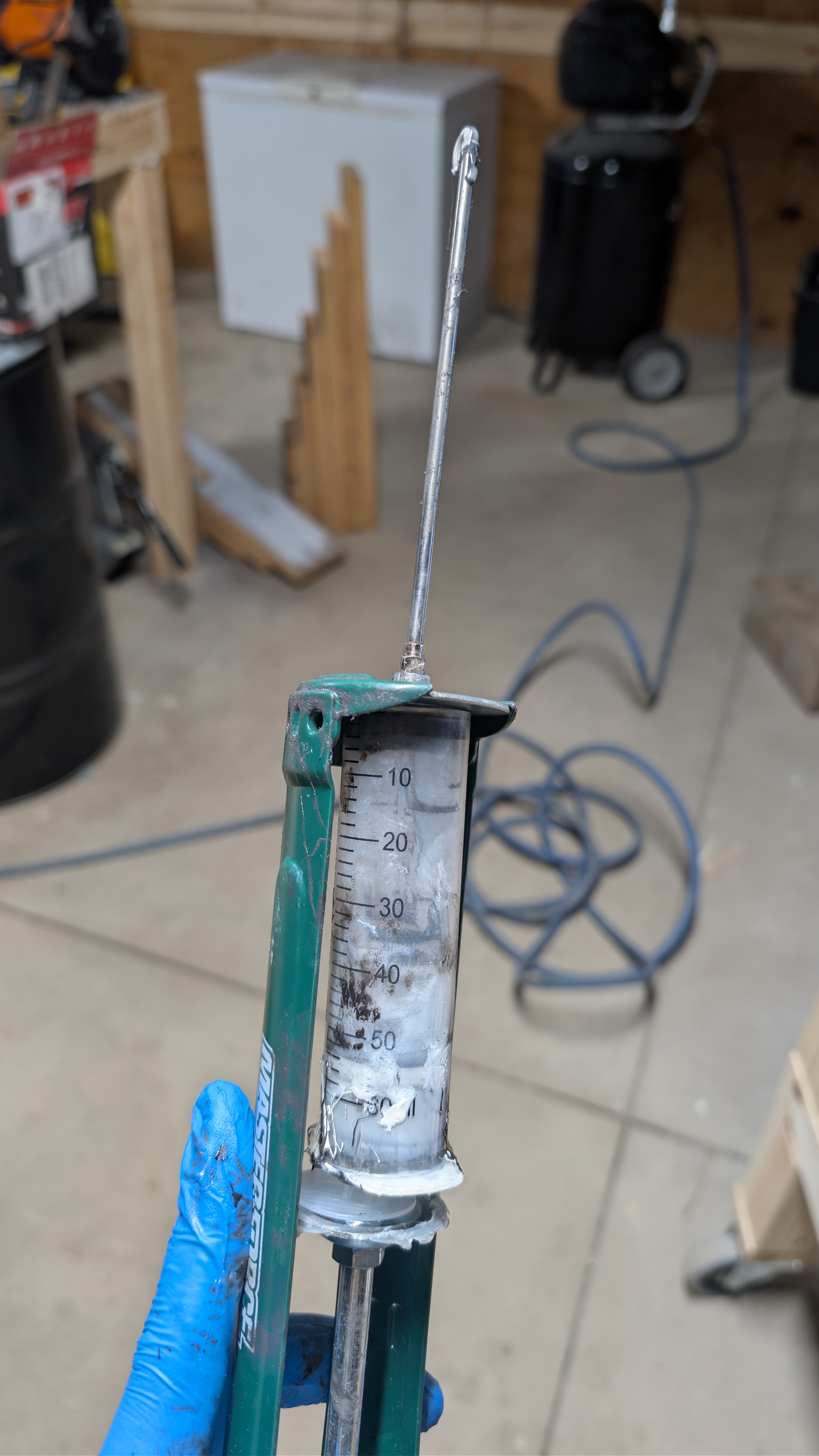

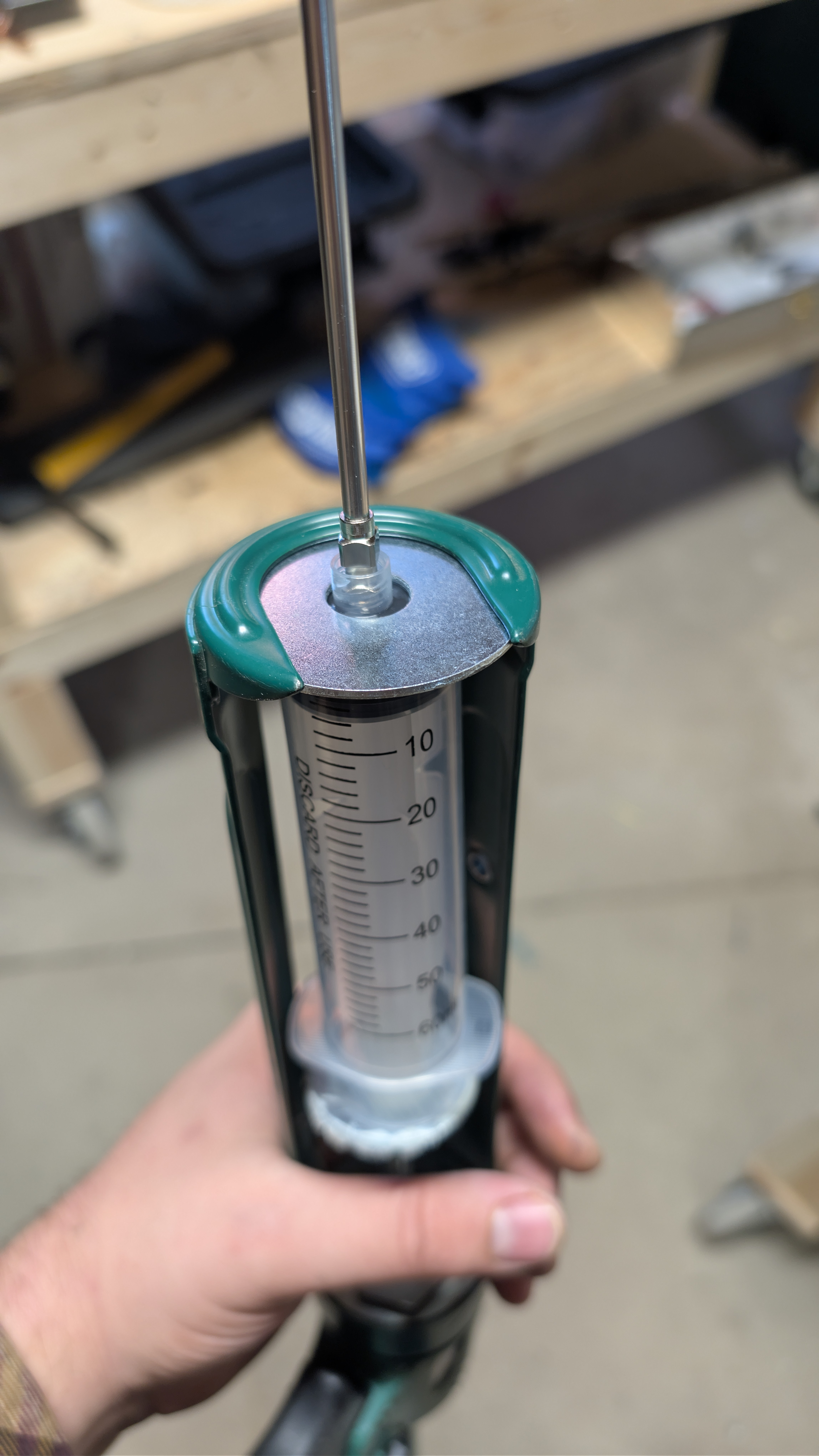

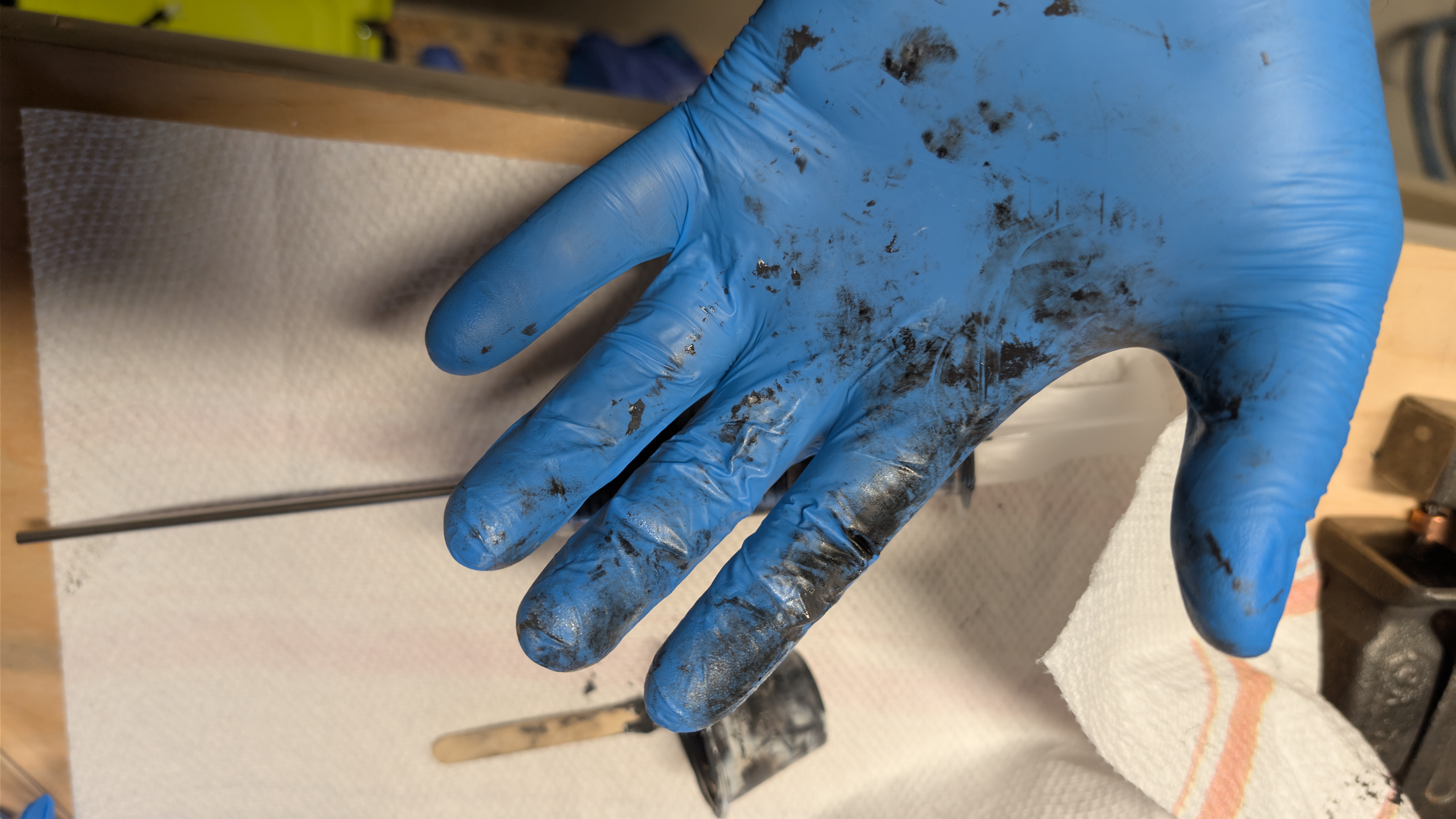

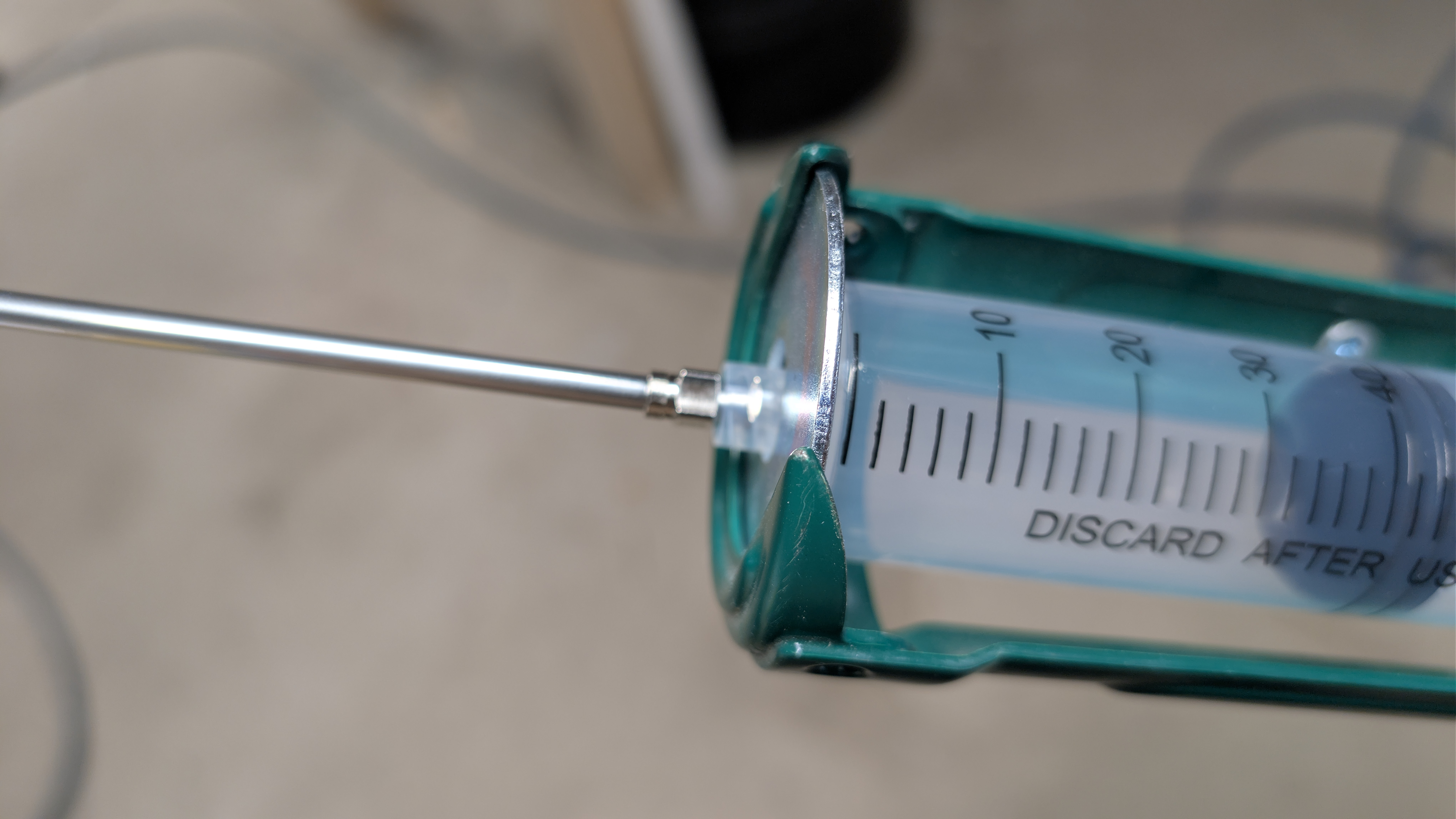

| 8/25 | 3.0 | | | | Applying tank sealant to rear rib | [1 (full), 2 (full), 3 (full), 4 (full), 5 (full), 6 (full), 7 (full), 8 (full), 9 (full), 10 (full), 11 (full), 12 (full), 13 (full), 14 (full)] |
| --- | 0.0 | | | | | |

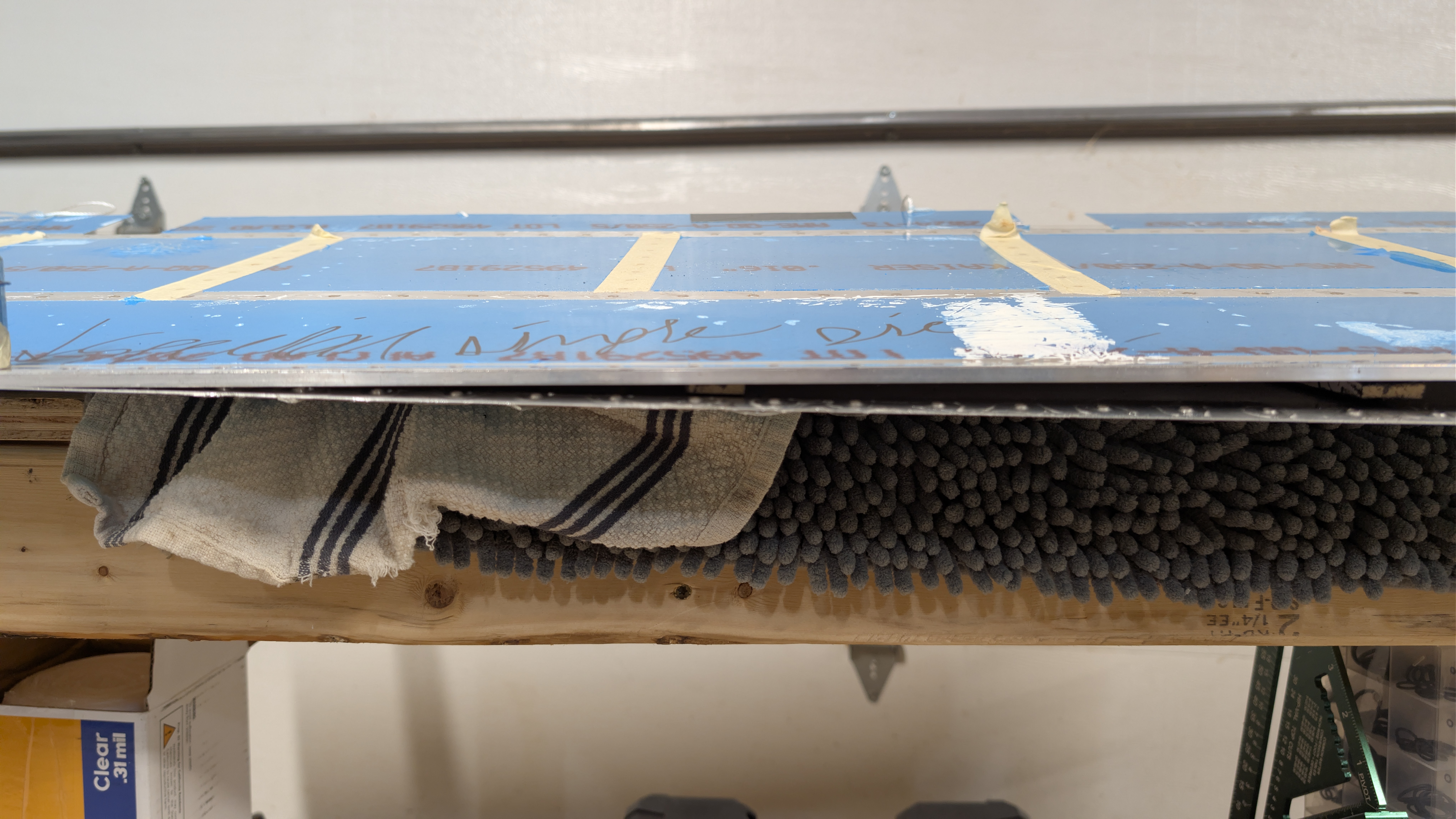

| 8/29 | 2.0 | | | | Last rear rib application of tank sealant. | [1 (full), 2 (full), 3 (full), 4 (full), 5 (full)] |

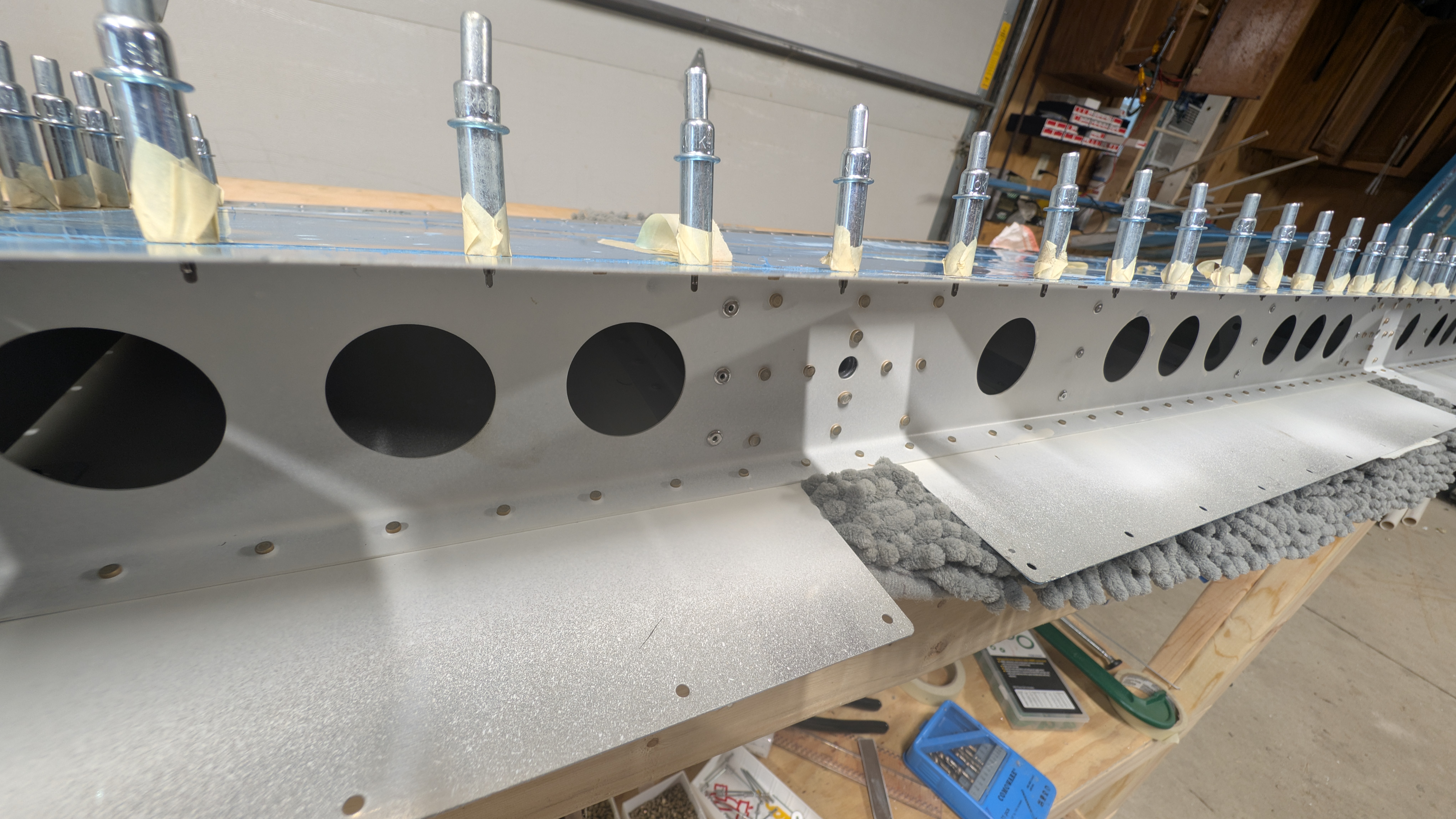

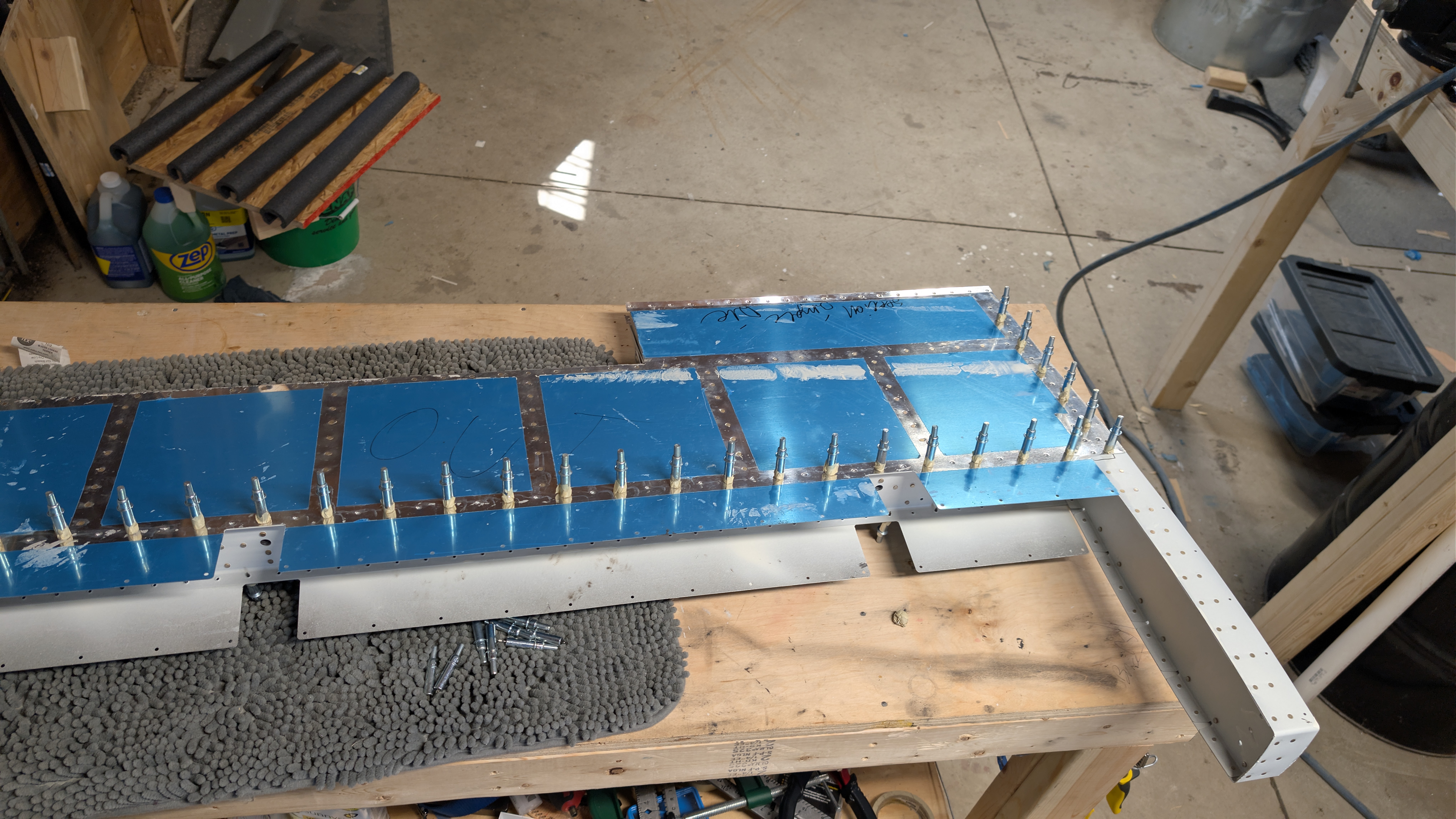

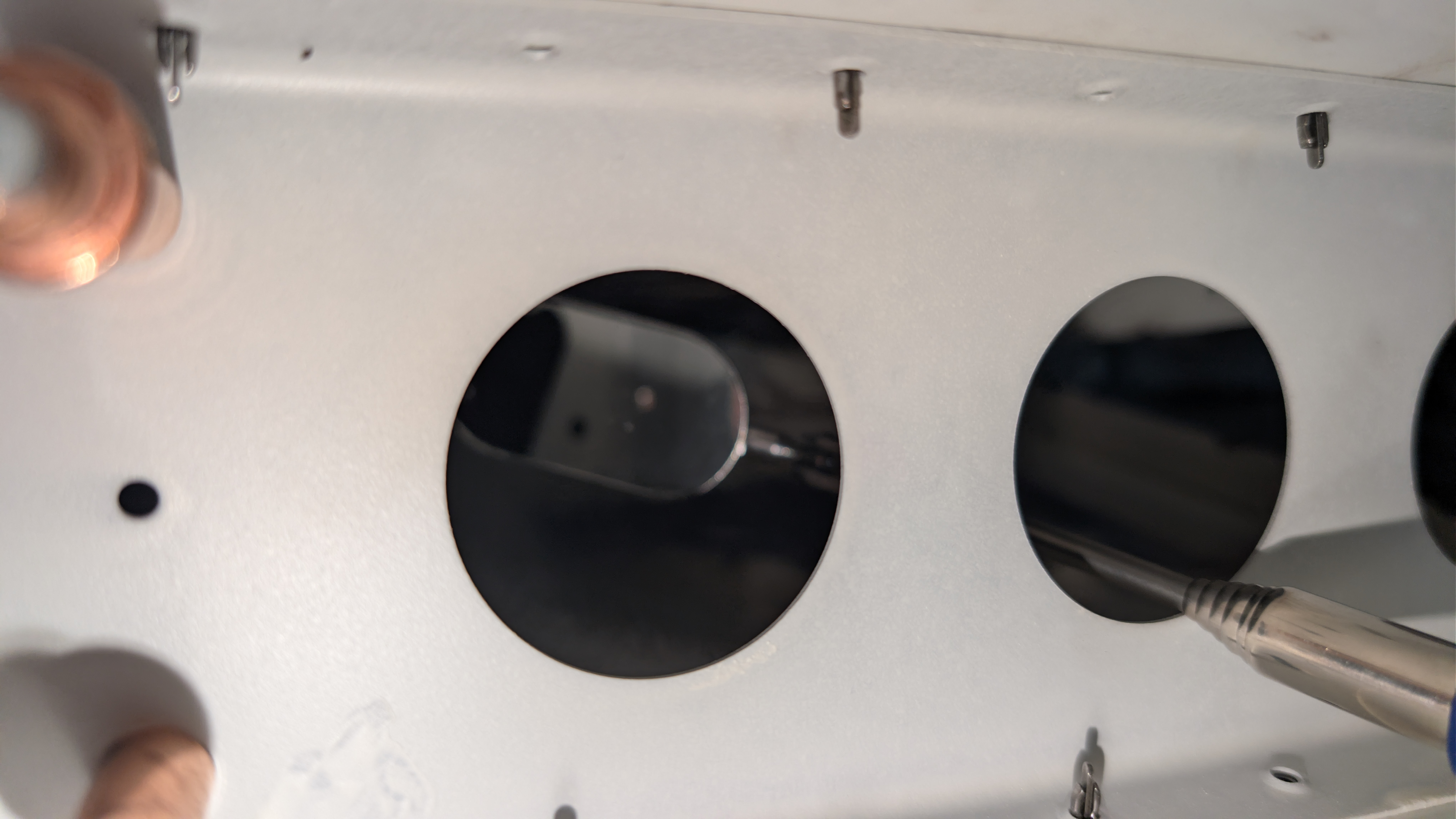

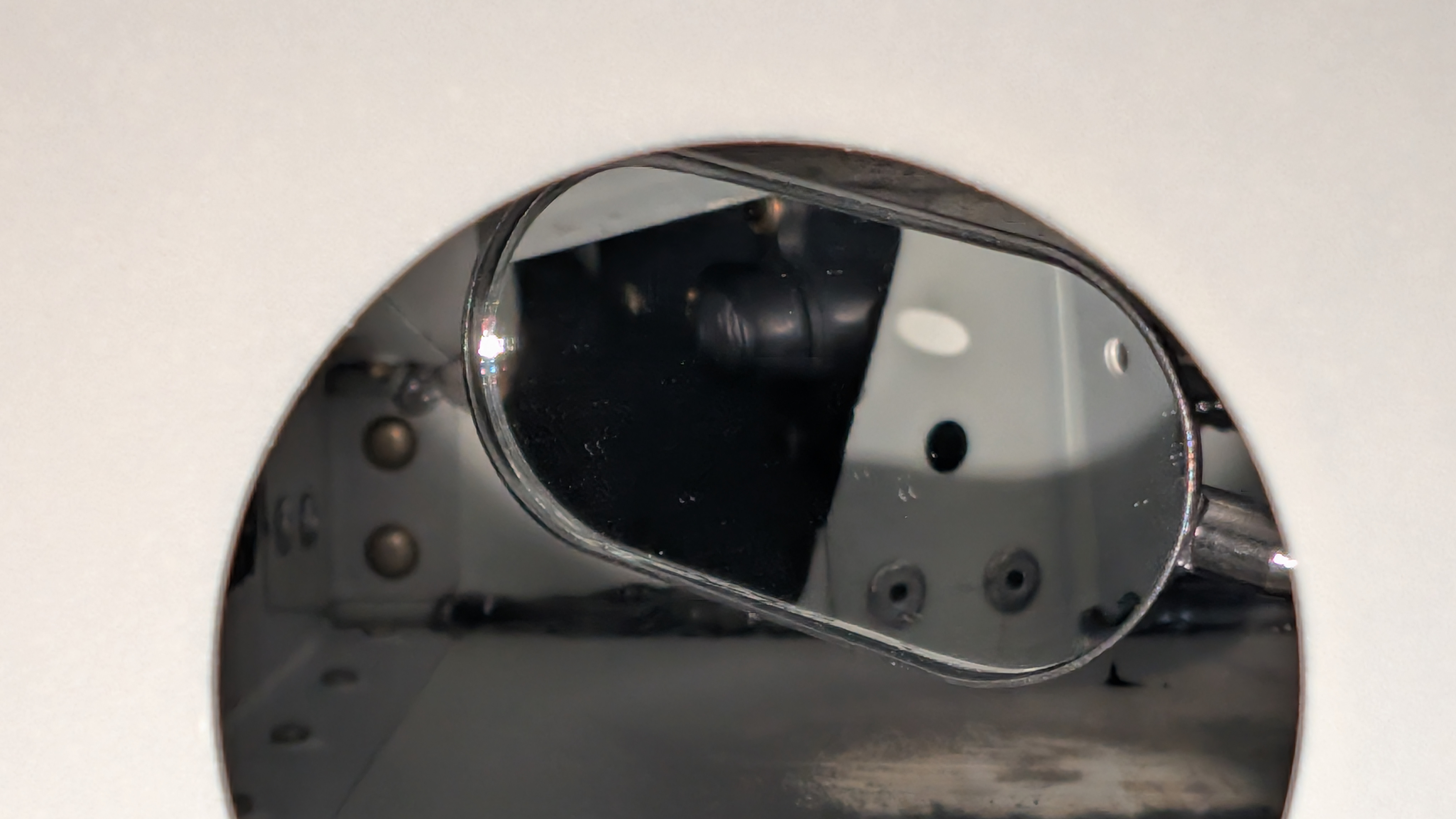

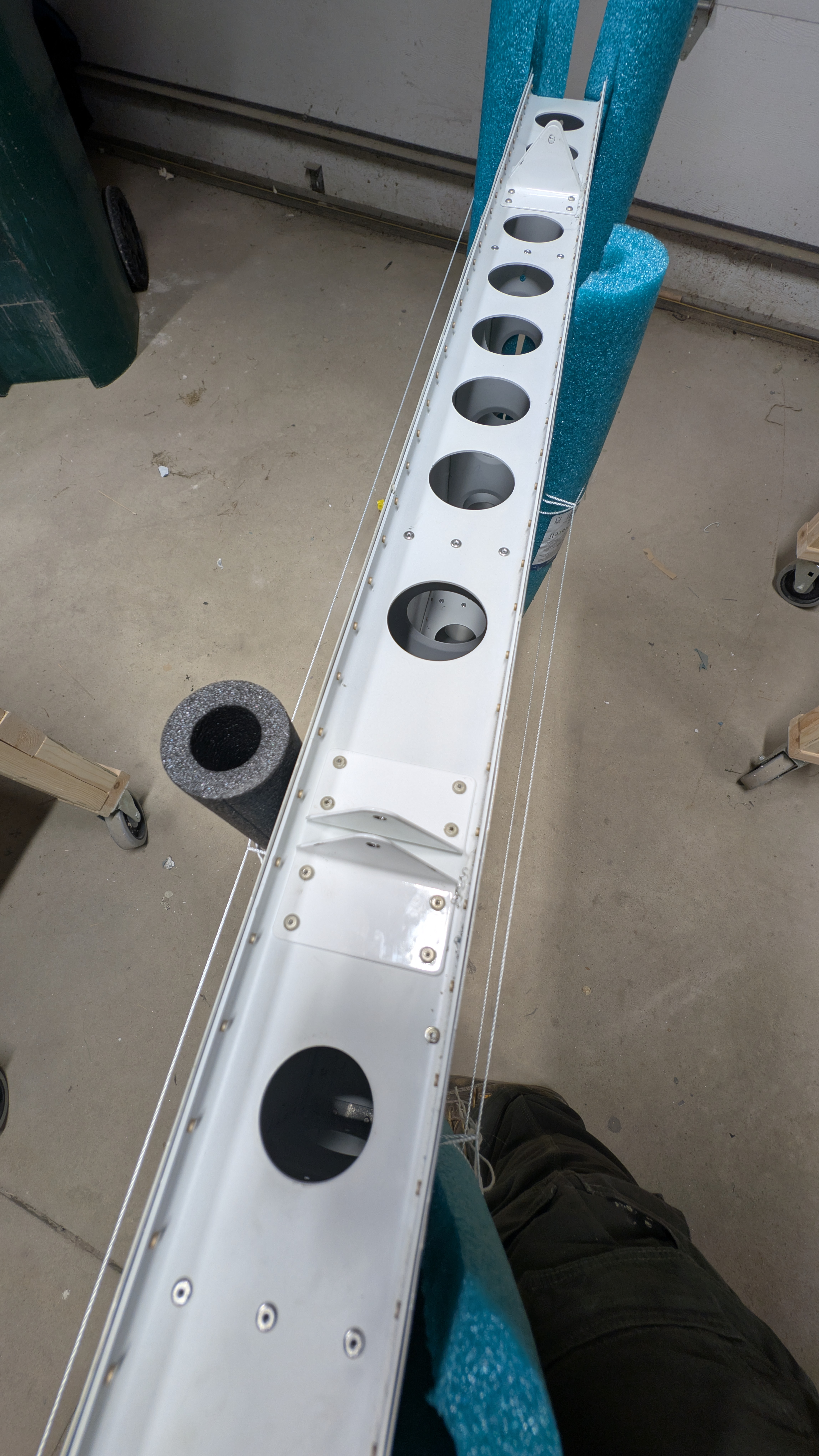

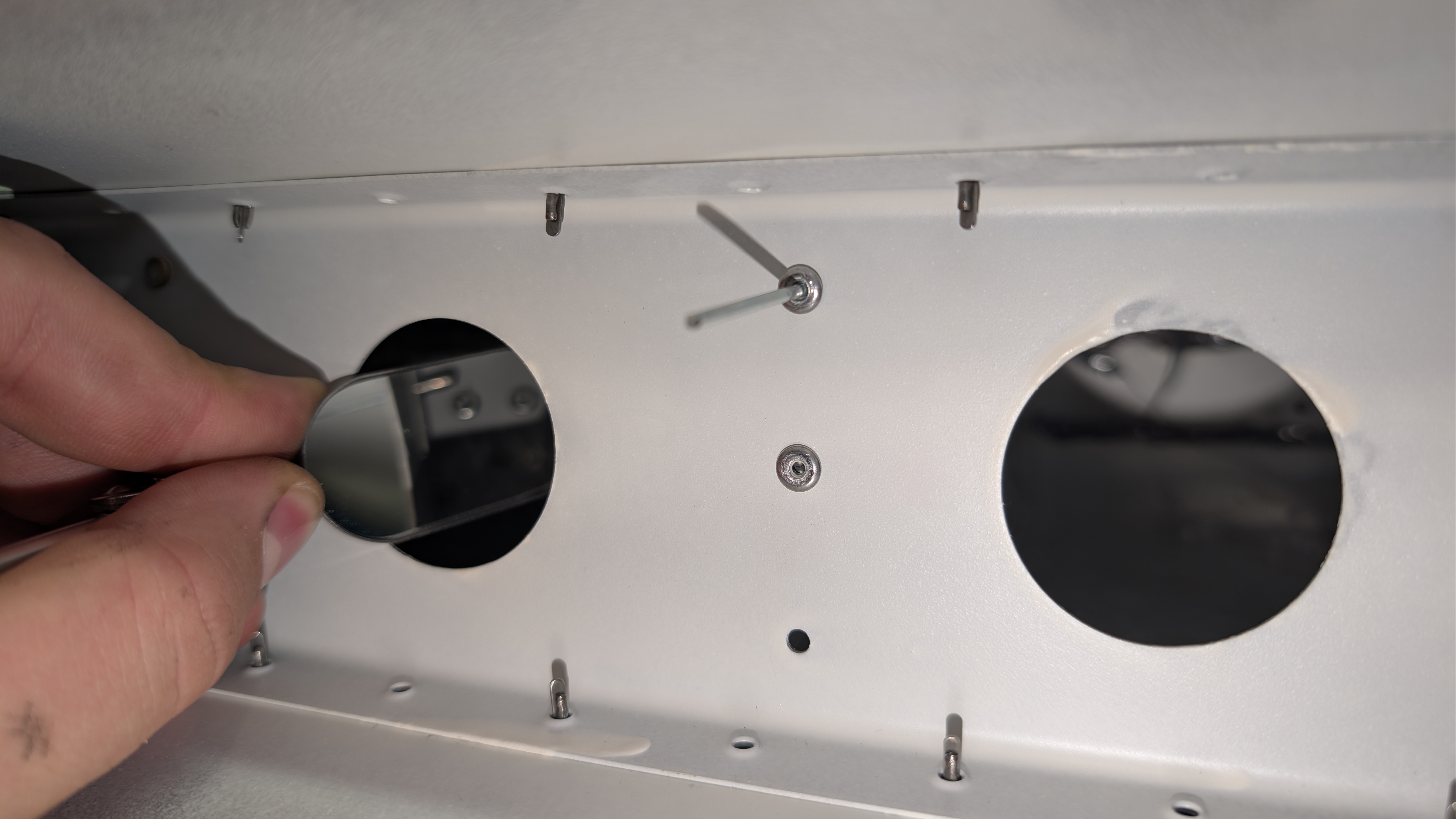

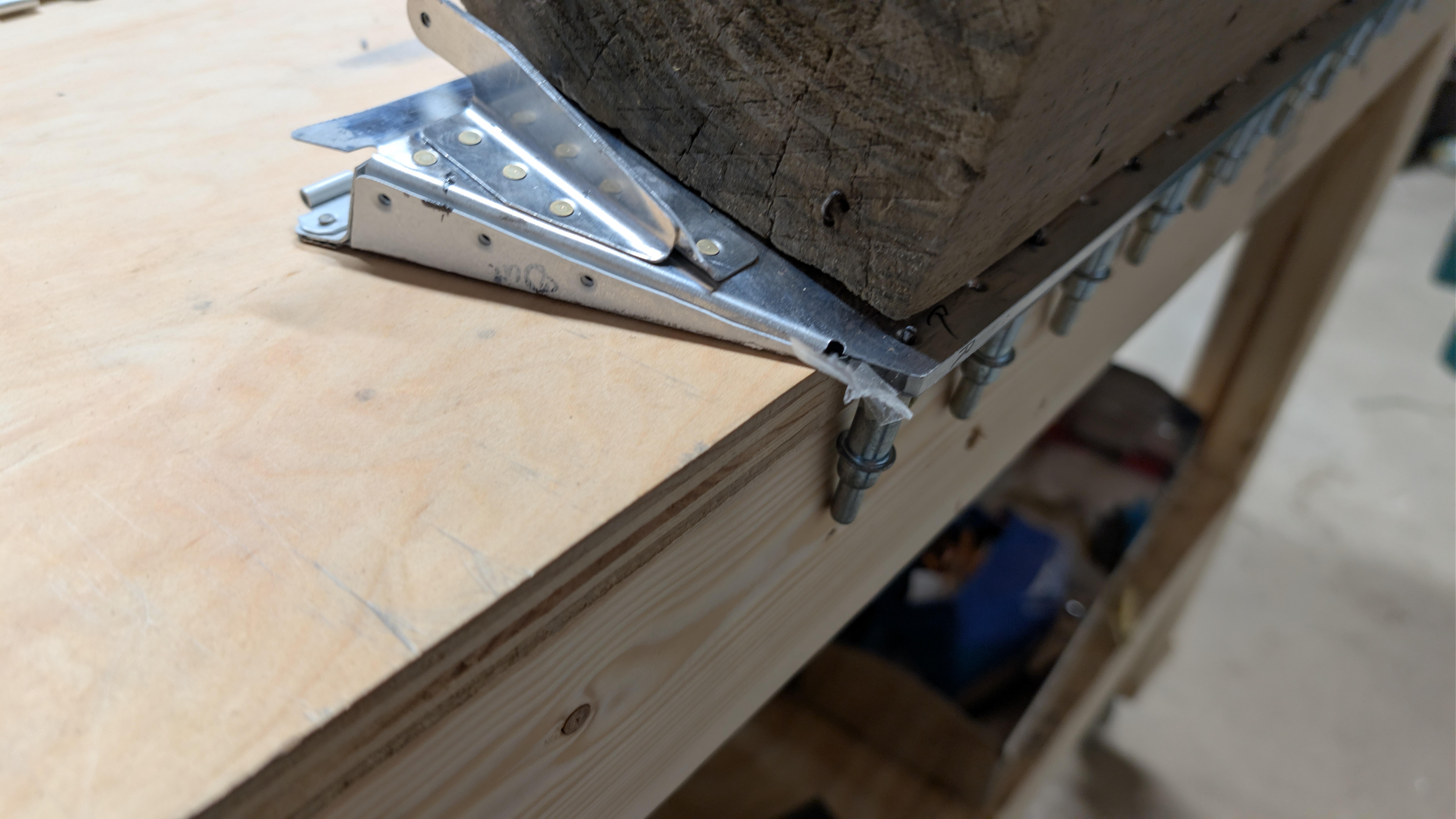

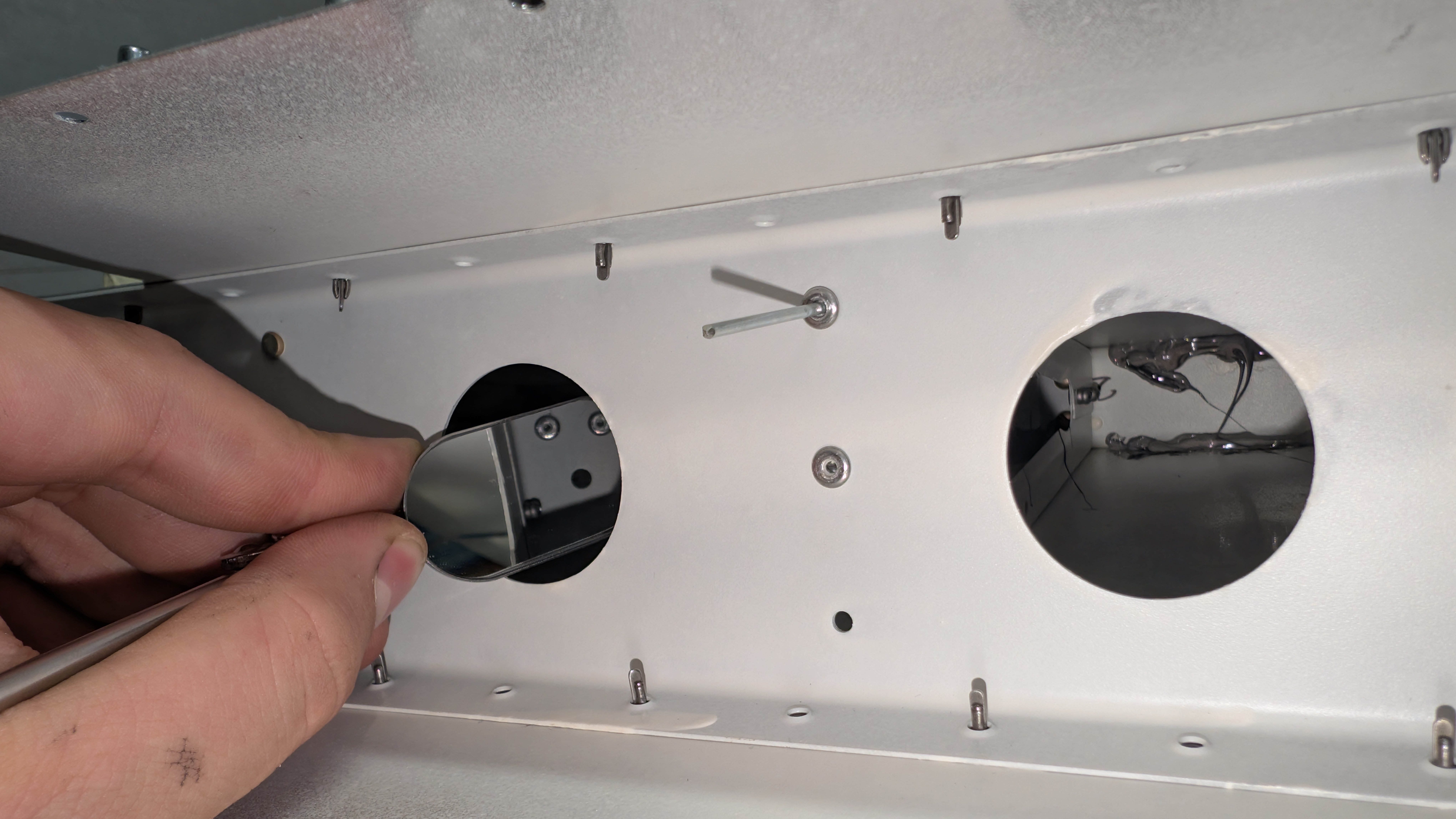

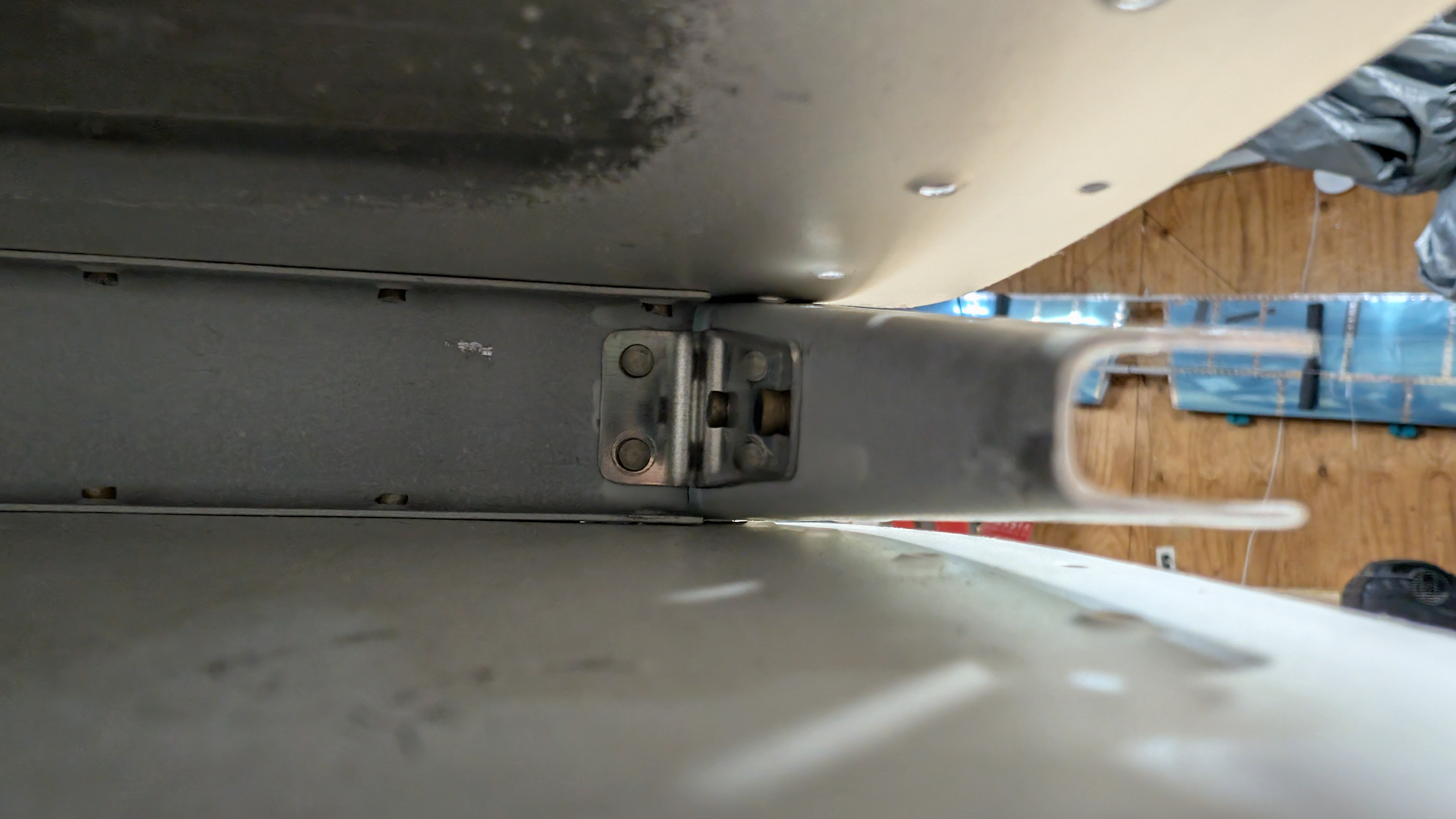

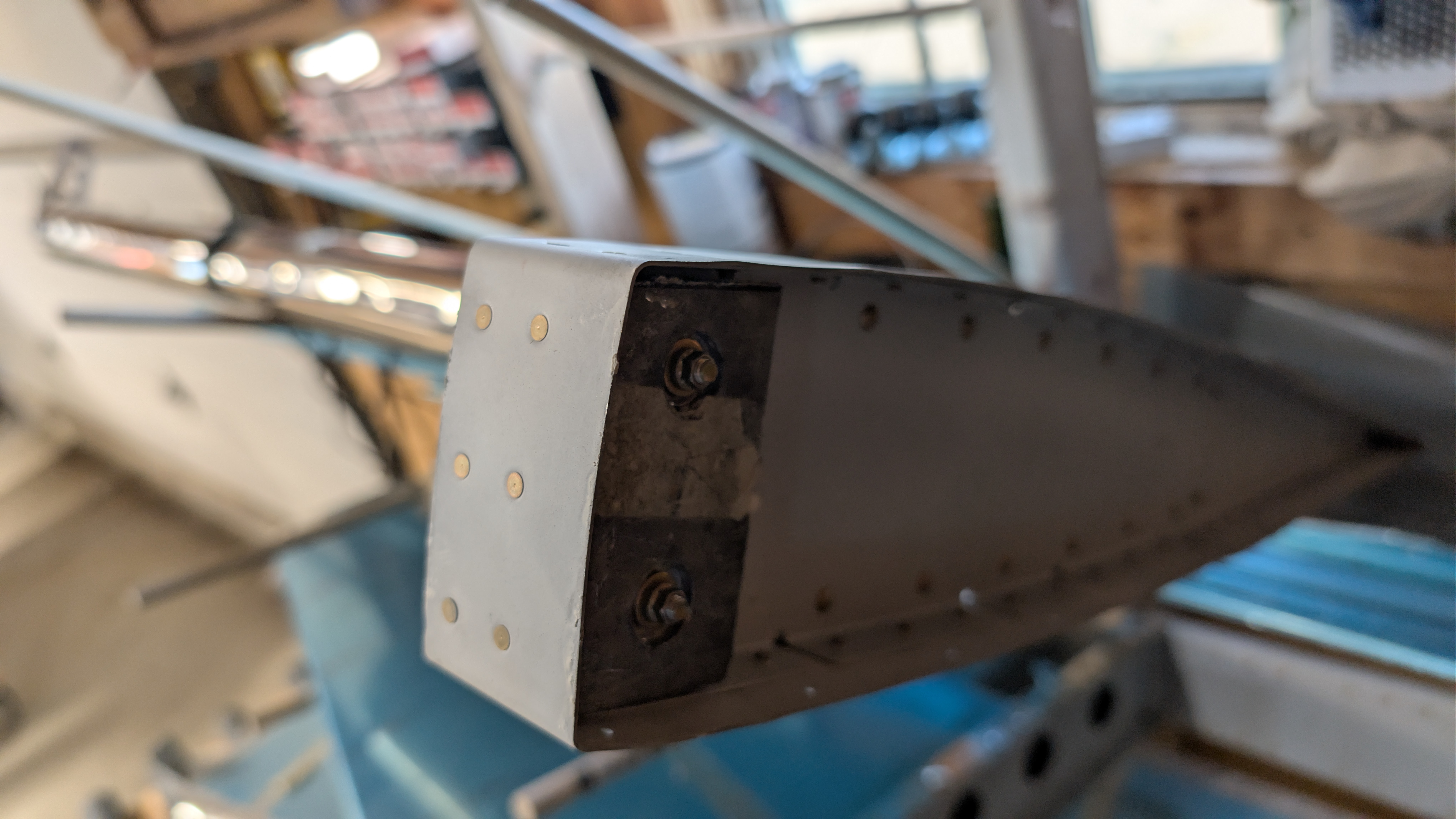

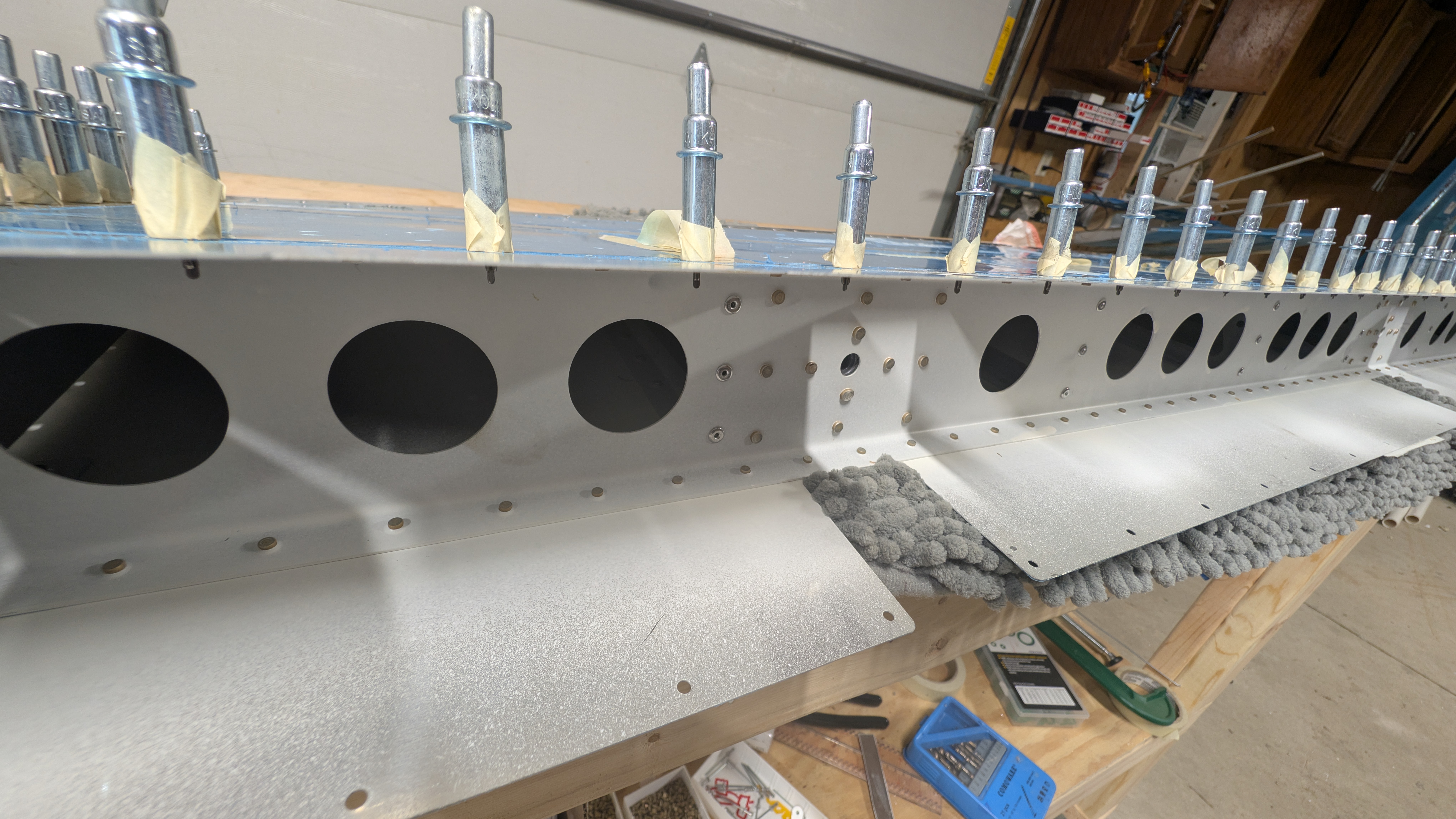

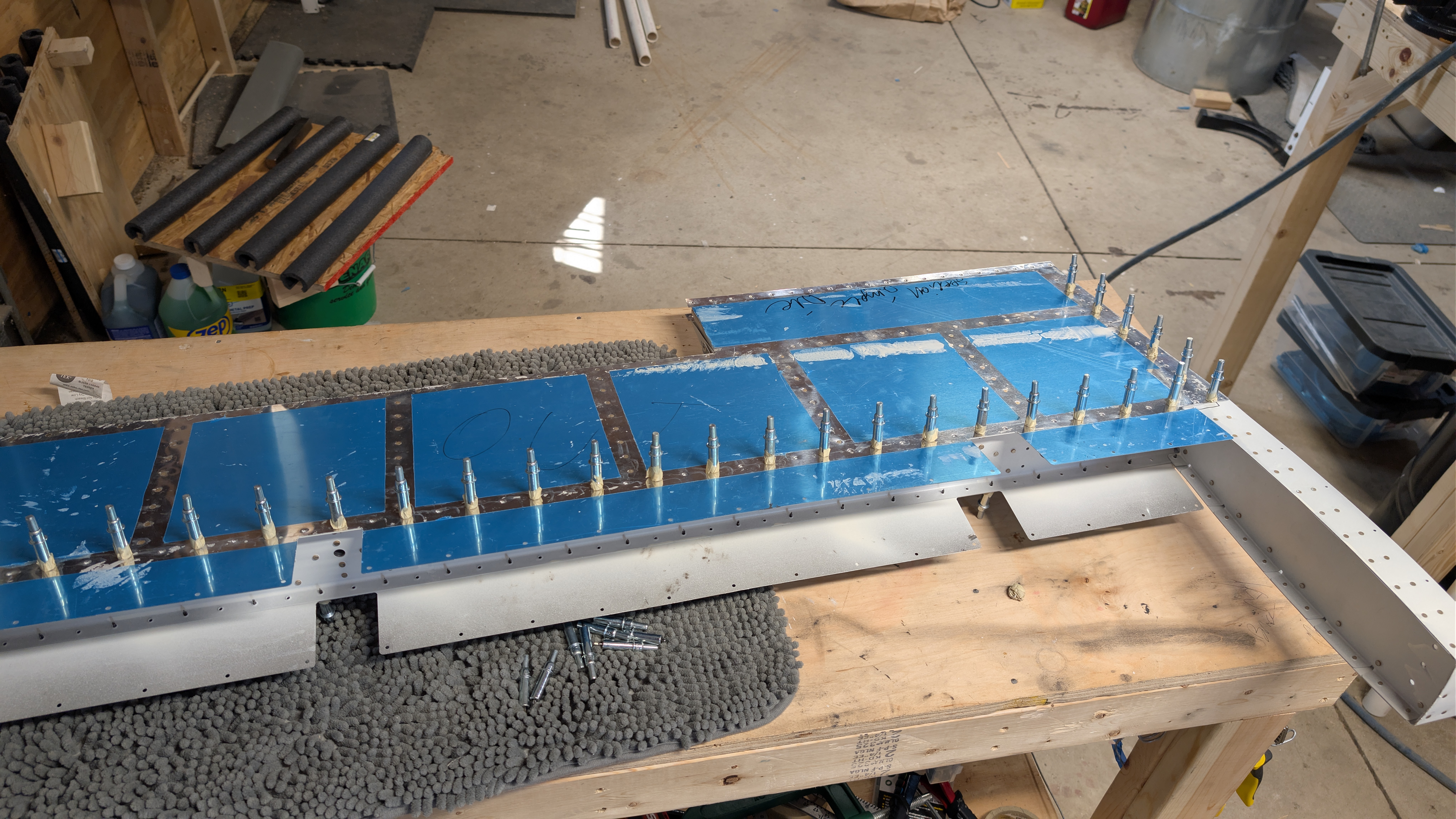

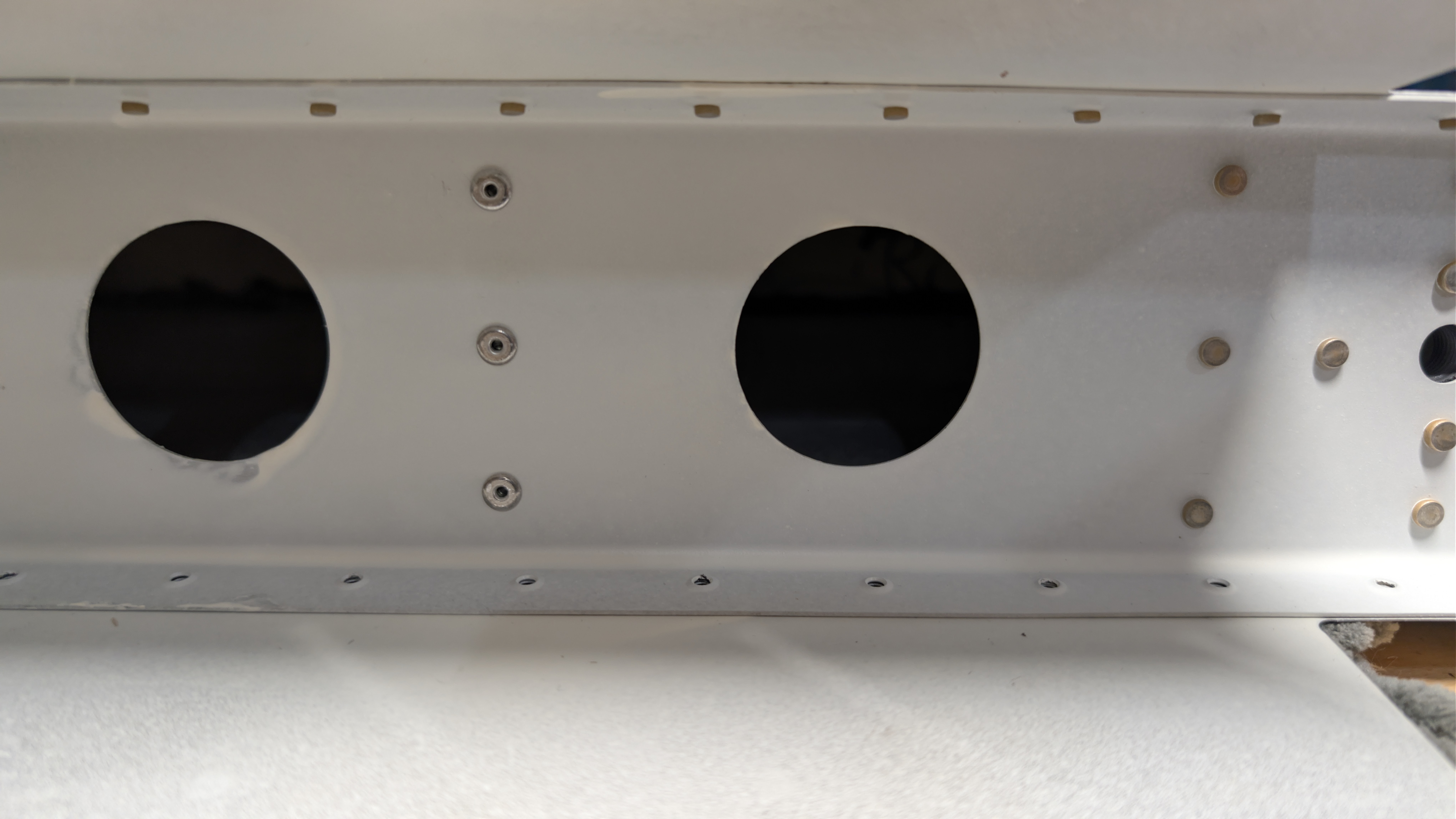

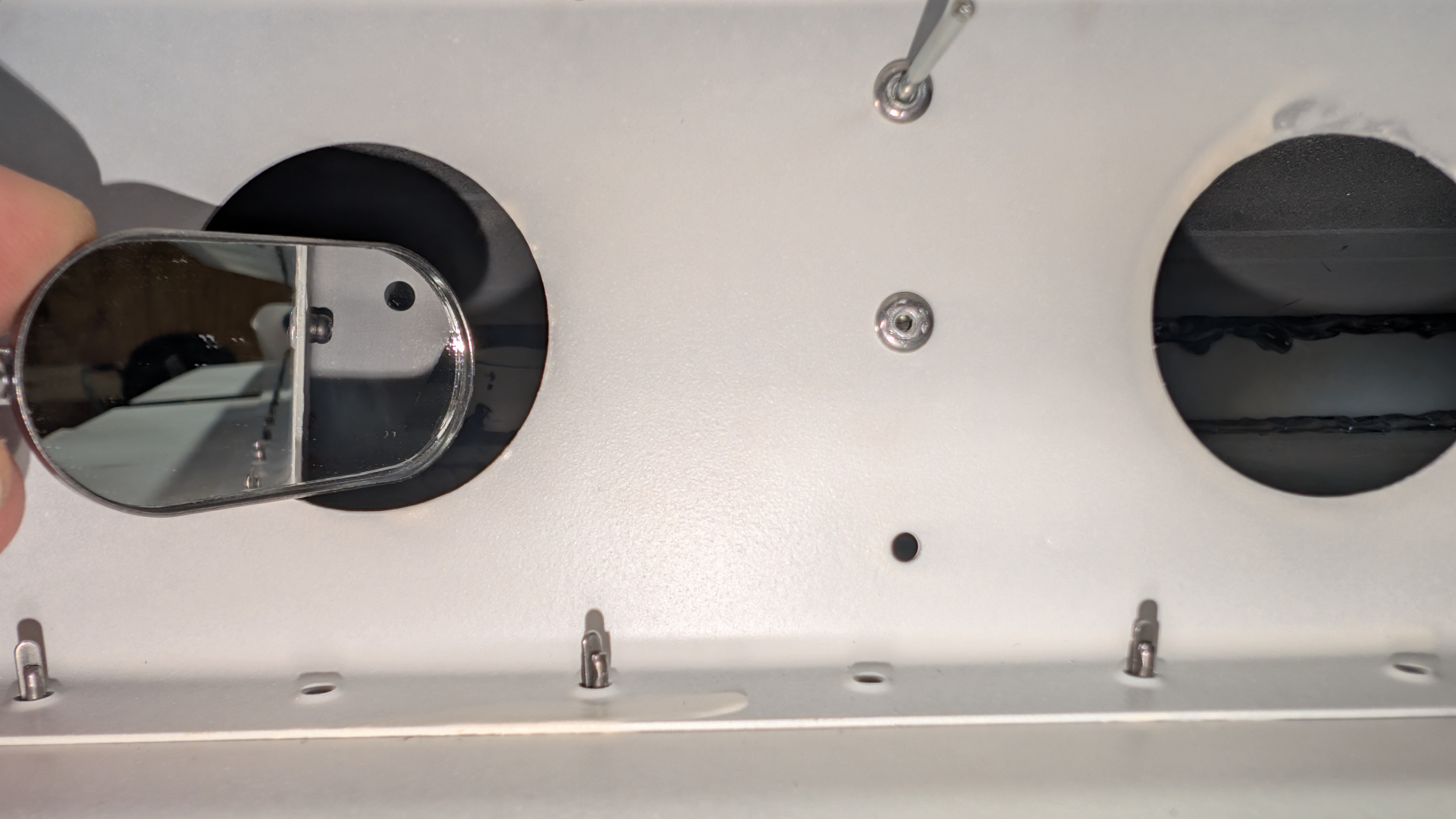

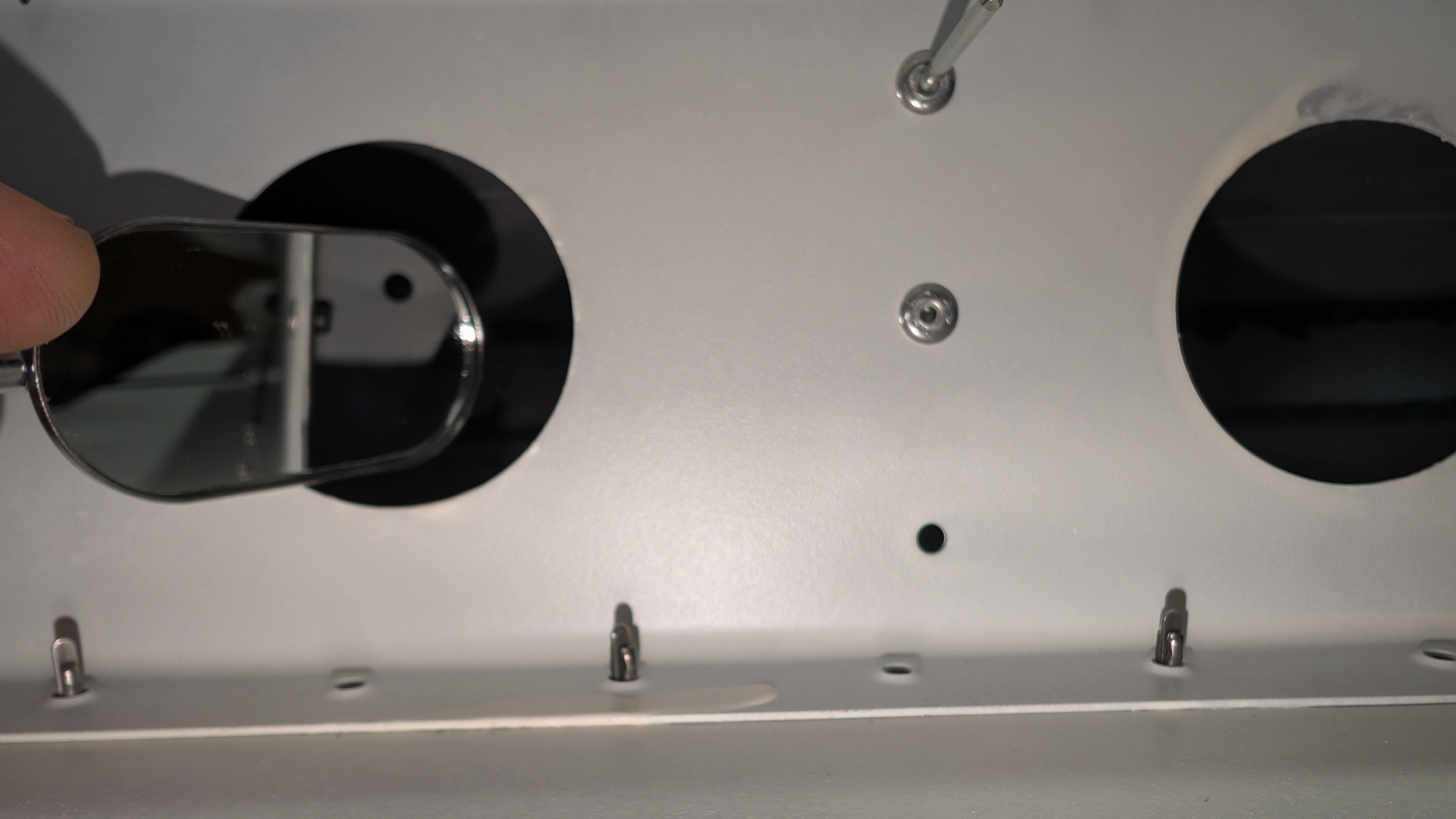

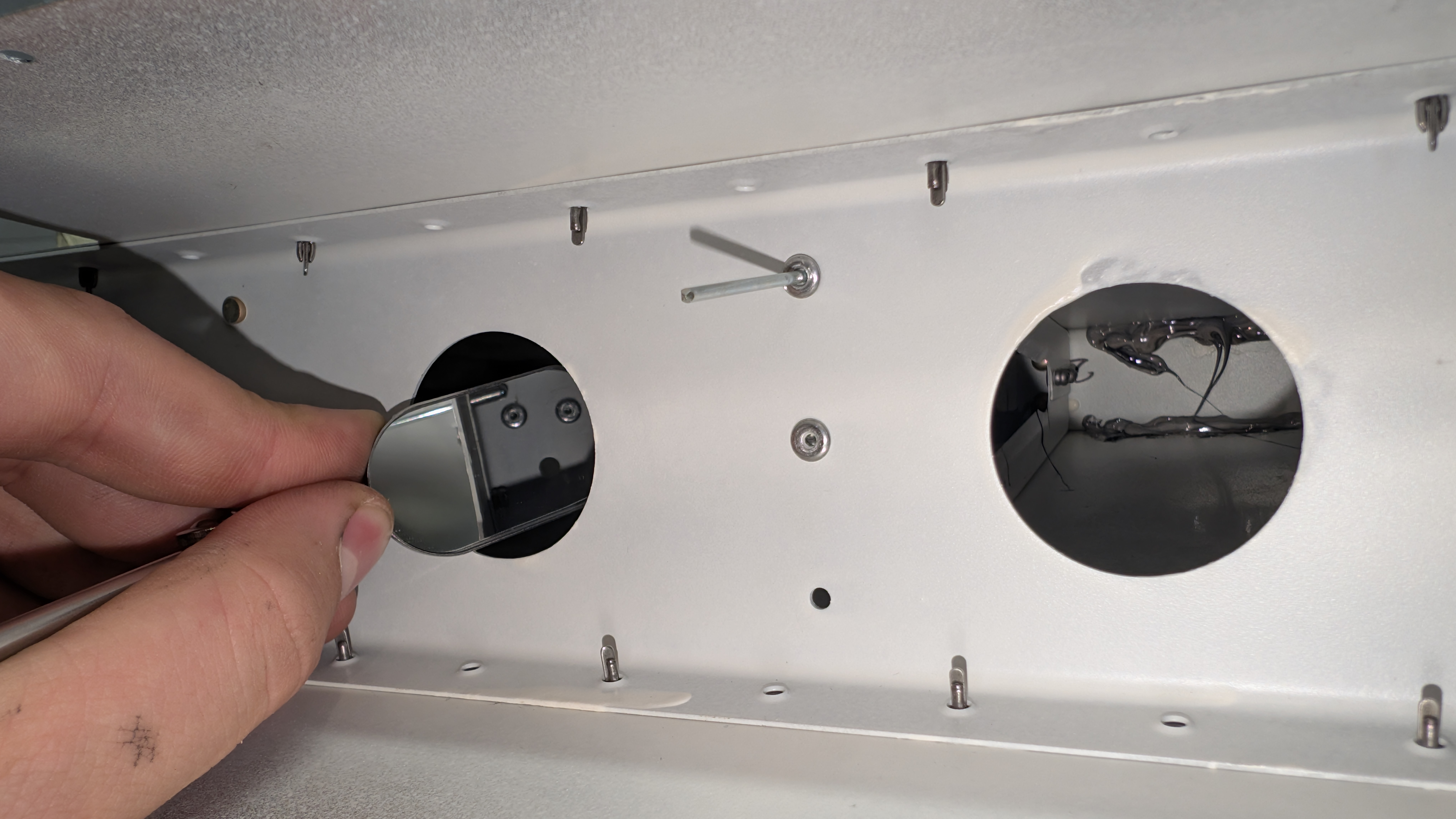

| 8/30 | 4.0 | | | | | [1 (full), 2 (full), 3 (full), 4 (full), 5 (full), 6 (full), 7 (full), 8 (full), 9 (full), 10 (full), 11 (full), 12 (full), 13 (full), 14 (full), 15 (full), 16 (full), 17 (full), 18 (full), 19 (full)] |

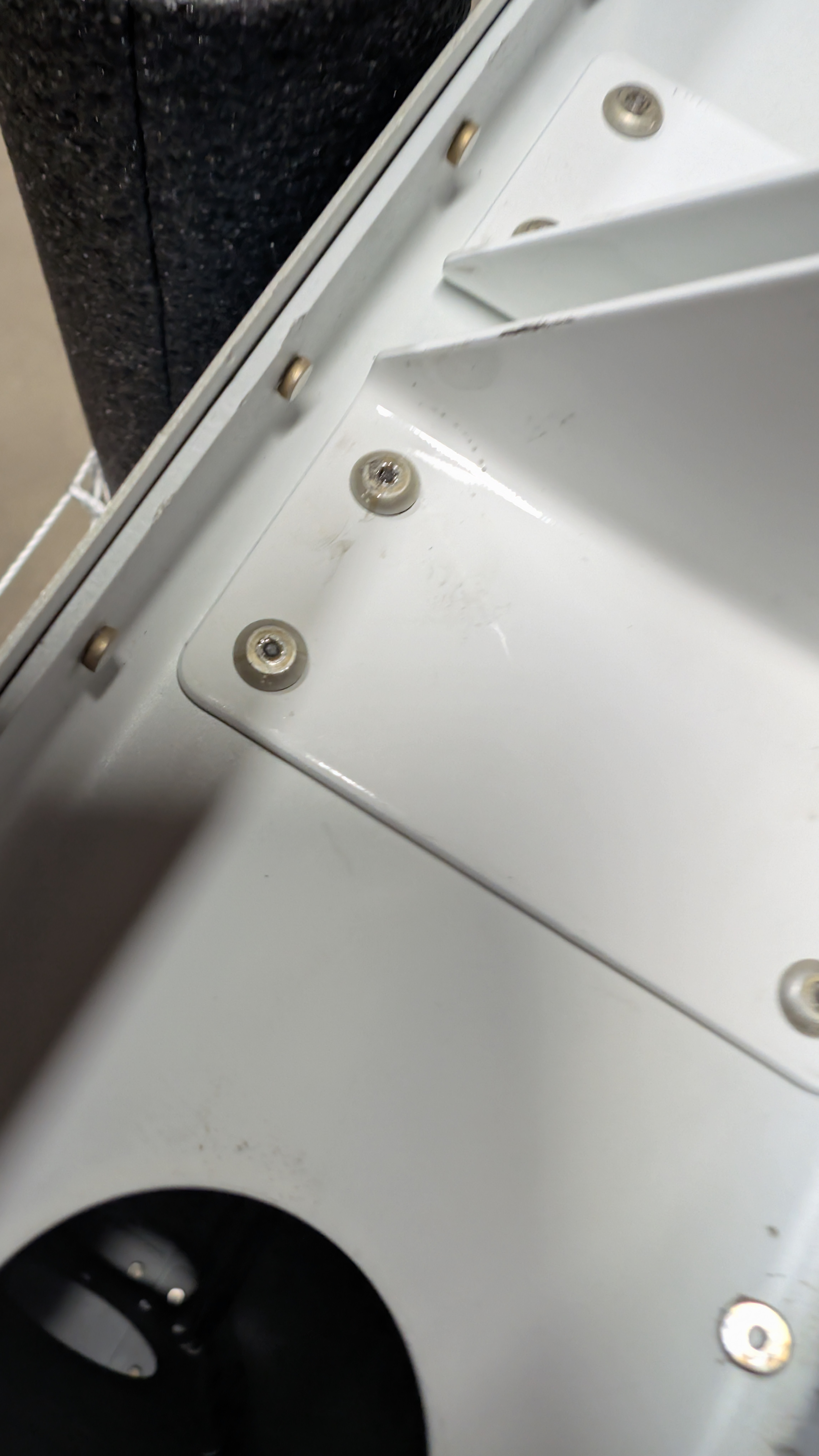

| 8/31 | 1.0 | | | | Mirror inspection- no progress on elevator | [1 (full), 2 (full), 3 (full), 4 (full), 5 (full)] |

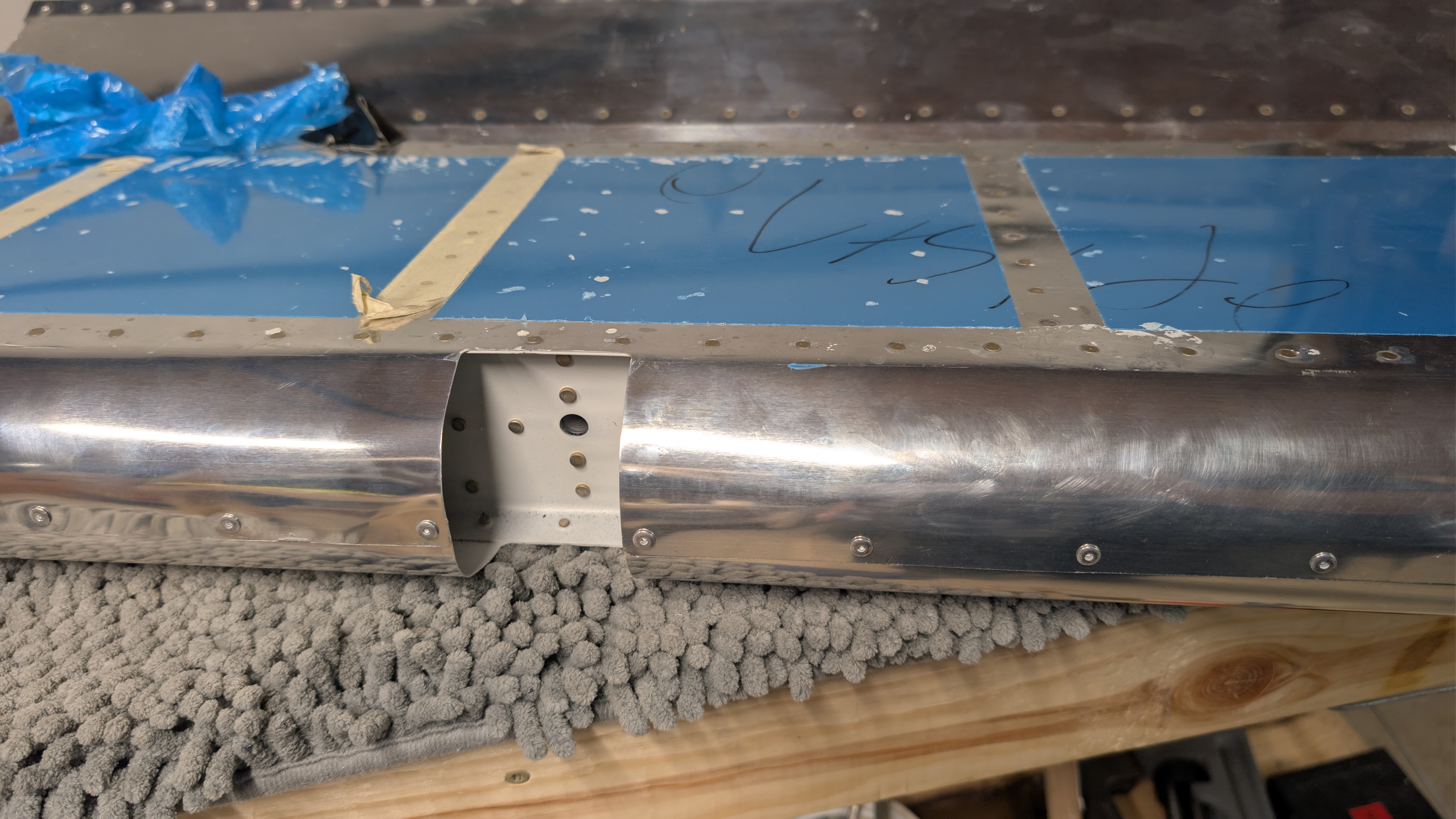

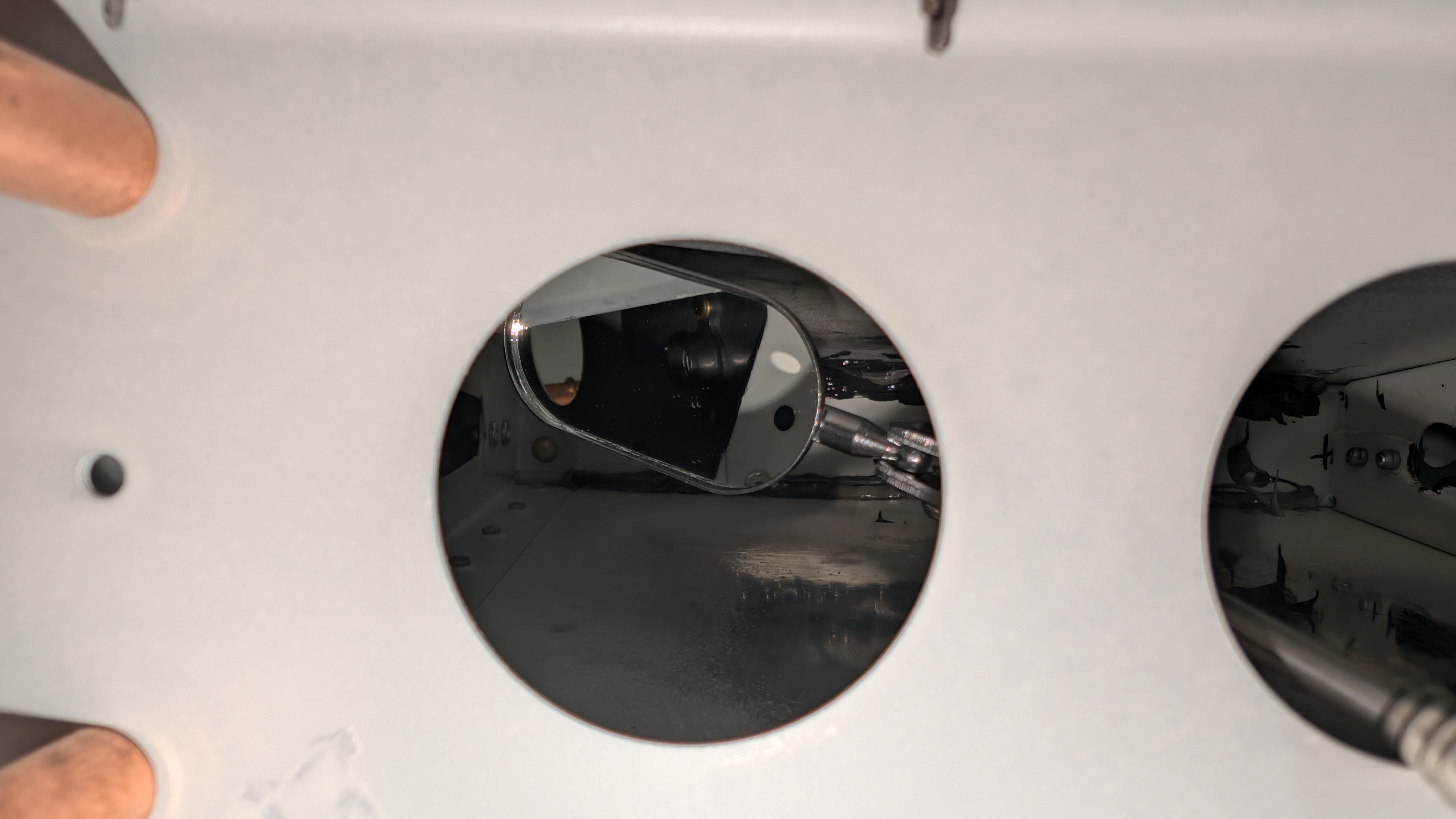

| 9/1 | 2.0 | | | | Clecoing skins on, first rivets in skin. (front spar) | [1 (full), 2 (full)] |
| 9/2 | 2.0 | | | | Riveting front spars in elevator (contd) | [1 (full), 2 (full)] |
| 9/3 | 0.0 | | | | No progress, just funny pic | [1 (full), 2 (full), 3 (full)] |
| 9/6 | 0.0 | | | | | [1 (full), 2 (full), 3 (full)] |
| --- | 0.0 | | | | | |

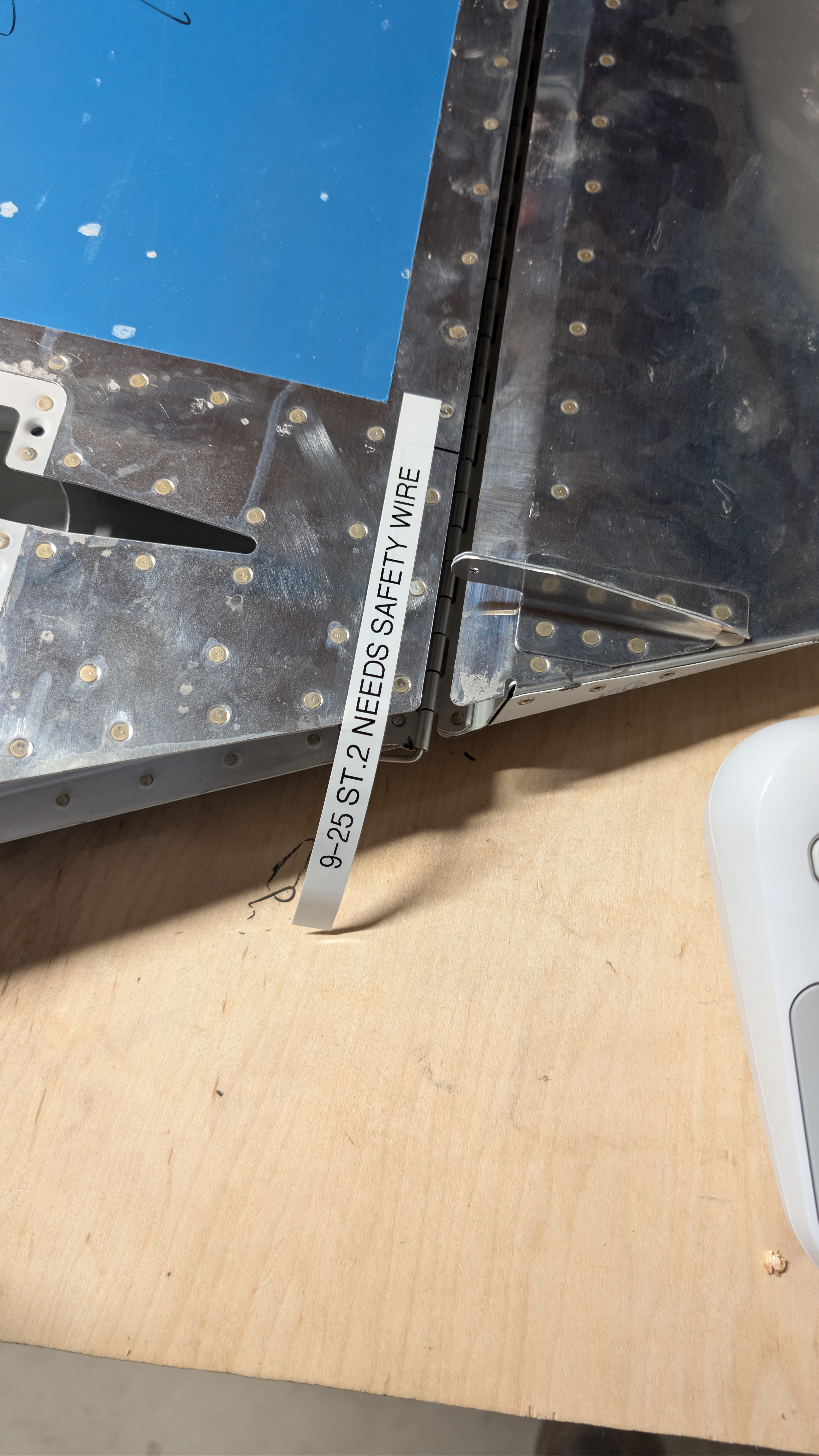

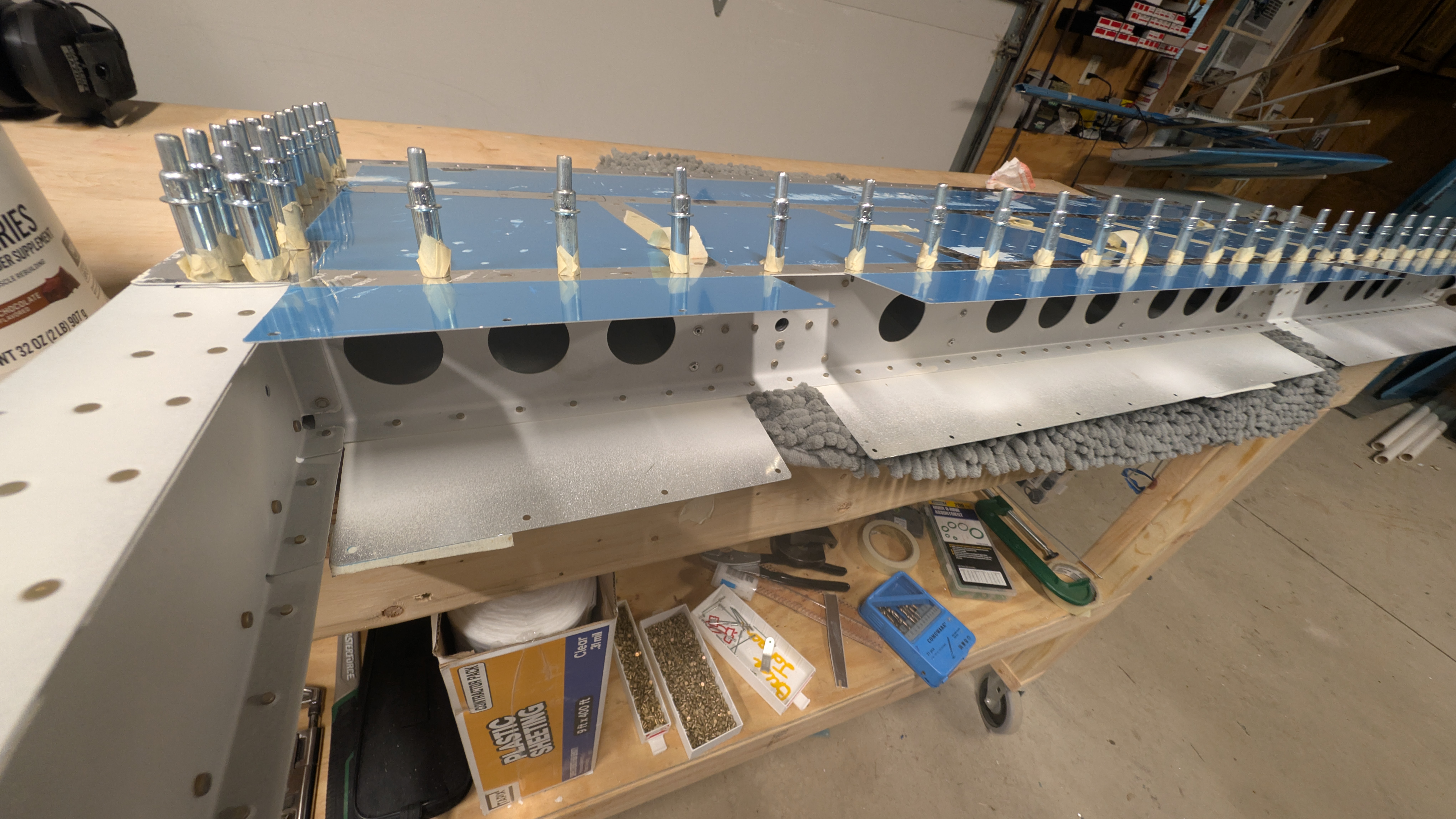

| 9/9 | 3.0 | | | | Made and drilled some more front spar rivets. | |
| --- | 0.0 | | | | | |
| 9/13 | 0.0 | | | | | [1 (full), 2 (full)] |

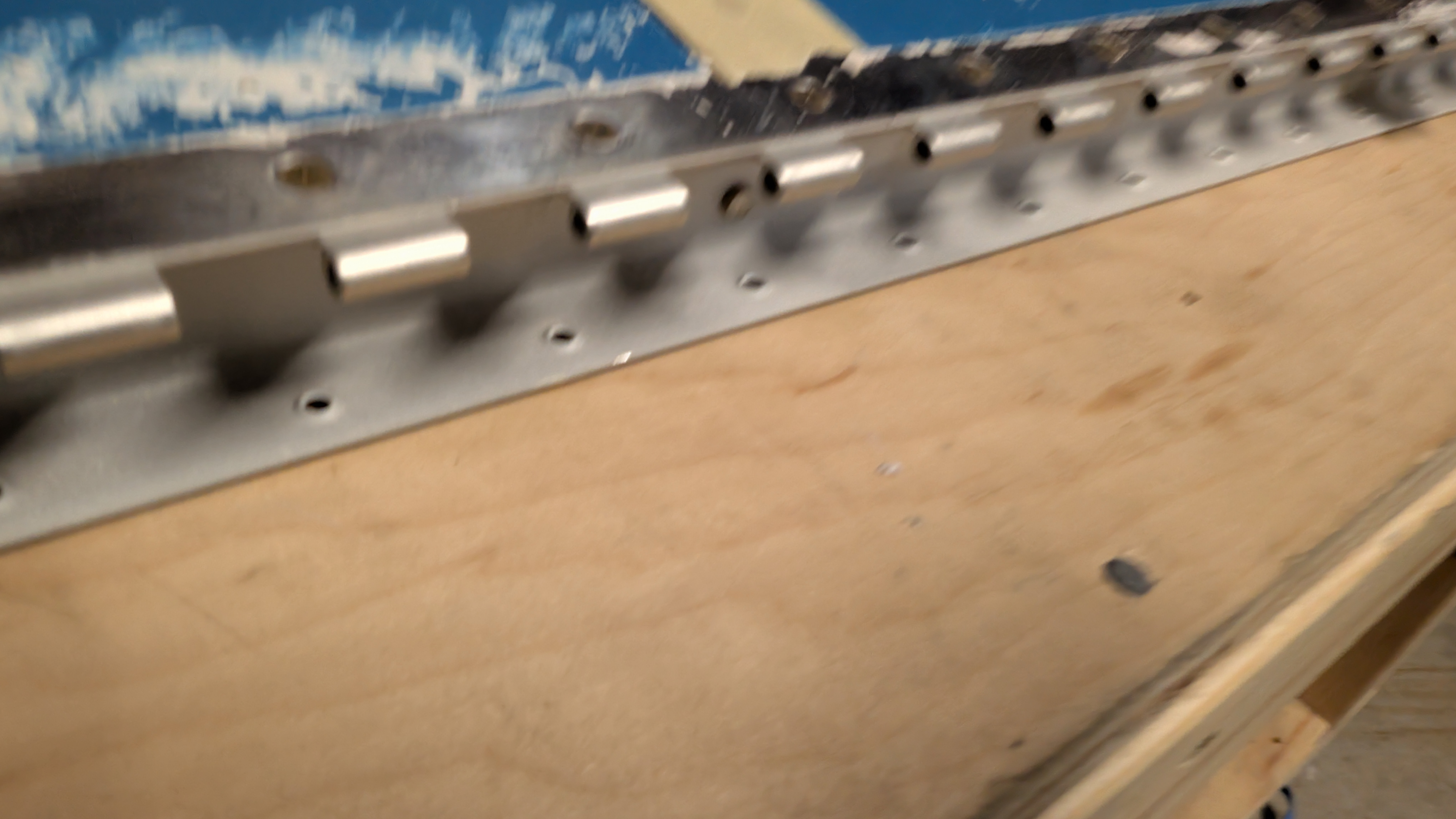

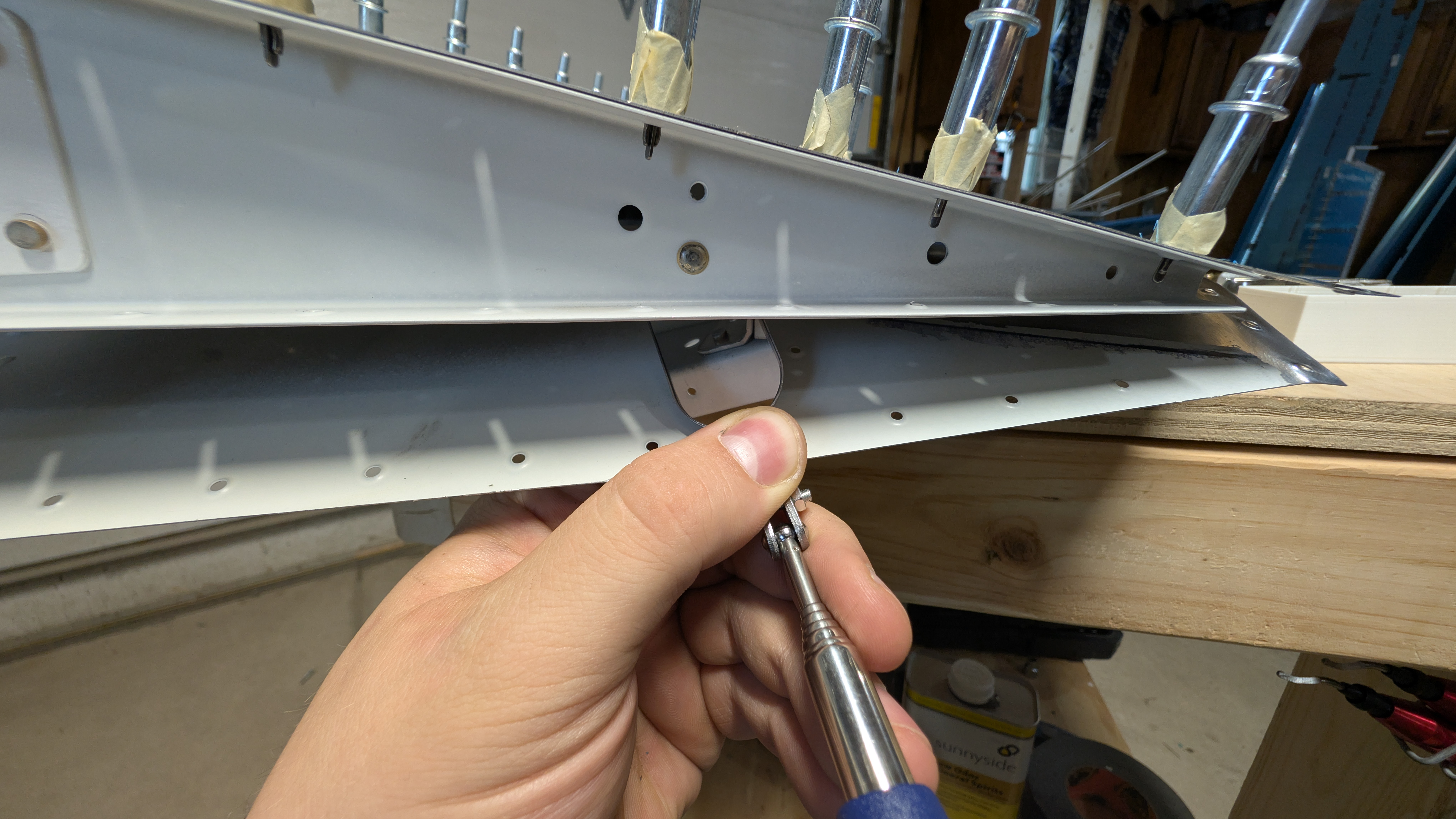

| 9/14 | 3.5 | | | | Set double sided tape for trailing edge. | [1 (full), 2 (full)] |

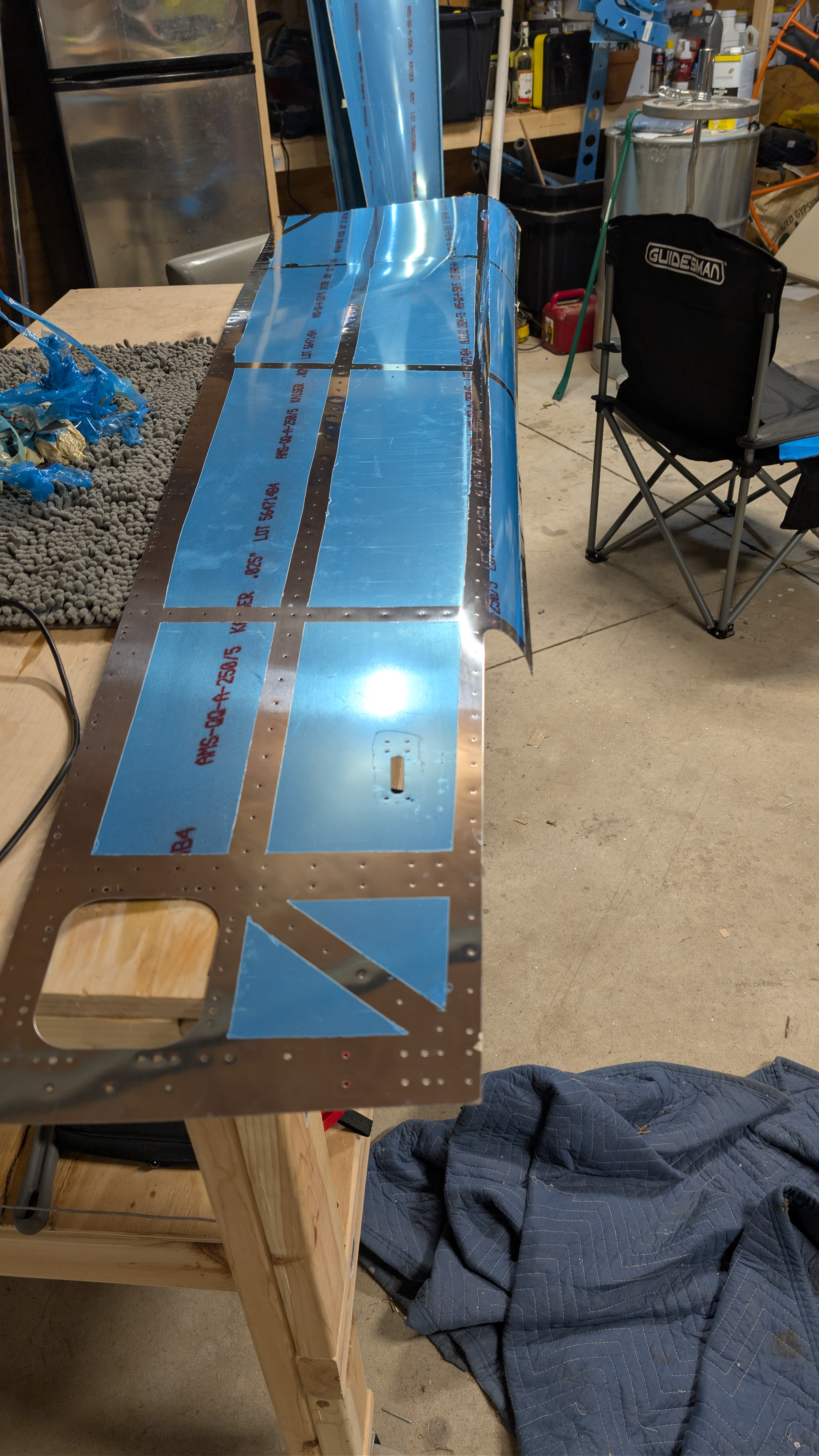

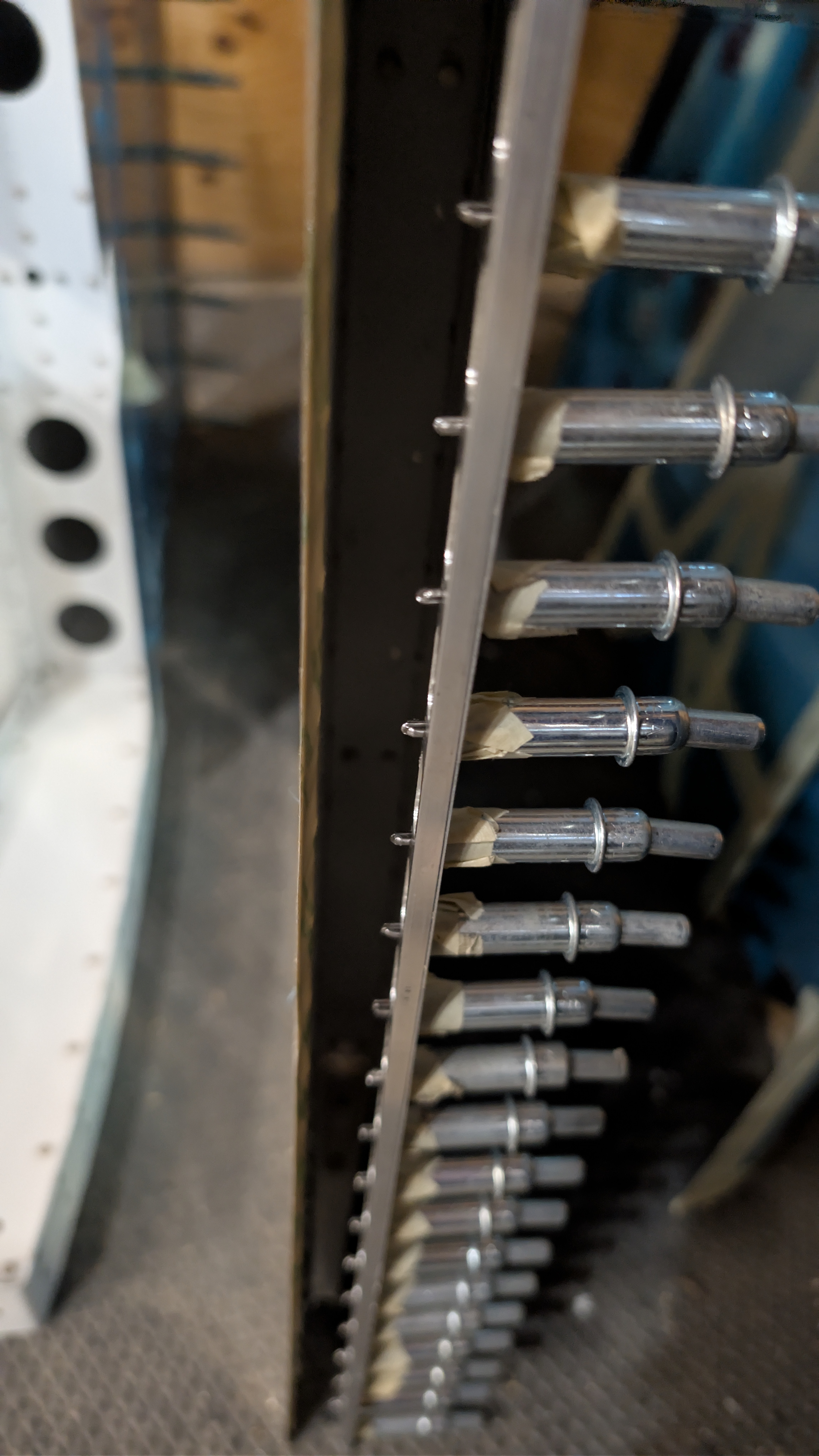

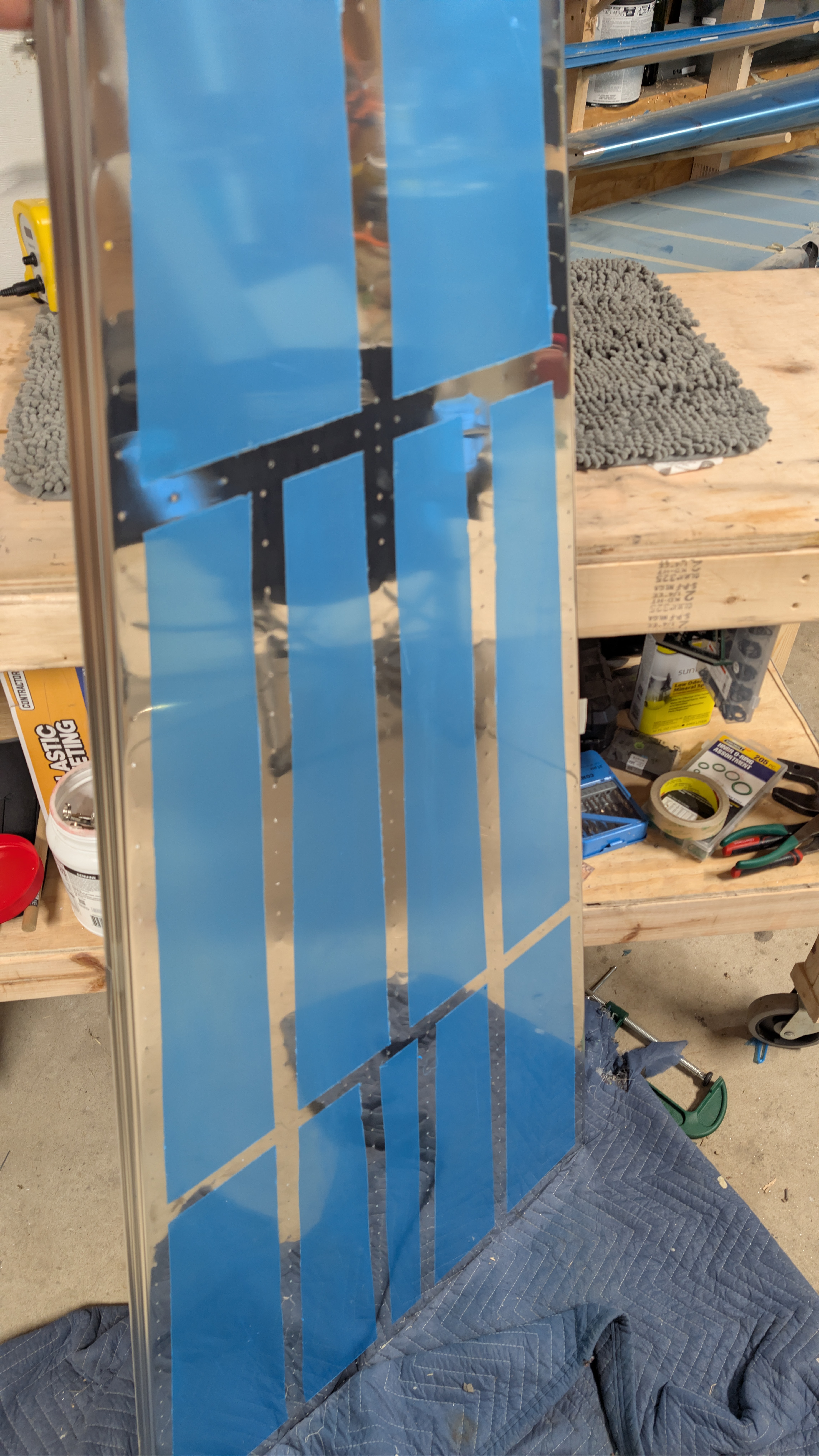

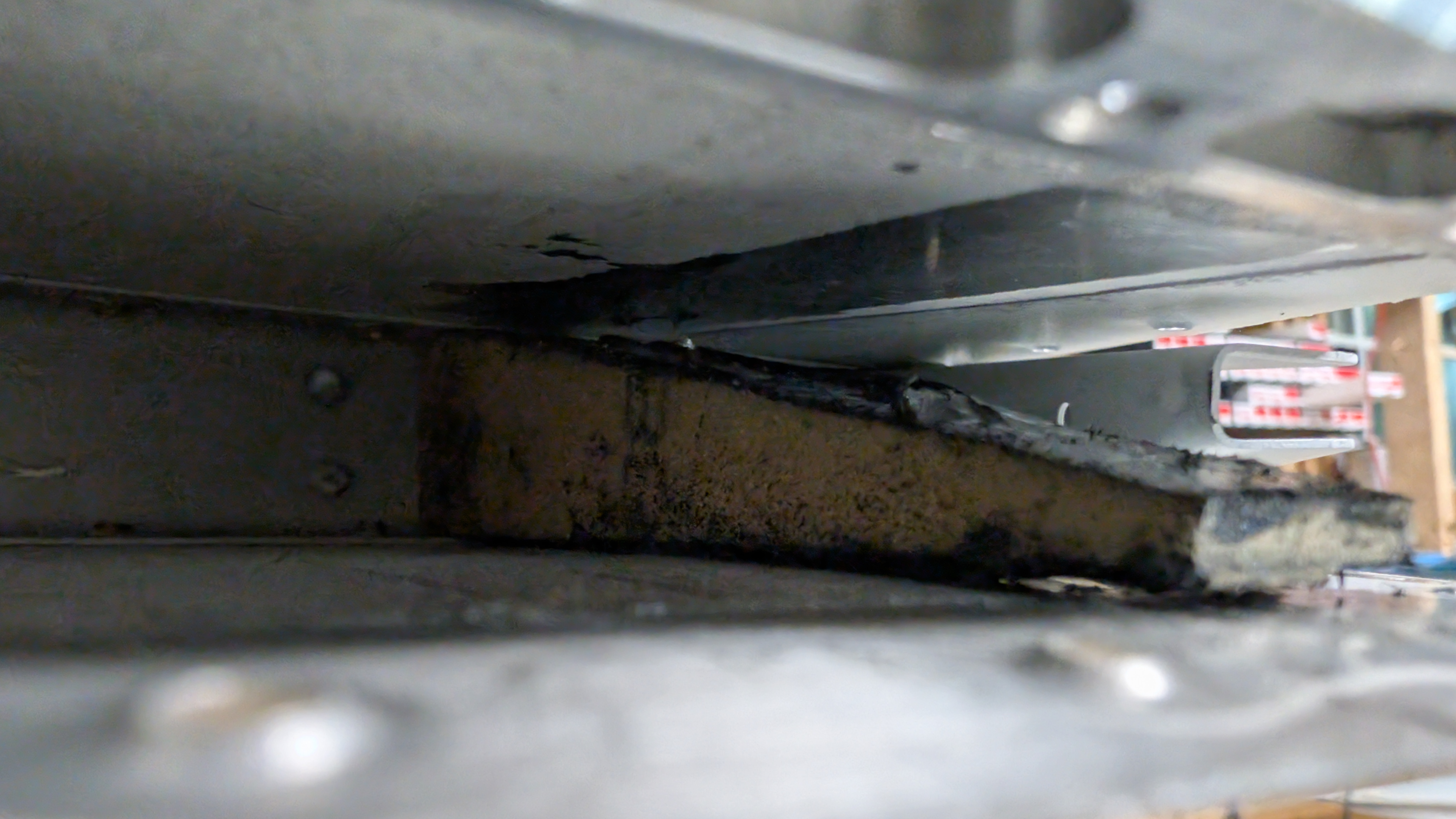

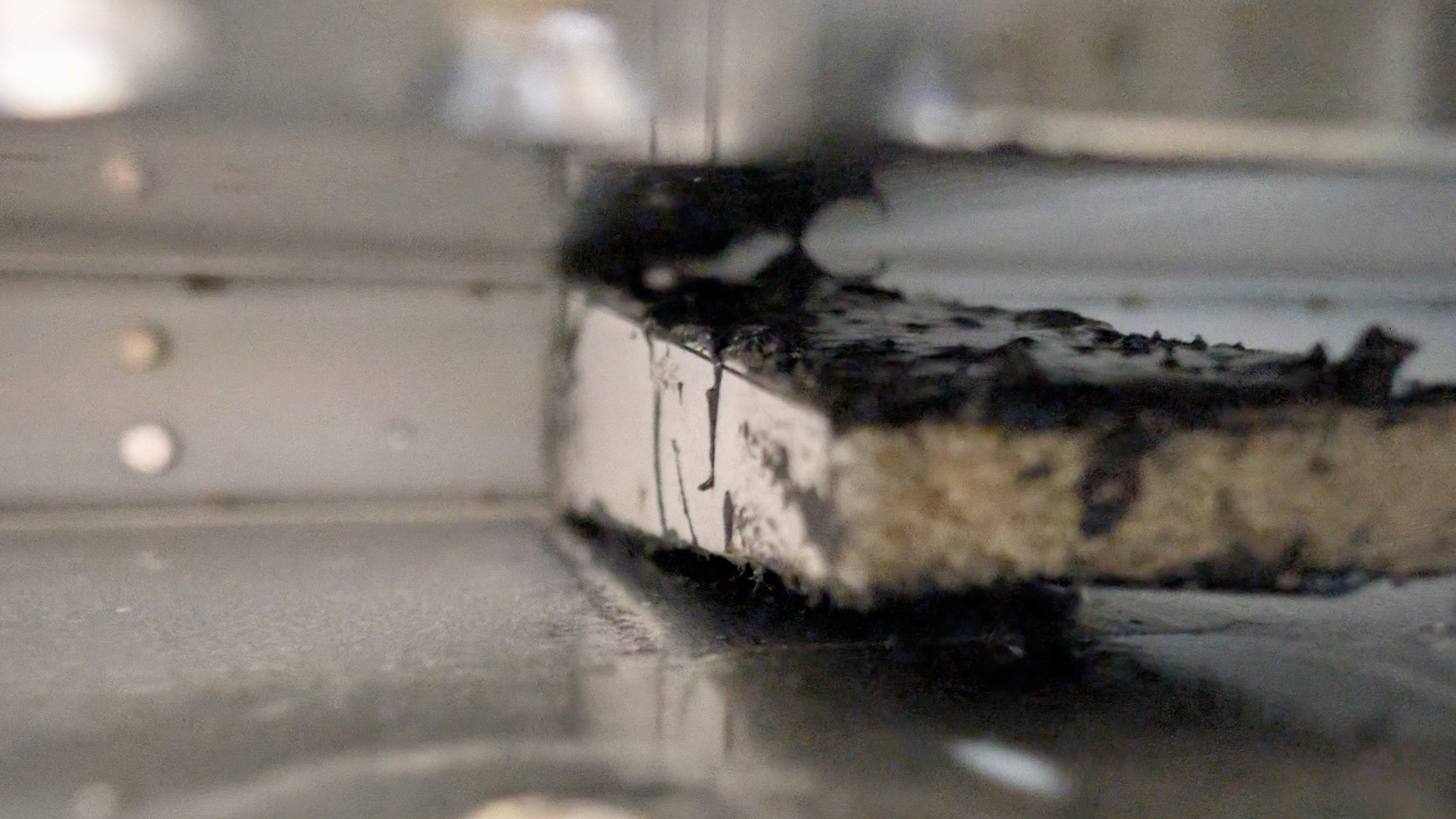

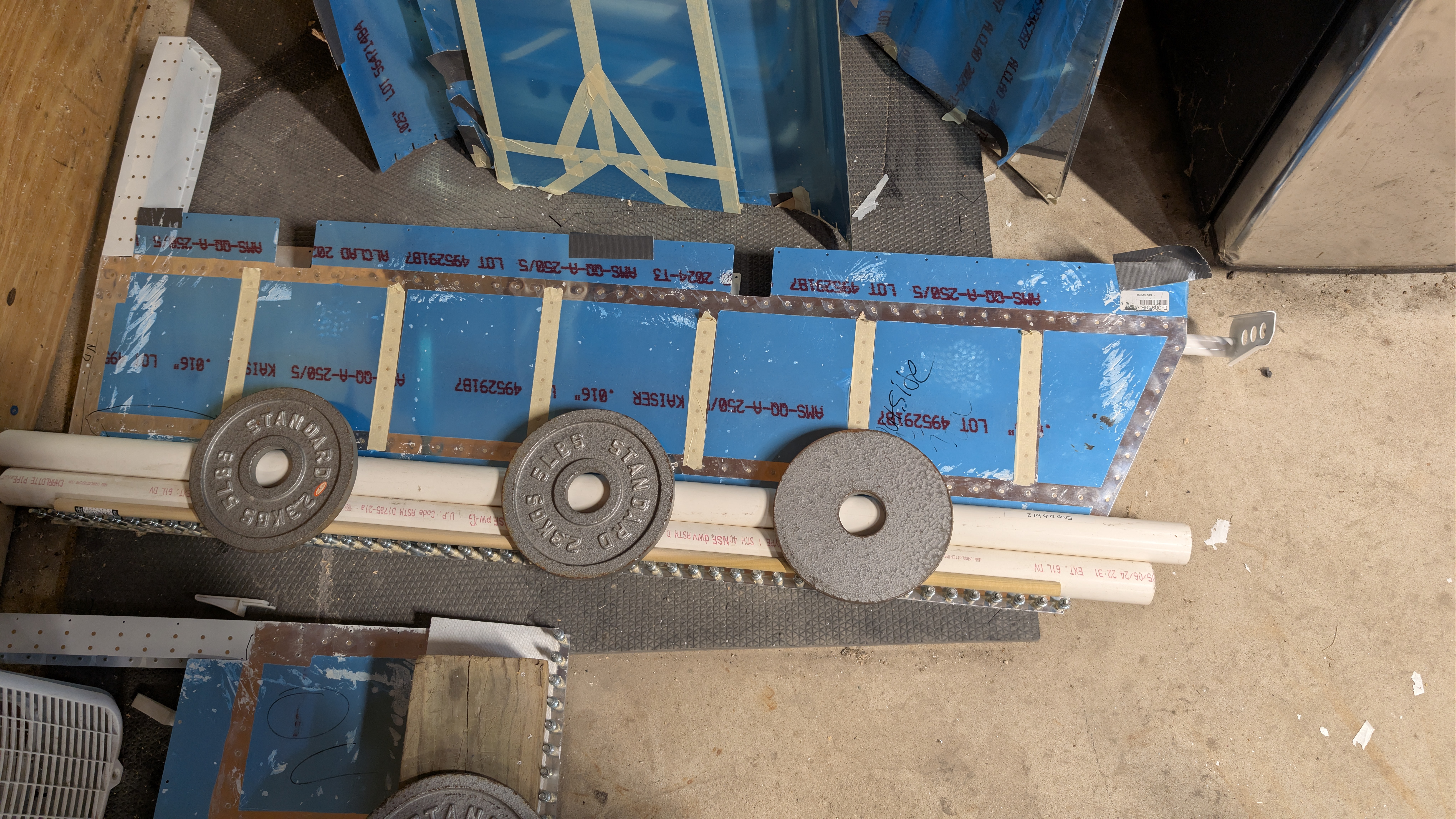

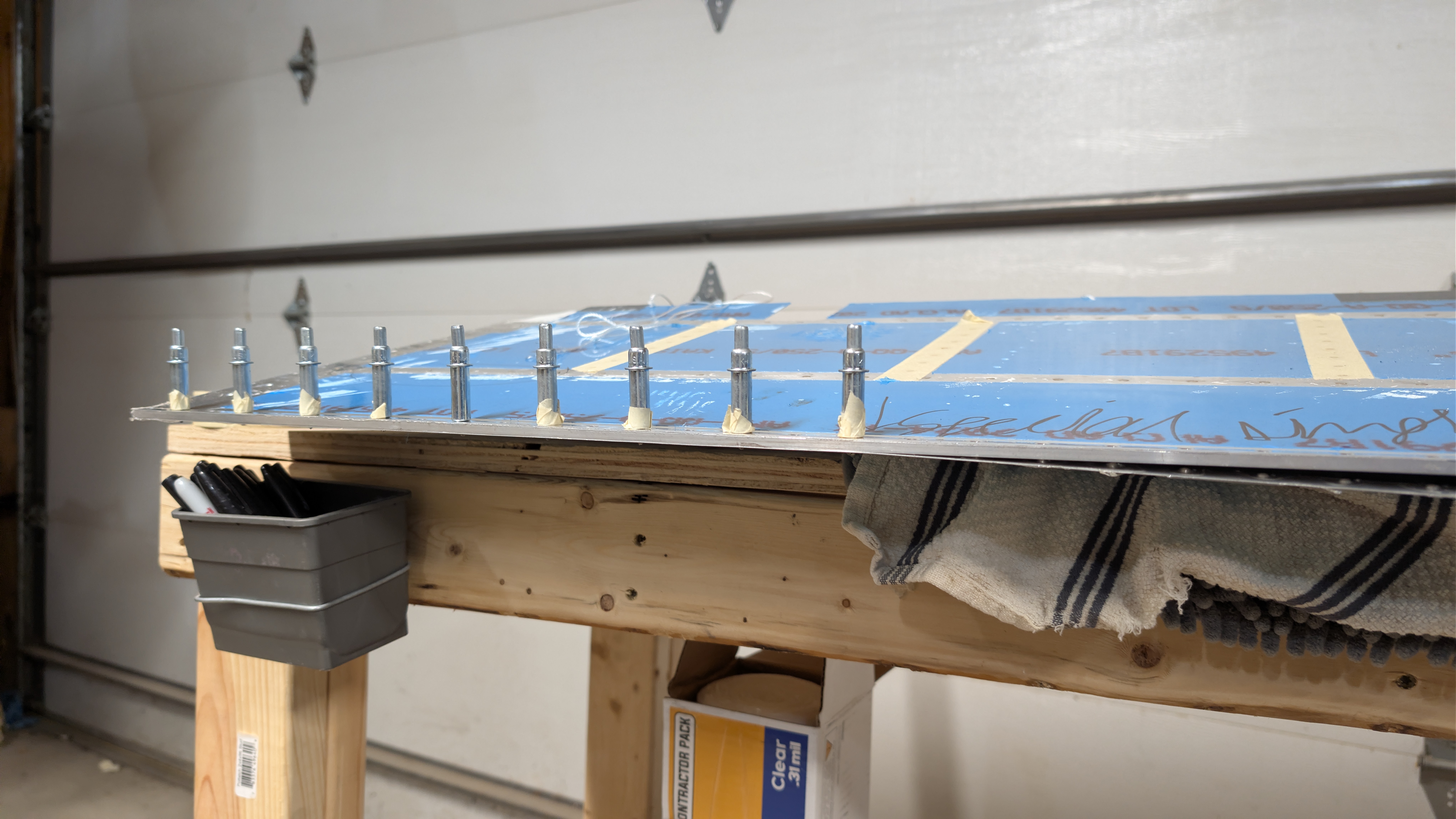

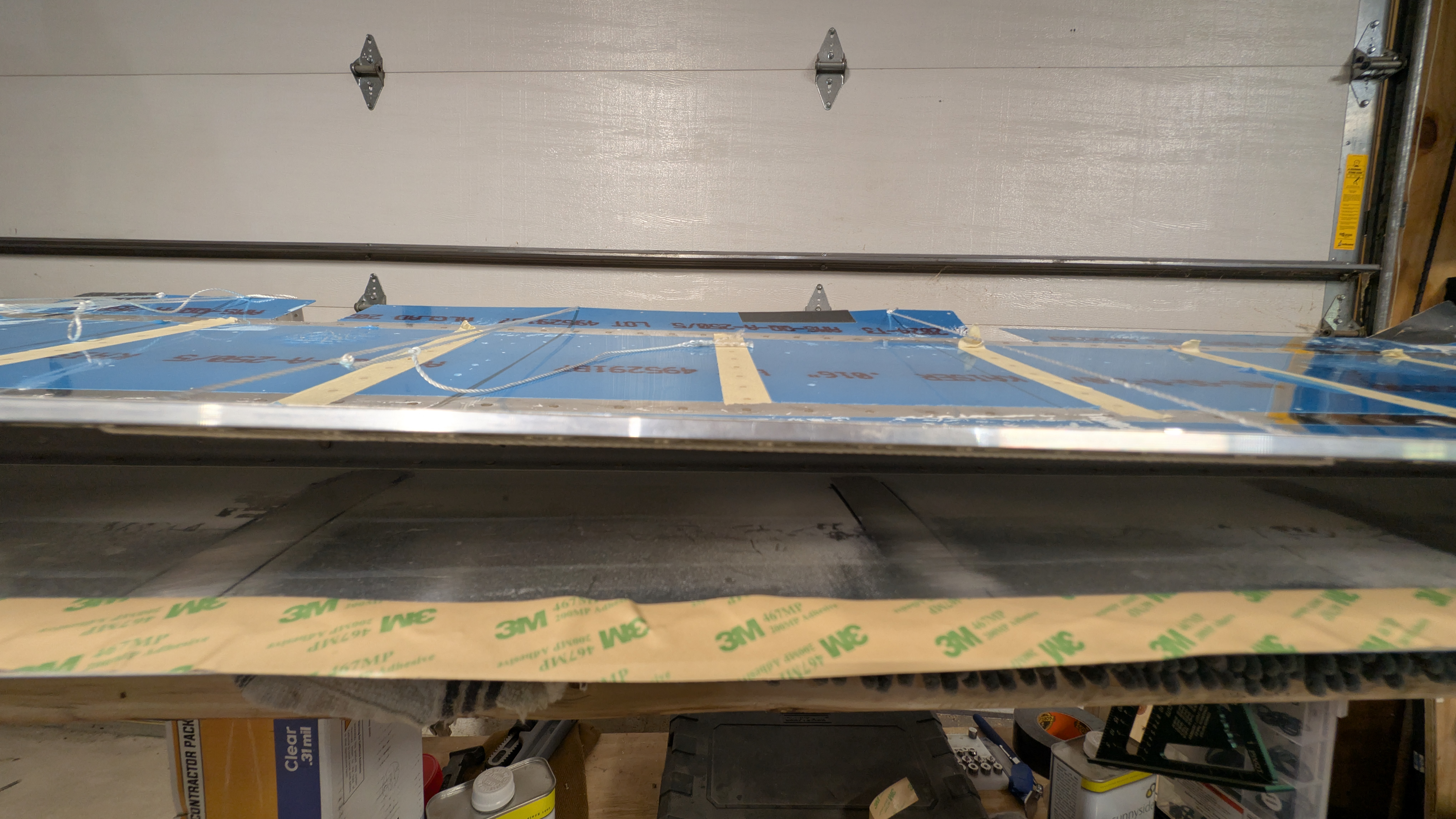

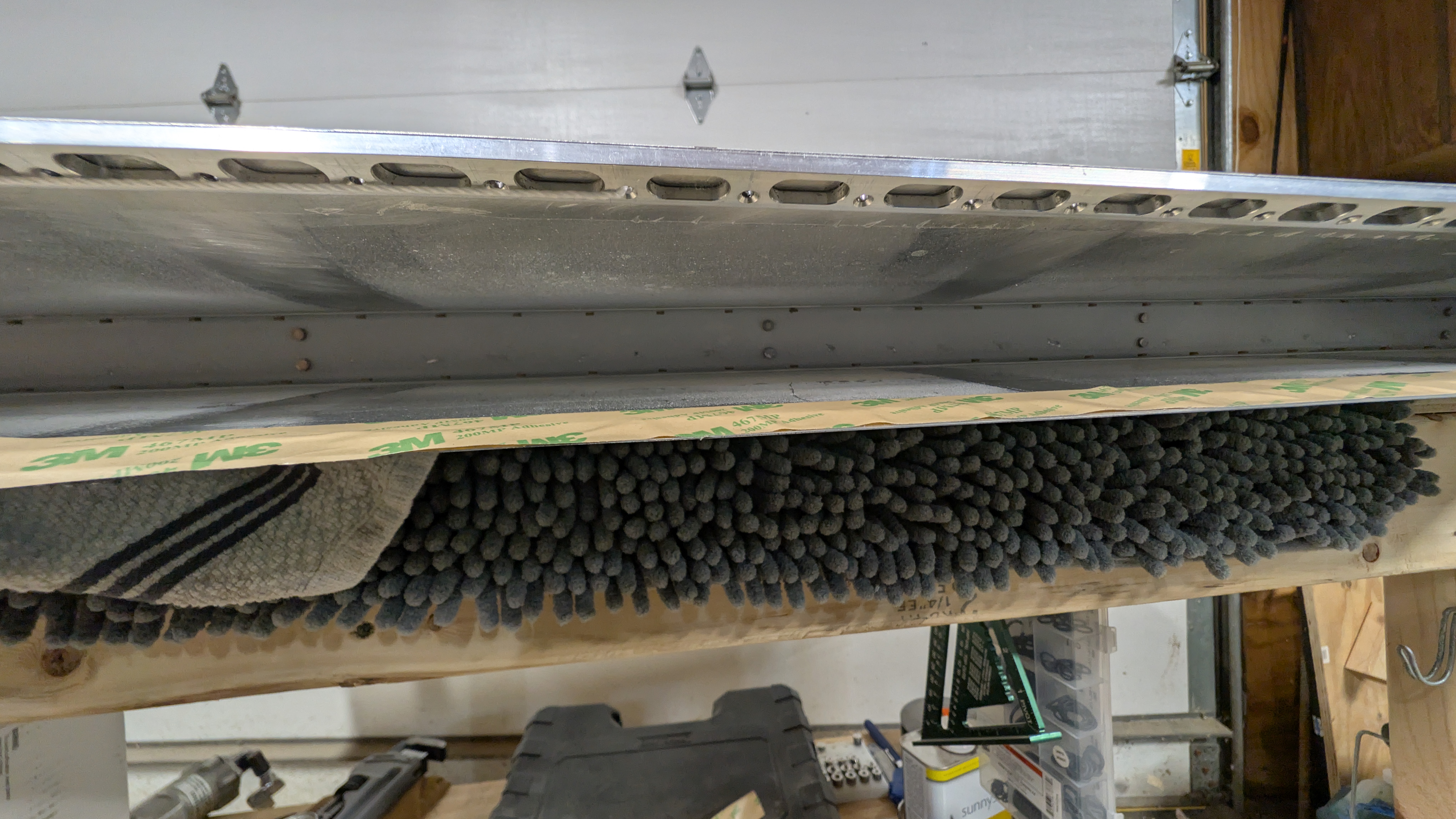

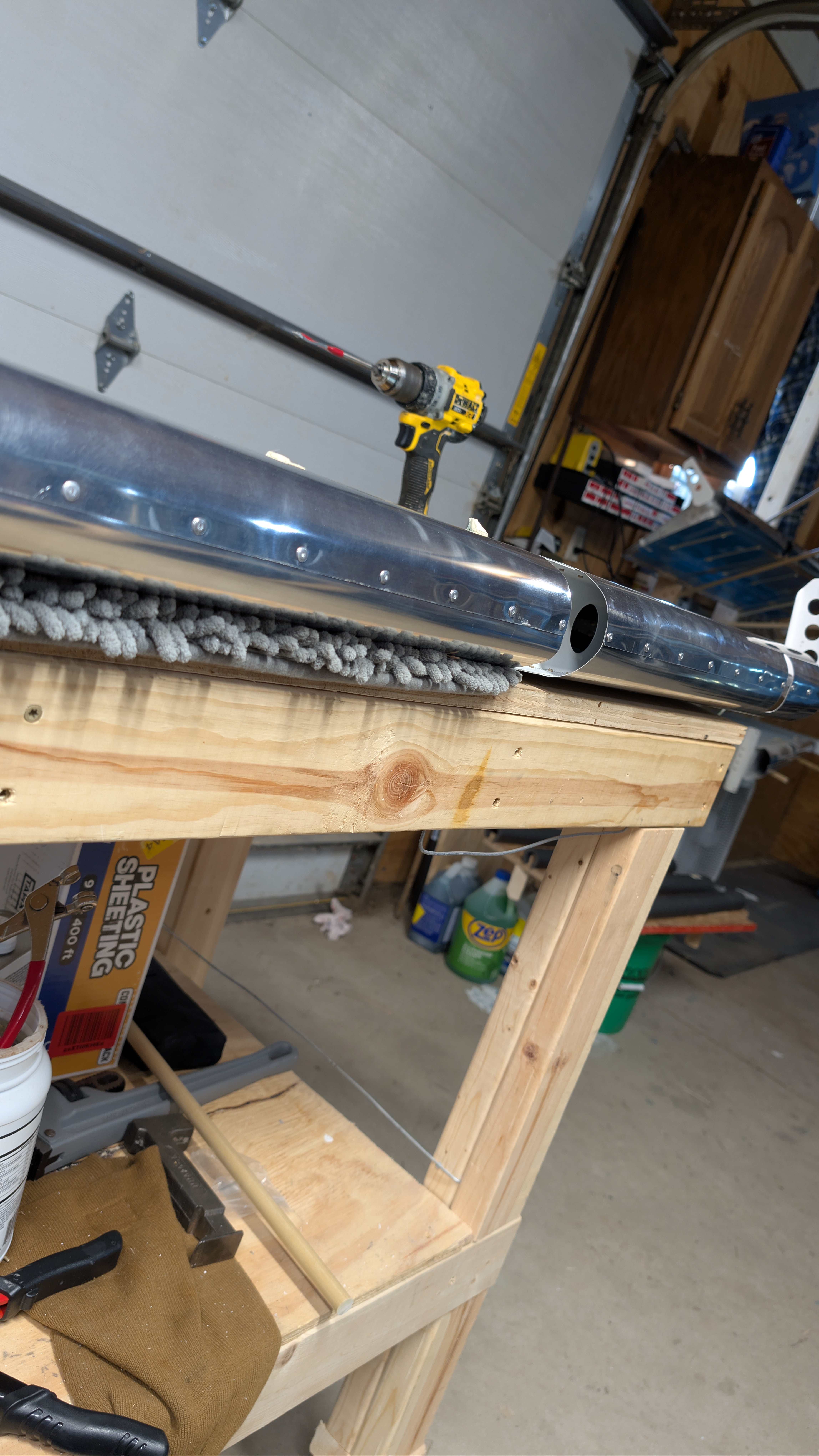

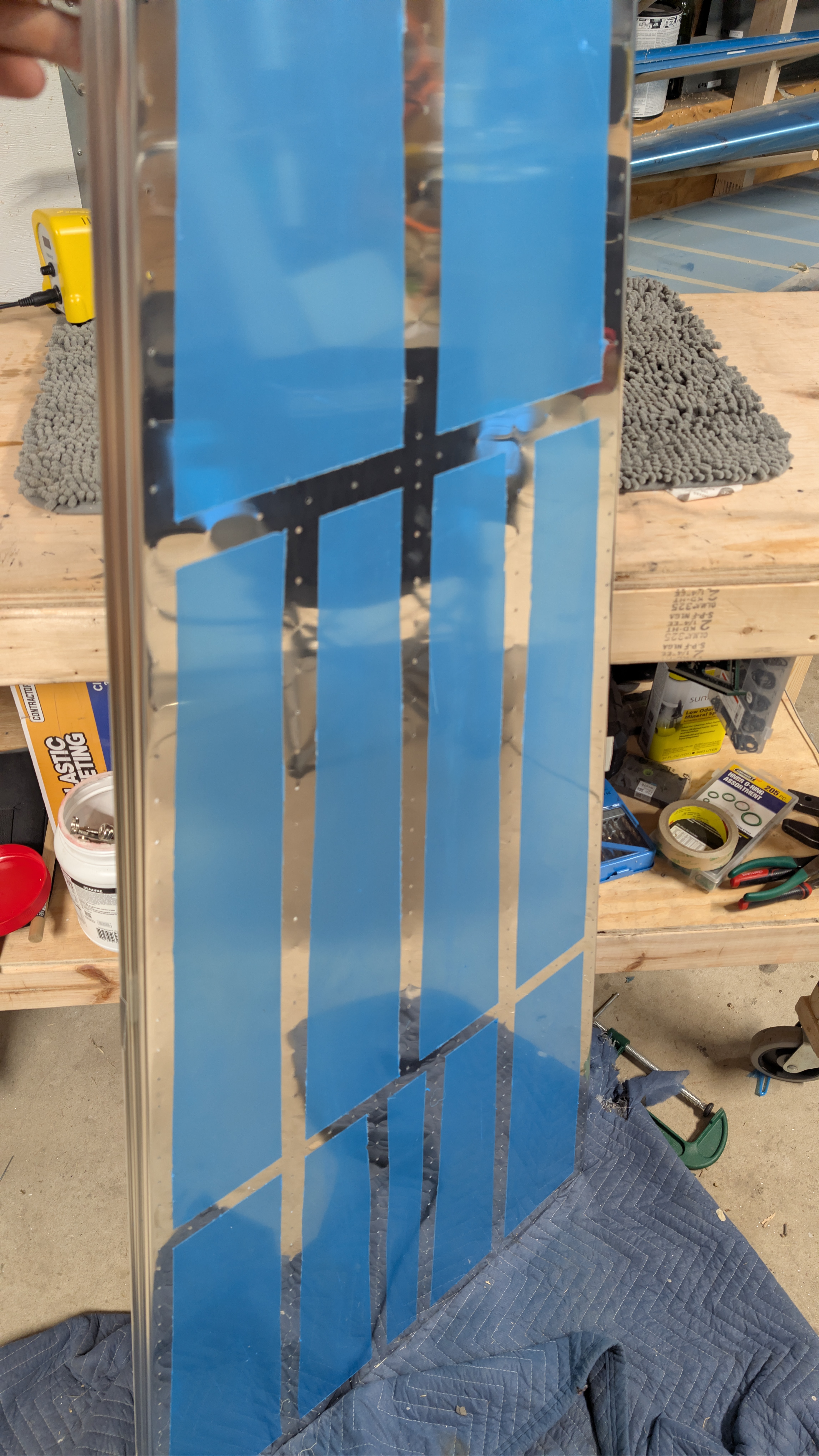

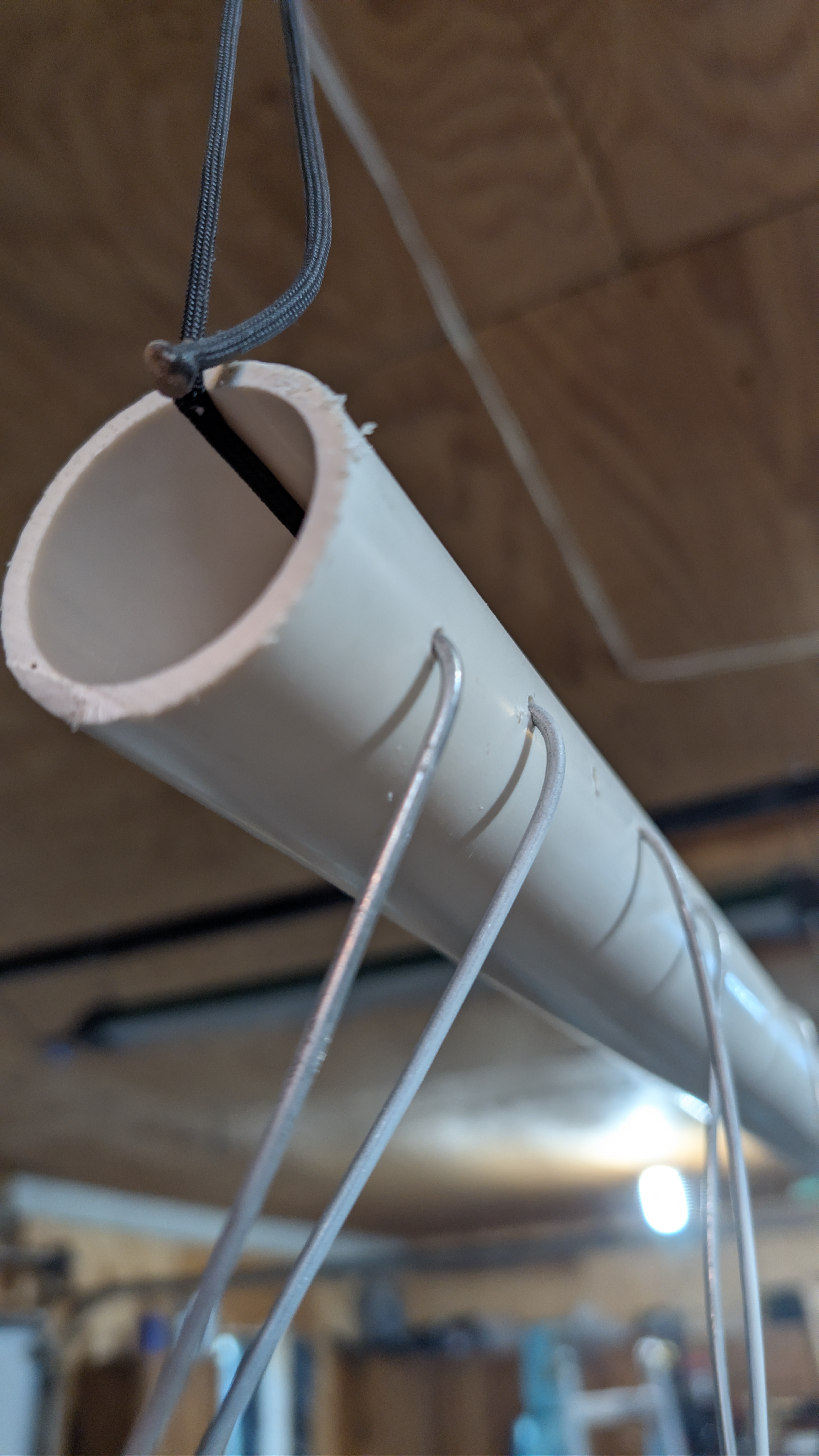

| 9/16 | 3.0 | | | | Flame-mastering the trailing edge PVC ribs, laying out the weights. | [1 (full), 2 (full), 3 (full), 4 (full), 5 (full), 6 (full), 7 (full), 8 (full), 9 (full), 10 (full), 11 (full), 12 (full), 13 (full)] |
| 9/20 | 0.0 | | | | | [1 (full), 2 (full)] |
| 9/21 | 0.0 | | | | | [1 (full), 2 (full)] |
| 9/22 | 0.0 | | | | | [1 (full), 2 (full), 3 (full)] |
| 9/23 | 0.0 | | | | | [1 (full), 2 (full)] |
| 9/24 | 0.0 | | | | | [1 (full), 2 (full), 3 (full), 4 (full)] |
| 9/26 | 0.0 | | | | | [1 (full), 2 (full), 3 (full)] |
| 10/4 | 0.0 | | | | | [1 (full), 2 (full), 3 (full), 4 (full)] |
| 10/10 | 0.0 | | | | | [1 (full), 2 (full)] |

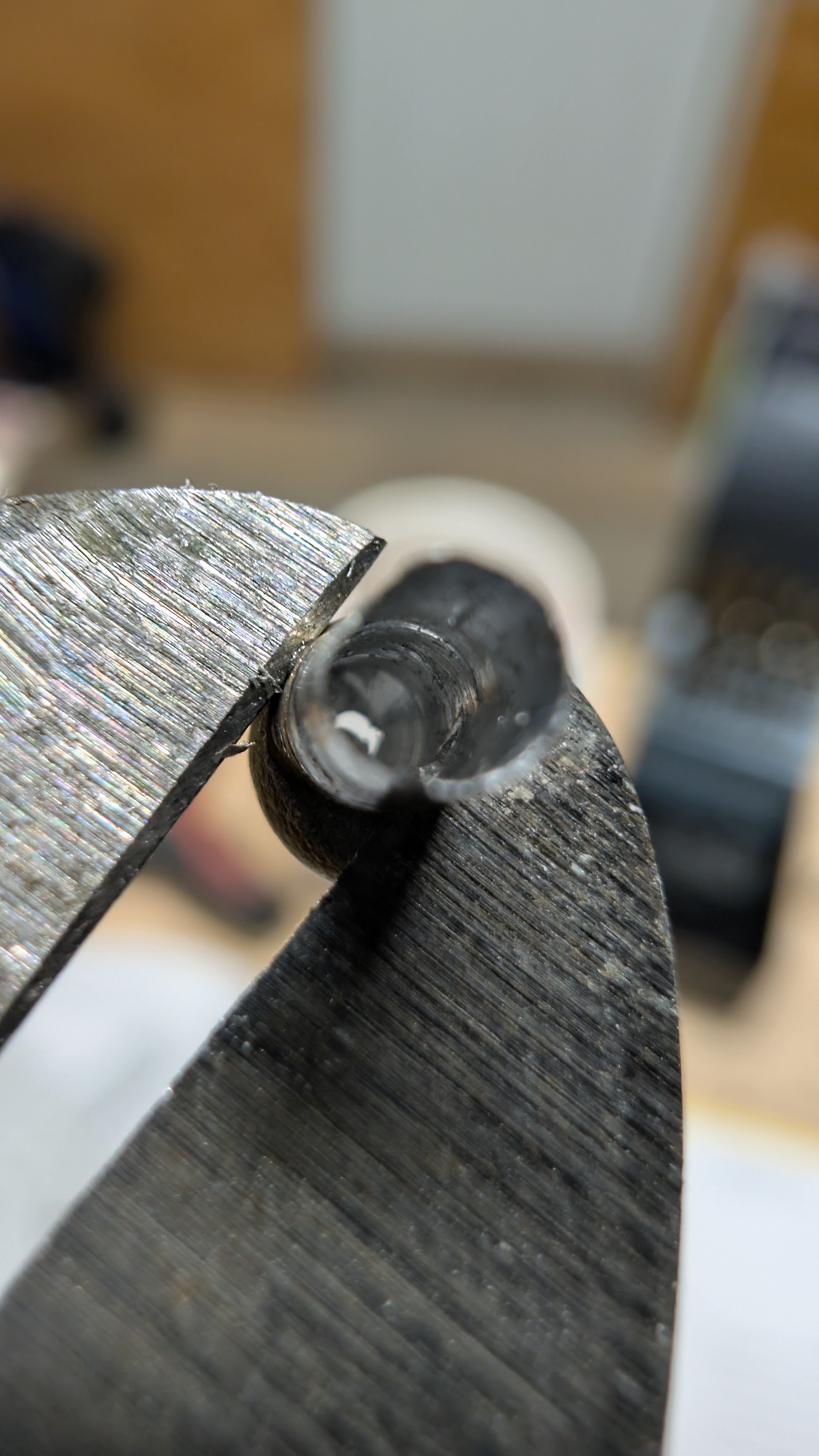

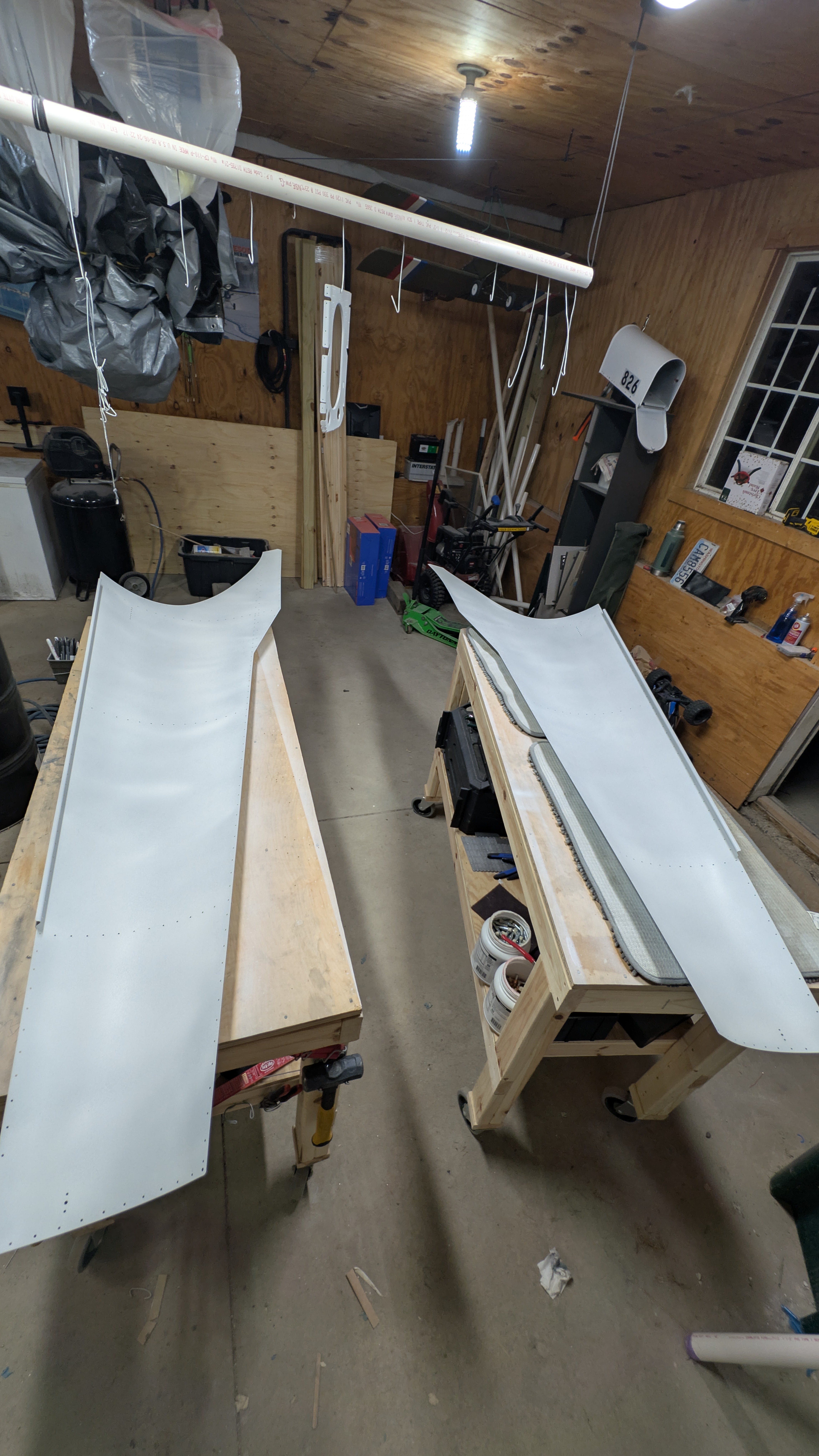

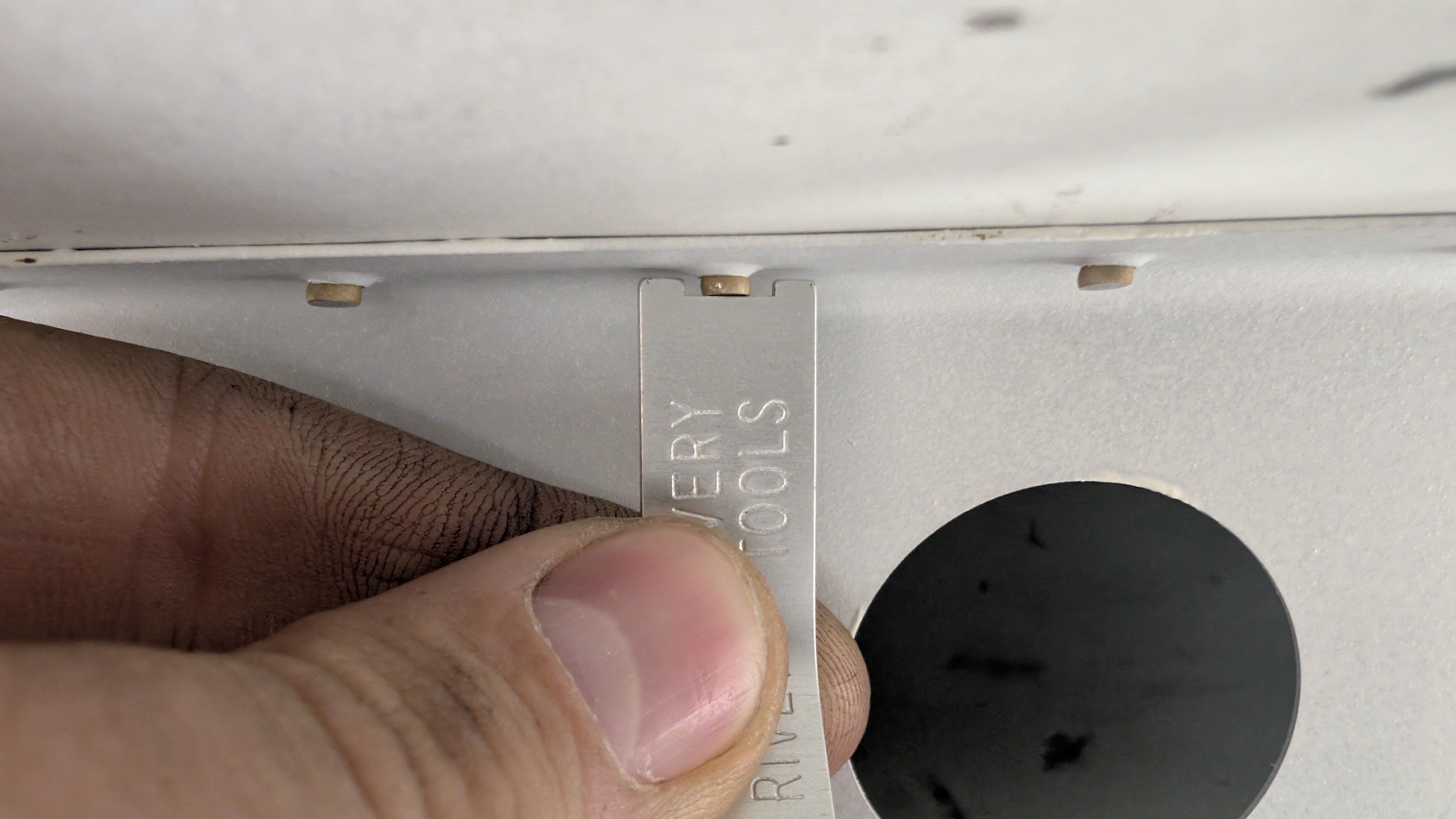

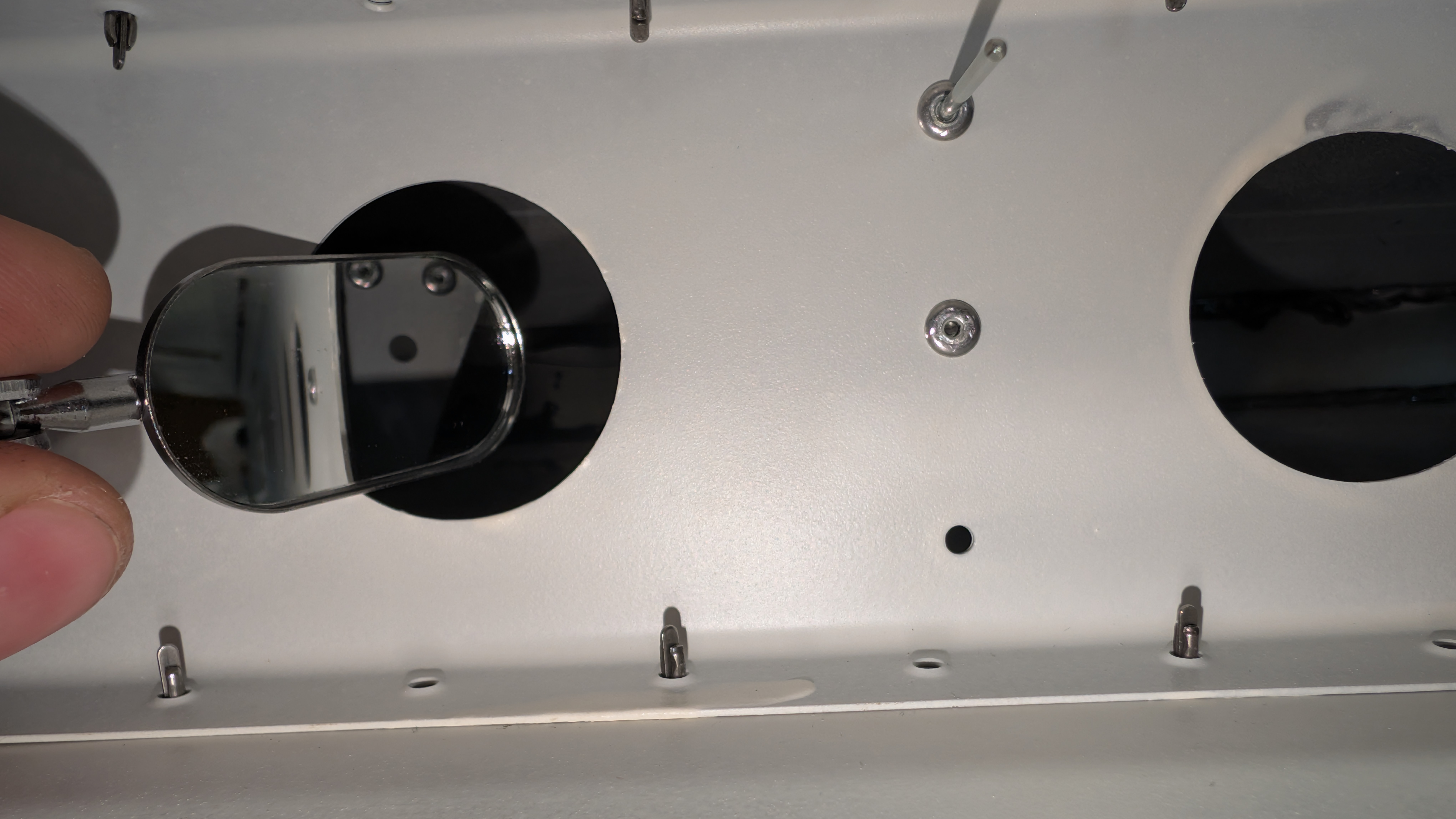

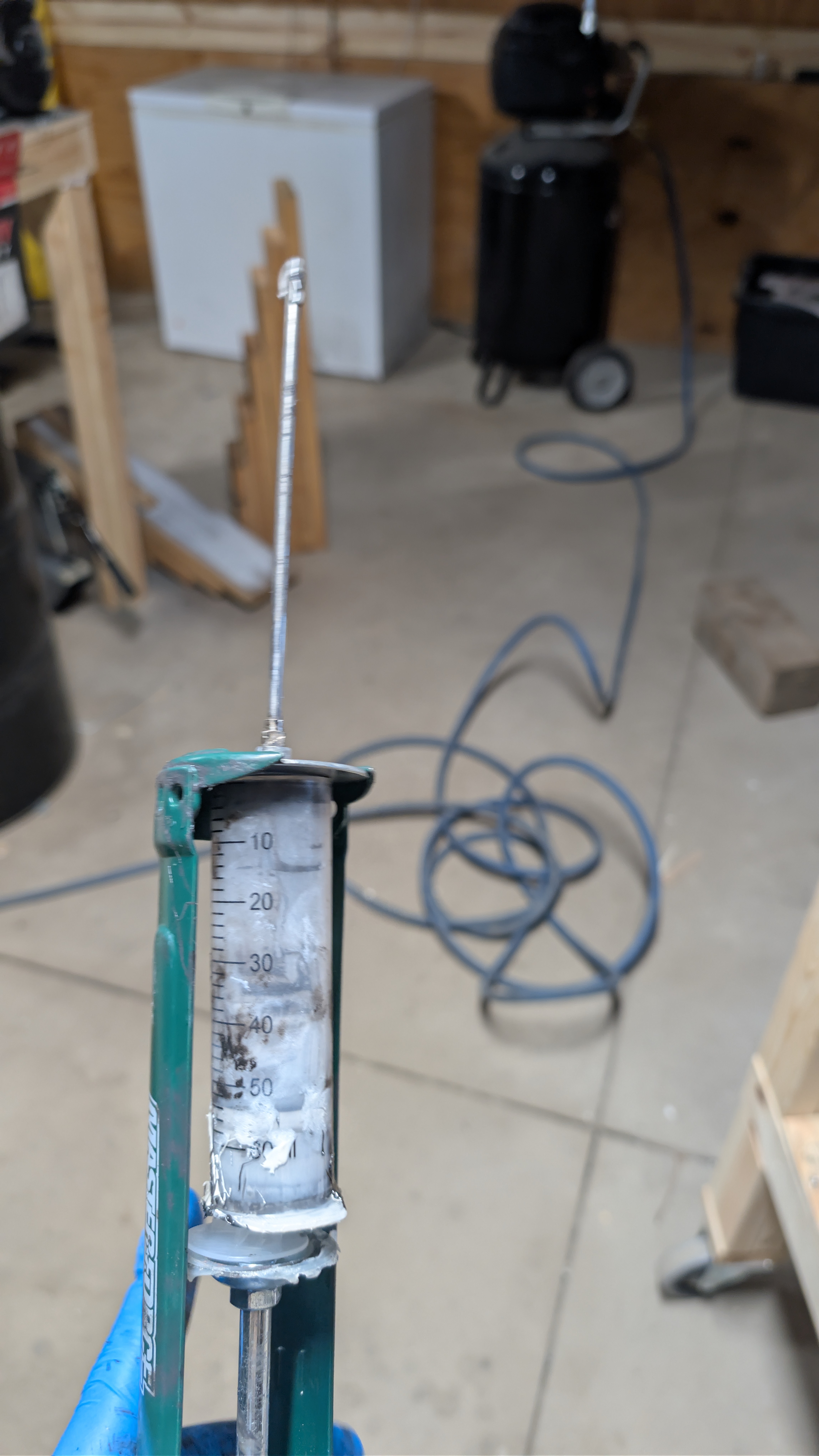

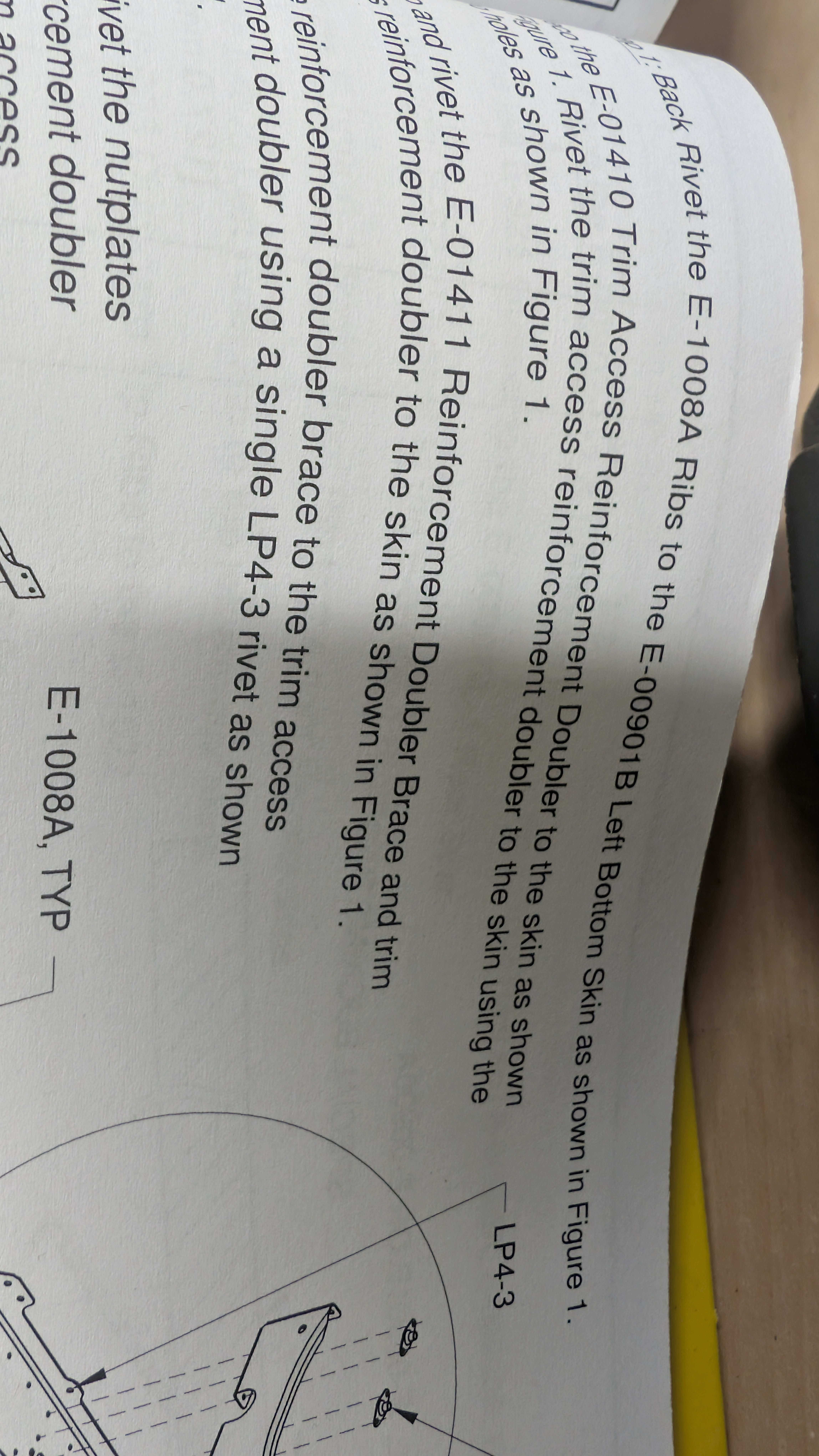

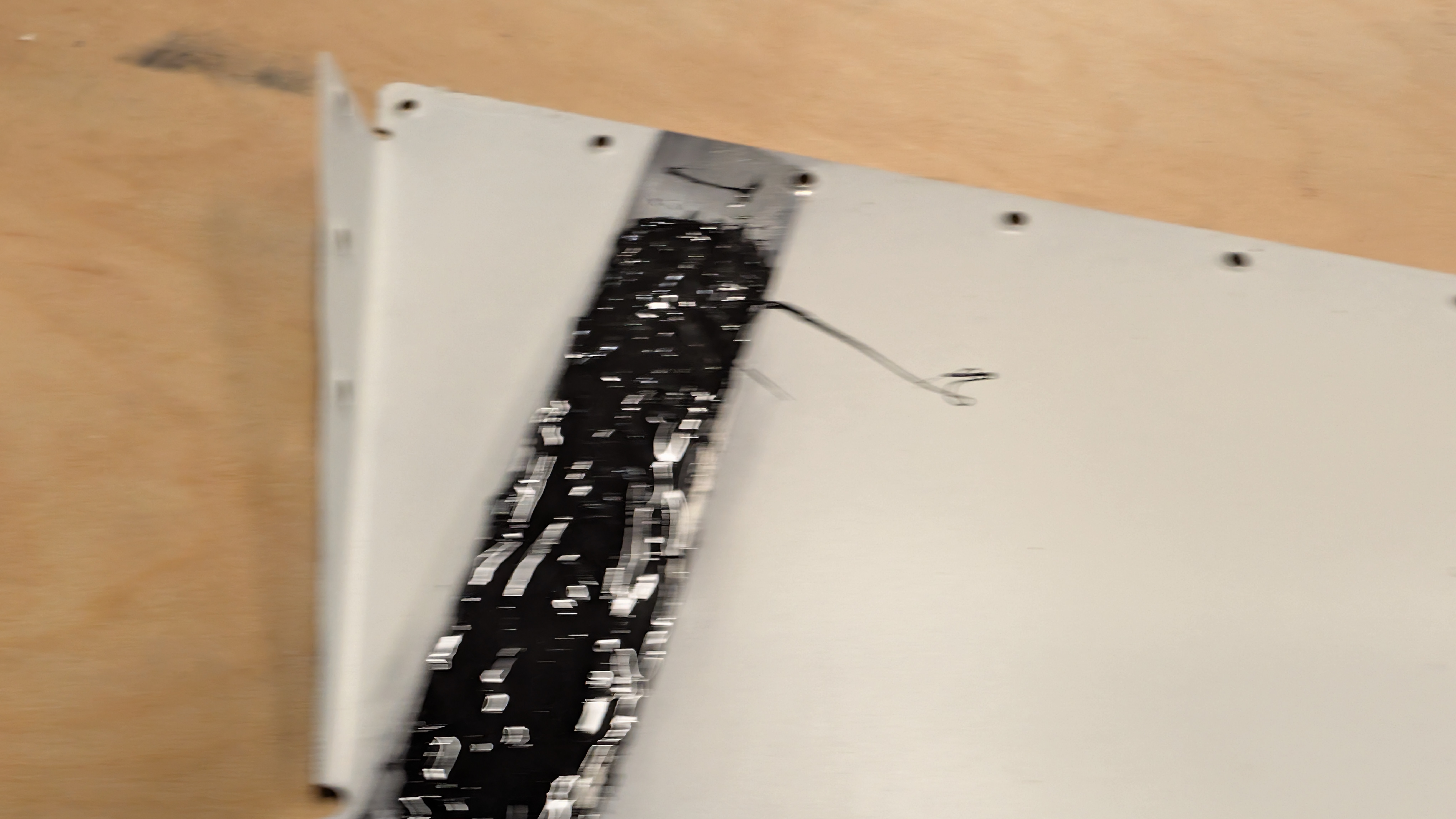

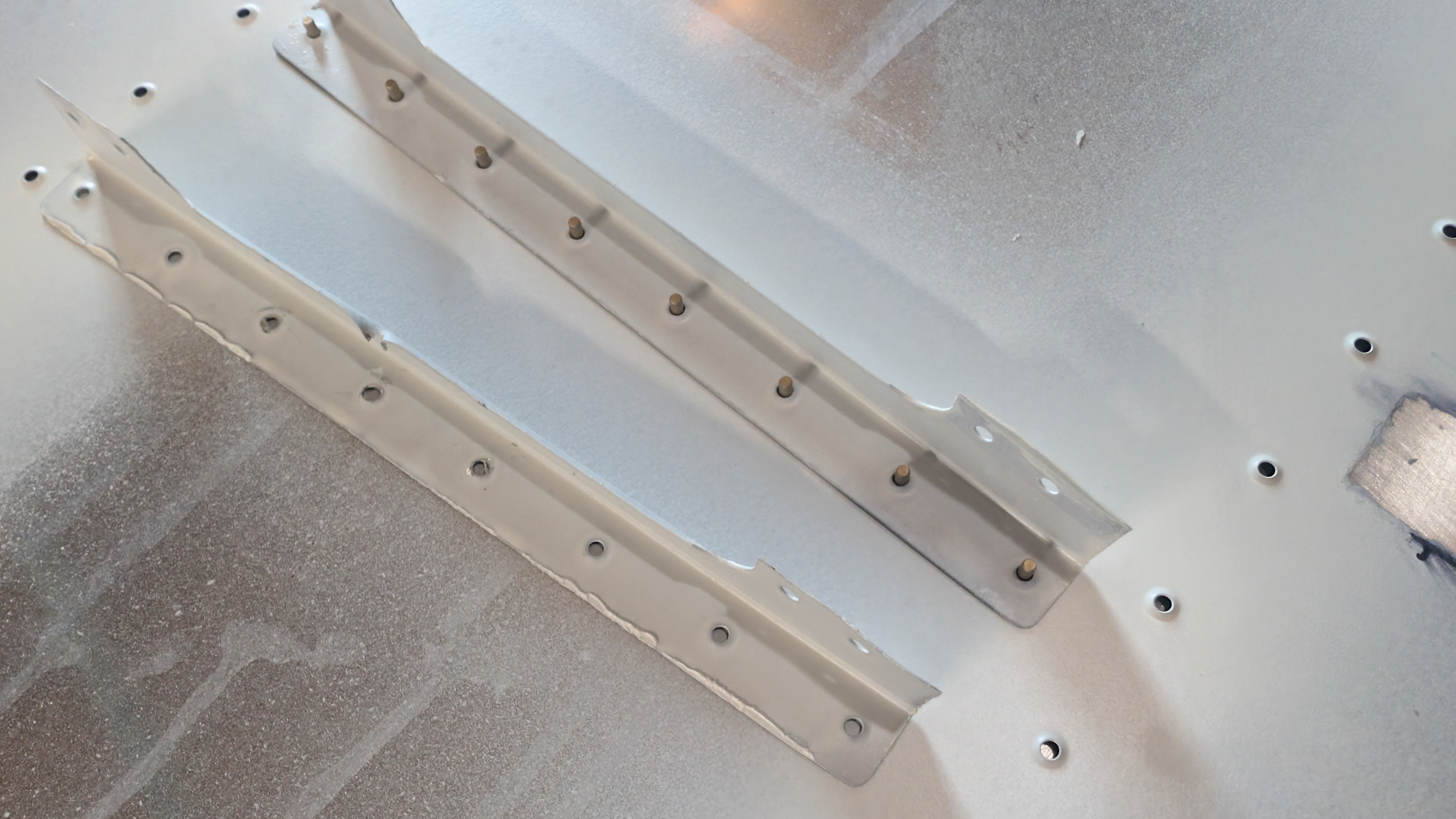

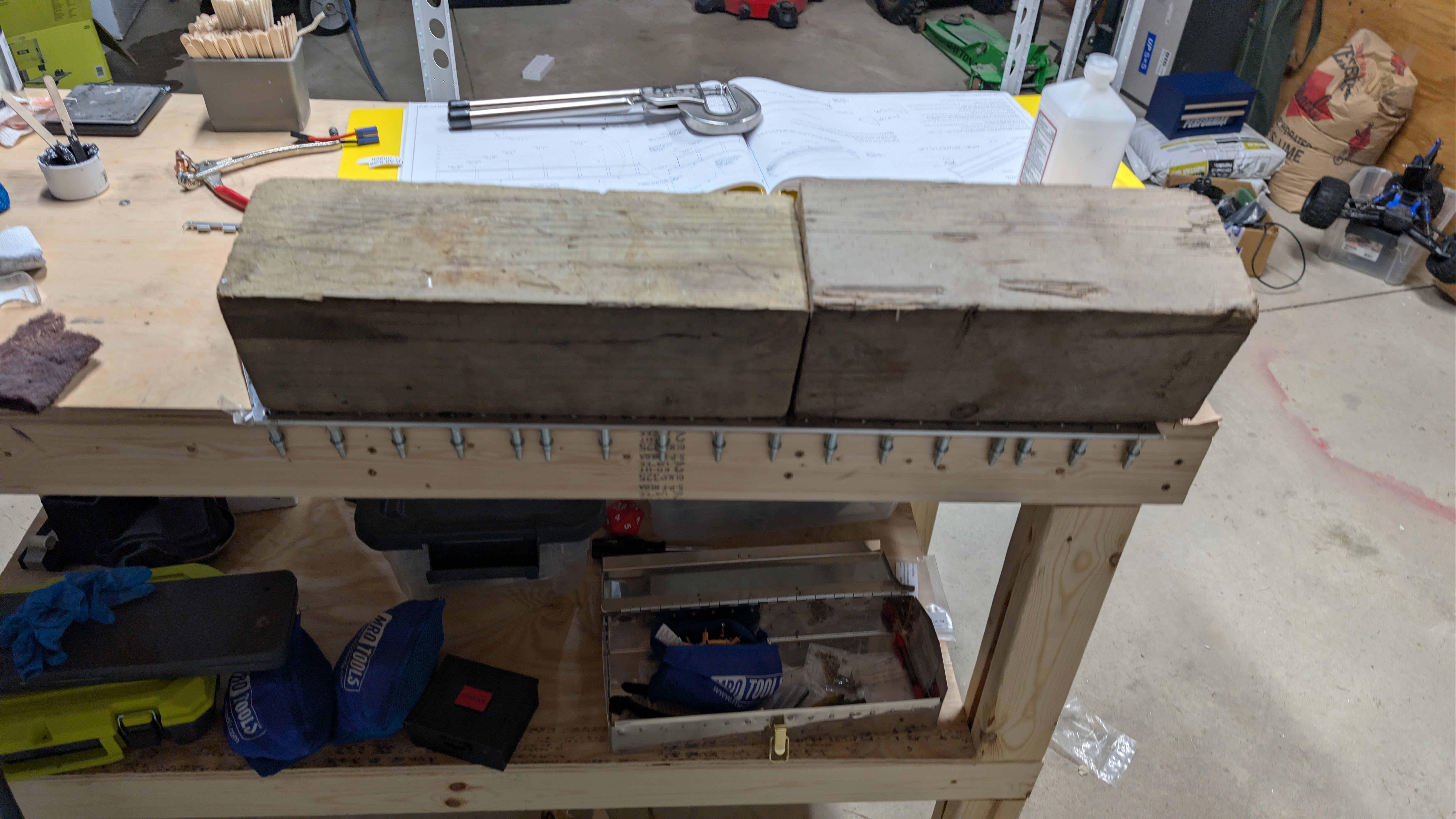

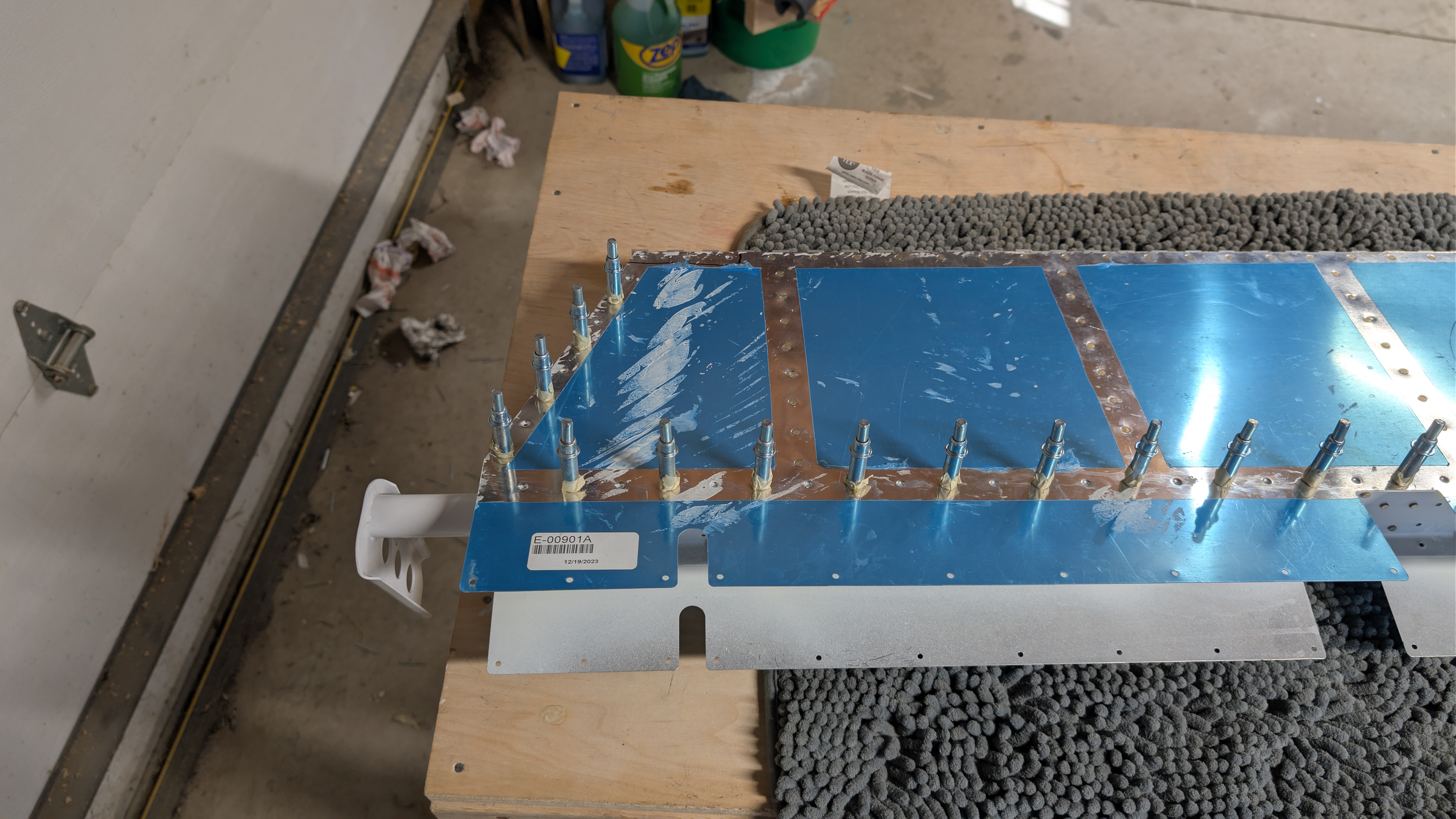

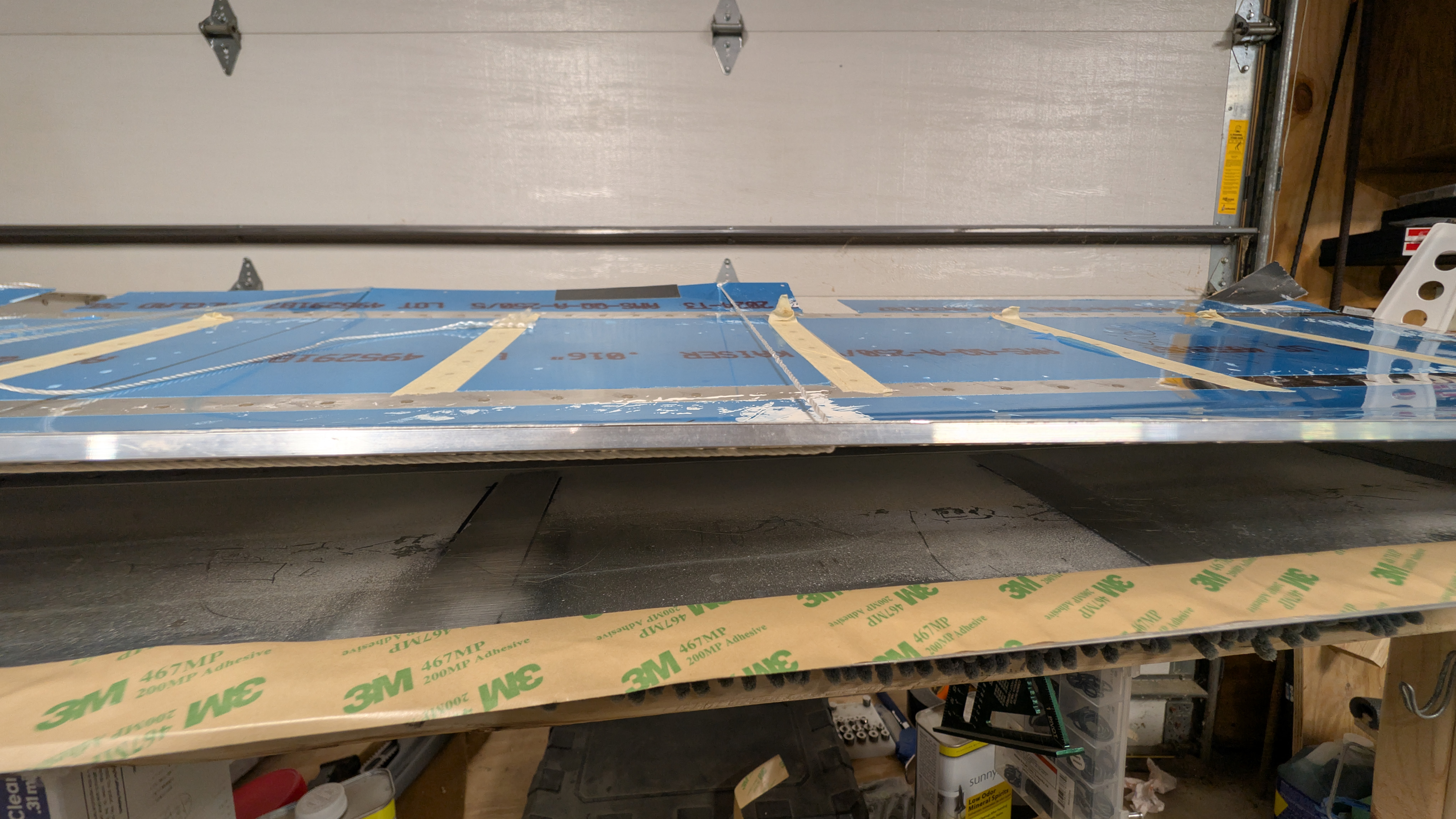

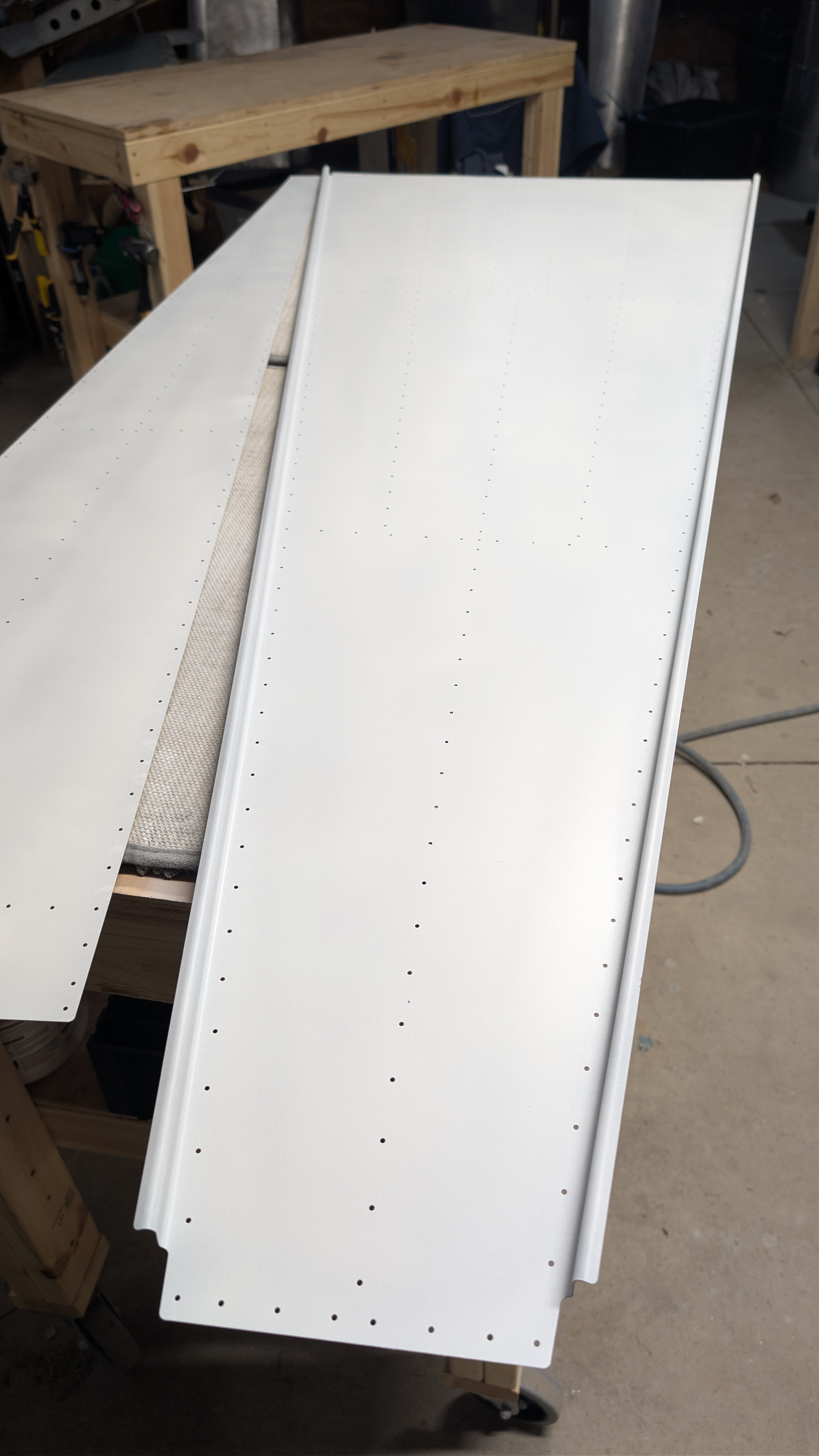

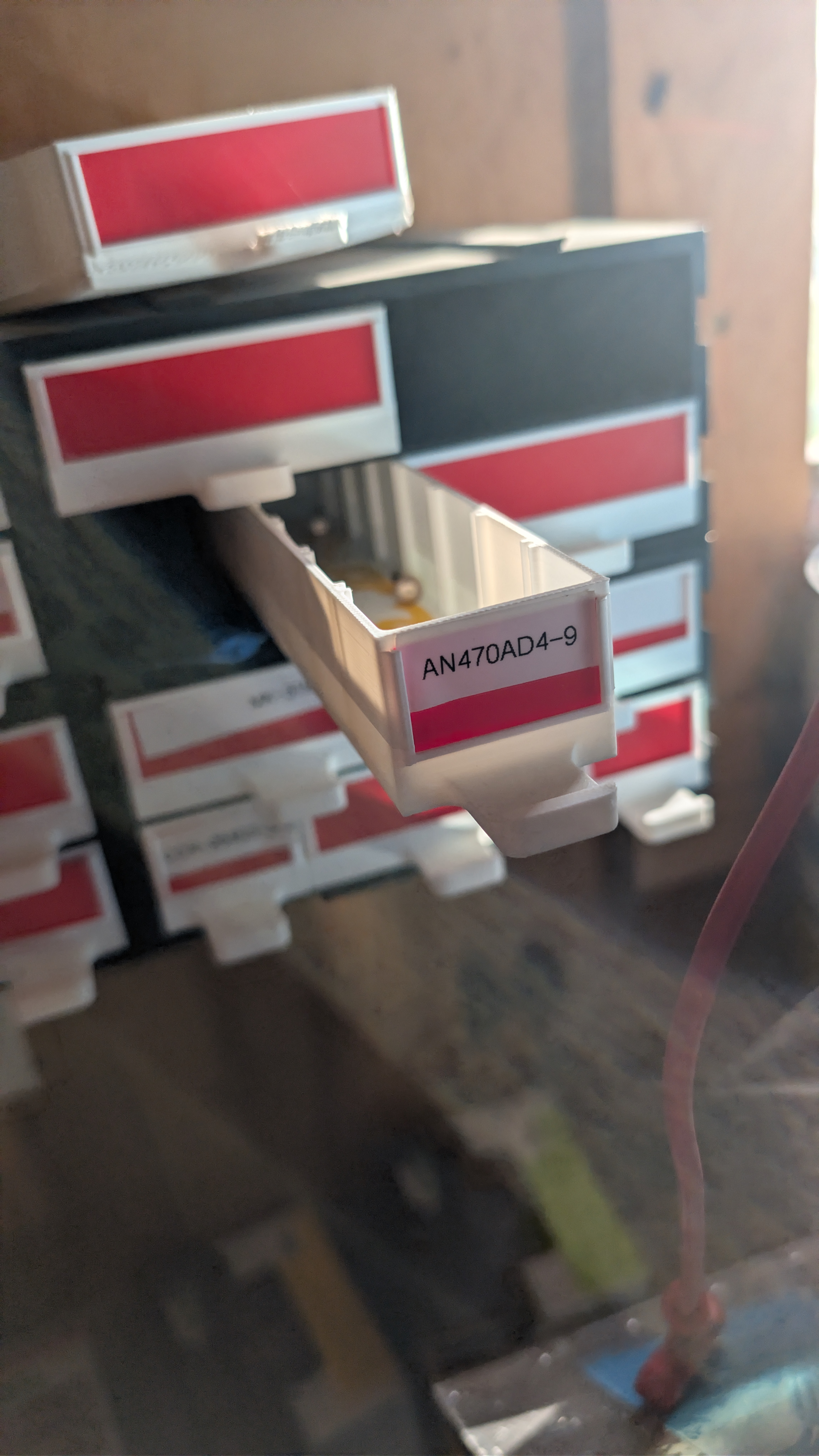

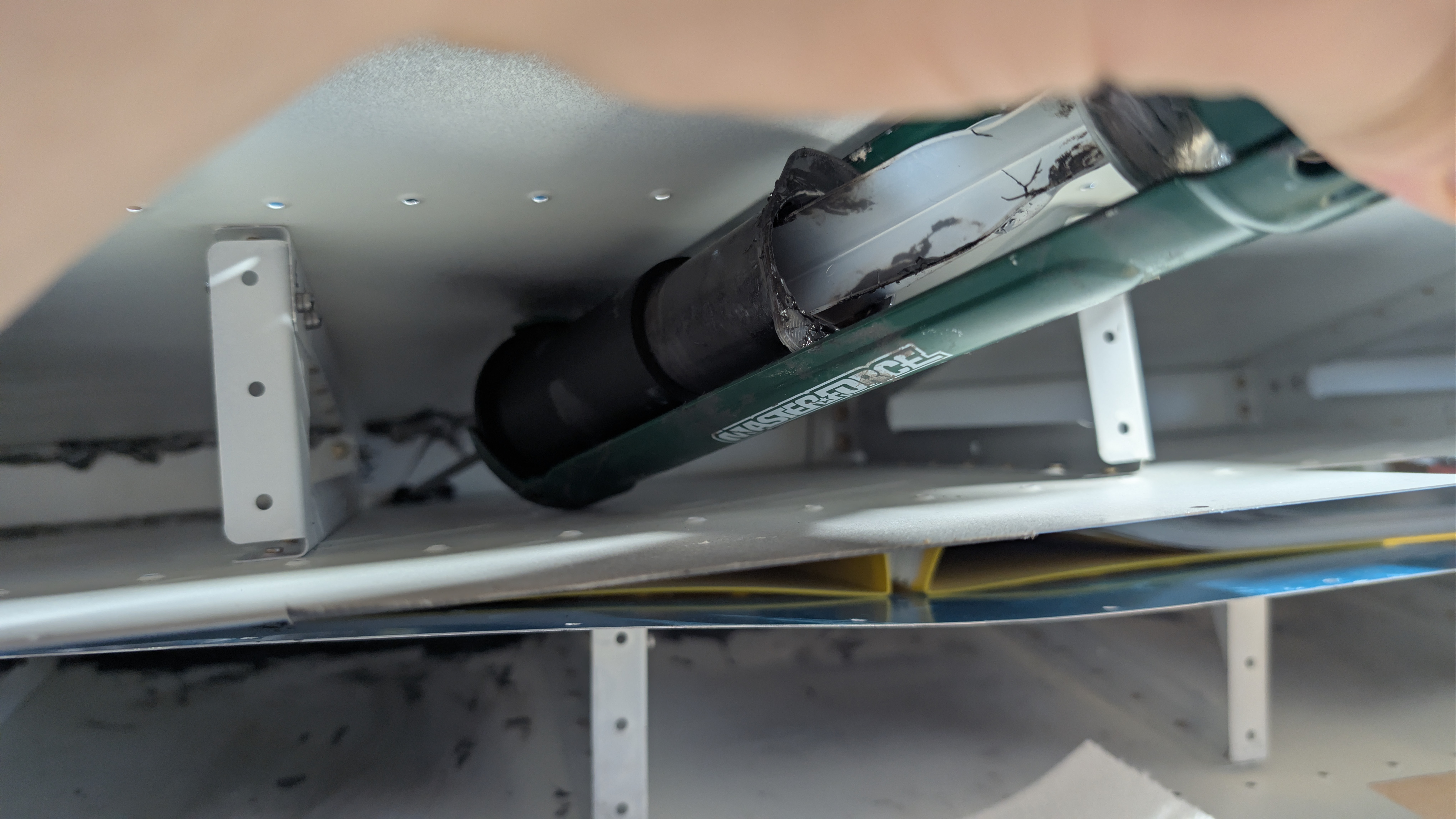

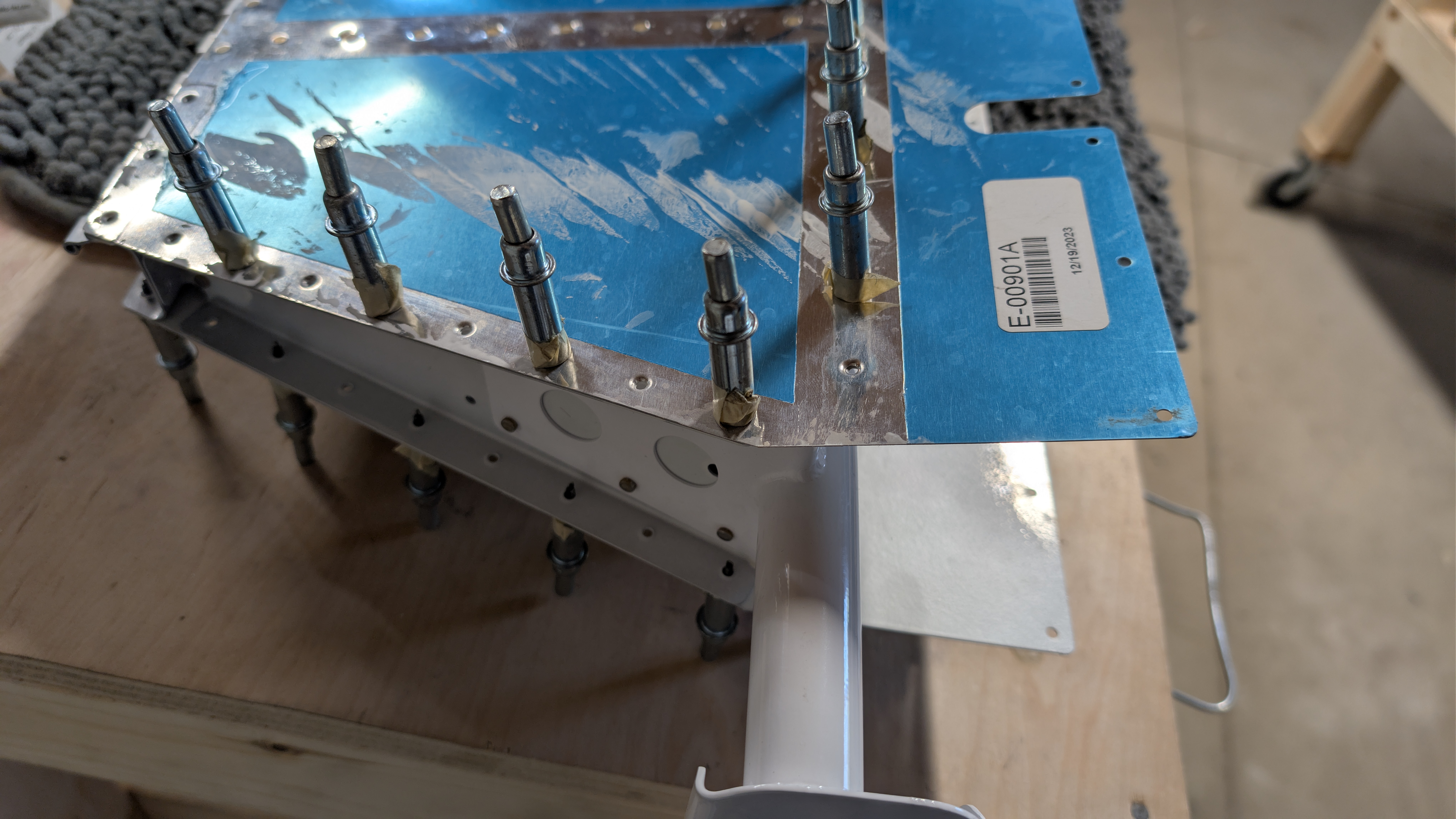

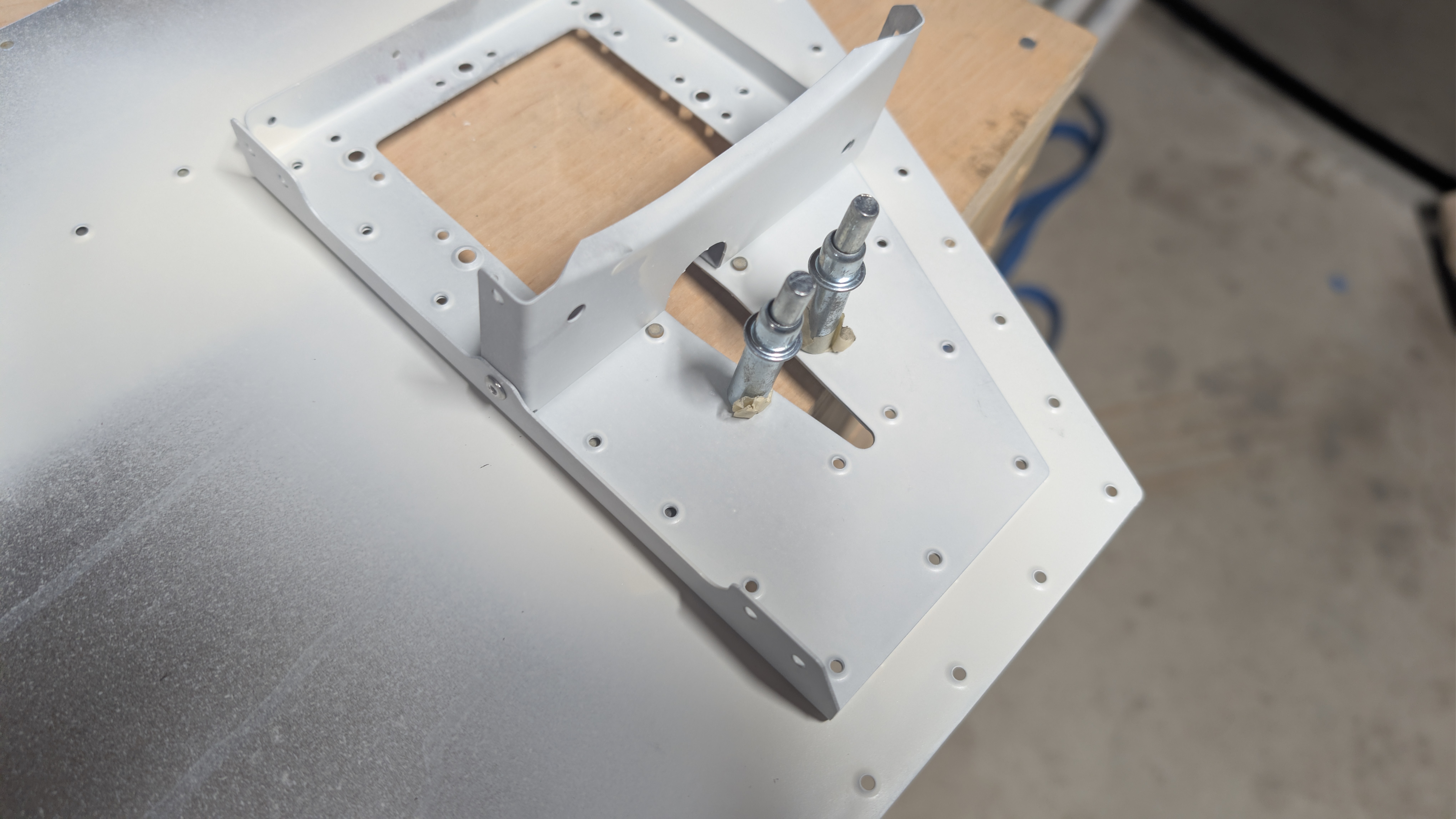

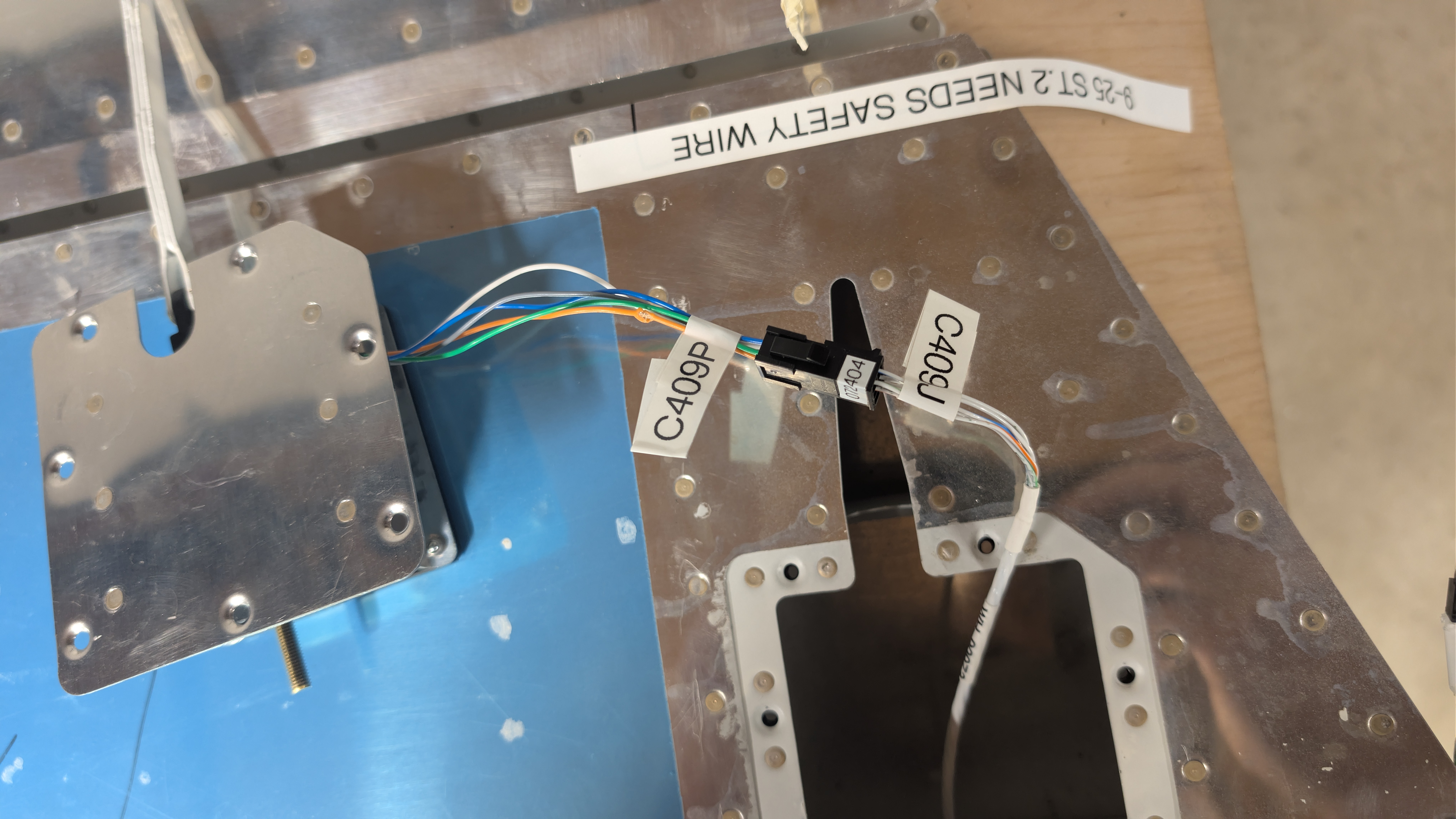

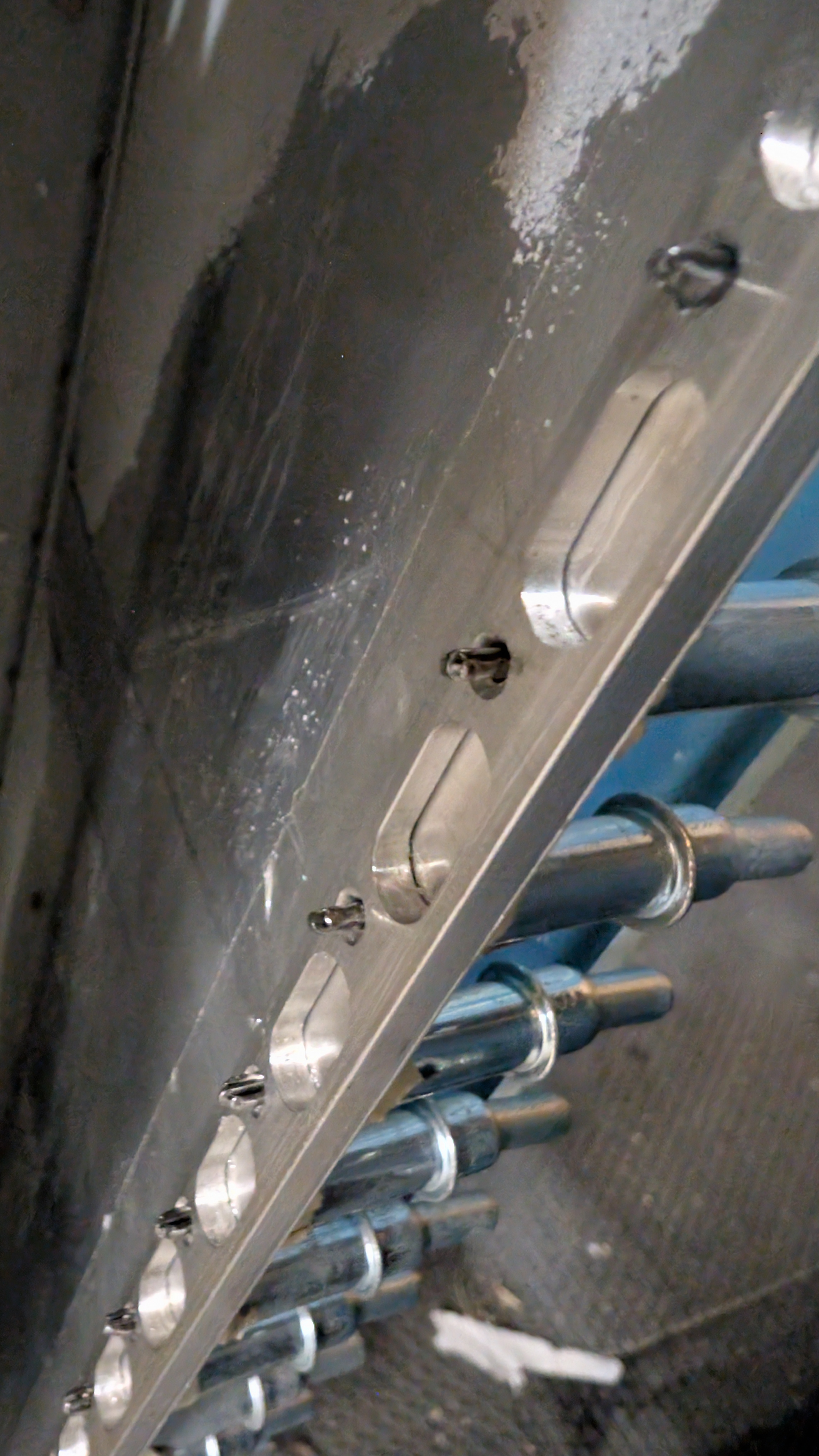

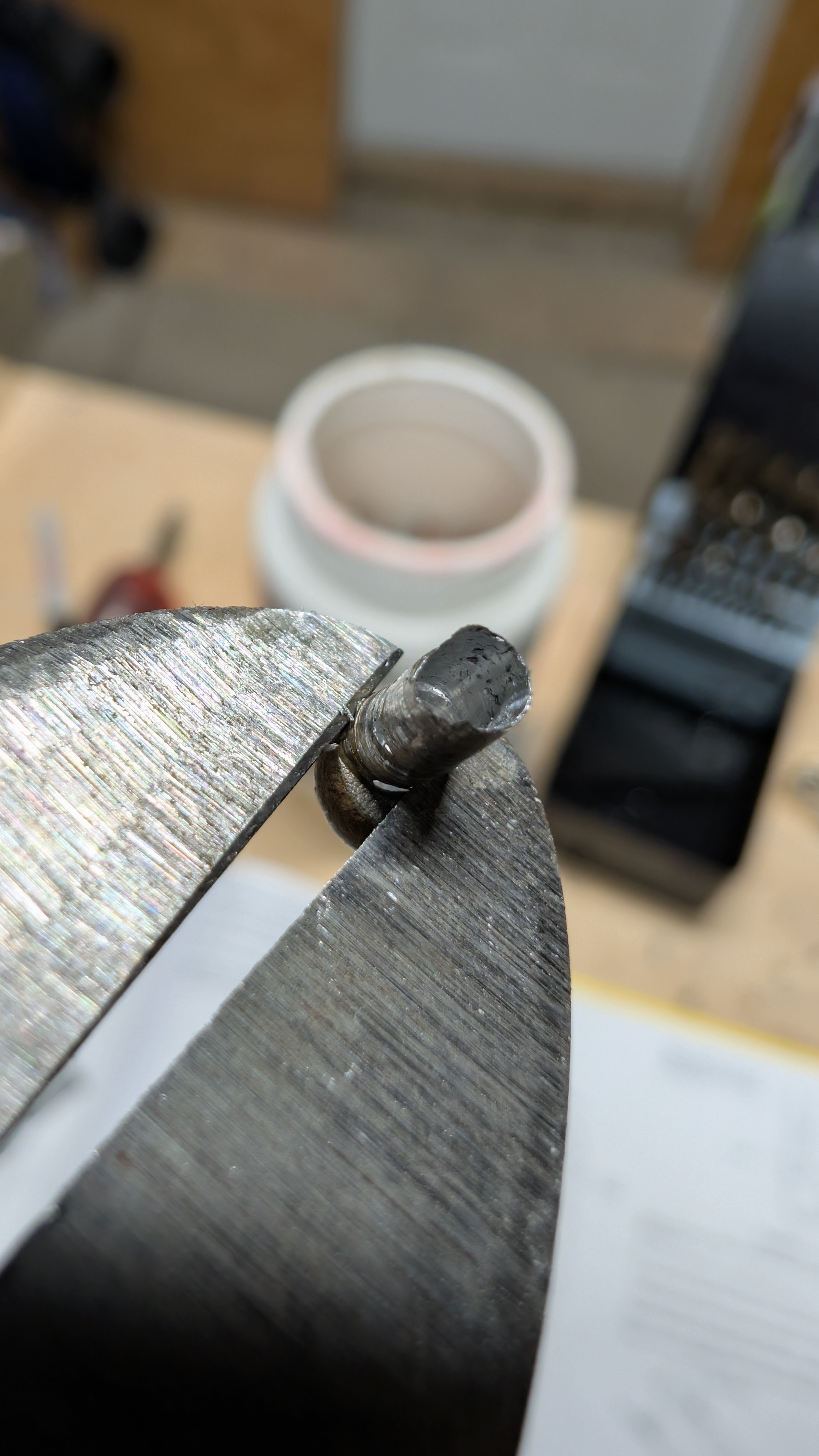

| 10/11 | 0.0 | | | | | [1 (full), 2 (full), 3 (full), 4 (full), 5 (full), 6 (full), 7 (full), 8 (full)] |
